JOHANNESBURG, SOUTH AFRICA – Ivanhoe Mines’ (TSX: IVN; OTCQX: IVPAF) President Marna Cloete and Chief Financial Officer David van Heerden are pleased to present the company’s financial results for the three and six months ended June 30, 2023. Ivanhoe Mines is a leading Canadian mining company developing and operating its four principal mining and exploration projects in Southern Africa: expanding the operations of the world-class Kamoa-Kakula Copper Complex in the Democratic Republic of Congo (DRC); building the tier-one Platreef palladium, rhodium, nickel, platinum, copper and gold development in South Africa; restarting the historic, ultra-high-grade Kipushi zinc-copper-lead-germanium mine in the DRC; as well as exploring the expansive exploration licences of Ivanhoe’s Western Foreland for copper discoveries adjacent to Kamoa-Kakula. All figures are in U.S. dollars unless otherwise stated.

Watch an August 2023 video highlighting Ivanhoe Mines’ construction and exploration activities: https://vimeo.com/850838953/163436ff95

FINANCIAL HIGHLIGHTS

  • Ivanhoe Mines recorded a profit of $87 million for Q2 2023, net of a $27 million non-cash loss on the $575 million convertible bond fair valuation, compared with a profit of $82 million for Q1 2023. The profit in the quarter includes Ivanhoe Mines’ share of profit and finance income from the Kamoa-Kakula joint venture of $123 million.
  • Kamoa-Kakula sold 101,526 tonnes of payable copper during Q2 2023, recognizing a record revenue of $702 million, an operating profit of $394 million and a quarterly EBITDA of $457 million.
  • Kamoa-Kakula’s cost of sales per pound (lb.) of payable copper sold was $1.24/lb. for Q2 2023 compared with $1.25/lb. and $1.15/lb. in Q1 2023 and Q2 2022, respectively. Cash costs (C1) per pound of payable copper produced in Q2 2023 totaled $1.41/lb., compared to $1.42/lb. and $1.42/lb. in Q1 2023 and Q2 2022, respectively.
  • Ivanhoe Mines Adjusted EBITDA was $172 million for Q2 2023, compared with $101 million for the same period in 2022, and $172 million for Q1 2023.
  • Since entering Phase 1 commercial production on July 1, 2021, the Kamoa-Kakula joint venture has generated $1.82 billion of net cash from operating activities, which has funded both the Phase 2 and Phase 3 expansions to date.
  • Ivanhoe Mines has a strong balance sheet with cash and equivalents of $393 million on hand as at June 30, 2023, and expects Kamoa-Kakula’s Phase 1 and Phase 2 cash flow to be sufficient to fund the Phase 3 expansion capital cost requirements at current copper prices.
  • On May 22, 2023, Kipushi Corporation entered into a financing facility with Rawbank SA, one of the largest financial institutions in the Democratic Republic of the Congo. Under the terms of the facility, Rawbank provided an $80 million loan, to be drawn down in two tranches of $40 million each. The first tranche has been drawn and will be used to fund Kipushi’s working capital requirements. The facility bears interest of 8% per annum.
  • On April 27, 2023, Ivanhoe and joint-venture partner Gécamines, the DRC’s state-owned mining company, announced an offtake term sheet for 100% of Kipushi’s zinc concentrate, together with a $250-million facility supported by Glencore International AG. The offtake and financing term sheet is subject to the execution of final, binding agreements, which are expected to be concluded in conjunction with the new Kipushi Corporation joint-venture agreement in the coming months.
  • On June 15, 2023, Ivanhoe announced the replacement of an outstanding $77.4-million loan receivable from High Power Exploration (HPX) with an equity investment in I-Pulse, its parent company, joining leading mining company BHP Group Limited as an investor. The company intends to enter into a collaboration agreement with I-ROX, an I-Pulse subsidiary, to investigate and develop applications for pulsed-power technology in the mining sector.

OPERATIONAL HIGHLIGHTS

  • Record quarterly production of 103,786 tonnes of copper in concentrate was achieved at Kamoa-Kakula for Q2 2023, compared with 93,603 tonnes in Q1 2023 and 87,314 tonnes in Q2 2022.
  • Over the first six months of 2023, Kamoa-Kakula has produced a total of 197,389 tonnes of copper in concentrate, placing it well on track to deliver annual production guidance of between 390,000 – 430,000 tonnes of copper.
  • Kamoa-Kakula's Phase 1 and 2 concentrators milled a record 2.2 million tonnes of ore during the second quarter at an average feed grade of 5.2% copper. This included high-grade, run-of-mine ore from the Kakula Mine, supplemented with ore from the surface stockpiles to achieve throughput higher than original design capacity.
  • On July 2, 2023, Kamoa-Kakula achieved a record daily milling rate of 29,968 dry metric tonnes, which is equivalent to an annual milling rate of 10 million tonnes per annum (after accounting for availability). For July, Kamoa-Kakula produced 35,636 tonnes of copper in concentrate, just short of a record, and achieved recoveries of 88%.
  • Kamoa-Kakula's Phase 3 mine and concentrator expansion, 500,000-tonne-per-annum on-site, direct-to-blister copper smelter and the refurbishment of Turbine #5 at the Inga II hydroelectric facility are advancing on schedule and are expected to be complete in late 2024. At current copper prices, it is expected that cashflow from Kamoa-Kakula’s Phase 1 and 2 operations will be sufficient to fund the remaining 2023 and 2024 expansion capital cost requirements of approximately $2.1 billion.
  • On July 27, 2023, Ivanhoe announced significant preliminary test work for improving copper recoveries at Kamoa-Kakula. In 2022, Kamoa Copper’s process engineering team, together with a number of internationally recognized external metallurgy specialists, initiated work to investigate ways to economically recover additional copper units from the tailings stream of the Phase 1 and 2 concentrators.  Results to-date indicate a significant improvement in total recoveries can be achieved by liberating copper from the tailings stream, which would further increase production, revenues and cash flow.
  • Ivanhoe continues its expansive copper exploration program on its Western Foreland licences that cover approximately 2,407 square kilometres adjacent to Kamoa-Kakula. The 2023 exploration program is budgeted at approximately $19 million. A total of 37 holes and 10,853 metres were completed during Q2 2023, following the conclusion of the wet-season in May. A total of 15,736 metres of diamond core have been drilled in the first half of 2023.
  • Ivanhoe is on schedule to publish a maiden Mineral Resource estimate for its Makoko and Kiala high-grade copper discoveries in the Western Foreland in Q3 2023.
  • Ivanhoe is undertaking optimization work to identify value-accretive options for installing hoisting capacity to Platreef's Shaft 3, which was originally planned as a ventilation and secondary escape shaft. Shaft 3 is currently under construction and now is planned to be equipped for hoisting. Shaft 3 is currently being reamed to a diameter of 5.1 metres. Approximately, 340 metres of the total 950 metres have been reamed to date, with completion planned in Q4 2023. The additional hoisting capacity from Shaft 3 may be used to accelerate underground mining activities for Phase 2, in advance of the completion of Shaft 2, which is expected in 2027.
  • Platreef underground development work is focused on lateral development towards the high-grade Flatreef orebody on the 750-metre, 850-metre and 950-metre levels. More than 2,000 metres of lateral development has been completed to date across all three levels, advancing at a rate of approximately 200 metres per month. Once the crusher and loading feeder installation on the 950-metre level is completed at the end of August, the rate of lateral underground development is expected to increase to approximately 300 metres per month throughout the remainder of the year.
  • Drilling of the pilot drill hole for the reaming of the 10-metre-diameter Shaft 2, which commenced in February 2023, was completed during the quarter. Preparations are now underway to commence reaming of Shaft 2 to an initial diameter of 3.1 metres.
  • At the Kipushi Mine, overall construction progress is approximately 50% complete and construction of the concentrator is on schedule for commissioning in Q3 2024. The concentrator includes dense media separation and a milling and flotation circuit. Kipushi is expected to produce more than 270,000 tonnes of zinc contained in concentrate over the first five years of production.
  • Kipushi's underground development activity is ahead of schedule, with 2,147 metres of lateral development completed since September 2022. Stoping of ultra-high-grade Big Zinc orebody is expected to begin in January 2024. The year-to-date underground development rate averages approximately 250 metres per month. The underground development rate is expected to increase to approximately 450 metres per month by year-end.

Christelle Nday (centre left) and Micheline Kyenge (centre right), President and Vice President of Kamoa's Women In Mining, conducted a tour of Kamoa-Kakula for a group of Grade 10 students from the nearby Mutoshi Technical Institute. The students are pictured in front of a 21-tonne underground loader at the Kansoko Mine portals.

Conference call for investors on Thursday, August 3, 2023

Ivanhoe Mines will hold an investor conference call to discuss its 2023 second-quarter financial results at 3:30 p.m. London time / 10:30 a.m. Eastern time / 7:30 a.m. Pacific time on Thursday, August 3. The conference call will conclude with a question-and-answer (Q&A) session. Media are invited to attend on a listen-only basis.

To view the webcast please use the following link: https://edge.media-server.com/mmc/p/3envh996

Analysts are invited to join by phone for the Q&A using the following link: https://register.vevent.com/register/BI41a67c7e4bc743e7975234c0ae560d1a

An audio webcast recording of the conference call, together with supporting presentation slides, will be available on Ivanhoe Mines’ website at www.ivanhoemines.com.

After issuance, the Financial Statements and Management’s Discussion and Analysis will be available at www.ivanhoemines.com and www.sedarplus.ca.

Read Ivanhoe's Second Quarter 2023 Sustainability Update: https://ivanhoemines.com/site/assets/files/3775/sustainability-review-q2-2023.pdf

Construction of the off-gas handling structure and the adjoining furnace building at Kamoa-Kakula’s direct-to-blister copper smelter.

Principal projects and review of activities

1. Kamoa-Kakula Copper Complex
39.6%-owned by Ivanhoe Mines
Democratic Republic of Congo

The Kamoa-Kakula Copper Complex is approximately 25 kilometres southwest of the town of Kolwezi and about 270 kilometres west of Lubumbashi in the DRC Copperbelt. Kamoa-Kakula’s Phase 1 concentrator began producing copper in May 2021 and achieved commercial production on July 1, 2021. The Phase 2 concentrator, which doubled nameplate production capacity, was commissioned in April 2022. Kamoa-Kakula is independently ranked by international mining consultant Wood Mackenzie to become the world’s third-largest copper mining operation in 2027, following the completion of the ongoing Phase 3 expansion. Kamoa-Kakula’s employee workforce is currently 97% Congolese.

The Kamoa-Kakula Copper Complex is operated as the Kamoa Holding joint venture between Ivanhoe Mines and Zijin Mining. Ivanhoe sold a 49.5% share interest in Kamoa Holding Limited (Kamoa Holding) to Zijin Mining and a 1% share interest in Kamoa Holding to privately owned Crystal River in December 2015. Kamoa Holding holds an 80% interest in the project. Ivanhoe and Zijin Mining each hold an indirect 39.6% interest in Kamoa-Kakula, Crystal River holds an indirect 0.8% interest, and the DRC government holds a direct 20% interest.

Kamoa-Kakula summary of operating and financial data

Q2 2023

Q1 2023

Q4 2022

Q3 2022

Q2 2022

Ore tonnes milled (000’s tonnes)

2,244

1,930

2,006

2,082

1,950

Copper ore grade processed (%)

5.21%

5.42%

5.40%

5.60%

5.44%

Copper recovery (%)

87.2%

87.1%

86.1%

85.9%

84.0%

Copper in concentrate produced (tonnes)

103,786

93,603

92,761

97,820

87,314

Payable copper sold (tonnes)

101,526

86,777

92,208

93,812

85,794

Cost of sales per pound ($ per lb.)

1.24

1.25

1.08

1.05

1.15

Cash cost (C1) ($ per lb.)

1.41

1.42

1.42

1.43

1.42

Realized copper price ($ per lb.)

3.79

4.04

3.54

3.50

4.34

Sales revenue before remeasurement ($'000)

729,924

659,529

619,997

570,504

699,381

Remeasurement of contract receivables ($'000)

(27,542)

29,594

53,473

(110,031)

(205,248)

Sales revenue after remeasurement ($'000)

702,382

689,123

673,470

460,473

494,133

EBITDA ($'000)(1)

    456,628

457,311

452,089

251,086

285,477

EBITDA margin (% of sales revenue)

65%

66%

67%

55%

58%

All figures in the above tables are on a 100%-project basis. Metal reported in concentrate is before refining losses or deductions associated with smelter terms. This news release includes “EBITDA”, “Adjusted EBITDA”, “EBITDA margin”, normalized profit and "Cash costs (C1)" which are non-GAAP financial performance measures. For a detailed description of each of the non-GAAP financial performance measures used herein and a detailed reconciliation to the most directly comparable measure under IFRS, please refer to the non-GAAP Financial Performance Measures section of this news release starting on page 52.

(1) Unrealized foreign exchange losses have been excluded from EBITDA in the current and prior periods presented, as the Company believes that including the unrealized foreign exchange gains and losses does not give a valuable indication of the mine’s ability to generate liquidity by producing operating cash flow to fund its working capital needs, service debt obligations, fund capital expenditures and distribute cash to its shareholders.

C1 cash cost per pound of payable copper produced can be further broken down as follows:

Q2 2023

Q1 2023

Q4 2022

Q3 2022

Q2 2022

Mining

($ per lb.)

      0.39

0.41

0.40

0.41

0.39

Processing

($ per lb.)

      0.19

0.19

0.16

0.12

0.14

Logistics charges (delivered to China)

($ per lb.)

      0.45

0.46

0.50

0.56

0.51

Treatment, refining and smelter charges

($ per lb.)

      0.25

0.23

0.23

0.21

0.21

General and administrative expenditure

($ per lb.)

      0.13

0.13

0.13

0.13

0.17

C1 cash cost per pound of payable copper produced

($ per lb.)

1.41

1.42

1.42

1.43

1.42

C1 cash costs are prepared on a basis consistent with the industry standard definitions by Wood Mackenzie cost guidelines but are not measures recognized under IFRS. In calculating the C1 cash cost, the costs are measured on the same basis as the company's share of profit from the Kamoa Holding joint venture that is contained in the financial statements. C1 cash costs are used by management to evaluate operating performance and include all direct mining, processing, and general and administrative costs. Smelter charges and freight deductions on sales to the final port of destination, which are recognized as a component of sales revenues, are added to C1 cash cost to arrive at an approximate cost of delivered, finished metal. C1 cash costs exclude royalties and production taxes and non-routine charges as they are not direct production costs.

All figures are on a 100% project basis and metal reported in concentrate is before refining losses or deductions associated with smelter terms.

(L-R) Guelord Ilunga, control room overseer; Derick Yav Tshang, control room overseer; Carine Ndala, control room overseer; Jean-Saint Kabange, plant metallurgist; Dan Mutamba, senior control room officer; and Chris Tshibanda, control room overseer, stand in the Kamoa-Kakula concentrator plant control room.

Kamoa-Kakula produced a record 103,786 tonnes of copper in Q2 2023, including a monthly record of 35,856 tonnes for May 2023

Kamoa-Kakula's Phase 1 and 2 concentrators are now regularly operating at the increased processing rate of 9.2 million tonnes per annum (Mtpa), following the completion of the debottlenecking program. The $50-million Phase 1 and 2 concentrator debottlenecking program was completed on budget and ahead of schedule in late February 2023, increasing production capacity up to 450,000 tonnes of copper in concentrate per annum.

The Kamoa-Kakula Phase 1 and Phase 2 concentrators continued to perform strongly in the second quarter, breaking several records including the quarterly production of 103,786 tonnes of copper in concentrate, a quarter-on-quarter increase of 11%. In addition, a monthly record was achieved in May 2023 with 35,856 tonnes of copper in concentrate produced. Also, during the quarter, a weekly production record of 9,710 tonnes of copper in concentrate was achieved in late April. Shortly after quarter-end, on July 2, 2023, a record daily milling rate of 29,968 dry metric tonnes was achieved, which is equivalent to an annual milling rate of 10 million tonnes per annum (after accounting for availability).

Kamoa-Kakula's Phase 1 and 2 concentrators milled a record 2.2 million tonnes of ore during the second quarter at an average feed grade of 5.2% copper. This included high-grade, run-of-mine ore from the Kakula Mine, supplemented with ore from the surface stockpiles to achieve throughput over original design capacity. Strong copper recoveries continued for the quarter averaging 87.2%.

For July, Kamoa-Kakula’s Phase 1 and 2 concentrators milled 0.6 million tonnes of ore at an average feed grade of 5.8% copper and recoveries of 88.0%, producing 35,636 tonnes, just short of a monthly record.

The record second-quarter production at Kamoa-Kakula was achieved despite maintenance shutdowns in June and intermittent grid instability.

Since late Q4 2022, Kamoa Copper has been working alongside DRC’s state-owned power company, La Société Nationale d’Electricité (SNEL), to identify the causes of instability across the southern DRC’s grid infrastructure to assist with delivering long-lasting solutions. Kamoa Copper has identified a series of upgrades and has outlined a project plan to deliver the improvements. Mobilization of resources is underway, with vendor selection and equipment procurement having commenced.

Concurrently, Kamoa Copper’s engineering team are working towards insulating Kamoa-Kakula from future instability by expanding on-site backup generation capacity, as well as sourcing additional power imported from the Zambian grid.

Over the next 12-18 months, on-site backup-power generation capacity will increase via a phased roll-out. During the second quarter, 11 megawatts (MW) of new generator capacity was installed, bringing the total on-site backup-power generation capacity to approximately 48 MW. Delivery of a further 30 MW in backup generation capacity, sufficient to power Kamoa-Kakula’s entire Phase 1 and 2 operations in the event of grid disruptions, will commence later this year and is expected to be operational by Q2 2024. Over 130 MW of further backup generation capacity has been ordered and is expected to be installed in 2024, in time for the completion of the Phase 3 concentrator and smelter that are currently under construction.

Discussions are advancing to secure up to 100 MW of additional power via the Zambian grid interconnector, with the initial phase expected to be ready in the third quarter.

Draw-down of surface ore stockpiles at Kakula continues as required. While the ongoing expansion of underground infrastructure at the Kakula mine takes place, ore will be drawn as required from the stockpile to maximize copper production.

Kamoa-Kakula’s high- and medium-grade ore surface stockpiles totaled approximately 4.1 million tonnes at an estimated grade of 3.7% copper as of the end of June 2023 and contained more than 152,000 tonnes of copper. The operation mined 2.2 million tonnes of ore grading 5.2% copper in Q2 2023, which was comprised of 2.0 million tonnes grading 5.4% copper from the Kakula mine, including 0.68 million tonnes grading 7.0% copper from the mine’s high-grade centre.

Jurie Human, civil supervisor, Kamoa Copper and Julias Mblambo, site foreman with DRC-based contractor Kongo River Construction, study schematics underground at the Kakula Mine.

Significant preliminary testwork for improving copper recoveries at Kamoa-Kakula

On July 27, 2023, Ivanhoe announced highly promising preliminary testwork to further improve copper recoveries at Kamoa-Kakula by liberating copper from the tailings stream by a conventional process of fine-grinding the material followed by flotation, thickening and filtration. Initial preliminary results indicate that with a feed grade of less than 1% copper, approximately 65% of the contained copper can be recovered from the tailings stream, which could increase overall metallurgical recoveries to well over 90%. Based on these results, Kamoa-Kakula can further increase production, revenues and cash flow.

In 2022, Kamoa Copper’s process engineering team, together with a number of internationally recognized external metallurgy specialists, initiated work to investigate ways to economically recover additional copper units from the tailings stream of the Phase 1 and 2 concentrators. There are 13 workstreams underway, including the process described above, which is subject to further metallurgical testwork and engineering work, to advance the project to an investment decision.

For context, in 2022 the Kamoa-Kakula Copper Complex milled approximately 7.1 million tonnes of ore at an average feed grade of 5.5% copper, producing 333,497 tonnes of copper in concentrate. Based on the metallurgical recovery of 86% copper, which was in line with design parameters, more than 50,000 tonnes of copper was not recovered into concentrate and diverted to the tailings storage facility, or used underground as backfill. The grade of Kamoa-Kakula’s tailings in 2022 averaged approximately 0.8% copper. For comparison, the average head grade of the copper mines globally was approximately 0.6% in 2022, according to Bank of Montreal (BMO) research. See Figure 1.

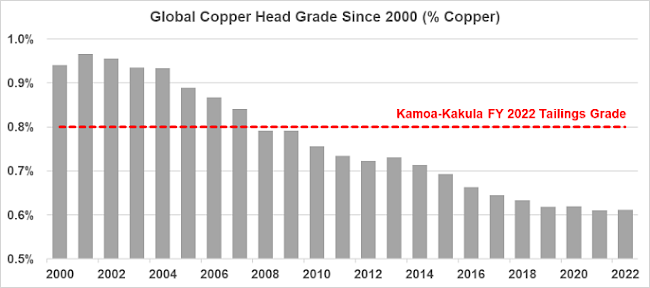

Figure 1. Global average copper head grade since 2000, compared with the average copper grade of Kamoa-Kakula’s tailings during 2022.

Source: BMO Research, Wood Mackenzie

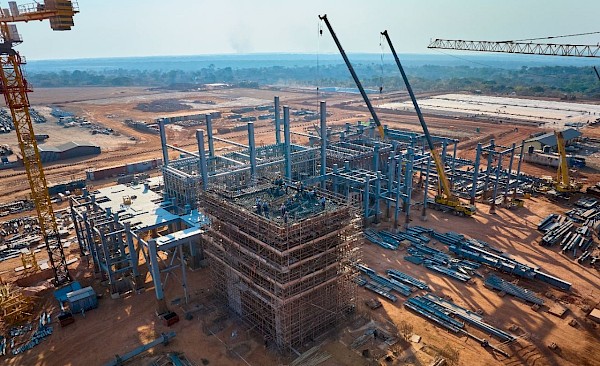

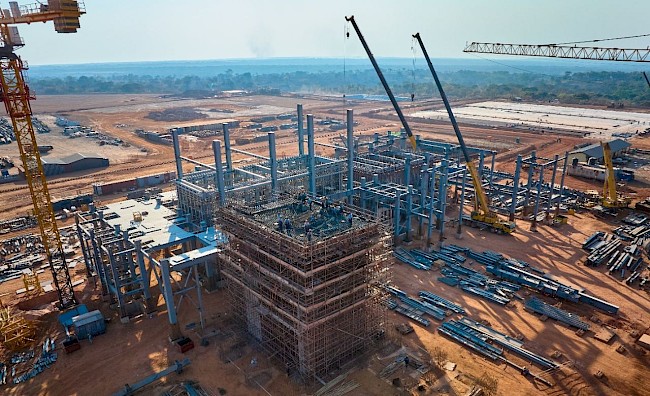

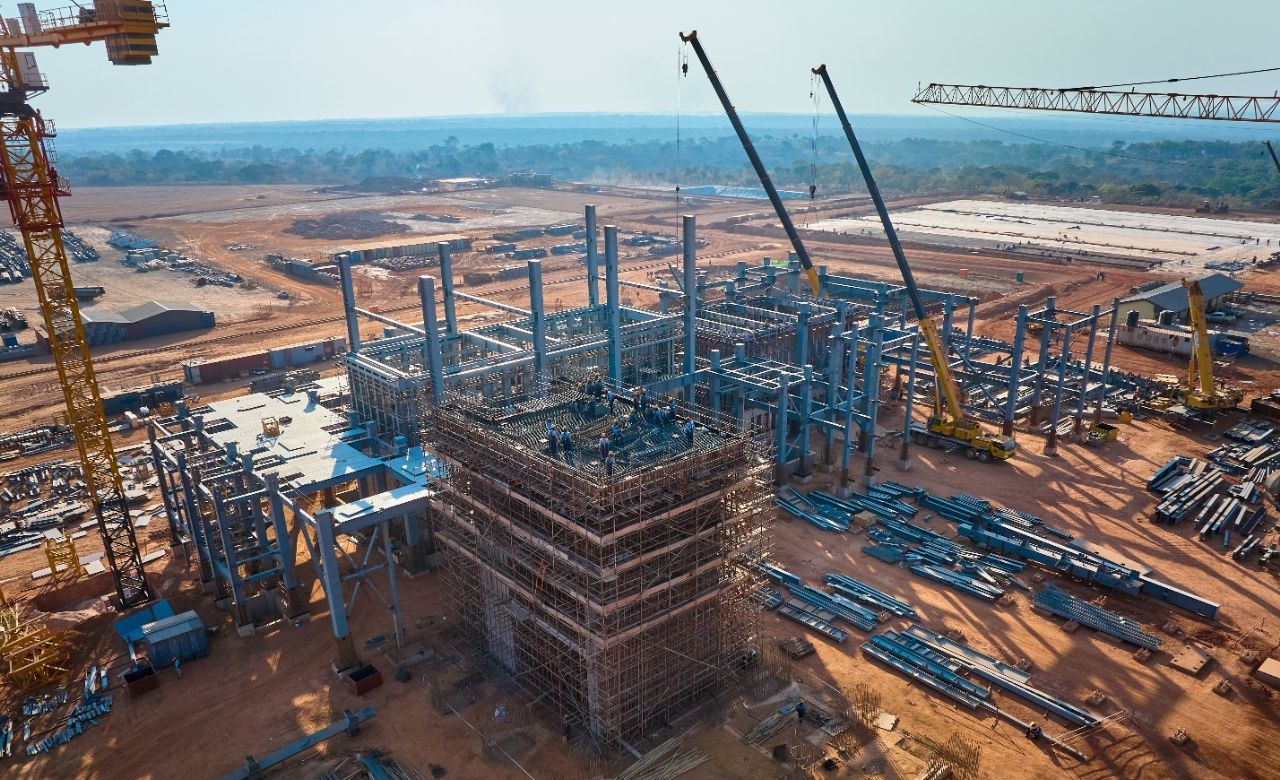

Construction of the Phase 3 concentrator plant and associated infrastructure is advancing well

Kamoa-Kakula’s ongoing Phase 3 expansion is expected to be commissioned in Q4 2024 and includes a new 5-Mtpa concentrator at Kamoa, which is approximately 10 kilometres north of the Phase 1 and 2 concentrators.

The process design of the Phase 3 concentrator is very similar to that of the Phase 1 and 2 concentrators, but 30% larger. The front end of the concentrator (stockpile, crushing and screening) is being built to a capacity of 10 Mtpa, double the required capacity for Phase 3, in anticipation of the future Phase 4 expansion. This follows the same construction approach as that of Phase 1 and Phase 2. The bulk of the equipment is the same or similar to that installed in the Phase 1 and 2 concentrators, resulting in a commonality of spare parts, while also leveraging prior operational and maintenance experience.

Following the commissioning of Phase 3, Kamoa-Kakula will have a total design processing capacity of 14.2 Mtpa. The completion of Phase 3 is expected to increase annualized copper production to an average of approximately 620,000 tonnes per year over the next ten years, which will position Kamoa Copper as the world’s third-largest copper mining complex in 2027, and the largest copper mine on the African continent. See Figure 2.

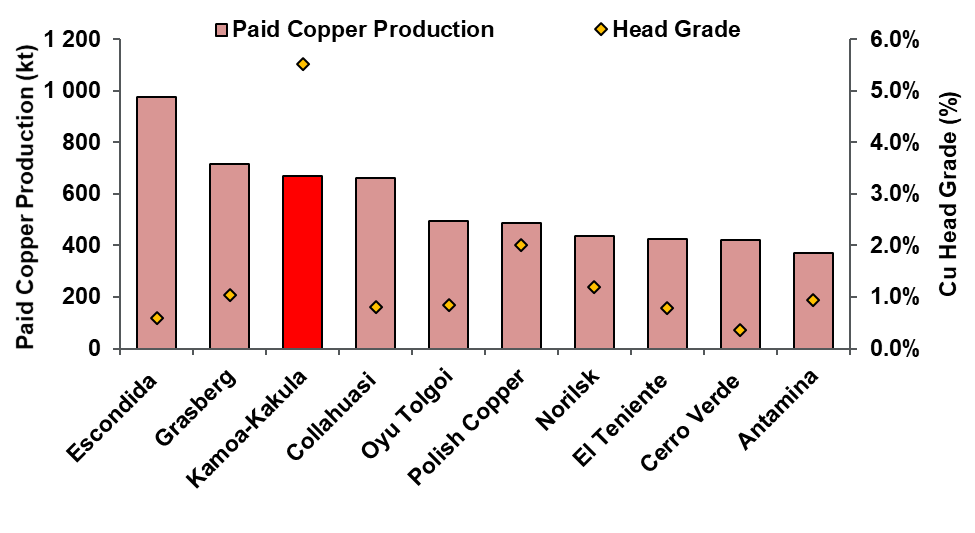

Figure 2: World’s projected top 10 copper mines in 2027, by key metrics.

Note: Kamoa-Kakula production and grade are based on the Kamoa-Kakula 2023 PFS. The ‘Cu Head Grade’ for the projects benchmarked by Wood Mackenzie reflects the average reserve grade.

Source: Wood Mackenzie, 2023 (based on public disclosure, the Kamoa-Kakula 2023 PFS has not been reviewed by Wood Mackenzie).

Kamoa-Kakula's Phase 3 expansion, consisting of two new underground mines known as Kamoa 1 and Kamoa 2 and a new, 5-Mtpa concentrator plant, is well on track for first production in the fourth quarter of 2024. Construction of the twin declines to the Kamoa 1 and Kamoa 2 underground mines and excavation to access the Phase 3 mining areas is advancing well. The Kamoa 1 and Kamoa 2 mines share a single box cut with a twin service-and-conveyor decline. Over 2,000 metres of linear advance across both declines have been completed to date and access to the Kamoa 2 Mine has been achieved, holing of the services decline is expected in October 2023. Underground mining activities are expected to commence at Kamoa 1 in late 2023 and Kamoa 2 in 2025, which will both involve the same mechanized drift-and-fill mining methods used at the Kakula Mine.

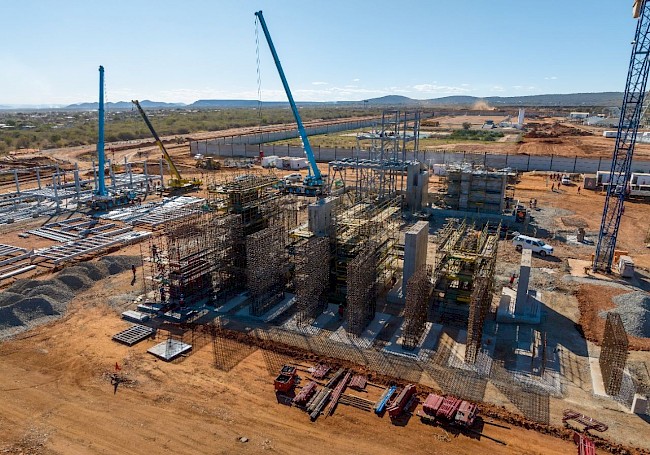

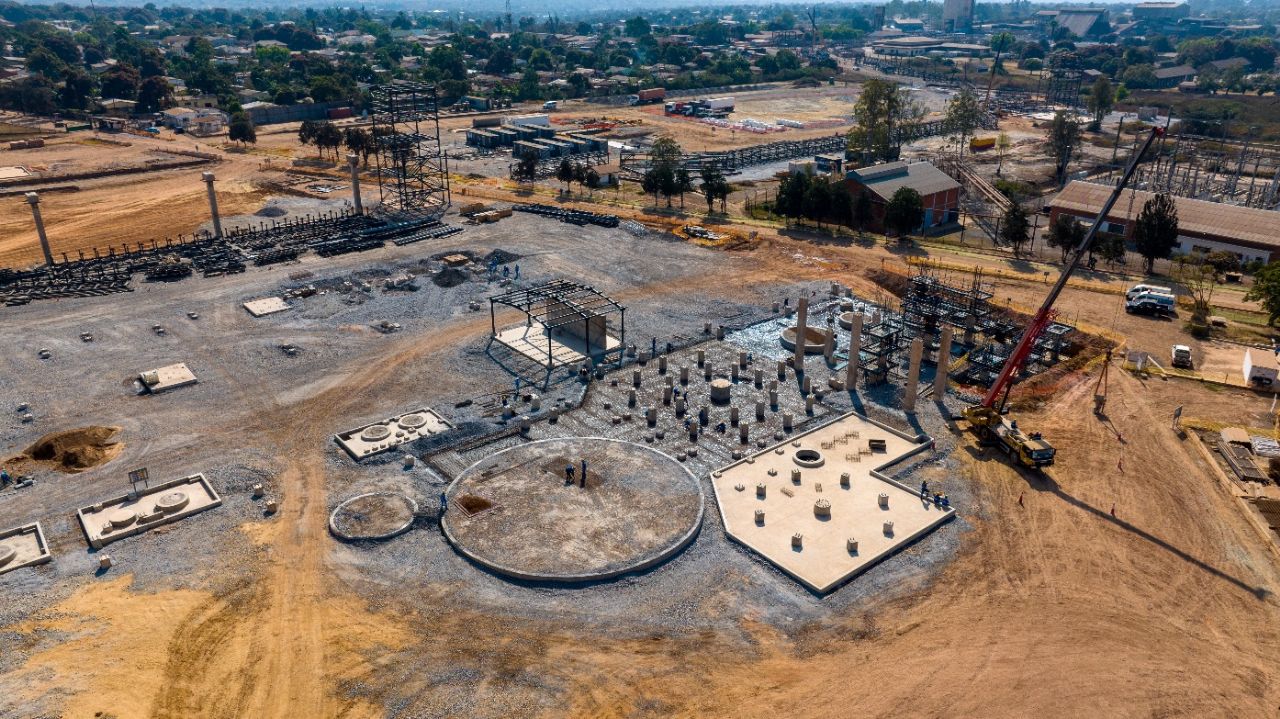

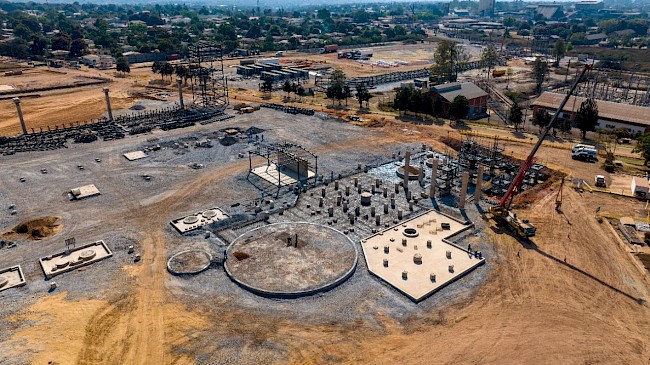

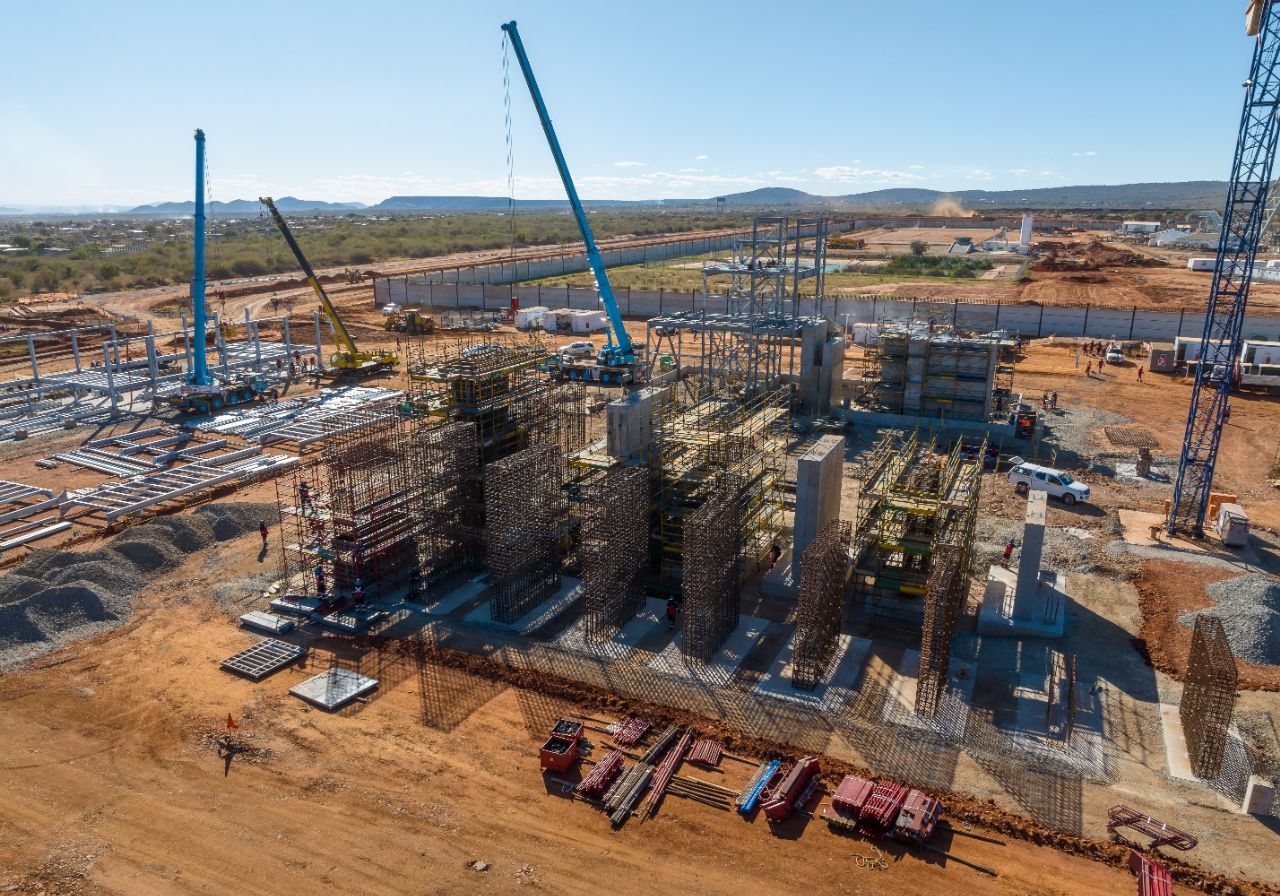

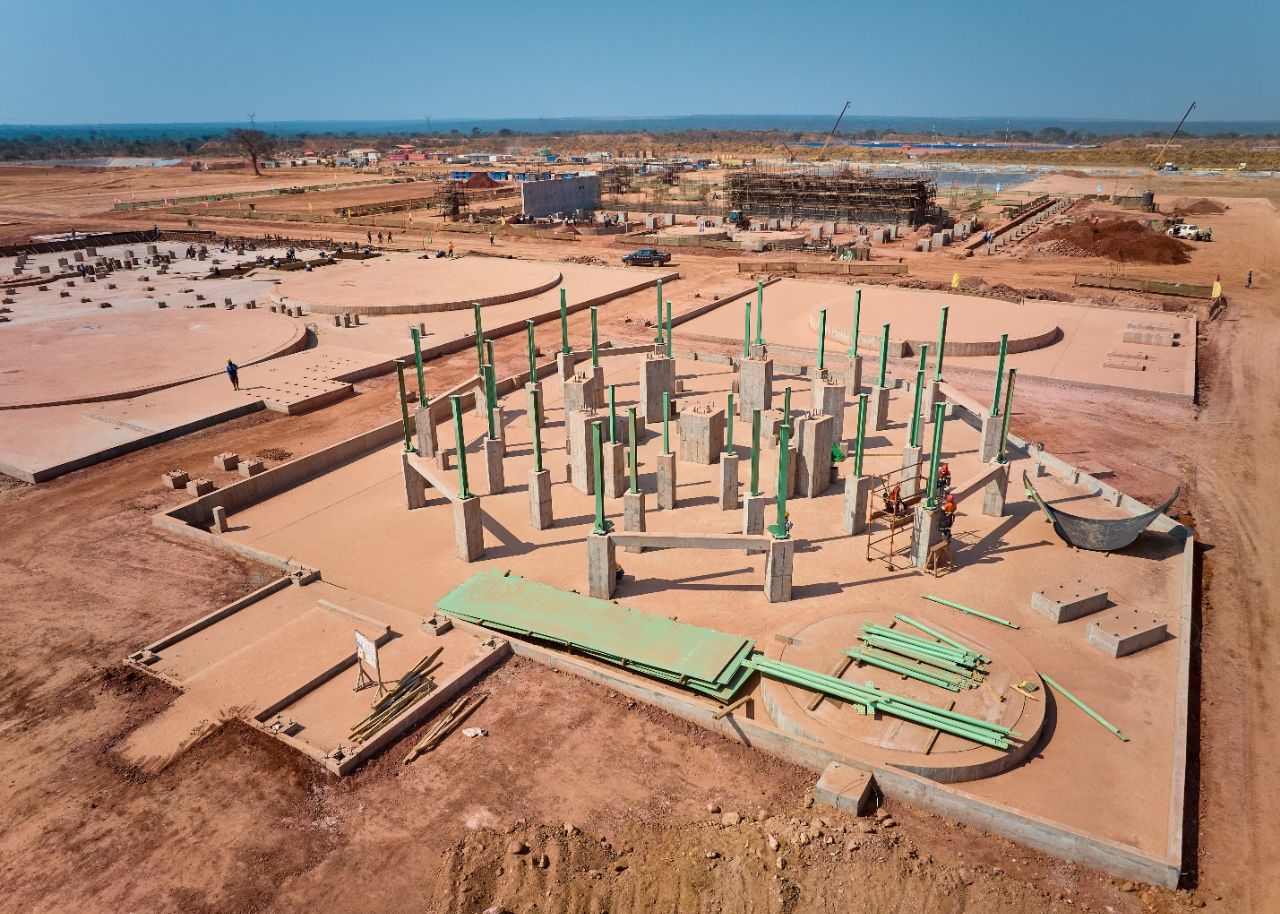

Civil works for Kamoa-Kakula's Phase 3 concentrator plant are nearing completion, with over 25,000 cubic metres of concrete poured to date.

Construction of the concentrate thickener base is progressing well at Kamoa-Kakula’s Phase 3 concentrator site.

Representatives from DRC-based contractor Prospere stand with members of the Kamoa Copper team in front of the foundation for Kamoa-Kakula's Phase 3 ball mill circuit.

Phase 3 concentrator project is 38% complete and on schedule for production in the fourth quarter of 2024

Detailed Phase 3 engineering design and procurement activities are nearly complete, with fabrication activities now 61% advanced. The rate of equipment deliveries to site is steadily increasing. A total of 505 of the forecasted 1,799 truck deliveries have already taken place and a further 224 trucks ladened with equipment are currently en route to site.

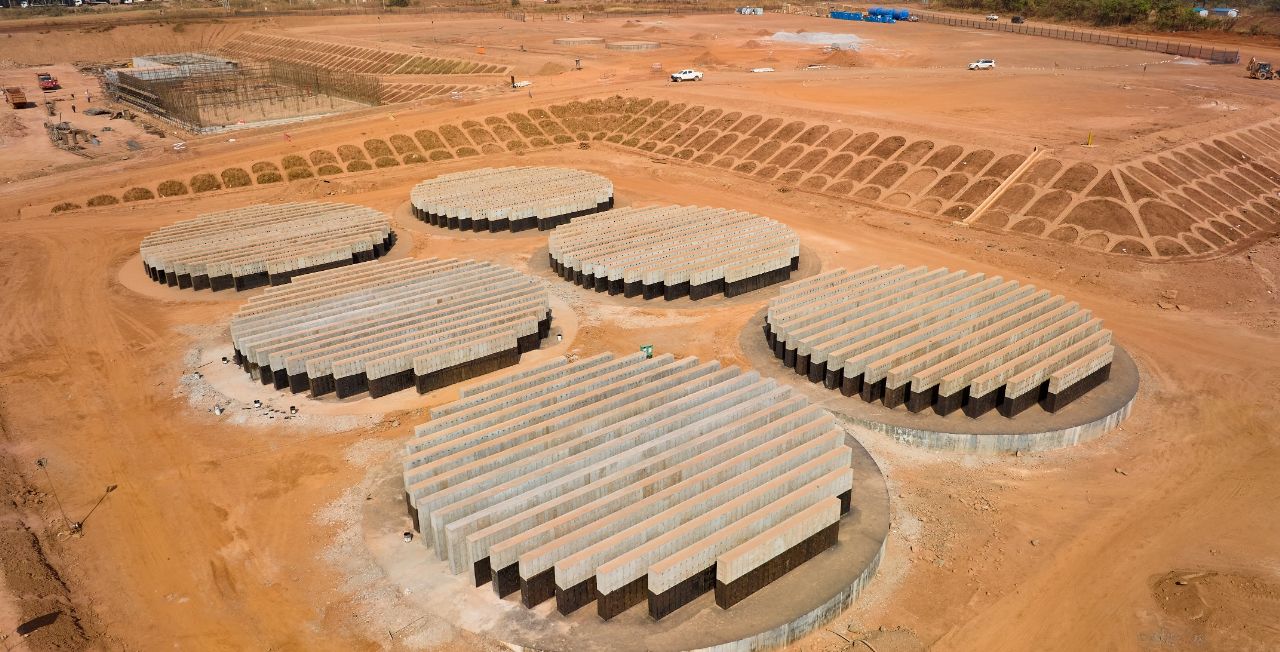

Civil works are nearing completion, with over 25,000 cubic metres of the total 30,000 cubic metres of concrete poured to date. The steel, mechanical, piping and plate work (SMPP) contract was also awarded during the quarter. Delivery of structural steel commenced during the quarter. Over 5,000 tonnes of the required 7,400 tonnes of structural steel and plate work have shipped to site. Orders for approximately 50,000 metres of the total 73,000 metres of piping have also been placed.

The last lot of the 1,830-tonne primary and secondary ball mill equipment package has been shipped by CITIC Heavy Industries of Henan province, China, with the first containers delivered to the Port of Durban, South Africa. Installation of the first of the two ball mills has commenced at the Phase 3 concentrator site, with scaffolding work well advanced. The first lots of the cone crushers, flotation cells, vibrating screens, concentrate filters, cyclone cluster, compressor and pump mechanical equipment packages are expected to be delivered to site imminently. Furthermore, the apron feeder was recently lifted into position inside the Phase 3 run-of-mine stockpile tunnel.

Smelter project is 56% complete and on target for commissioning in the fourth quarter of 2024

The Phase 3 expansion also includes the integration of Africa’s largest direct-to-blister flash smelter, which will have a capacity of 500,000 tonnes of 99+%-pure blister copper anodes per annum. The on-site smelter is being built adjacent to the existing Phase 1 and Phase 2 concentrator plants. The smelter will incorporate leading-edge technology supplied by Metso Outotec of Espoo, Finland and will meet the world-leading International Finance Corporation’s (IFC) emissions standards.

All major foundations for the equipment and buildings are complete. Most of the structural steel and equipment have been ordered and are now being manufactured. The first lots of structural steel and mechanical equipment have been delivered to site. Approximately 726 truckloads of steel and equipment out of an estimated total of 5,400 have been delivered. The main mechanical and electrical construction contractors have been appointed and mobilization is underway. Mechanical erection has started for the direct-to-blister flash furnace and electric slag-cleaning furnace and gas cleaning system. Approximately 2,000 construction workers are now working at the smelter site, and this is expected to peak at 3,000 in December 2023.

Kamoa-Kakula’s Phase 3 expansion includes the refurbishment of Turbine #5 at the Inga II hydroelectric power station. The turbine will supply an additional 178 megawatts of clean hydroelectric power to the national grid, which is sufficient to meet the power requirements of the Phase 3 concentrator, the flash smelter, as well as provide spare capacity for future expansions. The 99.7% pure blister anode copper produced from Kamoa-Kakula’s smelter is expected to be among the lowest carbon-dioxide emitters in the world per tonne of copper produced.

Civil construction of Kamoa-Kakula's Phase 3 direct-to-blister smelter furnace is progressing on schedule for completion in Q4 2024. It will be Africa’s largest direct-to-blister flash smelter.

Foundations and civil construction for the Phase 3 smelter high-strength acid storage and dispatch also are advancing on schedule. All major foundations for the equipment and buildings are complete.

The smelter will have a processing capacity of approximately 1.2 Mtpa of dry concentrate feed and is designed to run on a blend of concentrate produced from the Kakula (Phase 1 and 2) and Kamoa (Phase 3 and future Phase 4) concentrators. Under the Kamoa-Kakula 2023 Integrated Development Plan, the smelter is projected to accommodate approximately 80% of Kamoa-Kakula’s total concentrate production. Kamoa-Kakula will also continue to toll-treat concentrates under a 10-year agreement with the Lualaba Copper Smelter (LCS), located approximately 50 kilometres from Kamoa-Kakula, near the town of Kolwezi. Deliveries to LCS are expected to account for approximately 150,000 tonnes of copper concentrate annually.

As a by-product, the smelter will also produce in the region of 650,000 to 800,000 tonnes per year of high-strength sulphuric acid. There is strong demand for sulphuric acid in the DRC, as it is used to recover copper from oxide ores via the SX-EW (solvent extraction and electrowinning) process. The DRC market consumed approximately 6 million tonnes of acid in 2022. The vast majority of the consumed high-strength sulphuric acid is imported by regional consumers in the form of sulphur and burned in domestic acid plants.

The on-site smelter will offer transformative financial benefits for the Kamoa-Kakula Copper Complex, most notable being a material reduction in logistics costs, and to a lesser extent reduced concentrate treatment charges and local taxes, as well as revenue from acid sales. Logistics costs accounted for 32% of Kamoa-Kakula’s total cash costs (C1) during Q2 2023, and the volume of shipments is expected to halve following the Phase 3 expansion as trucks will transport 99+%-pure blister copper anodes instead of concentrate with approximately 50% contained copper. According to the Kamoa-Kakula 2023 Prefeasibility Study, smelter commissioning is expected to drive a decrease in average cash costs (C1) over the first five years (from 2025) to approximately $1.15/lb. of copper, a 21% reduction from the midpoint of the 2023 guidance of $1.45/lb. of payable copper produced.

Kamoa-Kakula’s Phase 3 expansion also includes the rehabilitation of Turbine #5 at the Inga II hydroelectric power station, which is progressing well. The replaced turbine will supply an additional 178 megawatts (MW) of clean hydroelectric power to the national grid and provide power for Phase 3. Study work is also progressing well to upgrade the transmission capacity of the existing grid infrastructure between the Inga II hydropower facility and the Kamoa site.

COPPER PRODUCTION AND CASH COST GUIDANCE FOR 2023

Kamoa-Kakula 2023 Guidance

Contained copper in concentrate (tonnes)

390,000 to 430,000

Cash cost (C1) ($ per pound)

1.40 to 1.50

2023 full-year cash cost (C1) and production guidance remain unchanged. The figures are on a 100%-project basis and metal reported in concentrate is before refining losses or deductions associated with smelter terms. Kamoa-Kakula’s 2023 guidance is based on several assumptions and estimates and involves estimates of known and unknown risks, uncertainties and other factors that may cause the actual results to differ materially.

Production guidance is based on assumptions about the disruption of power supply, among other things. The Kamoa-Kakula joint venture produced a total of 333,497 tonnes of copper in concentrate for the year ending December 31, 2022, and 197,389 tonnes in the first half of 2023 including 103,786 tonnes of copper in concentrate in Q2 2023.

Cash costs (C1) per pound of payable copper amounted to $1.41 for Q2 2023 and to $1.42 for Q1 2023.

Cash cost (C1) guidance is based on assumptions including, among other things, prevailing logistics costs based on estimated regional trucking capacity, particularly as regional idled operations are expected to come online, as well as increased benchmark treatment and refining charges, and inflation in consumables and other inputs.

C1 cash cost is a non-GAAP measure used by management to evaluate operating performance and includes all direct mining, processing, stockpile rehandling charges, and general and administrative costs. Smelter charges and freight deductions on sales to the final port of destination (typically China), which are recognized as a component of sales revenues, are added to C1 cash cost to arrive at an approximate cost of delivered finished metal.

For historical comparatives, see the non-GAAP Financial Performance Measures section of this news release.

Chikuk Kawiz Lea, a member of Kamoa's CADET program, stands at the Phase 1 and Phase 2 concentrator site. The program trains members of local communities for high-skill jobs at Kamoa-Kakula.

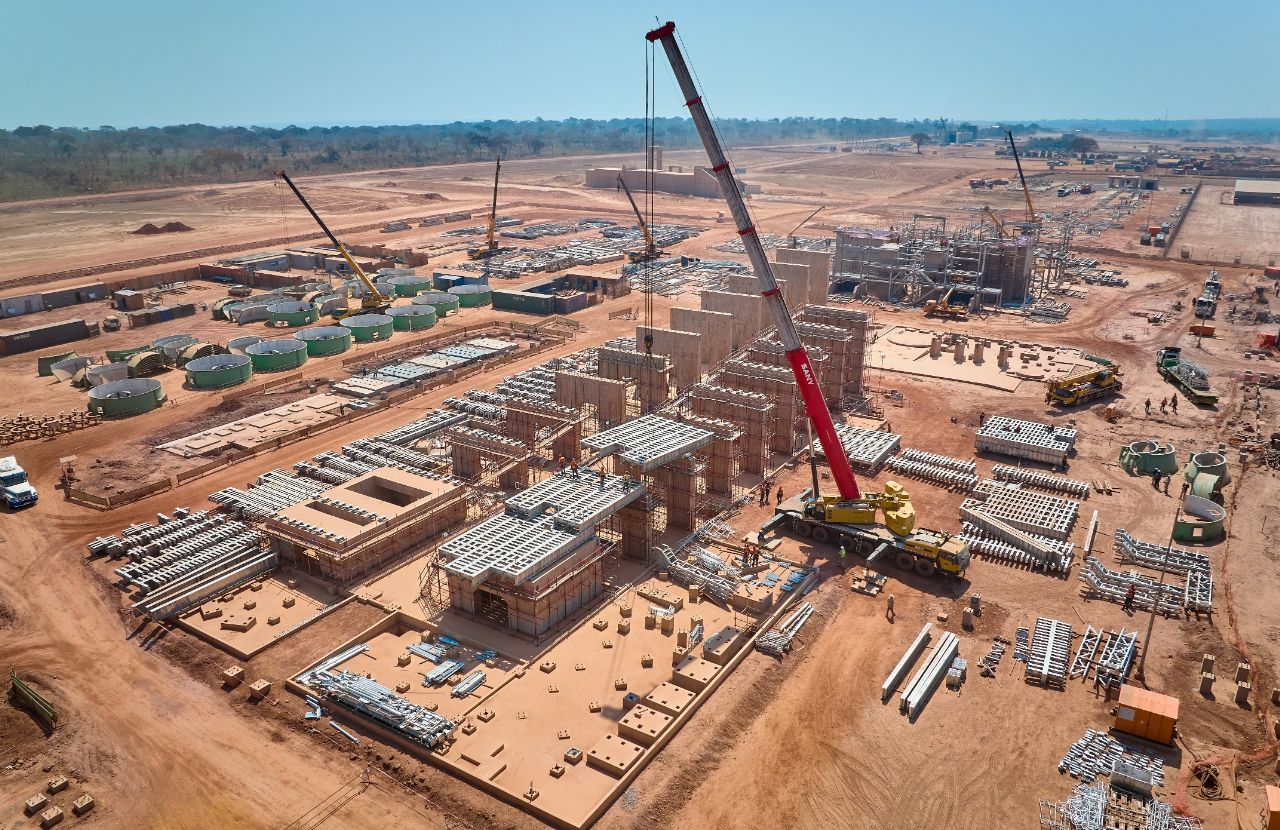

Construction teams at Kamoa-Kakula's Phase 3 concentrator site prepare for a structural steel lift with a new 450-tonne crane.

2. Platreef Project
64%-owned by Ivanhoe Mines
South Africa

The Platreef Project is owned by Ivanplats (Pty) Ltd (Ivanplats), which is 64%-owned by Ivanhoe Mines. A 26% interest is held by Ivanplats’ historically disadvantaged, broad-based, black economic empowerment (B-BBEE) partners, which include 20 local host communities with approximately 150,000 people, project employees and local entrepreneurs. A Japanese consortium of ITOCHU Corporation, Japan Oil, Gas and Metals National Corporation, and Japan Gas Corporation, owns a 10% interest in Ivanplats, which it acquired in two tranches for a total investment of $290 million.

The Platreef Project hosts an underground deposit of thick, platinum-group metals, nickel, copper, and gold mineralization on the Northern Limb of the Bushveld Igneous Complex in Limpopo Province – approximately 280 kilometres northeast of Johannesburg and eight kilometres from the town of Mokopane in South Africa.

On the Northern Limb, platinum-group metals mineralization is primarily hosted within the Platreef, a mineralized sequence traced for more than 30 kilometres along the strike. Ivanhoe’s Platreef Project, within the Platreef’s southern sector, is comprised of two contiguous properties: Turfspruit and Macalacaskop. Turfspruit, the northernmost property, is contiguous with, and along strike from, Anglo Platinum’s Mogalakwena group of mining operations and properties.
Since 2007, Ivanhoe has focused its exploration and development activities on defining and advancing the down-dip extension of its original discovery at Platreef, now known as the Flatreef Deposit, which is amenable to highly mechanized, underground mining methods. With Shaft 1, the initial access to the deposit, now in operation and hoisting development rock from underground, Ivanhoe is focusing on construction activities to bring Phase 1 of Platreef into production by Q3 2024.

Platreef development is currently funded by $300-million stream financing, with efforts to finalize an additional senior debt facility targeted for completion in Q3 2023.

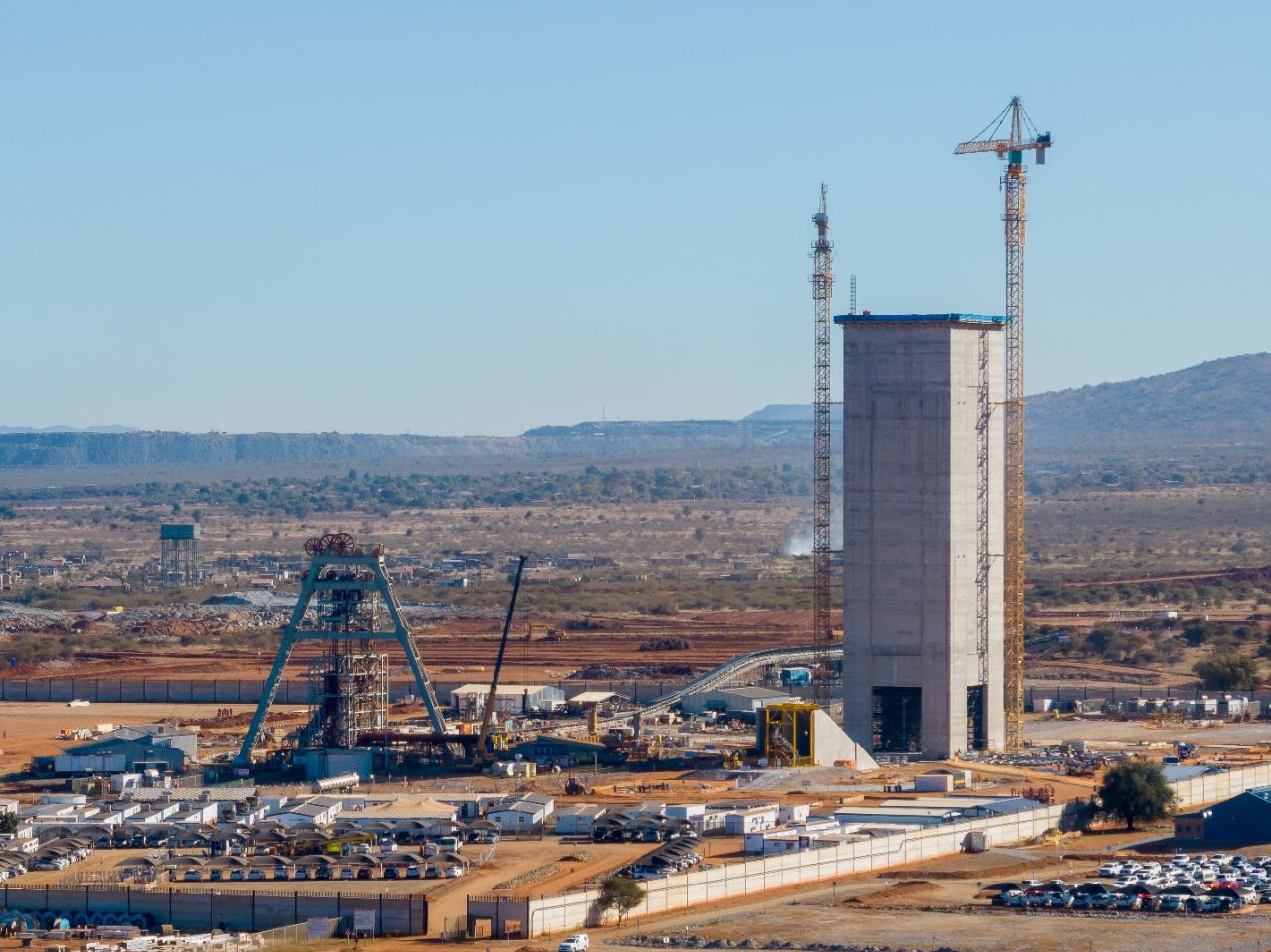

The Shaft 2 headgear concrete structure (right) beside Shaft 1 (left) was completed early in the quarter to a height of approximately 79 metres. Shaft 2’s overall height will be approximately 100 metres above ground, including the steel structure housing the main winders.

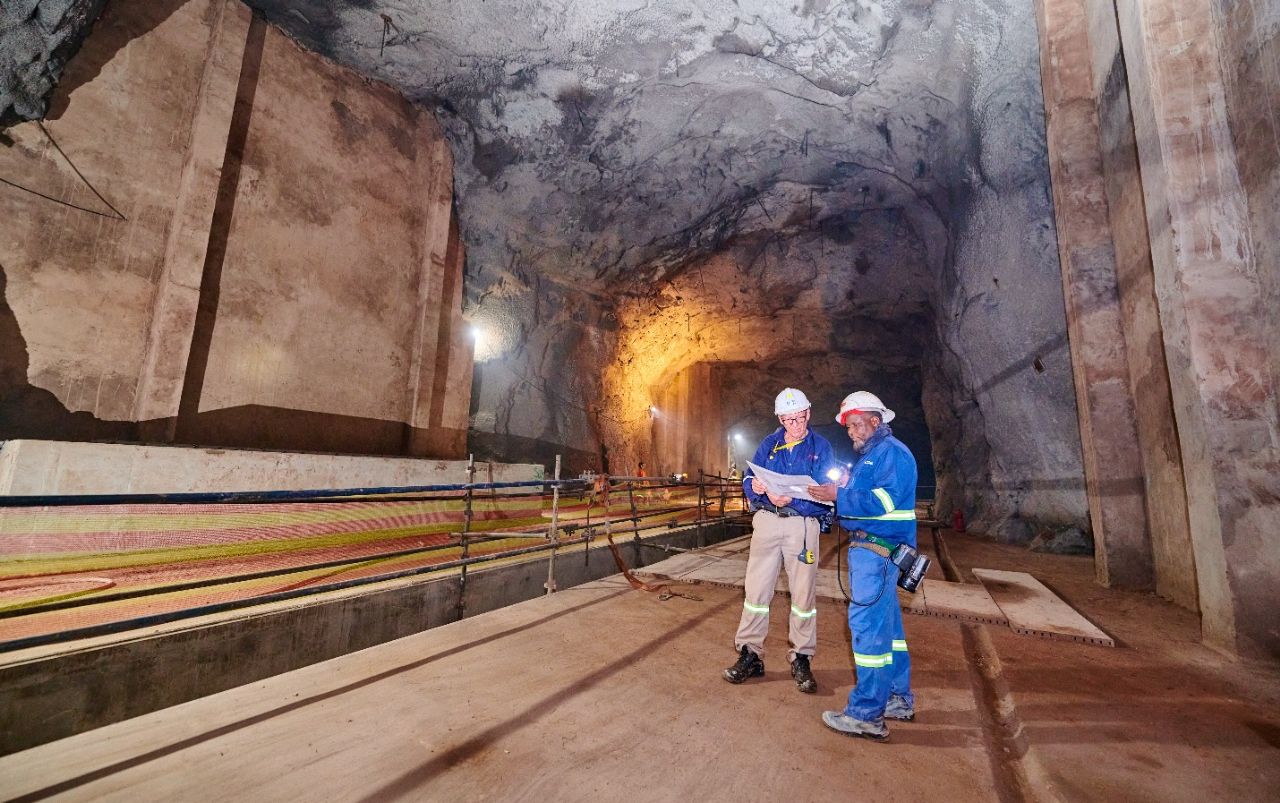

Surface construction activities and lateral underground mine development are progressing well

Underground development work has been focused on lateral development towards the high-grade Flatreef orebody on the 750-metre, 850-metre and 950-metre levels. More than 2,000 metres of lateral development has been completed to date across all three levels (750-metre, 850-metre and 950-metre levels), advancing at a rate of approximately 200 metres per month. Once the crusher and loading feeder installation on the 950-metre level is completed at the end of August, the rate of lateral underground development is expected to continue to increase to approximately 300 metres per month through the remainder of the year. From January 2024, the advancement rate is expected to increase to approximately 500 metres per month.

Platreef's Phase 1 concentrator is on schedule for first production in Q3 2024. All foundation concrete has been poured, with formwork and steel fixing of the walls and plinths commenced. The fabrication of the long-lead order mechanical equipment items is progressing as planned. Over 70% of all Phase 1 orders have been placed. Structural, mechanical, plate work & piping (SMPP) and the mill building structural steel erection commenced in April with approximately 160 tonnes of the total 1,500 tonnes of steelwork erected to date. The Electrical, Control & Instrumentation (EC&I) installation work package has been placed, with site establishment and onboarding completed.

Foundation for Platreef's Phase 1 flotation cells is advancing well. Platreef's Phase 1 concentrator is on schedule for first production in Q3 2024, with all foundation concrete poured.

The 10-metre diameter Shaft 2 currently under construction will have a hoisting capacity of 8 Mtpa. Shaft 2 will be utilized in subsequent development phases and will be among the largest hoisting shafts in the world. The Shaft 2 headgear concrete structure was completed early in the quarter to a height of approximately 79 metres. Shaft 2’s overall height will be approximately 100 metres above ground, including the steel structure housing the main winders. The Shaft 2 headgear internal structural steel construction is progressing well. The kibble and stage winder civil construction is nearing completion with the winder deliveries planned for December 2023. The kibble winder ropes were recently delivered.

Drilling of the pilot drill hole for the reaming of Shaft 2, which commenced in February 2023, has reached the shaft bottom. Preparations are now underway to commence reaming Shaft 2 to an initial diameter of 3.1 metres. Raise boring will commence from the 950-metre level once bottom access has been established.

Construction of Platreef’s first 5-MW solar-power plant commenced in Q4 2022 with commissioning expected later this year. The solar power plant inverter and solar panels were recently delivered to site. The power generated by this plant will support development activities and operations, together with other renewable energy sources to be introduced over time.

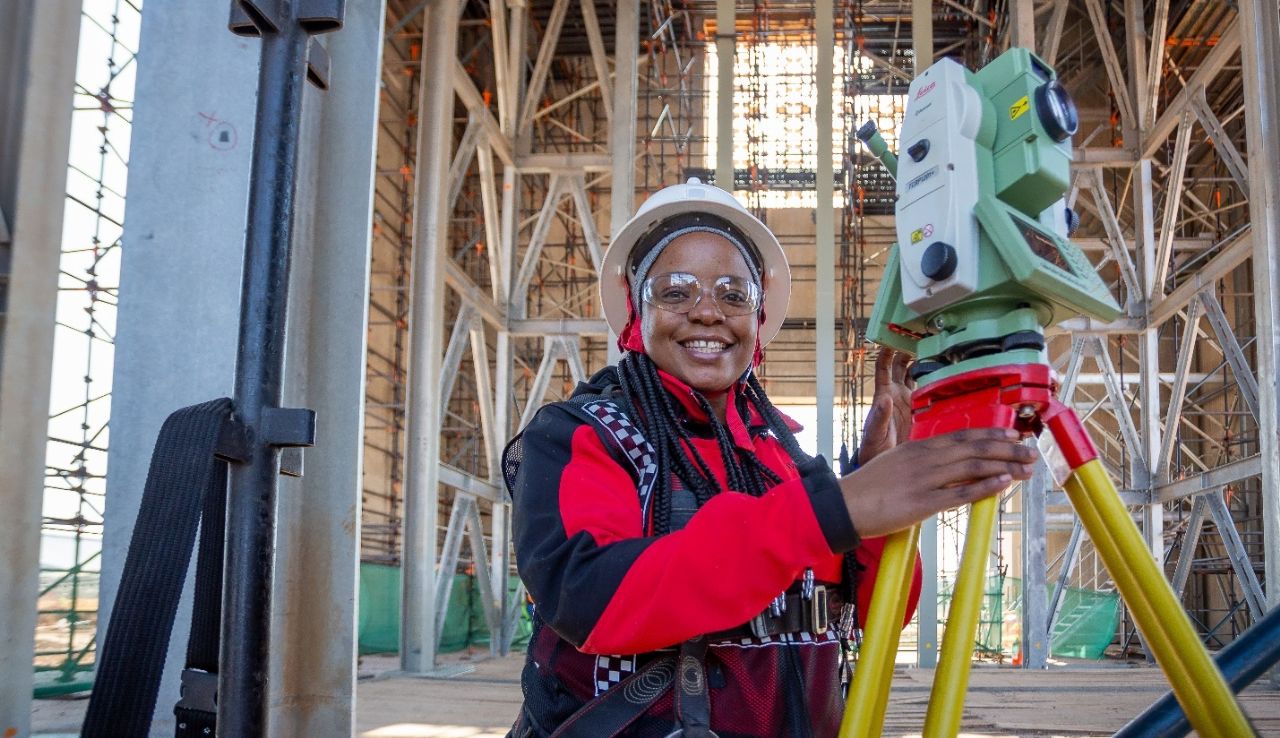

Sina Kekana, surveyor assistant, working at the base of Platreef's Shaft 2, which is on schedule for completion in late 2027.

Optimization work is underway to potentially accelerate Platreef’s Phase 2 expansion

Ivanhoe has initiated optimization work to identify value-accretive options for installing hoisting capacity in Shaft 3 (previously named Vent Shaft 1). Shaft 3, originally planned as a ventilation and secondary escape shaft, is currently under construction and is now planned to be equipped for hoisting, which will provide additional hoisting capacity to remove ore and waste from the underground mine. This has the benefit of de-risking the development and ramp-up of the Phase 1 mine and may be used to accelerate the

ramp-up of underground mining activities for Phase 2, in advance of the completion of Shaft 2, which is expected in 2027.

Shaft 3 is currently being reamed to a diameter of 5.1 metres. Approximately 340 metres of 950 metres have been reamed to date, with planned completion in Q4 2023. The manufacturing of the auxiliary winder for the Shaft 3 headgear is well-advanced and on schedule. The civil contractor responsible for the foundations of the stage winder and equipping winder has been appointed and is mobilizing.

Long-term supply of bulk water for the Platreef Mine

The water requirement for the Phase 1 operation is projected to peak at approximately three million litres per day, which will then increase to nine million litres per day once the Phase 2 expansion is complete. In January 2022, Ivanplats signed new agreements for the rights to receive local, treated water to supply the bulk water needed for the phased development plan at Platreef. These agreements replace those originally signed in 2018.

Under the terms of a new offtake agreement, the Mogalakwena Local Municipality (MLM) has agreed to supply at least three million litres per day of treated effluent, up to a maximum of 10 million litres per day for 32 years, from the date of first production, sourced from the town of Mokopane’s Masodi Wastewater Treatment Works, currently under construction.

Ivanplats also has signed a sponsorship agreement where Ivanplats has undertaken the commitment to complete the partially constructed Masodi Wastewater Treatment Works, which was halted in 2018. Since construction was restarted, work on the completion of the water treatment plant is progressing well towards completion in Q3 2023.

In addition, Ivanplats signed the Memorandum of Agreement to upgrade and refurbish the sewerage treatment infrastructure to increase the water offtake for future expansions.

3. Kipushi Project
68%-owned by Ivanhoe Mines
Democratic Republic of Congo

The Kipushi zinc-copper-germanium-silver-lead mine in the DRC is adjacent to the town of Kipushi, approximately 30 kilometres southwest of Lubumbashi on the Central African Copperbelt. Kipushi is approximately 250 kilometres southeast of the Kamoa-Kakula Copper Complex and less than one kilometre from the Zambian border. Ivanhoe acquired its 68% interest in the Kipushi Project in November 2011, through Kipushi Holding which is 100%-owned by Ivanhoe Mines. The balance of 32% in the Kipushi Project is held by the state-owned mining company, Gécamines.

The Kipushi 2022 Feasibility Study focuses on the mining of Kipushi’s zinc-rich Big Zinc and Southern Zinc zones, with an estimated 11.8 million tonnes of Measured and Indicated Mineral Resources grading 35.3% zinc. Kipushi’s exceptional zinc grade is more than twice that of the world’s next- highest-grade zinc project, according to Wood Mackenzie, a leading, international industry research and consulting group.

On April 27, 2023, Ivanhoe Mines announced the signing of a tri-partite offtake and financing term sheet between Kipushi Corporation SA, Gécamines and Glencore International AG (Glencore) to return the historic Kipushi zinc-copper-lead-germanium mine to production.

The offtake is for 100% of Kipushi’s zinc concentrates; between 400,000 and 600,000 dry metric tonnes per annum over a five-year term. The offtake term sheet contains standard, international commercial terms, including payables and treatment charges based on the zinc industry’s annual benchmark. The concentrate produced by Kipushi is expected to contain approximately 55% zinc and low levels of impurities. The buyer will purchase the concentrate at the Kipushi Mine on a free-carrier basis, meaning the buyer will be responsible for arranging freight and shipment to the destination, with such costs reimbursed by Kipushi.

The $250 million term financing facility will be split into two tranches and drawn down quarterly, subject to conditions precedent. The facility will bear an annual interest rate of the Secured Overnight Financing Rate (SOFR) plus 7% and shall be repaid, following a 24-month grace period from signing, in quarterly instalments over 36 months.

The offtake and financing term sheet is subject to the execution of final, binding agreements, which are expected to be concluded in conjunction with the new Kipushi joint-venture agreement.

In June 2023, Kipushi Corporation finalized an unsecured, $80-million financing facility with Rawbank SA. Rawbank is the largest domestic bank in the DRC, with a loan book to the DRC’s mining industry expected to increase to over $1 billion by the end of 2024.

The new facility has an annual interest rate of 8% and will rank junior to the $250 million facility supported by Glencore. In addition, a corporate guarantee is provided by Ivanhoe Mines. Kipushi Holding has also drawn down the first of the two $40 million tranches. The facility will be used to finance ongoing construction activities, reducing the shareholder loan requirement to Kipushi Corporation by Ivanhoe Mines.

The remaining initial capital for the Kipushi Project is $354 million, which will be funded by a combination of the new $80 million Rawbank facility and the $250 million facility supported by Glencore, with any shortfall covered by additional shareholder loans from Ivanhoe Mines.

As previously reported, Kipushi Holding and Gécamines signed a new agreement to return the ultra-high-grade Kipushi Mine to commercial production in Q1 2022, which sets out the commercial terms that will form the basis of a new Kipushi joint-venture agreement establishing a robust framework for the mutually beneficial operation of Kipushi for years to come and are subject to execution of definitive documentation. Once the agreement is concluded, it is anticipated that Ivanhoe Mines’ ownership in the Kipushi Project will reduce to 62%, with Gécamines holding the balance of 38%.

Construction of the new 800,000-tonne-per-annum concentrator facility is well underway. The concentrator is expected to produce more than 270,000 tonnes of zinc over the first five years of production.

Over 69 years, Kipushi produced a total of 6.6 million tonnes of zinc and 4.0 million tonnes of copper from 60 million tonnes of ore grading 11% zinc and approximately 7% copper. It also produced 278 tonnes of germanium and 12,673 tonnes of lead between 1956 and 1978. There is no formal record of the production of precious metals as the concentrate was shipped to Belgium and the recovery of precious metals remained undisclosed during the colonial era; however, drilling by Ivanhoe Mines has encountered significant silver values within Kipushi’s current zinc- and copper-rich deposits.

Since acquiring its interest in the Kipushi Mine in 2011, Ivanhoe’s drilling campaigns have upgraded and expanded the mine’s zinc-rich Measured and Indicated Mineral Resources to an estimated 11.78 million tonnes grading 35.34% zinc, 0.80% copper, 23 grams/tonne (g/t) silver and 64 g/t germanium, at a 7% zinc cut-off, containing 9.2 billion pounds of zinc, 8.7 million ounces of silver and 24.4 million ounces of germanium.

Based on testwork conducted for the Kipushi 2022 Feasibility Study, concentrate assays for the Kipushi Mine include significant quantities of germanium and gallium.

Germanium is a strategic metal used today in electronic devices, flat-panel display screens, light-emitting diodes, night vision devices, optical fibre, optical lens systems, and solar power arrays.

Gallium is a strategic metal used today to manufacture compound semiconductor wafers used in integrated circuits, and optoelectronic devices such as laser diodes, light-emitting diodes, photodetectors, and solar cells.

Kipushi concentrator is on schedule for first production in Q3 2024, with the overall project approximately 50% complete

Construction of the new 800,000-tonne-per-annum concentrator facility is well underway. The concentrator includes dense media separation (DMS) and a milling and flotation circuit and is expected to produce more than 270,000 tonnes of zinc contained in concentrate over the first five years of operations. Design recoveries are targeted at 96%, with a concentrate grade of 55% contained zinc.

With overall project progress at approximately 50% complete, the Kipushi concentrator is on schedule and expected to be commissioned in Q3 2024. Detailed design is effectively complete, ahead of schedule. Procurement activities are nearing completion, with only five equipment packages outstanding. To date, 15 of the total 73 equipment packages have been delivered to site with a number, including the ball mill, currently en route.

The ball mill, fabricated by CITIC Heavy Industries of Henan Province, China, has arrived at the port of Durban, South Africa, and is expected to be delivered to site within a month. The DMS plant fabricated by Bond Equipment in Gauteng, South Africa, has been completed and is being prepared to be trucked to site. The fabrication of the flotation cells by FL Smidth in Gauteng, South Africa, is also complete and will be delivered to site in the coming month.

Kipushi steel erection commenced in April 2023 with 1,342 tonnes of total 2,074 tonnes dispatched to site. With overall project progress at approximately 50% complete, the Kipushi concentrator is on schedule and expected to be commissioned in Q3 2024.

The structural, mechanical, piping and plate work (SMPP) contractor has completed and handed over its first structure, which is the electrical substation building.

Underground development activity is ramping up, with 2,147 metres of lateral development completed since September 2022. Stoping of the ultra-high-grade Big Zinc orebody is expected to begin in January 2024.

In line with the 2022 Kipushi Feasibility Study, mining will focus on the zinc-rich Big Zinc and Southern Zinc zones, with an estimated 11.8 million tonnes of Measured and Indicated Mineral Resources grading 35.3% zinc. Kipushi’s exceptional zinc grade is more than twice that of the world’s next- highest-grade zinc project, according to Wood Mackenzie, a leading, international industry research and consulting group.

In the first quarter of 2023, the underground mining contractor was appointed, and the phased on-site mobilization of mining crews and equipment is well underway. The primary mining fleet is supplied by Epiroc of Stockholm, Sweden. Over half of the primary fleet and secondary support equipment has been mobilized, with the remainder expected to be delivered at the end of the third quarter.

The underground mining operation is fully mechanized, highly efficient and designed to enable a quick ramp-up to a steady state. At the end of the second quarter, three mining crews have been deployed underground. Each mining crew made up of five miners per shift, is equipped with a primary fleet consisting of an Epiroc 282 Twin Boomer, a ST 14 Scooptram (LHD) and two MT42 dump trucks.

Tinette Brümmer from Epoch Resources at the earthworks site for Kipushi’s new tailings storage facility.

The first Simba long-hole drill rig for stoping (production mining) has also arrived on site and is being prepared to be lowered underground. Concurrent training of new underground miners is ongoing, targeting a full complement of four crews by the end of the third quarter.

Underground development is taking place to open multiple access levels to the Big Zinc orebody, from the top down. Perimeter, access and ventilation drives are under development at several locations between the 1,220-metre and 1,335-metre levels, while decline development continues to spiral down parallel to the plunging Big Zinc deposit. 1,526 metres of horizontal development have been completed year to date, approximately 20% ahead of schedule.

The year-to-date underground development rate have averaged approximately 250 metres per month. Following the mobilization of the remaining underground equipment fleet and the fourth mining crew, the underground development rate is expected to increase to approximately 450 metres per month by year-end.

Underground development throughout the remainder of the year will increasingly be in ore, grading between 20-25% zinc. The ore will be hauled to surface and stored on the stockpile ahead of concentrator commissioning.

With underground development well ahead of schedule, stoping of the ultra-high-grade Big Zinc orebody has been accelerated to commence in January 2024. Stoping is the process of extracting the ore from an underground mine, leaving behind an open space known as a stope.

The mining method of the Big Zinc orebody will be transverse sublevel open stoping in a primary and secondary sequence. The void of the mined-out stopes will be filled with cemented aggregate to maximize the extraction of the ultra-high-grade ore.

The total mining height of long-hole stopes is 60 metres (comprising of an upper 30-metre-high stope and lower 30-metre-high stope), which will be separated by 15-metre-high sill pillars. The long-hole stopes will be mined with a bottom-up mining sequence, with the lower stope extracted first followed by the upper stope. The stopes will be extracted using a primary and secondary long-hole stoping sequence.

Kipushi’s operations will be supplied with hydroelectric power from DRC’s state-owned electricity company, SNEL. A study completed in 2020 by Wood Mackenzie ranked Kipushi at the 2nd percentile of the Scope 1 + 2 emissions curve. See Figure 3 below.

Figure 3. Global zinc mine site scope 1+2 greenhouse gas (GHG) emissions in equivalent kilograms of carbon dioxide per tonne of equivalent zinc produced (kg CO2-e / t Zn eq.). Scope 1+2 annual GHG emissions from the Kipushi mine are forecast to be 0.06 equivalent tonnes of carbon dioxide per tonne of zinc produced (tCO2e/t Zn).

Source: Wood Mackenzie, 2020

Dedicated Kipushi commercial border crossing to unlock direct access to Zambia

Kipushi Mine is adjacent to the border town of Kipushi, approximately 30 kilometres southwest of Lubumbashi on the DRC Copperbelt. Kipushi is approximately 250 kilometres southeast of the Kamoa-Kakula Copper Complex and less than one kilometre from the Zambian border.

The commercial border crossings at Kasumbalesa and Sakania, also in Haut-Katanga province, handle most of the DRC Copperbelt’s imports and exports. They are located 110 kilometres and 230 kilometres by road southeast of Kipushi, respectively. The Kasumbalesa border experienced significant congestion in 2022 and Ivanhoe Mines has been working with the provincial government of Haut-Katanga on a series of initiatives to de-bottleneck the exporting of mineral products from the DRC.

One such initiative is a new commercial DRC-Zambia road border crossing at the town of Kipushi. Earlier this year, a series of study options were presented and reviewed by the provincial government of Haut-Katanga and the national authorities in the DRC. An agreement has since been reached to go ahead with building the new border crossing at Kipushi.

The new commercial border infrastructure consists of three project areas: a new 11-kilometre, street-lit, sealed by-pass road looping around the southern edge of Kipushi town; a new one-stop border post on the southern edge of the Kipushi town on the DRC side of the border, consisting of a staging area and a new administration building; and a new one-stop border post also consisting of a staging area and new administration building on the Zambian side of the border.

The vendor appointment by the Haut-Katanga province for the 11-kilometre, by-pass road is expected to be made imminently, with the mobilization of construction contractors to be made in the coming month. Project award for the border infrastructure is expected to be made towards the end of 2023.

Concurrently, work is underway by the Zambian government to upgrade roads for commercial traffic on the Zambian side of the border, connecting the T5 highway to the new commercial Kipushi border (See Figure 4). Upgrades have already commenced on some sections of road, with further infrastructure upgrades and all-weather proofing planned to take place over the next 12 to 18 months.

A new commercial DRC-Zambia border crossing at Kipushi will not only benefit the Kipushi Mine but also Kamoa-Kakula as an additional route for exporting concentrate products. In addition, the border crossing will provide socio-economic benefits to the community of Kipushi and the city of Lubumbashi, the capital of Haut-Katanga province, which is approximately 30 kilometres away.

Figure 4. Map of the current and planned commercial DRC-Zambia border infrastructure.

Kipushi follows in Kamoa-Kakula’s footsteps with a strong focus on local recruitment and progressive workforce training. There are currently more than 1,800 employees and contractors working at the Kipushi site, peaking at approximately 2,000 in the fourth quarter of 2023. Once operations have ramped up to steady-state, total on-site labour, including mining and support contractors, is expected to be approximately 1,200. Of the current 504 full-time employees at Kipushi, approximately 97% are Congolese.

A training program is underway to ensure that skills and practical experience gained during Kamoa-Kakula’s construction, commissioning and operations are shared with the leadership and operations staff at Kipushi. Staff from Ivanhoe Mines regularly visit Kipushi and contribute to building on-site capacity, coaching and training, sharing lessons learned and experience gained at Kamoa-Kakula, while key personnel from Kipushi visit Kamoa-Kakula to learn from practical experience. A comprehensive up-skilling training program is also under development for Kipushi and is expected to be rolled out later this month.

4. Western Foreland Exploration Project
90%- to 100%-owned by Ivanhoe Mines
Democratic Republic of Congo

Ivanhoe’s DRC exploration group is targeting Kamoa-Kakula-style copper mineralization on its Western Foreland Exploration Project. The 17 licences in the Western Foreland cover a combined area of 2,407 square kilometres to the north, south and west of the Kamoa-Kakula Copper Complex. The exploration group is using models that successfully led to the discoveries of Kakula, Kakula West, and the Kamoa North Bonanza Zone on the Kamoa Copper SA mining licence. The group is composed of a mixture of the same exploration geologists responsible for the previous discoveries and others with experience in the greater Copperbelt.

The focus of exploration during Q2 2023 has been on diamond and air core drilling, with four contractor diamond core drill rigs, one Ivanhoe Landcruiser diamond core drill rig, and one Ivanhoe air core drill rig working by the end of the quarter. A total of 15,736 metres of diamond core have been drilled in the first half of 2023, with 10,853 metres for a total of 37 holes completed in Q2 2023. Air core drilling has completed 69 holes year-to-date for a total of 1,795 metres.

Two drill holes were started during the quarter between the Makoko and Kakula deposits on the Kakula-Monwezi trend to investigate the potential for mineralization at depth between the two identified deposits, and proximal to regional structures. One hole deviated from the planned orientation and has been put on hold. The second hole intersected a splay fault off the Nchana Fault which prevented the hole from reaching target depth. Further drilling in this area will be carried out as deflections off the two existing holes, with directional drilling tools to be mobilized to the DRC later in the year to ensure the lower contact of the Foreland shelf stratigraphy with basement lithologies is intersected.

A further four holes were completed down dip of Makoko West to determine the potential for extension of mineralization into deeper parts of the Western Foreland shelf. These holes drilled Nguba Group stratigraphy before intersecting the Kibaran basement. Follow-up drilling is planned along sections to enhance the 3D geological interpretation of the area.

Road and bridge access to more remote parts of the Sakanama prospect were upgraded or constructed during the quarter. A single hole was drilled on this prospect, intersecting Roan group sediments to a depth of 443 metres.

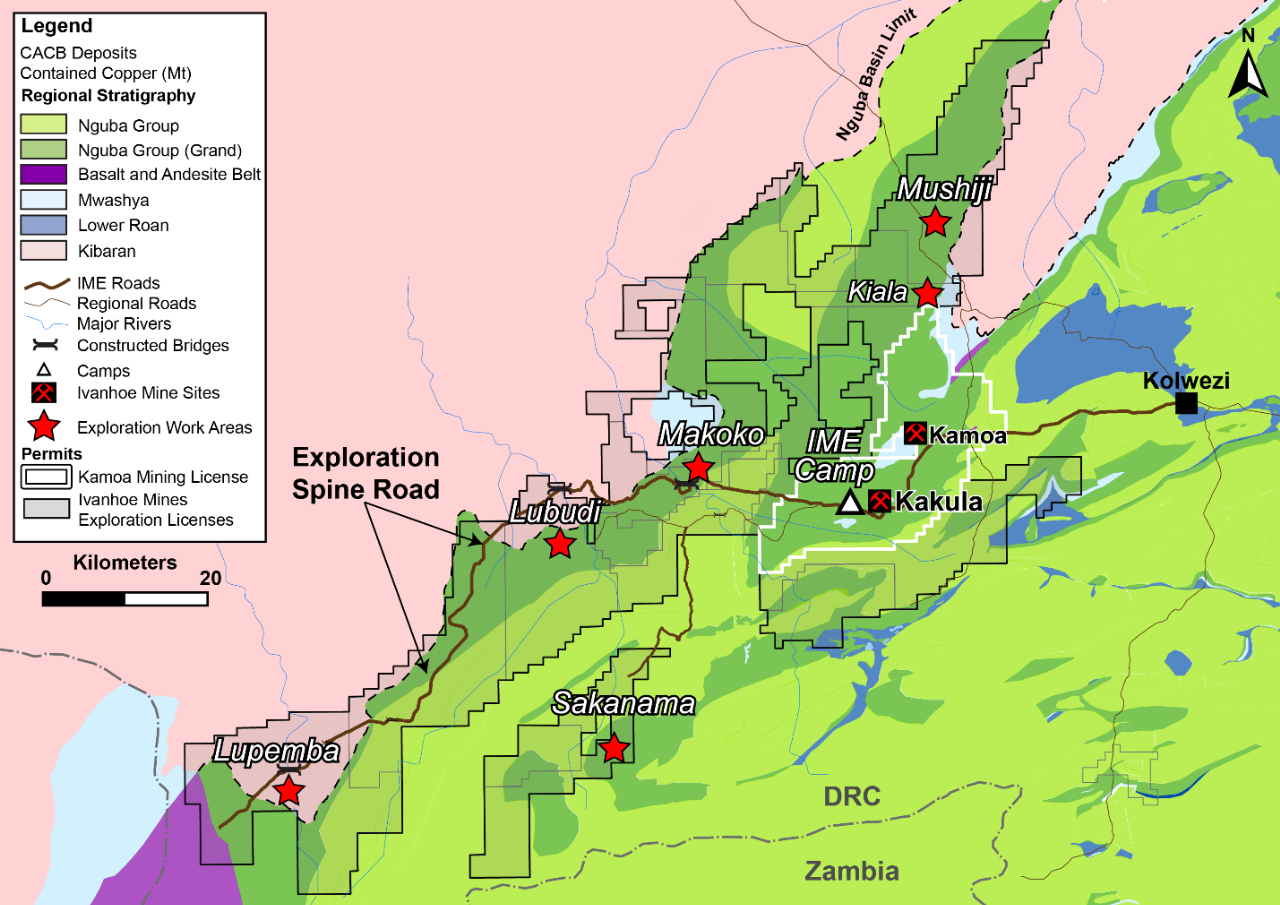

Figure 5. Map highlighting Ivanhoe Mines’ current exploration target areas across the Western Foreland licences.

Air core drilling was recommended on the Lupemba prospect during the quarter, extending the 800- by 800-metre grid of holes through exotic Kalahari sand cover.  Drilling was carried out using a single air core rig, with a second air core rig planned to start drilling early in Q3 following repairs. Rock-chip samples are collected from each hole below the Kalahari sands, which average between 5 and 30 metres thick. These samples will be analyzed for multi-element geochemistry to map lithology and identify copper anomalism under variable thickness Kalahari sand cover.

Collection of ground gravity began in the quarter along regional lines across the Western Foreland Shelf on a tight grid in the extended Makoko west area. The ground gravity will be used to identify thicker sequences of Nguba Group sediments, which are an indication of growth faults. Pre-Katangan growth faults are a key targeting tool for sediment-hosted copper mineralization as they generate sub-grabens with thicker siltstone host rock units and increased primary sedimentary pyrite. These faults are also thought to have played a key role in focusing mineralized fluid movement through the basal Roan sedimentary package.

An internal mineral resource model completed in early Q2 identified locations where additional infill diamond drilling is required in the Makoko resource. Fourteen holes were drilled in Q2 using the Ivanhoe Landcruiser rig for short holes (<150m) and two Titan drill rigs for deeper holes. The holes produced a total of 2,200 metres of core which will be added to the Makoko geological database.

The maiden inferred Mineral Resource Estimate for Makoko and Kiala is on course to be released in Q3 2023.

5. The Mokopane Feeder Exploration Project
100%-owned by Ivanhoe Mines
South Africa

Three new 100%-owned exploration rights were granted on the Northern Limb of the Bushveld complex in South Africa during Q4 2022. The three new exploration rights (Blinkwater 244KR, Moordrift 289KR and Lisbon 288KR) cover 80 square kilometres forming a continuous block situated on the southwest border of the existing Platreef Project’s mining rights.

This anomaly is interpreted to represent a primary feeder zone to the Rustenburg Layered Suite of the Northern Limb of the Bushveld Complex. Significant thickening of the Rustenburg Layered Suite, particularly of the more-dense Lower Zone units, is necessary to explain the large gravity anomaly. The proximity of the inferred feeder to the regional-scale crustal faults (the Ysterberg-Planknek and the Zebediela faults), as well as the anomalously thick zones of platinum-group metals mineralization at the Platreef Deposit, lead Ivanhoe to believe there is significant potential for Ni-Cu-PGE mineralization associated with this gravity feature.

Detailed high-resolution fixed-wing airborne magnetic and Falcon airborne gravity gradiometer geophysical surveys are being carried out to map and model the subsurface petrophysical characteristics of the anomaly. The magnetic survey was completed during Q2 2023, with the gravity survey to be flown during Q3 2023 due to equipment breakdown delays. Deep diamond drilling is now planned to commence in Q4 2023 to test targets identified from the results of the two surveys.

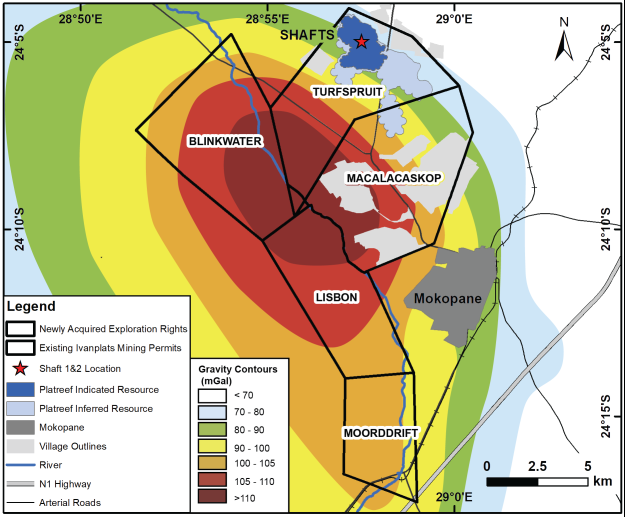

Figure 6. Image of the Platreef and Mokopane Feeder licences overlaid on the gravity geophysics anomaly.

SELECTED QUARTERLY FINANCIAL INFORMATION

The following table summarizes selected financial information for the prior eight quarters. Ivanhoe had no operating revenue in any financial reporting period. All revenue from commercial production at Kamoa-Kakula is recognized within the Kamoa Holding joint venture. Ivanhoe did not declare or pay any dividend or distribution in any financial reporting period.

Three months ended

June 30,

March 31,

December 31,

September 30,

2023

2023

2022

2022

$’000

$’000

$’000

$’000

Share of profit from joint venture

73,066

82,659

83,324

34,057

Finance income

61,956

57,826

58,477

46,720

Deferred tax recovery (expense)

1,965

926

(3,839)

4,252

Gain (loss) on fair valuation of financial asset

488

(1,595)

(1,170)

(2,873)

Loss on fair valuation of embedded derivative liability

(26,618)

(30,900)

(66,600)

(27,700)

General administrative expenditure

(10,474)

(8,571)

(11,870)

(9,199)

Share-based payments

(7,120)

(7,702)

(7,809)

(7,381)

Finance costs

(5,539)

(10,465)

(10,457)

(10,223)

Exploration and project evaluation expenditure

(4,375)

(3,381)

(3,887)

(4,312)

Profit (loss) attributable to:

Owners of the Company

92,042

86,637

41,884

26,344

Non-controlling interests

(4,859)

(4,157)

(4,705)

(2,477)

Total comprehensive income (loss) attributable to:

Owners of the Company

86,588

74,154

53,078

4,588

Non-controlling interest

(5,443)

(5,420)

(3,621)

(4,678)

Basic profit per share

0.08

0.07

0.03

0.02

Diluted profit per share

0.07

0.07

0.03

0.02

Three months ended

June 30,

March 31,

December 31,

September 30,

2022

2022

2021

2021

$’000

$’000

$’000

$’000

Gain (loss) on fair valuation of embedded derivative liability

183,600

(66,400)

(88,500)

54,900

Deferred tax recovery (expense)

114,184

(1,347)

74,069

(50)

Share of profit from joint venture

49,690

87,109

78,391

41,404

Finance income

38,596

31,505

27,978

26,437

Exploration and project evaluation expenditure

(13,470)

(12,243)

(15,800)

(15,677)

Finance costs

(10,013)

(7,391)

(10,539)

(10,451)

General administrative expenditure

(8,957)

(6,238)

(10,658)

(6,731)

Share-based payments

(4,637)

(7,389)

(7,490)

(5,117)

Profit (loss) attributable to:

Owners of the Company

316,242

26,394

45,833

89,806

Non-controlling interests

35,278

(4,854)

2,333

(4,456)

Total comprehensive income (loss) attributable to:

Owners of the Company

306,381

45,495

29,774

72,470

Non-controlling interest

34,495

(2,858)

632

(6,277)

Basic profit per share

0.26

0.02

0.04

0.07

Diluted profit per share

0.11(1)

0.02

0.04

0.03(1)

(1)  During the period, the Company identified that it had not considered the effect of the convertible notes in the diluted profit per share calculation since issuance of the notes in March 2021. As a result, the diluted profit per share disclosed during the three and six months ended June 30, 2022 was overstated. Refer to Ivanhoe Mines Ltd. condensed consolidated interim financial statements for the three and six months ended June 30, 2023 for additional information.

DISCUSSION OF RESULTS OF OPERATIONS

Review of the three months ended June 30, 2023 vs. June 30, 2022

The company recorded a profit for Q2 2023 of $87 million compared to a profit of $352 million for the same period in 2022. The profit for Q2 2022 included a gain on the fair valuation of the embedded derivative financial liability of $184 million, compared to a loss on the fair valuation of the embedded derivative financial liability of $27 million in Q2 2023, as well as the recognition of the deferred tax asset relating to the Kipushi Project of $114 million, both of which are described in greater detail below. The total comprehensive income for Q2 2023 was $81 million compared to $341 million for Q2 2022.

The Kamoa-Kakula Copper Complex sold 101,526 tonnes of payable copper in Q2 2023, realizing revenue of $702 million for the Kamoa Holding joint venture, compared to 85,794 tonnes of payable copper sold for revenue of $494 million for the same period in 2022. The company recognized income in aggregate of $123 million from the joint venture in Q2 2023, which can be summarized as follows:

Three months ended

June 30,

2023

2022

$’000

$’000

Company’s share of profit from joint venture

73,066

49,690

Interest on loan to joint venture

49,837

34,874

Company's income recognized from joint venture

122,903

84,564

The company’s share of profit from the Kamoa Holding joint venture was $23 million more in Q2 2023 compared to the same period in 2022 and is broken down in the following table:

Three months ended

June 30,

2023

2022

$’000

$’000

Revenue from contract receivables

729,924

699,381

Remeasurement of contract receivables

(27,542)

(205,248)

Revenue

702,382

494,133

Cost of sales

(277,646)

(217,112)

Gross profit

424,736

277,021

General and administrative costs

(27,794)

(23,964)

Amortization of mineral property

(3,005)

Profit from operations

393,937

253,057

Finance costs

(90,701)

(66,828)

Foreign exchange (loss) gain

(29,333)

863

Finance income and other

5,193

2,449

Profit before taxes

279,096

189,541

Current tax expense

(119,120)

(4,726)

Deferred tax recovery (expense)

30,278

(57,389)

Profit after taxes

190,254

127,426

Non-controlling interest of Kamoa Holding

(42,645)

(27,044)

Total comprehensive income for the period

147,609

100,382

Company’s share of profit from joint venture (49.5%)

73,066

49,690

The realized and provisional copper prices used for the remeasurement (mark-to-market) of contract receivables for the three months ended June 30, 2023, and for the same period in 2022, can be summarized as follows:

Three months ended

June 30,

2023

2022

$’000

$’000

Realized during the period – open at the start of the period

Opening forward price ($/lb.)(1)

4.05

4.69

Realized price ($/lb.)(1)

3.79

4.34

Payable copper tonnes sold

37,092

50,608

Remeasurement of contract receivables ($’000)

(21,356)

(39,227)

Realized during the period – new copper sold in the current period

Provisional price ($/lb.)(1)

4.00

Realized price ($/lb.)(1)

3.80

Payable copper tonnes sold

30,792

Remeasurement of contract receivables ($’000)

(13,006)

Open at the end of the period – open at the start of the period

Opening forward price ($/lb.)(1)

4.69

Closing forward price ($/lb.)(1)

3.80

Payable copper tonnes sold

39,797

Remeasurement of contract receivables ($’000)

(78,391)

Open at the end of the period – new copper sold in current period

Provisional price ($/lb.)(1)

3.77

4.26

Closing forward price ($/lb.)(1)

3.81

3.79

Payable copper tonnes sold

69,935

85,794

Remeasurement of contract receivables ($’000)

6,820

(87,630)

Total remeasurement of contract receivables ($’000)

(27,542)

(205,248)

(1) Calculated on a weighted average basis

Of the $91 million (Q2 2022: $67 million) finance costs recognized in the Kamoa Holding joint venture for Q2 2023, $72 million (Q2 2022: $58 million) relates to interest on shareholder loans where each shareholder funded Kamoa Holding in an amount equivalent to its proportionate shareholding interest before generating sufficient operational cashflow. Of the remaining finance costs, $14 million (Q2 2022: $7 million) relates to the provisional payment facility available under Kamoa-Kakula’s offtake agreements, while $3 million (Q2 2022: $2 million) relates to the equipment financing facilities and $2 million relates to bank over-drafts (Q2 2022: $nil).

Ivanhoe’s exploration and project evaluation expenditure amounted to $4 million in Q2 2023 and $13 million for the same period in 2022. Exploration and project evaluation expenditure for Q2 2023 related mainly to exploration at Ivanhoe’s Western Foreland exploration licences, while Q2 2022 also included amounts spent at the Kipushi Project, for which expenditure was capitalized in Q2 2023 due to the recommencement of the development of the project.

Finance income for Q2 2023 amounted to $62 million and was $23 million more than for the same period in 2022 ($39 million). Included in finance income is the interest earned on loans to the Kamoa Holding joint venture to fund past development, which amounted to $50 million for Q2 2023, and $35 million for the same period in 2022, and increased due to the higher LIBOR rates and accumulated loan balance. The company earns interest on the loan at USD 12-month LIBOR +7%. The average USD 12-month LIBOR rate for the three months ended June 30, 2023, was 5.53% compared to 2.81% for the same period in 2022. Interest will be calculated based on the term SOFR reference rate effective from July 1, 2023.

The company recognized a loss on the fair valuation of the embedded derivative financial liability of $27 million for Q2 2023, compared to a gain on the fair valuation of the embedded derivative financial liability of $184 million for Q2 2022, which is further explained in the accounting for the convertible notes section in Ivanhoe Mines' MD&A for the three and six months ended June 30, 2023.

In Q2 2022, the company recognized the deferred tax asset relating to the Kipushi Project resulting in a deferred tax recovery (income) of $114 million. With the agreement of the development plan by the shareholders of Kipushi and the approval of the development budget consistent with the Kipushi 2022 Feasibility Study, it was deemed probable that future taxable profit will be available from the Kipushi Project, against which the unused tax losses and unused tax credits can be utilized.

Review of the six months ended June 30, 2023, vs. June 30, 2022

The company recorded a profit of $170 million and a total comprehensive income of $150 million for the six months ended June 30, 2023, compared to a profit of $373 million and a total comprehensive income of $384 million for the same period in 2022. The profit for the six months ended June 30, 2022, included a gain on fair valuation of embedded derivative liability of $117 million, compared to a loss on fair valuation of embedded derivative financial liability of $58 million for the same period in 2023, as well as the recognition of the deferred tax asset relating to the Kipushi Project of $114 million described above.

The company recognized income in aggregate of $253 million from the joint venture in the six months ended June 30, 2023 (2022: $200 million), which can be summarized as follows:

Six months ended

June 30,

2023

2022

$’000

$’000

Company's share of profit from joint venture

155,725

136,799

Interest on loan to joint venture

97,429

63,163

Company's income recognized from joint venture

253,154

199,962

The company’s share of profit from the Kamoa Holding joint venture was $156 million for the six months ended June 30, 2023, compared to a profit of $137 million for the same period in 2022, the breakdown of which is summarized in the following table:

Six months ended

June 30,

2023

2022

$’000

$’000

Revenue from contract receivables

1,389,453

1,166,834

Remeasurement of contract receivables

2,052

(153,106)

Revenue

1,391,505

1,013,728

Cost of sales

(517,223)

(340,482)

Gross profit

874,282

673,246

General and administrative costs

(58,440)

(39,732)

Amortization of mineral property

(5,601)

Profit from operations

810,241

633,514

Finance costs

(179,374)

(121,471)

Foreign exchange (loss) gain

(34,218)

4,536

Finance income and other

10,188

4,280

Profit before taxes

606,837

520,859

Current tax expense

(195,593)

(9,941)

Deferred tax expense

(9,339)

(162,218)

Profit after taxes

401,905

348,700

Non-controlling interest of Kamoa Holding

(87,308)

(72,339)

Total comprehensive income for the period

314,597

276,361

Company's share of profit from joint venture (49.5%)

155,725

136,799

The realized and provisional copper prices used for the remeasurement (mark-to-market) of contract receivables for the six months ended June 30, 2023, and for the same period in 2022, can be summarized as follows.

Six months ended

June 30,

2023

2022

$’000

$’000

Realized during the period - open at the start of the period

Opening forward price ($/lb.)(1)

3.90

4.55

Realized price ($/lb.)(1)

3.95

4.43

Payable copper tonnes sold

88,271

103,673

Remeasurement of contract receivables ($'000)

11,269

(28,171)

Realized during the period - new copper sold in the current period

Provisional price ($/lb.)(1)

4.05

-

Realized price ($/lb.)(1)

3.94

-

Payable copper tonnes sold

86,913

-

Remeasurement of contract receivables ($'000)

(21,556)

-

Open at the end of the period - open at the start of the period

Opening forward price ($/lb.)(1)

3.79

4.55

Closing forward price ($/lb.)(1)

4.05

4.23

Payable copper tonnes sold

6,625

76,716

Remeasurement of contract receivables ($'000)

3,748

(55,278)

Open at the end of the period - new copper sold in current period

Provisional price ($/lb.)(1)

3.84

4.36

Closing forward price ($/lb.)(1)

3.88

4.13

Payable copper tonnes sold

100,241

137,713

Remeasurement of contract receivables ($'000)

8,591

(69,657)

Total remeasurement of contract receivables ($'000)

2,052

(153,106)

(1) Calculated on a weighted average basis

Of the $179 million (2022: $121 million) finance costs recognized in the Kamoa Holding joint venture for the six months ended June 30, 2023, $145 million (2022: $107 million) relates to interest on shareholder loans where each shareholder funded Kamoa Holding in an amount equivalent to its proportionate shareholding interest before generating sufficient operational cashflow. Of the remaining finance costs, $27 million (2022: $12 million) relates to the provisional payment facility available under Kamoa-Kakula’s offtake agreements, while $5 million (2022: $3 million) relates to the equipment financing facilities and $2 million relates to bank overdrafts (2022: $nil).

Exploration and project evaluation expenditure amounted to $8 million for the six months ended June 30, 2023, and was $18 million less than for the same period in 2022 ($26 million). Exploration and project evaluation expenditure for 2023 related mainly to exploration at Ivanhoe’s Western Foreland exploration licences while 2022 also included amounts spent at the Kipushi Project. Expenditure incurred at the Kipushi Project was capitalized in 2023 due to the recommencement of the development of the Project.

Finance income amounted to $120 million for the six months ended June 30, 2023, and $70 million for the same period in 2022. Included in finance income is the interest earned on loans to the Kamoa Holding joint venture to fund operations that amounted to $97 million for the six months ended June 30, 2023, and $63 million for the same period in 2022. No additional loans were advanced in 2023 with joint venture cashflow funding its operations and expansions. Interest increased due to higher LIBOR rates and due to the higher accumulated loan balance. The average USD 12-month LIBOR rate for the six months ended June 30, 2023, was 5.46% compared with 2.02% for the same period in 2022.

As explained in the accounting for the convertible notes section in Ivanhoe Mines’ MD&A for the three and six months ended June 30, 2023, the company recognized a loss on fair valuation of the embedded derivative financial liability of $58 million for the six months ended June 30, 2023 (2022: gain of $117 million).

The total comprehensive income for the six months ended June 30, 2023, included an exchange loss on translation of foreign operations of $20 million, compared to an exchange gain on translation of foreign operations recognized for the same period in 2022 of $10 million, resulting mainly from the weakening of the South African Rand by 10% from December 31, 2022, to June 30, 2023.

Financial position as at June 30, 2023 vs. December 31, 2022

The company’s total assets increased by $268 million, from $3,969 million as at December 31, 2022, to $4,237 million as at June 30, 2023. The increase in total assets was mainly attributable to the increase in the company’s investment in the Kamoa Holding joint venture by $253 million, the increase in property, plant and equipment of $180 million as project development continued at the Platreef and Kipushi projects, as well as the increase in deferred tax assets by $13 million.

The company’s investment in the Kamoa Holding joint venture increased by $253 million from $2,047 million as at December 31, 2022, to $2,300 million as at June 30, 2023. The company’s investment in the Kamoa Holding joint venture can be broken down as follows:

June 30,

December 31,

2023

2022

$’000

$’000

Company's share of net assets in joint venture

666,165

510,439

Loan advanced to joint venture

1,634,030

1,536,601

Total investment in joint venture

2,300,195

2,047,040

The company’s share of net assets in the Kamoa Holding joint venture can be broken down as follows:

June 30, 2023

December 31, 2022

100%

49.5%

100%

49.5%

$’000

$’000

$’000

$’000

Assets

Property, plant and equipment

3,340,132

1,653,365

2,733,176

1,352,922

Mineral property

784,286

388,222

789,888

390,995

Indirect taxes receivable

335,736

166,189

279,385

138,296

Cash and cash equivalents

333,204

164,936

365,633

180,988

Consumable stores

314,843

155,847

257,434

127,430

Other receivables

297,050

147,040

212,221

105,049

Long-term loan receivable

263,096

130,233

252,523

124,999

Non-current inventory

231,960

114,820

246,424

121,980

Trade receivables

106,031

52,485

63,196

31,282

Current inventory

78,141

38,680

27,011

13,370

Right-of-use asset

46,554

23,044

11,549

5,717

Prepaid expenses

14,253

7,055

9,216

4,562

Non-current deposits

1,872

927

2,272

1,125

Deferred tax asset

626

310

710

351

Liabilities

Shareholder loans

(3,300,152)

(1,633,575)

(3,103,381)

(1,536,174)

Trade and other payables

(345,098)

(170,824)

(309,710)

(153,306)

Deferred tax liability

(283,180)

(140,174)

(273,841)

(135,551)

Income taxes payable

(137,368)

(67,997)

(14,600)

(7,227)

Equipment finance facility

(113,490)

(56,178)

(102,890)

(50,931)

Rehabilitation provision

(84,413)

(41,784)

(45,231)

(22,389)

Other provisions

(58,833)

(29,122)

(26,675)

(13,204)

Provisional payment facility

(53,520)

(26,492)

(38,866)

(19,239)

Lease liability

(47,624)

(23,574)

(13,243)

(6,555)

Non-controlling interest

(378,319)

(187,268)

(291,012)

(144,051)

Net assets of the joint venture

1,345,787

666,165

1,031,189

510,439

Before commencing commercial production in July 2021, the Kamoa Holding joint venture principally used loans advanced to it by its shareholders to advance the Kamoa-Kakula Copper Complex through investing in development costs and other property, plant and equipment. No additional shareholder loans were advanced in 2022 or 2023 with joint venture cashflow funding its operations and expansions. The joint venture had a healthy cash position as at June 30, 2023, with cash and cash equivalents of $333 million on hand.

The Kamoa-Kakula’s Phase 1 and 2 operations are anticipated to generate significant operating cash flow to fund Phase 3 capital cost requirements at current copper prices and the joint venture is arranging short-term financing facilities should a shortfall occur due to a significant decrease in copper prices. Kamoa-Kakula has $150 million in overdraft facilities in place from local DRC banks.

The cash flows of the Kamoa Holding joint venture can be summarized as follows:

Three months ended

Six months ended

June 30,

June 30,

2023

2022

2023

2022

$’000

$’000

$’000

$’000

Net cash generated from operating activities

405,417

249,877

851,957

634,362

Change in working capital items

(83,794)

116,320

(256,913)

(43,646)

Net cash used in investing activities

(370,232)

(143,751)

(623,388)

(250,767)

Net cash (used in) generated from financing activities

(6,142)

(895)

(3,744)

1,133

Effect of foreign exchange rates on cash

(1,669)

(5,097)

(341)

(6,664)

Net cash (outflow) inflow

(56,420)

216,454

(32,429)

334,418

Cash and cash equivalents - beginning of the period

389,624

139,995

365,633

22,031

Cash and cash equivalents - end of the period

333,204

356,449

333,204

356,449

The Kamoa Holding joint venture’s net increase in property, plant and equipment from December 31, 2022, to June 30, 2023, amounted to $607 million and can be further broken down as follows:

Six months ended

June 30,

2023

2022

$’000

$’000

Kamoa Holding joint venture

Expansion capital

518,049

267,756

Sustaining capital

105,707

25,709

Initial capital

9,009

623,756

302,474

Depreciation capitalized

18,197

5,340

Total capital expenditure

641,953

307,814

Borrowing costs capitalized

51,544

21,554

Total additions to property, plant and equipment for Kamoa Holding

693,497

329,368

Less depreciation, disposals and foreign exchange translation

(86,541)

(54,296)

Net increase in property, plant and equipment of Kamoa Holding

606,956

275,072

Ivanhoe’s cash and cash equivalents decreased by $204 million, from $597 million as at December 31, 2022, to $393 million as at June 30, 2023. The company spent $198 million on project development and acquiring other property, plant and equipment and $28 million on its operating activities.

The net increase in property, plant and equipment amounted to $180 million, with additions of $206 million to project development and other property, plant and equipment. Of this total, $106 million pertained to development costs and other acquisitions of property, plant and equipment at the Platreef Project, while $70 million pertained to development costs and other acquisitions of property, plant and equipment at the Kipushi Project as set out on page 48. Ivanhoe also purchased a corporate aircraft in Q2 2023 for $29 million.

The main components of the additions to property, plant and equipment – including capitalized development costs – at the Platreef and Kipushi projects for the six months ended June 30, 2023, and for the same period in 2022, are set out in the following tables:

Six months ended

June 30,

2023

2022

$’000

$’000

Platreef Project

Phase 1 construction

55,912

17,959

Phase 2 construction

25,785

4,722

Salaries and benefits

6,478

6,706

Administrative and other expenditure

3,288

3,053

Depreciation

3,152

739

Studies and contracting work

2,181

2,079

Site costs

1,984

1,034

Social and environmental

883

556

Total development costs

99,663

36,848

Other additions to property, plant and equipment

6,233

2,093

Total additions to property, plant and equipment for Platreef

105,896

38,941

Six months ended

June 30,

2023

2022

$’000

$’000

Kipushi Project

Mine construction costs

39,159

Administration and overheads

6,619

3,519

Salaries and benefits

7,832

5,725

Other expenditure

5,186

2,107

Depreciation - development

4,170

Studies and contracting work

3,569

1,698

Electricity

3,533

1,544

Other additions to property, plant and equipment

427

1,459

Depreciation - exploration and project evaluation

3,759

Total project expenditure

70,495

19,811

Accounted for as follows:

Additions to property, plant and equipment

38,265

1,459

Development costs capitalized to property, plant and equipment

32,230

Exploration and project evaluation expenditure in the loss from operating activities

18,352

Total project expenditure

70,495

19,811

Costs incurred during 2023 at the Platreef and Kipushi projects are deemed necessary to bring the project to commercial production and are therefore capitalized as property, plant and equipment.

On June 30, 2023, the company entered into an exchange agreement with I-Pulse Inc. (I-Pulse), under which the company replaced the outstanding convertible loan balance owed to it by HPX Inc. with an equity investment in I-Pulse. The company extended a $50 million convertible loan to HPX on April 25, 2019. As at June 30, 2023, the loan balance was $77 million, comprising a principal amount of $50 million and accrued interest of $27 million. Under the exchange agreement, the company transferred all convertible loan obligations from HPX to I-Pulse, in exchange for the issuance of common stock in I-Pulse to Ivanhoe. HPX is a subsidiary of I-Pulse. The equity investment in I-Pulse represents approximately 5% of the issued and outstanding common stock of I-Pulse.

The company’s total liabilities increased by $102 million to $1,230 million as at June 30, 2023, from $1,128 million as at December 31, 2022, with the increase mainly due to the loss on the fair valuation of the embedded derivative liability of $58 million and the loan facility of $40 million entered into by the Kipushi Project explained below.

On May 22, 2023, Kipushi Corporation SA (Kipushi), a subsidiary of the company and the operator of the Kipushi Project, entered into a loan agreement with Rawbank SA (Rawbank), a financial institution in the DRC. Under the terms of the loan agreement, Rawbank provided an $80 million loan, to be drawn down in two tranches of $40 million each, to Kipushi to fund its working capital requirements. The first tranche of the loan was drawn down by Kipushi on June 27, 2023. The loan incurs interest at 8% per year plus a commission of 0.5% per quarter. The loan and accumulated interest and commission are repayable on May 31, 2024. Ivanhoe has guaranteed all amounts due by Kipushi to Rawbank under this loan agreement.

LIQUIDITY AND CAPITAL RESOURCES

The company had $393 million in cash and cash equivalents as at June 30, 2023. At this date, the company had consolidated working capital of approximately $349 million, compared to $595 million at December 31, 2022.

The company’s capital expenditure for 2023 and 2024 can be summarized as follows:

Capital Expenditure

H1 2023 Actuals

2023 Guidance

2024 Guidance

($’ million)

($’ million)

($’ million)

Kamoa-Kakula

Phase 3 expansion

407

1,400 – 1,800

1,100 – 700

Phase 2 and other expansion capital

111

120

Sustaining capital

106

180

80

624

1,700 – 2,100

1,180 – 780

Platreef

Phase 1 initial capital

77

190 – 240

200 – 150

Phase 2 capital

26

60

60

103

250 – 300

260 – 210

Kipushi

Initial capital

66

200 – 250

180 – 130

All capital expenditure figures are presented on a 100%-project basis.

The ranges provided reflect uncertainty in the timing of Kamoa-Kakula Phase 3 expansion, Platreef Phase 2 capital and Kipushi cash flows between calendar years 2023 and 2024. The 2024 capital expenditure guidance for Platreef and Kipushi excludes sustaining capital required in 2024 post-initial production.

As documented in the Kamoa-Kakula 2023 Integrated Development Plan announced on January 30, 2023, the remaining capital cost for the total Phase 3 expansion was estimated at $3.0 billion, including the mine, concentrator, smelter, infrastructure and investment in off-site hydropower infrastructure. The Phase 1 and 2 operations are anticipated to generate significant operating cash flow in 2023 and 2024 and are expected to fund capital cost requirements at current copper prices. The joint venture had cash and cash equivalents of $333 million on hand at the end of June 2023.

Construction for Platreef's Phase 1 Mine is well underway, with the first production on track for Q3 2024. The planned Phase 2 capital expenditure at Platreef mainly represents the continuation of sinking Shaft 2 and the construction of the Shaft 2 headframe, as well as Shaft 3 construction and equipping, allowing optionality for possible acceleration in Phase 2, which is currently under review.

Construction of the Kipushi Mine is also underway, with the processing plant scheduled for completion by Q3 2024. Of the $380 million capital budget to completion, approximately $163 million has been committed to date. On April 27, 2023, Ivanhoe and joint-venture partner Gécamines announced an offtake term sheet for 100% of Kipushi’s zinc concentrate, together with a $250 million facility supported by Glencore International AG. The offtake and financing term sheet is subject to the execution of final, binding agreements, which are expected to be concluded in conjunction with the new Kipushi Corporation joint-venture agreement in the coming months.

On May 22, 2023, Kipushi entered into a loan agreement with Rawbank SA, a financial institution in the DRC. Under the terms of the loan agreement, Rawbank provided an $80 million loan, to be drawn down in two tranches of $40 million each, to Kipushi to fund its working capital requirements. The first tranche of the loan was drawn down by Kipushi on June 27, 2023. The loan incurs interest at 8% per year plus a commission of 0.5% per quarter. The loan and accumulated interest and commission are repayable on May 31, 2024. Ivanhoe has guaranteed all amounts due by Kipushi to Rawbank under this loan agreement.

Exploration activities at the Western Foreland Exploration Project in the DRC and other targets will continue in 2023 with an initial budget of $31 million.

On March 17, 2021, the company closed a private placement offering of $575 million of 2.50% convertible senior notes maturing in 2026. The convertible senior notes are senior unsecured obligations of the company which will accrue interest payable semi-annually in arrears at a rate of 2.50% per annum and will mature on April 15, 2026, unless earlier repurchased, redeemed or converted. The notes will be convertible at the option of holders, before the close of business on the business day immediately preceding October 15, 2025, only under certain circumstances and during certain periods, and thereafter, at any time until the close of business on the second scheduled trading day immediately preceding the maturity date. Upon conversion, the notes may be settled, at the company’s election, in cash, common shares or a combination thereof. The carrying value of the host liability was $480 million and the fair value of the embedded derivative liability was $279 million as at June 30, 2023.

The company has a mortgage bond outstanding on its offices in London, United Kingdom, of £3.2 million ($4.1 million). The bond is fully repayable on August 28, 2025, secured by the property, and incurs interest at a rate of 1 month Sterling Overnight Index Average (SONIA) plus 1.90% payable monthly in arrears. Only interest will be payable until maturity.

In 2013, the company became a party to a loan payable to ITC Platinum Development Limited, which had a carrying value and contractual value of $37 million as at June 30, 2023. The loan is repayable once the Platreef Project has residual cash flow, which is defined in the loan agreement as gross revenue generated by the Platreef Project, less all operating costs attributable thereto, including all mining development and operating costs. The loan incurs interest of USD 3-month LIBOR plus 2% calculated monthly in arrears. Interest is not compounded. Interest will be calculated based on the Term SOFR applicable to United States Dollars on a 3-month deposit plus 2.26% effective from June 30, 2023.

The company has an implied commitment in terms of spending on work programs submitted to regulatory bodies to maintain the good standing of exploration and exploitation permits at its mineral properties. The following table sets forth the company’s long-term obligations:

Contractual obligations as at June 30, 2023

Payments Due By Period

Total

<1 year

1-3 years

4-5 years

>5 years

$’000

$’000

$’000

$’000

$’000

Convertible notes

577,993

2,993

575,000

Debt

81,429

40,027

4,072

37,330

Lease commitments

1,689

348

770

571

Total contractual obligations

661,111

43,368

579,842

571

37,330

Debt in the above table represents the mortgage bond owing to Citibank, the loan payable to ITC Platinum Development Limited and the loan from Rawbank, as described above.

The company is required to fund its Kamoa Holding joint venture in an amount equivalent to its proportionate shareholding interest.

NON-GAAP FINANCIAL PERFORMANCE MEASURES

Kamoa-Kakula’s C1 cash costs and C1 cash costs per pound

C1 cash costs and C1 cash costs per pound are non-GAAP financial measures. These are disclosed to enable investors to better understand the performance of Kamoa-Kakula in comparison to other copper producers who present results on a similar basis.

C1 cash costs are prepared on a basis consistent with the industry standard definitions by Wood Mackenzie cost guidelines but are not measures recognized under IFRS. In calculating the C1 cash cost, the costs are measured on the same basis as the company's share of profit from the Kamoa Holding joint venture that is contained in the financial statements. C1 cash costs are used by management to evaluate operating performance and include all direct mining, processing, and general and administrative costs. Smelter charges and freight deductions on sales to the final port of destination, which are recognized as a component of sales revenues, are added to C1 cash cost to arrive at an approximate cost of finished metal. C1 cash costs and C1 cash costs per pound exclude royalties and production taxes and non-routine charges as they are not direct production costs.

Reconciliation of Kamoa-Kakula’s cost of sales to C1 cash costs, including on a per pound basis:

Three months ended

Six months ended

June 30,

June 30,

2023

2022

2023

2022

$'000

$'000

$'000

$'000

Cost of sales

277,646

217,112

517,223

340,482

Logistics, treatment and refining charges

123,887

113,671

235,330

162,512

General and administrative expenditure

27,794

23,964

58,440

39,732

Royalties and production taxes

(59,994)

(55,651)

(113,806)

(84,227)

Depreciation

(47,722)

(32,457)

(86,210)

(47,693)

Power rebate

(4,779)

(9,272)

Movement in finished goods inventory

(774)

545

(1,462)

548

General and administrative expenditure of other group entities

(4,321)

(2,074)

(4,645)

(2,302)

C1 cash costs

311,737

265,110

595,598

409,052

Cost of sales per pound of payable copper sold ($ per lb.)

1.24

1.15

1.25

1.12

C1 cash costs per pound of payable copper produced ($ per lb.)

1.41

1.42

1.41

1.34

Payable copper produced in concentrate (tonnes)

100,413

84,476

190,974

138,271

Figures in the above table are for the Kamoa-Kakula joint venture on a 100% basis.

EBITDA, Adjusted EBITDA, EBITDA margin and normalized profit

EBITDA, Adjusted EBITDA, EBITDA margin and normalized profit are non-GAAP financial measures. Ivanhoe believes that Kamoa-Kakula’s EBITDA is a valuable indicator of the mine’s ability to generate liquidity by producing operating cash flow to fund its working capital needs, service debt obligations, fund capital expenditures and distribute cash to its shareholders. EBITDA and Adjusted EBITDA are also frequently used by investors and analysts for valuation purposes. Kamoa-Kakula’s EBITDA and the EBITDA and Adjusted EBITDA for the company are intended to provide additional information to investors and analysts and do not have any standardized definition under IFRS and should not be considered in isolation or as a substitute for measures of performance prepared per IFRS. EBITDA and Adjusted EBITDA excludes the impact of cash costs of financing activities and taxes, and the effects of changes in operating working capital balances, and therefore are not necessarily indicative of operating profit or cash flow from operations as determined under IFRS. Other companies may calculate EBITDA and Adjusted EBITDA differently.

The EBITDA margin is an indicator of Kamoa-Kakula's overall health and denotes its profitability, which is calculated by dividing EBITDA by revenue. The EBITDA margin is intended to provide additional information to investors and analysts, does not have any standardized definition under IFRS, and should not be considered in isolation, or as a substitute, for measures of performance prepared per IFRS.

Reconciliation of profit after tax to Kamoa-Kakula’s EBITDA:

Three months ended

Six months ended

June 30,

June 30,

2023

2022

2023

2022

$'000

$'000

$'000

$'000

Profit after taxes

190,254

127,426

401,905

348,700

Finance costs

90,701

66,828

179,374

121,471

Current and deferred tax expense

88,842

62,115

204,932

172,159

Depreciation

50,727

32,457

91,811

47,693

Unrealized foreign exchange loss (gain)(1)

41,355

(836)

46,244

(6,011)

Finance income

(5,251)

(2,513)

(10,327)

(4,319)

EBITDA

456,628

285,477

913,939

679,693

Figures in the above table are for the Kamoa-Kakula joint venture on a 100% basis.

  1. Unrealized foreign exchange losses (gains) have been excluded from EBITDA in the current and prior periods presented, as the company believes that including the unrealized foreign exchange gains and losses does not give a useful indication of Kamoa-Kakula's overall health and profitability.

Reconciliation of profit after tax to Ivanhoe’s EBITDA and adjusted EBITDA:

Three months ended

Six months ended

June 30,

June 30,

2023

2022

2023

2022

$'000

$'000

Profit after taxes

87,183

351,520

169,663

373,060

Finance income

(61,956)

(38,596)

(119,782)

(70,101)

Current and deferred tax recovery

(1,769)

(114,183)

(2,650)

(112,976)

Finance costs

5,539

10,013

16,004

17,404

Unrealized foreign exchange loss(1)

1,934

2,384

3,225

752

Depreciation

609

2,276

1,085

4,538

EBITDA

31,540

213,414

67,545

212,677

Share of profit from joint venture net of tax

(73,066)

(49,690)

(155,725)

(136,799)

Company's share of EBITDA from Kamoa-Kakula joint venture(2)

180,489

114,309

361,285

268,934

Loss (gain) on fair valuation of embedded derivative liability

26,618

(183,600)

57,518

(117,200)

Non-cash share-based payments

6,589

6,457

13,127

12,710

Adjusted EBITDA

172,170

100,890

343,750

240,322

  1. Unrealized foreign exchange losses have been excluded from EBITDA in the current and prior periods presented, as the Company believes that including the unrealized foreign exchange gains and losses does not give a valuable indication of the company’s ability to generate liquidity and operating cash flow and distribute cash to its shareholders
  2. The company's attributable share of EBITDA from the Kamoa-Kakula joint venture is calculated using the company’s effective shareholding in Kamoa Copper SA (39.6%), Ivanhoe Mines Energy DRC SARL (49.5%), Kamoa Holding Limited (49.5%) and Kamoa Services (Pty) Ltd (49.5%).

This news release should be read in conjunction with Ivanhoe Mines’ audited 2022 Financial Statements and Management’s Discussion and Analysis report available at www.ivanhoemines.com and at www.sedarplus.ca.

Disclosure of technical information

Disclosures of a scientific or technical nature in this news release regarding the Kamoa-Kakula Copper Complex (other than stockpiles estimation), the Platreef Project and the Kipushi Project have been reviewed and approved by Steve Amos, who is considered, by virtue of his education, experience and professional association, a Qualified Person under the terms of National Instrument 43-101 (NI 43-101). Mr. Amos is not considered independent under NI 43-101 as he is the Executive Vice President, Projects, at Ivanhoe Mines. Mr. Amos has verified the technical data related to the foregoing disclosed in this news release.

Disclosures of a scientific or technical nature regarding the Kamoa-Kakula stockpiles in this news release have been reviewed and approved by George Gilchrist, who is considered, by virtue of his education, experience and professional association, a Qualified Person under the terms of NI 43-101. Mr. Gilchrist is not considered independent under NI 43- 101 as he is the Vice President, Resources, at Ivanhoe Mines. Mr. Gilchrist has verified the technical data regarding the Kamoa-Kakula stockpiles disclosed in this news release.

Disclosures of a scientific or technical nature regarding the Western Foreland Exploration Project in this news release have been reviewed and approved by Stephen Torr, who is considered, by virtue of his education, experience and professional association, a Qualified Person under the terms of NI 43-101. Mr. Torr is not considered independent under NI 43-101 as he is the Vice President, Geosciences, at Ivanhoe Mines. Mr. Torr has verified the technical data regarding the Western Foreland Exploration Project disclosed in this news release.

Ivanhoe has prepared an independent, NI 43-101-compliant technical report for the Kamoa-Kakula Project, the Platreef Project and the Kipushi Project, each of which is available on the company’s website and under the company’s SEDAR+ profile at www.sedarplus.ca:

  • Kamoa-Kakula Integrated Development Plan 2023 Technical Report dated March 6, 2023, prepared by OreWin Pty Ltd.; China Nerin Engineering Co. Ltd.; DRA Global; Epoch Resources; Golder Associates Africa; Metso Outotec Oyj; Paterson and Cooke; SRK Consulting Ltd.; and The MSA Group.
  • The Kipushi 2022 Feasibility Study dated February 14, 2022, prepared by OreWin Pty Ltd., MSA Group (Pty) Ltd., SRK Consulting (South Africa) (Pty) Ltd, and METC Engineering.
  • The Platreef 2022 Feasibility Study dated February 28, 2022, prepared by OreWin Pty Ltd., Mine Technical Services, SRK Consulting Inc., DRA Projects (Pty) Ltd and Golder Associates Africa.

These technical reports include relevant information regarding the effective dates and the assumptions, parameters and methods of the mineral resource estimates on the Platreef Project, the Kipushi Project and the Kamoa-Kakula Copper Complex cited in this news release, as well as information regarding data verification, exploration procedures and other matters relevant to the scientific and technical disclosure contained in this news release in respect of the Platreef Project, Kipushi Project and Kamoa-Kakula Copper Complex.

Information contact

Follow Robert Friedland (@robert_ivanhoe) and Ivanhoe Mines (@IvanhoeMines_) on Twitter.

Investors
Vancouver:  Matthew Keevil +1.604.558.1034
London:        Tommy Horton +44 7866 913 207

Media
Tanya Todd +1.604.331.9834

Website www.ivanhoemines.com

Forward-looking statements

Certain statements in this news release constitute “forward-looking statements” or “forward-looking information” within the meaning of applicable securities laws. Such statements and information involve known and unknown risks, uncertainties and other factors that may cause the actual results, performance or achievements of the company, its projects, or industry results, to be materially different from any future results, performance or achievements expressed or implied by such forward-looking statements or information. Such statements can be identified using words such as “may”, “would”, “could”, “will”, “intend”, “expect”, “believe”, “plan”, “anticipate”, “estimate”, “scheduled”, “forecast”, “predict” and other similar terminology, or state that certain actions, events, or results “may”, “could”, “would”, “might” or “will” be taken, occur or be achieved. These statements reflect the company’s current expectations regarding future events, performance and results and speak only as of the date of this news release.

Such statements include without limitation, the timing and results of: (i) statements that Kamoa-Kakula expects Phase 1 and Phase 2 cash flow to be sufficient to fund the Phase 3 expansion capital cost requirements at current copper prices; (ii) statements regarding highly promising preliminary testwork to further improve copper recoveries at Kamoa-Kakula, with results indicating that recoveries well over 90% can be achieved by liberating copper from the tailings stream and that based on these results, Kamoa-Kakula can further increase production, revenues and cash flow; (iii) statements that Kamoa Copper has been working alongside DRC’s state-owned power company, SNEL, to identify the causes of instability across the southern DRC’s grid infrastructure to assist with delivering long-lasting solutions and that Kamoa Copper has identified a series of upgrades and has outlined a project plan to deliver the improvements; (iv) statements that Kamoa Copper’s engineering team are working towards insulating Kamoa-Kakula from future instability by expanding on-site backup generation capacity, as well as sourcing additional power imported from the Zambian grid; (v) statements that over the next 12-18 months, on-site backup-power generation capacity at Kamoa-Kakula will increase via a phased roll-out; (vi) statements that the delivery of a further 30 MW in backup generation capacity, sufficient to power Kamoa-Kakula’s entire Phase 1 and 2 operations in the event of grid disruptions, will commence later this year and is expected to be operational by Q2 2024; (vii) statements that over 130 MW of further backup generation capacity has been ordered and is expected to be installed in 2024, in time for the completion of the Phase 3 concentrator and smelter that are currently under construction; (viii) statements that discussions are advancing to secure up to 100 MW of additional power via the Zambian grid interconnector, with the initial phase expected to be ready in the third quarter; (ix) statements that following the commissioning of Phase 3, Kamoa-Kakula will have a total design processing capacity of 14.2 Mtpa; (x) statements that the completion of Phase 3 is expected to increase annualized copper production to an average of approximately 620,000 tonnes per year over the next ten years, which will position Kamoa Copper as the world’s third-largest copper mining complex in 2027, and the largest copper mine on the African continent; (xi) statements that underground mining activities are expected to commence at Kamoa 1 in late 2023 and Kamoa 2 in 2025, which will both involve the same mechanized drift-and-fill mining methods used at the Kakula Mine; (xii) statements that the smelter at Kamoa-Kakula will incorporate leading-edge technology supplied by Metso Outotec of Espoo, Finland and will meet the world-leading IFC emissions standards; (xiii) statements that the number of workers at the smelter site is expected to peak at 3,000 in December 2023; (xiv) statements that the 99.7% pure blister anode copper produced from Kamoa-Kakula’s smelter is expected to be among the lowest carbon-dioxide emitters in the world per tonne of copper produced; (xv) statements that the smelter will have a processing capacity of approximately 1.2 Mtpa of dry concentrate feed and is designed to run on a blend of concentrate produced from the Kakula (Phase 1 and 2) and Kamoa (Phase 3 and future Phase 4) concentrators; (xvi) statements that under the Kamoa-Kakula 2023 Integrated Development Plan, the smelter is projected to accommodate approximately 80% of Kamoa-Kakula’s total concentrate production; (xvii) statements regarding Kamoa-Kakula continuing to toll-treat concentrates under a 10-year agreement with the LCS, located approximately 50 kilometres from Kamoa-Kakula, near the town of Kolwezi and that deliveries to LCS are expected to account for approximately 150,000 tonnes of copper concentrate annually; (xviii) statements that Kamoa-Kakula’s Phase 3 mine and concentrator expansion and 500,000-tonne-per annum on-site, direct-to-blister copper smelter, which is expected to be Africa’s largest direct-to-blister flash smelter, are advancing on schedule and are expected to be completed in late 2024, and that meanwhile ore will be drawn from the stockpiles to maximize copper production; (xix) statements that as a by-product, the smelter at Kamoa-Kakula will also produce in the region of 650,000 to 800,000 tonnes per year of high-strength sulphuric acid; (xx) statements that the on-site smelter will offer transformative financial benefits for the Kamoa-Kakula Copper Complex, most notable being a material reduction in logistics costs, and to a lesser extent reduced concentrate treatment charges and local taxes, as well as revenue from acid sales; (xxi) statements that the volume of shipments is expected to halve following the Phase 3 expansion as trucks will transport 99+%-pure blister copper anodes instead of concentrate with approximately 50% contained copper and that according to the Kamoa-Kakula 2023 Prefeasibility Study, smelter commissioning is expected to drive a decrease in average cash costs (C1) over the first five years (from 2025) to approximately $1.15/lb. of copper; (xxii) statements that the rehabilitation of Turbine #5 at the Inga II hydroelectric power station, will supply an additional 178 MW of clean hydroelectric power to the national grid and provide power for Phase 3 concentrator, the flash smelter, as well as provide spare capacity for future expansion; (xxiii) statements regarding Kamoa-Kakula’s 2023 guidance including contained copper in concentrate of 390,000 to 430,000 tonnes and cash cost (C1) of $1.40 to $1.50 per lb; (xxiv) statements regarding the company focusing on construction activities to bring Phase 1 of Platreef into production by Q3 2024; (xxv) statements that once the crusher and loading feeder installation on the 950-metre level is completed at the end of August, the rate of lateral underground development is expected to continue to increase to approximately 300 metres per month through the remainder of the year and that from January 2024, the advancement rate is expected to increase to approximately 500 metres per month; (xxvi) statements that the 10-metre diameter Shaft 2 currently under construction will have a hoisting capacity of 8 Mtpa and that Shaft 2 will be utilized in subsequent development phases and will be among the largest hoisting shafts in the world; (xxvii) statements that the kibble and stage winder civil construction is nearing completion with the winder deliveries planned for December 2023; (xxviii) statements that commissioning of Platreef’s first 5-MW solar-power plant is expected later this year and that power generated by this plant will support development activities and operations, together with other renewable energy sources to be introduced over time; (xxix) statements that Shaft 3, originally planned as a ventilation and secondary escape shaft, is currently under construction and is now planned to be equipped for hoisting, which will provide additional hoisting capacity to remove ore and waste from the underground mine and that this has the benefit of de-risking the development and ramp-up of the Phase 1 mine and may be used to accelerate the ramp-up of underground mining activities for Phase 2, in advance of the completion of Shaft 2, which is expected in 2027; (xxx) statements that Shaft 3 is currently being reamed to a diameter of 5.1 metres with planned completion in Q4 2023; (xxxi) statements that Platreef’s water requirement for the Phase 1 operation is projected to peak at approximately three million litres per day, which will then increase to nine million litres per day once the Phase 2 expansion is complete; (xxxii) statements that Masodi Wastewater Treatment Works is progressing well towards completion in Q3 2023; (xxxiii) statements that the concentrate produced by Kipushi is expected to contain approximately 55% zinc and low levels of impurities; (xxxiv) statements that the buyer will purchase the concentrate at the Kipushi Mine on a free-carrier basis, meaning the buyer will be responsible for arranging freight and shipment to the destination, with such costs reimbursed by Kipushi; (xxxv) statements that Kipushi concentrator is on schedule for commissioning and first production in Q3 2024; (xxxvi) statements that the Kipushi concentrator includes DMS and a milling and flotation circuit and is expected to produce more than 270,000 tonnes of zinc contained in concentrate over the first five years of operations; (xxxvii) statements that the Kipushi concentrator’s design recoveries are targeted at 96%, with a concentrate grade of 55% contained zinc; (xxxviii) statements that stoping of the ultra-high-grade Big Zinc orebody is expected to begin in January 2024; (xxxix) statements that over half of the Kipushi primary fleet and secondary support equipment has been mobilized, with the remainder expected to be delivered at the end of the third quarter; (xl) statements that concurrent training of new underground miners is ongoing at Kipushi, targeting a full complement of four crews by the end of the third quarter; (xli) statements that the year-to-date underground development rate averages approximately 250 metres per month and that following the mobilization of the remaining underground equipment fleet and the fourth mining crew, the underground development rate is expected to increase to approximately 450 metres per month by year-end; (xlii) statements that underground development at Kipushi throughout the remainder of the year will increasingly be in ore, grading between 20-25% zinc and that the ore will be hauled to surface and stored on the stockpile ahead of concentrator commissioning; (xliii) statements that the new commercial DRC-Zambia border crossing at Kipushi will not only benefit the Kipushi Mine but also Kamoa-Kakula as an additional route for exporting concentrate, and that such border crossing will provide socio-economic benefits to the community of Kipushi and the city of Lubumbashi; (xliv) statements that the mining method of the Big Zinc orebody at Kipushi will be transverse sublevel open stoping in a primary and secondary sequence and that the void of the mined-out stopes will be filled with cemented aggregate to maximize the extraction of the ultra-high-grade ore; (xlv) statements that at Kipushi the total mining height of long-hole stopes is 60 metres (comprising of an upper 30-metre-high stope and lower 30-metre-high stope), which will be separated by 15-metre-high sill pillars, that the long-hole stopes will be mined with a bottom-up mining sequence, with the lower stope extracted first followed by the upper stope and that the stopes will be extracted using a primary and secondary long-hole stoping sequence; (xlvi) statements that the vendor appointment by the Haut-Katanga province for the 11-kilometre, by-pass road from Kipushi is expected to be made imminently, with the mobilization of construction contractors to be made in the coming month and that the project award for the border infrastructure is expected to be made towards the end of 2023; (xlvii) statements that employees and contractors working at the Kipushi site will peak at approximately 2,000 in the fourth quarter of 2023 and that once operations have ramped up to steady-state, total on-site labour, including mining and support contractors, is expected to be approximately 1,200; (xlviii) statements that follow-up drilling is planned along sections of the four holes that were completed down dip of Makoko West to enhance the 3D geological interpretation of the area; (xlix) statements that  the gravity survey to be flown at the Mokopane Feeder Project will be completed during Q3 2023 due to equipment breakdown delays and that deep diamond drilling is now planned to commence in Q4 2023 to test targets identified from the results of the magnetic survey and the gravity survey to be completed; (l) statements that the remaining capital cost for the total Phase 3 expansion is estimated at $3.0 billion, including the mine, concentrator, smelter, infrastructure and investment in off-site hydropower infrastructure; (li) statements that the offtake and financing term sheet between Ivanhoe and joint-venture partner Gécamines, supported by Glencore International AG, is subject to the execution of final, binding agreements, which are expected to be concluded in conjunction with the new Kipushi Corporation joint-venture agreement in the coming months, and the particulars of such offtake and financing, including the fact that the company’s ownership in the Kipushi Project will reduce to 62%; (lii) statements that Phase 1 and Phase 2 operations at Kamoa-Kakula are anticipated to generate significant operating cash flows in 2023 and 2024, and are expected to fund capital cost requirements of approximately $2.1 billion at current copper prices, and that the joint venture is arranging short-term financing facilities should a shortfall occur due to a significant decrease in copper prices; (liii) statements with respect to the company’s capital expenditure guidance and planned expenditures for 2023 and 2024; (liv) statements that 2023 exploration activities have an initial budget of $31 million, including $19 million for Western Foreland; (lv) statements that the company intends to enter into a collaboration agreement with I-ROX, an I-Pulse subsidiary, to investigate and develop applications for pulsed-power technology in the mining sector; (lvi) statements that the company is on schedule to publish a maiden Mineral Resource estimate for its Makoko and Kiala high-grade copper discoveries in the Western Foreland in Q3 2023; and (lvii) statements that a second air core rig is planned to start drilling at Western Forelands in early Q3 2023.

As well, all of the results of the feasibility study for the Kakula copper mine, the Kamoa-Kakula 2023 IDP, the Platreef 2022 feasibility study, and the Kipushi 2022 feasibility study constitute forward-looking statements or information and include future estimates of internal rates of return, net present value, future production, estimates of cash cost, proposed mining plans and methods, mine life estimates, cash flow forecasts, metal recoveries, estimates of capital and operating costs and the size and timing of phased development of the projects.

Furthermore, concerning this specific forward-looking information concerning the operation and development of the Kamoa-Kakula Copper Complex, Platreef and Kipushi projects, and the exploration of the Western Foreland Exploration Project and the Mokopane Feeder Exploration Project, the company has based its assumptions and analysis on certain factors that are inherently uncertain. Uncertainties include: (i) the adequacy of infrastructure; (ii) geological characteristics; (iii) metallurgical characteristics of the mineralization; (iv) the ability to develop adequate processing capacity; (v) the price of copper, nickel, zinc, platinum, palladium, rhodium and gold; (vi) the availability of equipment and facilities necessary to complete development and exploration; (vii) the cost of consumables and mining and processing equipment; (viii) unforeseen technological and engineering problems; (ix) accidents or acts of sabotage or terrorism; (x) currency fluctuations; (xi) changes in regulations; (xii) the compliance by joint venture partners with terms of agreements; (xiii) the availability and productivity of skilled labour; (xiv) the regulation of the mining industry by various governmental agencies; (xv) the ability to raise sufficient capital to develop such projects; (xvi) changes in project scope or design; (xvii) recoveries, mining rates and grade; (xviii) political factors; (xviii) water inflow into the mine and its potential effect on mining operations, and (xix) the consistency and availability of electric power.

This news release also contains references to estimates of Mineral Resources and Mineral Reserves. The estimation of Mineral Resources is inherently uncertain and involves subjective judgments about many relevant factors. Estimates of Mineral Reserves provide more certainty but still involve similar subjective judgments. Mineral Resources that are not Mineral Reserves do not have demonstrated economic viability. The accuracy of any such estimates is a function of the quantity and quality of available data and of the assumptions made and judgments used in engineering and geological interpretation (including estimated future production from the company’s projects, the anticipated tonnages and grades that will be mined and the estimated level of recovery that will be realized), which may prove to be unreliable and depend, to a certain extent, upon the analysis of drilling results and statistical inferences that ultimately may prove to be inaccurate. Mineral Resource or Mineral Reserve estimates may have to be re-estimated based on: (i) fluctuations in copper, nickel, zinc, platinum group elements (PGE), gold or other mineral prices; (ii) results of drilling; (iii) metallurgical testing and other studies; (iv) proposed mining operations, including dilution; (v) the evaluation of mine plans after the date of any estimates and/or changes in mine plans; (vi) the possible failure to receive required permits, approvals and licences; and (vii) changes in law or regulation.

Forward-looking statements and information involve significant risks and uncertainties, should not be read as guarantees of future performance or results and will not necessarily be accurate indicators of whether such results will be achieved. Many factors could cause actual results to differ materially from the results discussed in the forward-looking statements or information, including, but not limited to, the factors discussed above and under the “Risk Factors” section in the company’s MD&A for the three and six months ended June 30, 2023, and its Annual Information Form, and elsewhere in this news release, as well as unexpected changes in laws, rules or regulations, or their enforcement by applicable authorities; the failure of parties to contracts with the company to perform as agreed; social or labour unrest; changes in commodity prices; and the failure of exploration programs or studies to deliver anticipated results or results that would justify and support continued exploration, studies, development or operations.

Although the forward-looking statements contained in this news release are based upon what management of the company believes are reasonable assumptions, the company cannot assure investors that actual results will be consistent with these forward-looking statements. These forward-looking statements are made as of the date of this news release and are expressly qualified in their entirety by this cautionary statement. Subject to applicable securities laws, the company does not assume any obligation to update or revise the forward-looking statements contained herein to reflect events or circumstances occurring after the date of this news release.

The company’s actual results could differ materially from those anticipated in these forward-looking statements as a result of the factors outlined in the “Risk Factors” section in the company’s MD&A for the three and six months ended June 30, 2023, and its Annual Information Form.

南非约翰内斯堡 — 艾芬豪矿业 (TSX: IVN; OTCQX: IVPAF) 总裁玛娜·克洛特 (Marna Cloete) 及首席财务官大卫·范·希尔登 (David van Heerden) 欣然宣布公司截至2023年6月30日止三个月及六个月的财务业绩。艾芬豪矿业是一家加拿大矿业公司,正在推进旗下位于南部非洲的四大矿业项目﹕位于刚果民主共和国 (以下简称 “刚果 (金)”) 的卡莫阿-卡库拉 (Kamoa-Kakula) 世界级铜矿项目的扩建工程、位于南非的普拉特瑞夫 (Platreef) 顶级钯-铑-镍-铂-铜-金矿的建设项目、位于刚果 (金) 的久负盛名的基普什 (Kipushi) 超高品位锌-铜-铅-锗矿的复产项目,以及在毗邻卡莫阿-卡库拉的西部前沿 (Western Foreland) 探矿权进行勘查以寻找新的铜矿资源。除非另有指明,所有货币数字均以美元为单位。

卡莫阿-卡库拉铜矿项目2023年8月份运营和施工进展的视频﹕https://vimeo.com/850838953/163436ff95

财务业绩重点﹕

  • 艾芬豪矿业于2023年第二季度录得利润8,700万美元 (已扣除5.75亿美元可转债的的公允价值录得2,700万美元的非现金损失),2023年第一季度的利润为8,200万美元。第二季度的利润主要来自艾芬豪矿业在卡莫阿-卡库拉合资企业中的利润份额及财务收入 (共计1.23亿美元)。
  • 2023年第二季度,卡莫阿-卡库拉出售10.2万吨铜,破纪录获得7.02亿美元收入,营业利润为3.94亿美元,季度EBITDA达4.57亿美元。
  • 2023 年第二季度,卡莫阿-卡库拉的销售成本为1.24美元 / 磅,2023年第一季度及2022 年第二季度的销售成本分別为1.25美元 / 磅及1.15美元 / 磅。2023 年第二季度,现金成本 (C1) 为1.41美元 / 磅,2023年第一季度及2022 年第二季度的C1现金成本分別为1.42美元 / 磅及1.42美元 / 磅。
  • 艾芬豪矿业2023年第二季度经调整的EBITDA为1.72亿美元,2022年同期为1.01亿美元,2023年第一季度为1.72亿美元。
  • 自2021年7月1日启动 I 期商业化生产以来,卡莫阿-卡库拉合资企业已从经营活动产生18.2亿美元的净现金,至今为 II 期和 III 期扩建提供资金。
  • 艾芬豪矿业的财政状况稳健。截至2023年6月30日,公司持有现金和现金等价物3.93亿美元,预计卡莫阿-卡库拉 I 期和 II 期运营产生的现金流,以当前铜价计算,将足以支撑 III 期扩建所需的资本性开支。
  • 2023年5月22日,基普什锌业与刚果(金) 最大型的金融机构之一Rawbank签订融资协议。Rawbank 根据协议条款向基普什提供8,000万美元贷款,分两期提取,每期4,000万美元。基普什已提取第一期款项,将项目运营所需提供资金。贷款的年利率为8%。
  • 2023年4月27日,艾芬豪公布与合资企业伙伴刚果 (金) 国有矿业公司杰卡明 (Gécamines) 及 Glencore International AG (以下简称 "Glencore") 就基普什锌精矿100%产量的包销协议以及2.5亿美元的融资安排达成协议。包销和融资协议与基普什锌业的合资协议修订版预计将于未来数月同时落实,但尚需完成具有约束力的最终股东协议的签署。
  • 2023年6月15日,艾芬豪公布将高能勘探公司 (以下简称 “HPX”) 未偿还艾芬豪矿业的7,740万美元贷款余额转换为在其母公司I-Pulse 的股权投资,加入领先矿业公司必和必拓集团有限公司共同入股I-Pulse。公司正计划与 I-Pulse 的子公司 I-ROX 合作,携手研发脉冲功率技术在采矿领域的应用。

经营活动重点﹕

  • 2023年第二季度,卡莫阿-卡库拉铜矿刷新季度纪录共产铜10.4万吨,2023年第一季度生产9.4万吨铜,2022年第二季度生产8.7万吨铜。
  • 2023年前6个月,卡莫阿-卡库拉共产铜19.7万吨,有望按计划实现39万至43万吨铜的年度生产指导目标。
  • 卡莫阿-卡库拉I期和II期选厂第二季度共处理约220万吨矿石,平均入选品位5.2%,主要来自卡库拉矿山的高品位矿石,但由于选厂处理能力超过设计产能,需从地表矿堆向选厂额外供矿。
  • 2023年7月2日,卡莫阿-卡库拉创造单日处理矿石3万吨的新纪录,相当于1,000万吨矿石的年化处理能力 (考虑了设备利用率)。卡莫阿-卡库拉7月份生产精矿含铜3.6万吨,略低于最高月度生产记录,回收率达88%。
  • 卡莫阿-卡库拉 III 期矿山及选厂扩建计划、位于矿山范围内的50万吨/年一步炼铜冶炼厂的建设工程,以及英加二期水电站5号涡轮机组的升级改造正如期推进,预计于2024年底完工。预计卡莫阿-卡库拉 I 期和 II 期运营产生的现金流,以当前铜价计算,将足以支撑 2023年剩余时间和2024年扩建所需的资本性开支 (共计约19亿美元)。
  • 2023年7月27日,艾芬豪矿业公布卡莫阿-卡库拉铜矿尾矿再回收初步试验取得重大进展。2022年,卡莫阿铜业的选矿团队与多个国际知名的研究单位合作,探索以具有经济合理性的技术从 I 期和 II 期尾矿回收铜金属。至今结果显示,从尾矿再回收铜金属,有助于进一步提高产量、收入和现金流。
  • 艾芬豪继续在毗邻卡莫阿-卡库拉铜矿约2,407平方公里的西部前沿探矿权进行详细勘查。2023年的勘查预算约1,900万美元。5月份雨季结束后,2023年第二季度共完成37个钻孔共10,853米。2023年上半年共完成15,736米的金刚石钻探。
  • 艾芬豪将于2023年第三季度发布西部前沿Makoko和Kiala高品位铜矿勘查区的首次矿产资源估算报告。
  • 艾芬豪已启动优化工作,研究在普拉特瑞夫 3 号竖井安装提升设备的优化方案。施工中的3号竖井,原计划用于通风井及第二逃生井,现正计划装配提升设备。3号竖井正进行扩孔工程至直径5.1米,已完成约340米 (共950米),计划于2023年第四季度完工。3 号竖井装配提升设备,可在 2 号竖井于2027年投产前加快 II 期的井下开采作业。
  • 普拉特瑞夫重点建设从750米和850米中段到950米中段向Flatreef高品位矿体的水平开拓。目前,三个中段已完成共计2,000米以上的水平开拓,月平均200米。待8月底破碎机和矿石传送设备在950米中段完成装机后,预计今年剩余时间内的井下水平开拓速度将加快至约300米/月。
  • 直径10米的2号竖井的先导孔钻将于本季度完工。目前正准备开展2号竖井的扩孔作业,初步计划扩大至3.1米直径。
  • 基普什矿山的总体建设工程已完成约50%,选厂建设如期推进,将于2024年第三季度投产。选厂包括重介质分选车间以及浮选车间。基普什预计在投产后前5年将年产锌超过27万吨。
  • 基普什的井下开拓工程超计划推进,自2022年9月已完成2,147米的水平开拓。预计于2024年1月开采超高品位的大锌矿体。2023年至今的井下开拓速度约250米/月,预计到年底将提升至约450米/月。

卡莫阿矿业女性协会主席 Christelle Nday (中左)及副主席 Micheline Kyenge (中右) 带领一班来自毗邻 Mutoshi 技术学院的 10 年级学生参观卡莫阿-卡库拉铜矿,在卡索科 (Kansoko) 矿山入口一台载重21吨的装载机前拍照留念。

2023年8月3日周四召开投资者电话会议

艾芬豪矿业将于8月3日周四伦敦时间3:30pm / 北美东部时间 10:30 am / 太平洋时间7:30 am 召开投资者电话会议,讨论2023年第二季度的财务业绩。电话会议将包括答问环节,被邀媒体将在听众列席。

观看网络直播的链接: https://edge.media-server.com/mmc/p/3envh996

分析师请使用以下链接参加答问环节﹕ https://register.vevent.com/register/BI41a67c7e4bc743e7975234c0ae560d1a

电话会议的网络广播录音及相关演示材料将在艾芬豪矿业网站上提供﹕ www.ivanhoemines.com

发布后,财务报表和管理层的讨论和分析将在www.ivanhoemines.comwww.sedarplus.ca上提供。

阅读2023年第二季度艾芬豪可持续发展更新报告:https://ivanhoemines.com/site/assets/files/3775/sustainability-review-q2-2023.pdf

卡莫阿-卡库拉一步炼铜冶炼厂的尾气净化系统及毗邻的熔炼设施正在建设。

主要项目及活动回顾

1. 卡莫阿-卡库拉铜矿项目
艾芬豪矿业持有39.6%权益
位于刚果民主共和国

卡莫阿-卡库拉铜矿位于刚果(金) 铜矿带科卢韦齐 (Kolwezi) 以西约 25 公里,卢本巴希 (Lubumbashi) 以西约 270 公里处。卡莫阿-卡库拉铜矿项目的 I 期选厂于2021年5月启动生产,并于2021年7月1日正式实现商业化生产。II 期选厂的设计产能翻倍,于2022年4月投产。卡莫阿-卡库拉被国际矿业咨询公司伍德曼肯兹 (Wood Mackenzie) 评为2027年 (建设中的 III 期扩建投产后) 全球第3大铜矿。目前,卡莫阿-卡库拉约97%的员工为刚果(金)居民。

卡莫阿-卡库拉铜矿项目由艾芬豪矿业与紫金矿业的合资企业卡莫阿控股负责运营。2015年12月,艾芬豪向紫金矿业出售卡莫阿控股有限公司 (以下简称 "卡莫阿控股") 49.5% 的权益,并向私营企业晶河全球出售卡莫阿控股1%的权益。卡莫阿控股持有项目80%权益。艾芬豪与紫金矿业各自间接持有卡莫阿-卡库拉铜矿项目39.6%的权益,晶河全球间接持有 0.8% 权益,而刚果(金)政府则直接持有20%权益。

卡莫阿-卡库拉运营和财务数据摘要

2023年
第二季度

2023年
第一季度

2022年
第四季度

2022年
第三季度

2022年
第二季度

矿石处理量 (千吨) 2,244 1,9302,0062,0821,950
处理矿石铜品位 (%) 5.21% 5.42%5.40%5.60%5.44%
铜回收率 (%) 87.2% 87.1%86.1%85.9%84.0%
生产精矿含铜 (吨) 103,786 93,60392,76197,82087,314
已销售铜 (吨) 101,526 86,77792,20893,81285,794
销售成本 (美元/磅) 1.24 1.251.081.051.15
C1现金成本  (美元/磅) 1.41 1.421.421.431.42
实现铜价 (美元/磅) 3.79 4.043.543.504.34
平衡前的销售收入 (千美元) 729,924 659,529619,997570,504699,381
平衡后的合同应收款 (千美元) (27,542) 29,59453,473(110,031)(205,248)
平衡后的销售收入 (千美元) 702,382 689,123673,470460,473494,133
EBITDA (千美元)(1)    456,628 457,311452,089251,086285,477
EBITDA利润率 (
占销售收入的百分比)
65% 66%67%55%58%

上述数字均以100%项目权益统计。报告的精矿含铜金属量未考虑冶炼协议中的损失或扣减。本新闻稿载述“EBITDA”、“经调整EBITDA”、“EBITDA利润率”和“C1现金成本”为非公认会计准则的财务指标。关于本文载述每项非公认会计准则财务指标的详细说明,以及与国际财务报告准则 (IFRS) 最直接可比的详细对账,请参阅本新闻稿第●页“非公认会计准则财务指标”的部分。

  1. 未实现的外汇损失(包括前期的损失) 并未计入EBITDA,由于公司认为计入未实现的外汇损益并不能充分反映卡莫阿-卡库拉的整体经济性和盈利能力。

C1现金成本明细如下 :

 2023年
第二季度
2023年
第一季度
2022年
第四季度
2022年
第三季度
2022年
第二季度

采矿(美元/磅)      0.380.410.400.410.39
选矿(美元/磅)      0.190.190.160.120.14
运费 (运往中国)(美元/磅)      0.450.460.500.560.51
粗炼、精炼和冶炼费(美元/磅)      0.250.230.230.210.21
管理和行政成本(美元/磅)      0.130.130.130.130.17
生产每磅交付铜的C1现金成本(美元/磅) 1.41 1.42 1.42 1.43 1.42

C1 现金成本的计算基准与伍德曼肯兹成本指南制定的行业标准定义一致,但并非国际财务报告准则认可的方式。在计算 C1 现金成本时,成本的计量基准与财务报表中所述的公司应占卡莫阿控股合资企业的收益份额相同。管理层以C1 现金成本评估经营业绩,其中包括所有直接采矿、选矿以及管理和行政成本。冶炼费和销售至最终港口的运费扣减被列作销售收入的一部分,将计入C1现金成本,以得出交付成品金属的粗略成本。权益金、产品税和非经常性费用并非直接生产成本,因此不会计入C1现金成本。

上述数字均以100%项目权益统计。报告的精矿铜产量未考虑冶炼协议中的损失或扣减。

(左起)﹕控制室主管 Guelord Ilunga、Derick Yav Tshang 及 Carine Ndala、矿冶专家 Jean-Saint Kabange、高级控制员 Dan Mutamba 以及控制室主管 Chris Tshibanda 在卡莫阿-卡库拉的选厂控制室内。

卡莫阿-卡库拉铜矿于2023年第二季度共生产10.4万吨铜,2023年5月份破纪录生产3.6万吨铜

扩产建设竣工后,卡莫阿-卡库拉 I 期和 II 期选厂的综合稳态产能已提升至920万吨/年。I 期和 II 期选厂的扩产建设在预算5,000万美元内、比原计划提前于2023年2月底完成,年化产能提高至45万吨/年。

卡莫阿-卡库拉 I 期和 II 期选厂于2023年第二季度持续表现强劲,并刷新多项纪录,包括本季度破纪录生产10.4万吨铜,同比增长11%。2023年5月还创下月度产铜3.6万吨的纪录,并于4月底破纪录单周产铜9,710吨。2023年7月2日创造单日处理矿石3万吨的新纪录,相当于1,000万吨矿石的年化处理能力 (考虑了设备利用率)。

卡莫阿-卡库拉 I 期和 II 期选厂第二季度共处理约220万吨矿石,平均入选品位5.2%,主要来自卡库拉矿山的高品位矿石,但由于选厂处理能力超过设计产能,需从地表矿堆向选厂额外供矿。第二季度的平均铜回收率保持强劲,达87.2%。

7月份,卡莫阿-卡库拉 I 期和 II 期选厂共处理60万吨矿石,平均入选品位5.8%,回收率达88%,产铜3.6万吨,略低于最高月度生产纪录。

尽管6月份曾多次停机检修维护并且出现供电不稳定的情况,卡莫阿-卡库拉仍能于第二季度创下生产纪录。

自2022年第四季度起,卡莫阿铜业一直与刚果(金)国有电力公司SNEL紧密合作,就刚果(金)南部电网出现的稳定性问题进行研究,找出供电问题的症结并协助制定长期解决方案。卡莫阿铜业已制定一系列的升级改造计划以改善供电稳定性,目前正调动资源,并已开展供应商招标及设备采购的工作。

此外,卡莫阿铜业的工程师正计划在矿山增加备用供电系统,确保卡莫阿-卡库拉项目未来的供电稳定性,同时正讨论引入赞比亚外部输电。

在未来12至18个月内将分阶段实施电力增容计划。2023年第二季度已增容11兆瓦,矿山的备用电力共计48兆瓦。预计今年晚些时候将增加额外30兆瓦的备用电力,即使在电力中断的情况下,也能够满足卡莫阿-卡库拉项目 I 期和 II 期的总电力需求,预计于2024年第二季度投入运作。目前已订购增容130兆瓦的备用电力系统,预计于2024年完成装机,以配合建设中的 III 期选厂和冶炼厂投产。

同时正讨论引入赞比亚外部输电,增加高达100兆瓦电力,预计于2023年第三季度完成首阶段工作。

继续从卡库拉地表堆场向选厂供矿,卡库拉矿山正进行地下基础设施扩建,因此将从地表矿堆向选厂供矿以满足产量最大化。

截至2023年6月底,卡莫阿-卡库拉地表堆存约410万吨高品位和中品位矿石,平均铜品位约3.7%,含超过15.2万吨铜。2023年第二季度共采出220万吨矿石,铜品位5.2%;其中在卡库拉矿山采出的200万吨矿石,铜品位5.4% (包括矿床高品位中心采出的68万吨矿石,铜品位高达7.0%)。

卡莫阿铜业土建主管Jurie Human和承包商Kongo River Construction的现场经理Julias Mblambo正研究卡库拉的井下设计图。

卡莫阿-卡库拉提高铜回收率的初步试验取得可喜进展

2023年7月27日,艾芬豪公布卡莫阿-卡库拉铜矿尾矿再回收初步试验取得可喜进展,试验设计将尾矿磨至微米级,再进行常规的浮选、浓密和压滤;在入选品位低于1%的情况下,仍可回收尾矿中约65%的铜,有望将整体回收率提高至95%左右。试验分析结果显示,卡莫阿-卡库拉可以进一步提高产量、收入和现金流。

2022年,卡莫阿铜业的选矿团队与多个国际知名的研究单位合作,探索以具有经济合理性的技术从 I 期和 II 期尾矿回收铜金属。目前,共13项不同技术路线的选矿试验正在进行中,需作进一步的选冶试验及工程设计,力求加快项目发展以推进投资决策。

2022年,卡莫阿-卡库拉铜矿共处理约710万吨矿石,平均入选品位5.5%,产铜33.3万吨。以设计指标回收率86%计算 ,超过5万吨铜未能回收而进入尾矿库或用于井下回填。卡莫阿-卡库拉2022年的尾矿平均铜品位约0.8%。BMO的研究显示,2022年全球铜矿的原矿平均铜品位约为0.6% (见图 1)。

图1﹕2000 年以来的全球平均原矿铜品位和卡莫阿-卡库拉2022年尾矿平均铜品位

信息来源﹕BMO 研究部、伍德曼肯兹 (Wood Mackenzie)

III 期选厂和地表基础设施建设顺利

卡莫阿-卡库拉 III 期扩建预计将于2024年第四季度投产。III 期扩建将在 I 期和 II 期选厂以北约10公里处,建设一座500万吨/年的新选厂。

III 期选厂的工艺设计与 I 期和 II 期选厂相似,但产能高出30%。选厂前端流程 (堆矿、初碎和筛分) 的设计产能高达1,000万吨/年,以配合后续的 IV 期扩建。选厂的建设理念与 I 期和 II 期相同,大部分设备与 I 期和 II 期选厂相同或类似,因此可以使用相同的备件,并可利用之前汲取的操作和维护方面的经验。

III 期投产后,卡莫阿-卡库拉的综合设计产能将提高至1,420万吨/年。预计在前10年产能扩大至年产62万吨铜,这将使卡莫阿铜业于2027年成为全球第三以及非洲最大的铜矿山(详见图2)。

图 2﹕2027年世界十大铜矿排名预测

注:卡莫阿-卡库拉铜矿的产量和品位引自卡莫阿-卡库拉2023预可研。伍德曼肯兹制定的 "铜入选品位” 反映了矿产储量的平均品位。

信息来源﹕伍德曼肯兹 (2023年) (根据公开披露而作出,伍德曼肯兹未审核卡莫阿-卡库拉 2023 预可研)。

卡莫阿-卡库拉 III 期扩建包括卡莫阿1区和卡莫阿2区的新采区,以及一座500万吨/年的新选厂,将按计划于2024年第四季度投产。卡莫阿1区和卡莫阿2区的双向斜坡道建设和 III 期采区的进出场通道掘进工程进展顺利。卡莫阿1区和卡莫阿2区将使用同一井口的双向斜坡道,用于人员出入场及传送带通道。双向斜坡道施工顺利,至今已完成超过2,000米的水平掘进工程,卡莫阿2区的进场通道已经完工,预计于2023年10月份贯通斜坡道。卡莫阿1区将于2023年底开始采矿,其后卡莫阿2区将于2025年开展,将采用与卡库拉矿山同样的机械化进路充填采矿法。

卡莫阿-卡库拉选厂 III 期土建工程即将完成,迄今已浇注超过2.5万立方米的混凝土。

卡莫阿-卡库拉 III 期选厂精矿浓密机的地基建设进展顺利。

承包商Prospere的代表与卡莫阿铜业团队在卡莫阿-卡库拉 III 期球磨机基座前。

III 期项目进度已完成38%,按计划将于2024年第四季度实现投产

III 期的详细工程设计和采购工作即将完成,设备加工制造已完成61%,正逐步加快设备交付。预计共需1,799辆卡车来运输所有设备,其中505辆已经运至现场,另有224辆装载设备的卡车正在运送途中。

土建工程即将完成,迄今已浇注超过2.5万立方米的地基混凝土(共3万立方米)。2023年第二季度已签订钢结构、机械、管道和钣金(SMPP)合同,且钢结构已开始运抵现场。建设所需7,400吨钢结构和钣金,其中约5,000吨已交付现场,且5万米长管道(共计7.3万米)的采购订单已经完成.

第一台和第二台球磨机最后一批重载1,830吨的设备已从中国河南的中信重工发运,首批集装箱已抵达南非德班港。III 期选厂现场已开始安装第一台球磨机 (共两台) ,且脚手架搭建工作进展顺利。首批设备包括圆锥破碎机、浮选设施、振动筛、精矿压滤机、旋流器、压缩机和水泵等,预计即将运抵现场,且最近已将板式给矿机吊到 III 期矿堆。

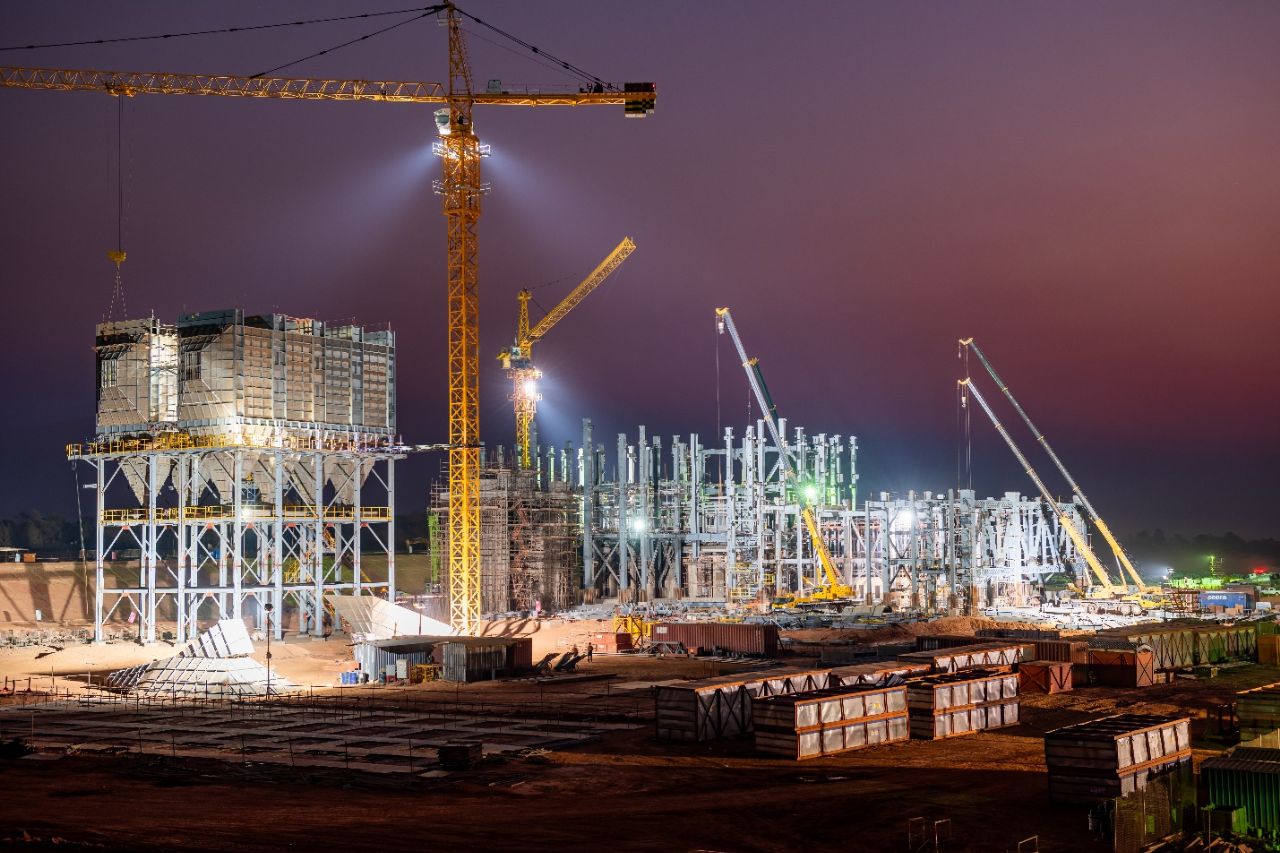

冶炼厂整体项目工程已完成56%,将按计划于2024年第四季度实现投产

III 期扩建计划还包括建设非洲最大的一步炼铜冶炼厂,每年可生产50万吨含铜超过99%的粗铜和阳极铜。冶炼厂位于矿山范围内,毗邻 I 期和 II 期选厂。冶炼厂将采用芬兰美卓奥图泰公司的技术,按照国际金融公司(IFC)制订的排放标准建造。

所有设备和厂房的桩基工程都已完成。大部分钢结构和设备的采购订单已经完成,目前正在制造中。第一批钢结构和机械设备已运抵现场。约726辆装载钢材和设备的卡车 (预计共5,400辆卡车) 已抵达现场。项目已签订机电施工合同,承包商的工作团队已开始进驻营地。一步炼铜冶炼厂的闪速炉和电炉以及尾气净化系统正进行机械安装。目前约有2,000名工人在冶炼厂施工,预计2023年12月将达到最高人数3,000名。

卡莫阿-卡库拉 III 期扩建还将包括英加二期水电站5号涡轮机组的升级改造。涡轮机组升级后,将为国家电网增容178兆瓦清洁水电,可以满足 III 期选厂及一步炼铜冶炼厂的电力需求,并为日后扩建提供备用电能。卡莫阿-卡库拉冶炼厂生产的99.7%阳极铜预计将成为全球单位铜碳排放最低的产品之一。

卡莫阿-卡库拉 III 期一步炼铜冶炼厂的土建工程进展顺利,将按计划于2024年第四季度完工,将会成为非洲最大型的一步炼铜冶炼厂。

III 期冶炼厂浓硫酸储运设施的地基及土建施工正按计划推进。所有设备和厂房的桩基工程都已完成。

冶炼厂的精矿处理能力达1,200万吨/年,将处理 I 期和 II 期来自卡库拉和 III 期及后续 IV 期来自卡莫阿选厂的精矿。卡莫阿-卡库拉2023综合开发方案显示,冶炼厂将处理卡莫阿-卡库拉约80%的精矿。卡莫阿-卡库拉根据与卢阿拉巴铜冶炼厂签订的为期十年的协议,继续将部分精矿送往距离卡莫阿-卡库拉铜矿约50公里、靠近科卢韦齐镇的卢阿拉巴铜冶炼厂代加工,预计每年处理约15万吨铜精矿。

此外,冶炼厂每年将生产65万至80万吨的浓硫酸副产品。刚果(金)对硫酸有强烈需求,用于 SX-EW (溶剂萃取法和电解) 法处理氧化铜矿石。刚果(金)市场于2022年共消耗约600万吨酸,其中大部分通过进口硫磺来制造硫酸。

冶炼厂位于矿山范围内,为卡莫阿-卡库拉铜矿项目带来巨大的经济效益,显著降低物流成本,还有助于降低粗炼费和当地税项,并可从副产品硫酸的销售中获得收益。2023年第二季度,物流成本已占卡莫阿-卡库拉C1现金成本的 32%,由于含铜超过99%阳极粗铜出口的单位物流成本明显低于铜精矿,有助于将整体货运量减少一半以上。卡莫阿-卡库拉2023预可研显示,冶炼厂投产前5年 (从2025年起计) 将平均C1现金成本降低至约1.15美元/磅,与2023年指导目标中位的每磅可售铜C1现金成本1.45美元/磅相比,下降了21%。

卡莫阿-卡库拉 III 期扩建还包括英加二期水电站5号涡轮机组的升级改造,工程进展顺利。涡轮机组升级完成后,将为国家电网增容178兆瓦清洁水电,可满足 III 期的电力需求。同时正研究升级英加二期水电站和卡莫阿营地之间的现有电网基础设施的传输能力。

2023年生产及现金成本指导目标

卡莫阿-卡库拉2023年指导目标
精矿含铜 (吨)39万至43万
C1现金成本 (美元磅)1.40至1.50

2023年全年的C1现金成本及生产指导目标保持不变。上述数字均以100%项目权益统计。报告的精矿含铜未考虑冶炼协议中的损失或扣减。卡莫阿-卡库拉2023年的指导目标以各项假设和估算为基础,涉及对已知和未知风险、不确定性和其它因素的估计,可能与实际业绩出现重大差异。

生产指导目标以电力供应中断及其它假设为基础。截至2022年12月31日止年度,卡莫阿-卡库拉合资企业全年精矿产铜共33.3万吨,2023年上半年生产19.7万吨铜,其中包括2023年第二季度生产的10.4万吨。

2023年第二季度,每磅可售铜的C1现金成本为1.41美元/磅,2023年第一季度为1.42美元/磅。

C1现金成本的指导目标以各项假设为基础,包括基于区域货运能力估算的运输成本 (特别是闲置企业可能仍在运行)、粗炼和精炼费用的增加,以及消耗品等的通货膨胀。

C1现金成本为非公认会计准则的财务指标。管理层以C1现金成本评估经营业绩,其中包括所有采矿、选矿、堆矿处理以及管理和行政成本。冶炼费和销售至最终港口 (通常是中国港口) 的运费被列作销售收入的一部分,将计入C1现金成本,以得出交付最终结算金属产品的粗略成本。

卡莫阿CADET计划成员之一Chikuk Kawiz Lea在卡莫阿-卡库拉 I 期和 II 期选厂现场。CADET计划旨在为当地社区成员提供高技能工作培训。

施工团队在卡莫阿-卡库拉 III 期选厂,使用载重450吨的起重机吊装钢结构。

关于过往成本的对比,请参阅本新闻稿中“非公认会计准则财务指标”的部分。

2.普拉特瑞夫项目
艾芬豪矿业持股64%
位于南非

普拉特瑞夫项目由 Ivanplats (Pty) Ltd. (以下简称 "Ivanplats") 持有,艾芬豪矿业持有Ivanplats公司64%的权益。《全面提高黑人经济实力法案》(B-BBEE) 的南非受益人持有项目26%的权益,这些受益人包括20个当地社区,约15万居民、项目雇员和当地企业主。伊藤忠商事株式会社、日本石油天然气和金属国家公司和日本天然气公司组成的日本财团通过2轮投资 (共2.9亿美元) 持有Ivanplats 10%的权益。

普拉特瑞夫是一个地下开采矿山,铂族金属、镍、铜和金矿体厚大,位于林波波省的布什维尔德岩浆杂岩带北部,距离约翰内斯堡东北约280公里,距离莫科菲德镇约8公里。

在布什维尔德北翼,铂族金属矿化主要赋存在普拉特瑞夫层位,是一套走向延伸30多公里的矿化序列。艾芬豪的普拉特瑞夫项目位于普拉特瑞夫层位的南部,由Turfspruit及Macalacaskop两个相连的矿权组成。最北部的Turfspruit 矿权,邻近且位于英美铂金(Anglo Platinum) Mogalakwena矿山的走向延伸上。

自2007年以来,艾芬豪重点推进普拉特瑞夫的勘查和开发活动,以圈定和扩大早期发现的Flatreef矿床的深部延伸,以开展高度机械化的地下开采。1号竖井用于初步进场通道,现已正式运行并从井下提升矿石。目前,艾芬豪正全力进行建设工程,以推进普拉特瑞夫 I 期于2024年第三季度实现投产。

普拉特瑞夫项目由3亿美元的金属流融资提供开发资金,正集中推进落实高级债务融资,计划于2023年第三季度达成协议。

1 号竖井 (图左) 旁的2号竖井混凝土井塔 (图右) 在本季度初已完成79米。2 号竖井将高出地面约100米,包括支撑主卷扬机的钢结构。

地表建设工程及井下水平巷道开拓进展顺利

地下开发工作重点建设从750米和850米中段到950米中段向Flatreef高品位矿体的水平开拓。目前,三个中段已完成共计2,000米以上的水平开拓,即平均每月开拓约200米工程。待8月底破碎机和给矿机在950米中段完成装机后,预计今年剩余时间内的井下水平开拓速度将继续加快至约300米/月。从2024年1月起,预计开拓速度将提升至约500米/月。

普拉特瑞夫 I 期选厂将于2024年第三季度投产。所有地基已浇注混凝土,并已开展墙体和基座的模板和钢架构固定工作。长周期机械设备正按计划制造生产中。I 期的所有采购订单已完成70%以上。4月份开始进行SMPP工程和选厂的钢结构安装,建设所需1,500吨钢结构,至今约160吨已完成安装。电气仪表项目(EC&I) 已签订合同,承包商已搭建营地且工作团队已进驻现场。

普拉特瑞夫 I 期浮选设施的地基建设进展顺利。普拉特瑞夫 I 期选厂将按计划于2024年第三季度投产,目前所有地基已浇注混凝土。

直径10米的2号竖井正在施工中,将具有800万/吨年的提升能力。2号竖井将用于后续建设阶段,并将成为全球最大型的提升竖井之一。本季度初,2号竖井的混凝土井塔已完成约79米。2 号竖井将高出地面约100米,包括支撑主卷扬机的钢结构。2号竖井井塔的内部钢结构施工进展顺利。吊桶和分级卷扬机的土建工程即将完成,卷扬机将于2023年12月运抵现场,且最近已交付吊桶卷扬机的钢索。

2号竖井的先导孔钻进于2023年2月开展,至今已达到竖井底部。目前正准备开展2号竖井的扩孔作业,初步将扩大至3.1米直径。竖井底部的通道开通后,将从950米中段开始进行反向成井钻进。

普拉特瑞夫的5兆瓦光伏电厂于2022年第四季度开始施工,预计于今年晚些时候投产。光伏逆变器和光伏板最近已运抵现场。光伏发电将用于矿山开发和运营活动,且其后将引入其它可再生能源。

测量助理Sina Kekana在普拉特瑞夫2号竖井工作。 2号竖井将按计划于2027年底竣工。

优化工作正进行中,力求加快普拉特瑞夫 II 期扩建

艾芬豪已启动优化工作,研究在 3 号竖井 (前身为1号通风井)装配提升设备的优化方案。施工中的3号竖井,原计划用作通风井及第二逃生井,现正计划装配提升设备,可从井下提升矿石和废石。这个方案有利于降低 I 期矿山建设和产量爬坡的风险,并可在 2 号竖井于2027年投产前加快 II 期井下开采作业的产量爬坡。

3号竖井正进行扩孔,计划达到直径5.1米,至今已完成约340米 (共950米),计划于2023年第四季度完工。 3 号竖井井塔的辅助卷扬机正在制造生产中且进展顺利。目前已签订凿井卷扬机和装配卷扬机地基建设的土建合同,且承包商的工作团队已开始进驻现场。

普拉特瑞夫矿山生产用水的长期供应

预计 I 期生产的用水需求最高约300万公升/天,II 期扩建完工后将提高至900万公升/天。2022年1月,Ivanplats签署新协议,将获得当地经处理后的中水,以供应普拉特瑞夫分期开发所需的生产用水。这份协议取代了最初于2018年签署的协议。

根据新协议的条款,Mogalakwena当地政府 (以下简称“MLM”) 同意,自项目投产后的32年间由莫科菲德的 Masodi 废水处理厂每天供应不少于300万公升且不多于1,000万公升经处理的中水。Masodi 废水处理厂的施工正在进行中。

同时,Ivanplats已签署资助协议,承诺将完成Masodi废水处理厂2018年中断后的未完成工程。废水处理厂重启建设工程后,施工进展顺利,将于2023年第三季度完工。

此外,Ivanplats已就污水处理基础设施的升级改造签署协议备忘录,以增加日后扩建所需的供水量。

3. 基普什项目
艾芬豪矿业持有68%股权
位于刚果民主共和国

位于刚果(金)的基普什锌-铜-锗-银-铅矿,邻近基普什镇,距离卢本巴希西南约30公里。基普什地处中非铜矿带,位于卡莫阿-卡库拉铜矿项目东南约250公里,距离赞比亚边境不足一公里。2011年11月,艾芬豪通过其全资子公司基普什控股,收购了基普什项目68%的权益;其余32%权益由刚果(金) 国有矿业公司杰卡明持有。

基普什2022年可行性研究的重点是大锌矿带和南锌矿带的开采,估算的探明和控制矿产资源之矿石量达1,180万吨,锌品位35.3%。基普什拥有超高的锌品位,国际领先的研究咨询集团伍德曼肯兹认为基普什锌品位超过全球第二高锌矿项目的两倍以上。

2023年4月27日,艾芬豪矿业公布基普什锌业与杰卡明及Glencore International AG (以下简称 "Glencore") 已就包销和融资安排签署三方协议,推进久负盛名的基普什锌-铜-铅-锗矿山复产。

包销协议涵盖基普什矿山于5年期内生产锌精矿的100%产量 (40万至60万干吨/年)。包销协议包括标准的国际商业条款,以及基于年度行业基准的锌产品应付款和粗炼费。预计基普什将会生产锌品位约55%的精矿,有害元素含量极低。包销商将以FCA (货交承运人) 方式购买基普什矿山的精矿,买方将负责由交货点至最终目的地的货运,有关费用由基普什进行报销。

2.5亿美元的定期融资将分两期支付,每季度提取一次,但仍须满足先决条件。融资安排的年利率为有担保隔夜融资利率 (SOFR) 加7%,并应在签字后24个月的宽限期后,在36个月内按季度分期支付。

包销和融资协议与基普什的合资协议修订版预计将同时签署,但尚需完成具有约束力的最终股东协议的签署。

2023年6月,基普什锌业与Rawbank银行签订一项8,000万美元的无担保融资协议。 Rawbank 是刚果(金)最大型的国内银行,预计到2024年底,Rawbank向刚果(金)采矿业提供的贷款将达10亿美元以上。

Rawbank贷款的年利率为8%,将服从于嘉能可支持的2.5亿美元融资安排。此外,艾芬豪矿业还就该项贷款提供企业担保。基普什控股已提取第一期4,000万美元款项 (共两期)。贷款将为项目的建设工程提供资金,以减低艾芬豪矿业向基普什锌业提供股东贷款的需求。

基普什项目剩余的初期资本性开支为3.54亿美元,将由与Rawbank新签订的8,000万美元融资和嘉能可支持的2.5亿美元融资提供资金,差额将由艾芬豪矿业提供额外股东贷款弥补。

2022年第一季度,基普什控股与杰卡明签署新框架协议,推进基普什超高品位矿山重启商业化生产。新框架协议规定的商业条款将构成基普什新合资项目协议的基础,为基普什矿山未来的互利运营构建稳固的框架,但尚需完成最终股东协议的签署。达成协议后,艾芬豪矿业所占基普什项目的股权将减少至62%,杰卡明将持有余下的38%股权。

80万吨/年的新选厂正在施工中,预计投产前5年年产锌超过27万吨。

在过去69年开采期间,基普什共开采了6,000万吨矿石,锌和铜品位分别为11%和约7%,共生产660万吨锌和400万吨铜;同时在1956年与1978年间生产了278吨锗和12,673吨铅。由于精矿被运送到比利时,而且在殖民时代并没有公开贵金属的冶炼回收率,因而没有贵金属产量的历史纪录。另外,艾芬豪矿业在基普什富锌和富铜矿带的钻探勘查,还发现了价值巨大的银矿资源。

艾芬豪于2011年收购基普什项目的权益后,钻探勘查使得富锌矿体的探明和控制矿产资源增加至两倍以上,估算的矿石量为1,178万吨,锌品位35.34%、铜品位0.80%、银品位23克/吨和锗品位64克/吨 (7% 锌边界品位),含有92亿磅锌、870万盎司银和2,440万盎司锗。

基普什2022可行性研究显示,基普什的精矿含有大量的锗和镓金属。

锗是一种战略金属,用于电子设备、平板显示屏、发光二极管(LED)、夜视设备、光纤网络、光学透镜系统和太阳能电池应用。

镓更是一种战略金属,用于制造集成电路所需的复合半导体晶片,以及激光二极管、LED、光电探测器和太阳能电池等光电设备。

基普什选厂将按计划于2024年第三季度投产,整体项目进度已完成约50%

80万吨/年新选厂的建设工程正顺利进行。选厂设施包括重介质分选 (DMS) 以及一座选矿和浮选设施,预计在投产前5年将生产精矿含锌27万吨以上。设计回收率为96%,精矿锌品位55%。

整体项目进度已完成约50%,基普什选厂将按计划于2024年第三季度投产。详细设计已超计划提前完成。采购工作也快将完成,只有台套设备尚未交付。选厂所需共计73台套设备,其中15台套已运抵现场,尚有部分设备 (包括球磨机在内) 正在运送途中。

中信重工在中国制造的球磨机已抵达南非德班港,预计于一个月内运抵现场。南非 Bond Equipment 公司制造的重介质分选设备已完工并正准备经卡车运往现场。南非FL Smidth公司生产制造的粗选机组都已完成,预计于下个月发货。

2023年4月份开始在基普什进行钢结构安装,建设所需2,074吨钢结构,至今1,342吨已抵达现场。整体项目进度已完成约50%,基普什选厂将按计划于2024年第三季度投产。

SMPP承包商已完成第一座建筑物,即变电站大楼的工程,并已移交给矿场。

井下开拓工程正加快推进,自2022年9月已完成2,147米的水平开拓。预计于2024年1月开采超高品位的大锌矿体。

基普什2022年可行性研究的重点是大锌矿带和南锌矿带的开采,估算的探明和控制矿产资源之矿石量达1,180万吨,锌品位35.3%。基普什拥有超高的锌品位,国际领先的研究咨询集团伍德曼肯兹认为基普什锌品位超过全球第二高锌矿项目的两倍以上。

2023年第一季度已签约地下采矿承包商,且采矿班组和采矿设备正分阶段进驻现场。主要采矿设备来自瑞典安百拓 (Epiroc) 公司。超过一半的主要采矿设备和辅助设备都已运抵现场,预计剩余的设备将于第三季度后期交付。

项目采用高效的、全机械化地下作业,有助于加快矿石处理量爬坡至稳态产能。项目于第二季度末调派3队采矿班组人员进行井下作业。每队采矿班组由5名矿工组成,配备主要采矿设备,包括一台安百拓282双臂台车、一台ST14铲运机以及两台MT42运载卡车。

Epoch Resources人员Tinette Brümmer在基普什尾矿库的土方工程施工现场。

第一台Simba深孔钻机已抵达现场,并准备运送到井下。同时,项目正为新的地下矿工提供培训,目标是要在第三季度末全面部署4个采矿班组。

地下开拓工程进展顺利,目前正从上至下建设大锌矿体的多个进场通道。现正在1,220米至1,335米中段之间的多个位置建设周边设施、进场通道和通风系统。斜坡道继续与大锌矿体开拓并行建设,2023年至今已完成1,526米的水平开拓,比原计划超前约20%。

2023年至今的平均地下开拓速度约250米/月。其余的地下开拓设备和第4队采矿班组进场后,预计到年底将超过450米/月。

本年度剩余时间的地下开拓工程将脉内掘进为主,锌品位20-25%。选厂投产前,矿石将被运送到地表的矿石堆场。

大锌矿体的井下开拓工程超前推进,预计于2024年1月开展采矿活动。空场法是一种开采地下矿石的采矿方法,留下的空间称为采空区。

大锌矿体将采用横向分段的空场法进行一次和二次开采,使用混凝土进行回填以最大化开采超高品位的矿石。

深孔采场的总高度为60米 (包括上层30米及下层30米),其间留有15米高的底柱。深孔采场将从下至上进行开采,先开采下层采场,然后开采上层,使用深孔采矿法进行一次和二次开采。

基普什矿山将使用刚果(金)国有电力公司SNEL提供的水电。伍德曼肯兹2020年的一项研究显示,基普什矿山的气体排放 (范围一和二) 曲线处于第二个百分位数 (见下图 3)。

图 3﹕全球锌矿的温室气体排放量 (范围一和二),以生产每吨当量锌金属所排放的当量二氧化碳千克数值 (kg CO2-e / t Zn eq.) 计算。基普什矿山每年的温室气体排放量 (范围一和二) 约为生产每吨锌金属排放0.06吨的二氧化碳 (tCO2e/t Zn)。

建设基普什专用商业口岸直接通往赞比亚

基普什矿山邻近基普什镇,距离卢本巴希西南约30公里。基普什地处中非铜矿带,位于卡莫阿-卡库拉铜矿项目东南约250公里,距离赞比亚边境不足一公里。

位于上加丹加省的 Kasumbalesa 和Sakania 是目前刚果(金)铜矿带进出口最繁忙的两个商业口岸,分别位于基普什东南面约110公里及230公里处。Kasumbalesa口岸于2022年出现了严重的通关拥堵。艾芬豪矿业一直与上加丹加省政府合作,采取一系列措施以改善出口矿产品的流程。

其中一项措施是研究在基普什建设刚果(金)-赞比亚的新商业口岸。今年早些时候,上加丹加省政府及刚果(金)国家当局已就各项建议进行审批,并已达成协议,通过在基普什建设新商业口岸。

新商业口岸的基础设施由三个项目部分组成﹕一条围绕基普什镇南端的环线,全长11公里并设有路灯;位于刚果(金)边境内基普什镇南端的新设一站式口岸,设有等候区及行政大楼);以及位于赞比亚边境的新设一站式口岸,同样设有等候区和行政大楼。

预计上加丹加省即将签署建造11公里环线的合同,且承包商的工作团队将于下月进驻营地。口岸基础设施的合同将于2023年底签署。

同时,赞比亚政府正进行公路升级改造,将T5高速公路连接到基普什边境 (见图4)。赞比亚政府已开展部分路段的升级工程,并计划在未来12至18个月内进行基础设施升级和全天候防护工作。

在基普什建设刚果(金)-赞比亚商业口岸,不仅为基普什矿山带来优势,同时也为卡莫阿-卡库拉项目提供了出口精矿产品的额外通道。新设的商业口岸还将为基普什和距离约30公里的上加丹加省省会卢本巴希的当地社区创造社会经济效益。

基普什以卡莫阿-卡库拉为榜样,重点推行当地招聘和发展人才培养。约有1,800名员工和承包商正参与基普什项目的建设,预计2023年第四季度将达到2,000名的峰值。矿山作业实现产量爬坡达到稳态产能后,预计现场的员工人数 (包括采矿和服务承包商) 将达约1,200名。目前,在基普什的504名全职员工中,超过97%为刚果(金)居民。

目前正进行培训计划,与基普什的管理层和工作班组分享卡莫阿-卡库拉项目在建设、投产和运营阶段所获得的技能和汲取的实践经验。艾芬豪矿业的员工经常到访基普什矿山,并提供现场工作能力培养、指导和培训,并分享在卡莫阿-卡库拉项目获得的经验,而基普什的关键人员也不时造访卡莫阿-卡库拉以学习实践经验。同时,基普什正制定一项全面的技能提升培训计划,预计将于本月底推行。

图4﹕现有口岸和规划中的刚果(金)-赞比亚商业口岸设施

4. 西部前沿勘查项目
艾芬豪矿业全资拥有及持有90%权益
位于刚果民主共和国

艾芬豪的刚果(金)勘查团队在西部前沿探矿权内,重点勘查卡莫阿-卡库拉类型的铜矿化。位于卡莫阿-卡库拉铜矿项目以北、以南和以西的西部前沿探矿权包括17个探矿证,总面积约2,407平方公里。之前在中非铜矿带取得重大发现和勘查经验的原班地质团队,在西部前沿探矿权内,采用相同的勘查模型。该模型成功指导了卡库拉、卡库拉西区和卡莫阿北区富矿带的发现。

2023年第二季度的勘查工作集中在金刚石和空气钻,本季度末共有四台承包商的金刚石钻机、一台艾芬豪自有的巡洋舰车载金刚石钻机及一台空气钻机进行钻探工作。2023年上半年共完成15,736米的金刚石钻探,其中37个钻孔共10,853米于2023年第二季度完成。2023年至今已完成了69个钻孔共1,795米的空气钻。

2023年第二季度,在Makoko和卡库拉矿床之间施工两个钻孔,以调查这两个矿床之间以及毗邻区域构造的地下是否存在矿化带。其中一个钻孔由于跑偏而被终止。第二个钻孔打到Nchana断层的一条分支断裂,因此未能达到设计深度。其后在该范围进行的钻探工程将会远离现有的两个钻孔,并使用今年晚些时候将运抵刚果(金)的定向钻进工具,以确保能够钻进至前陆陆棚地层下部边界和基底地层。

此外,在Makoko西区完成了4个钻孔,以查明西部前沿陆棚深部是否存在矿化带。这4个钻孔穿过Nguba群地层后打到Kibaran基底。计划沿剖面进行后续钻探,以提高该范围三维地质解释的质量。

本季度进行了道路和桥梁的修建工程,通往Sakanama勘查区更偏远的范围。在Sakanama勘查区施工的一个钻孔,在地表以下443米深度打到罗安群的沉积岩。

本季度在Lupembe勘查区重新开展空气钻,按照800米×800米的工程间距开展钻探,钻孔设计穿过Kalahari砂层。早期仅投入一台空气钻机进行钻探,计划在第三季度初进行维护工作时投入第二台空气钻机。空气钻旨在穿过平均5至30米厚的Kalahari砂层以采集下伏地层的岩屑样品,用于多元素地球化学分析和岩性分析,并查明在不同厚度的Kalahari砂层发现的铜异常。

本季度开始在西部前沿陆棚沿区域测线横穿Makoko西区,开展小间距大地重力测量,以识别较厚的Nguba群沉积岩,它也是生长断层的指示。前加丹加的生长断层是寻找沉积岩中赋存的铜矿化的关键指针,它们生成的半地堑,具有较厚大的粉砂岩容矿岩石和原生沉积黄铁矿。有人认为这些生长断层在从罗安群沉积序列富集和运移成矿流体过程中发挥了重要的作用。

第二季度初完成的内部矿产资源建模,确定了Makoko勘查区需要加密钻探的区域。第二季度共完成14个钻孔,采用艾芬豪自有的巡洋舰车载钻机进行150米以下的浅孔及两台Titan钻机进行深孔钻探。这14个钻孔共2,200米的岩芯数据,将纳入Makoko的地质数据库。

Makoko和Kiala的首次矿产资源估算报告将按计划于2023年第三季度发布。

图5﹕艾芬豪矿业西部前沿勘查区分布

5. 莫科菲德 (Mokopane Feeder) 勘查项目
艾芬豪矿业全资拥有
位于南非

2022年第四季度,公司获发位于布什维尔德杂岩带北部的三宗新探矿权,由艾芬豪矿业全资拥有。Blinkwater 244KR 、Moordrift 289KR 和 Lisbon 288KR 三个新的探矿权涵盖总面积 80 平方公里,是普拉特瑞夫项目现有矿权向西南的扩界。

该异常被认为是布什维尔德杂岩体北翼 Rustenburg 层状岩套的主要供矿构造带 (feeder zone)。Rustenburg 层状岩套的厚度显著增加,特别是高密度的下部带显著加厚,可以很好的解释重力异常的原因。解译的供矿构造靠近区域规模的地壳断层 (Ysterberg-Planknek 及 Zebedelia 断层) ,同时考虑到在普拉特瑞夫矿床厚大异常的铂族金属矿化,艾芬豪据此认为与这些重力异常相关的镍-铜-铂族元素矿化前景非常乐观。

图 6﹕普拉特瑞夫及莫科菲德探矿权重力异常分布图。

目前正进行高分辨率的航磁和Falcon重力测量,以解译重力异常所代表的岩石特征并开展三维建模。2023年第二季度已完成磁测。由于设备故障延期,重力测量将于2023年第三季度进行。目前计划于2023年第四季度开展金刚石钻探,以验证上述物探工作识别的靶区。

季度财务信息精选

下表总结了八个季度滚动的财务信息摘要。艾芬豪在任何财务报告期间都没有任何经营收入。卡莫阿-卡库拉项目商业化生产所得的经营收入均被计入卡莫阿控股合资企业。艾芬豪在任何财务报告期间都未声明或支付任何股息或股东红利。

  截至2023年6月30日止三个月 截至2023年3月31日止
三个月
截至2022年12月31日止三个月 截至2022年9月30日止三个月
  $’000$’000$’000$’000

应占合资企业利润 73,06682,65983,32434,057
财务收入 61,95657,82658,47746,720
递延(税款)回收 1,965926(3,839)4,252
金融资产的公允价值收益 (亏损) 488(1,595)(1,170)(2,873)
衍生负债的公允价值亏损 (26,618)(30,900)(66,600)(27,700)
管理和行政开支 (10,474)(8,571)(11,870)(9,199)
股份支付 (7,120)(7,702)(7,809)(7,381)
融资成本 (5,539)(10,465)(10,457)(10,223)
勘查及项目评价开支 (4,375)(3,381)(3,887)(4,312)
利润 (亏损):
归属于本公司股东 92,04286,63741,88426,344
归属于少数股东 (4,859)(4,157)(4,705)(2,477)
综合收益 (亏损) 合计﹕
归属于本公司股东 86,58874,15453,0784,588
归属于少数股东 (5,443)(5,420)(3,621)(4,678)

基本每股利润 0.080.070.030.02
稀释每股利润 0.070.070.030.02

  截至2022年6月30日止三个月 截至2022年3月31日止
三个月
截至2021年12月31日止三个月 截至2021年9月30日止三个月
  $’000$’000$’000$’000

衍生负债的公允价值收益(亏损) 183,600(66,400)(88,500)54,900
递延(税款)回收 114,184(1,347)74,069(50)
应占合资企业利润 49,69087,10978,39141,404
财务收入 38,59631,50527,97826,437
勘查及项目评价开支 (13,470)(12,243)(15,800)(15,677)
融资成本 (10,013)(7,391)(10,539)(10,451)
管理和行政开支 (8,957)(6,238)(10,658)(6,731)
股份支付 (4,637)(7,389)(7,490)(5,117)
利润 (亏损):
归属于本公司股东 316,24226,39445,83389,806
归属于少数股东 35,278(4,854)2,333(4,456)
综合收益 (亏损) 合计﹕
归属于本公司股东 306,38145,49529,77472,470
归属于少数股东 34,495(2,858)632(6,277)

基本每股利润 0.260.020.040.07
稀释每股利润 0.19(1)0.020.040.03(1)

(1) 公司确认,自2021年3月发行可转债以来,于期内并无考虑到可转债对于计算稀释每股利润的影响。因此,报表披露截至2022年6月30日止三个月及六个月的稀释每股利润为多计数值。

经营业绩讨论

截至2023年6月30日止三个月 (对比 2022年6月30日) 的回顾

公司于2023年第二季度录得8,700万美元的利润,2022年同期录得3.52亿美元利润。2022年第二季度所录得的利润,主要是嵌入式衍生金融负债的公允价值录得1.84亿美元的收益 (2023年第二季度嵌入式衍生金融负债的公允价值则录得2,700万美元的损失) 以及确认了基普什项目1.14亿美元的递延所得税资产,详情将在下文阐述。公司于2023年第二季度录得8,100万美元的综合收益,2022年第二季度则录得3.41亿美元。

卡莫阿-卡库拉铜矿项目于2023年第二季度销售10.2万吨铜,为卡莫阿控股合资企业创造7.02亿美元的收入。2022年同期则销售8.6万吨铜,收入4.94亿美元。2023年第二季度,公司录得来自合资企业的总收入1.23亿美元,总结如下:

 截至2023年6月30日
止三个月
截至2022年6月30日
止三个月
 $'000$'000

公司应占合资企业利润73,06649,690
合资企业贷款利息49,83734,874
 122,903 84,564

2023年第二季度,公司在卡莫阿控股合资企业的应收利润相比2022年同期增加了2,300万美元,明细详见下表里的汇总:

 截至2023年6月30日
止三个月
截至2022年6月30日
止三个月
 $'000$'000

应收款项的收入729,924699,381
平衡后的合同应收款(27,542)(205,248)
收入 702,382 494,133
销售成本(277,646)(217,112)
毛利 424,736 277,021

管理和行政开支(27,794)(23,964)
矿产摊销(3,005)
经营利润 393,937 253,057

融资成本(90,701)(66,828)
外汇亏损 (收益)(29,333)863
财务收入和其它5,1932,449
税前利润 279,096 189,541

当期税款(119,120)(4,726)
递延(税款)回收30,278(57,389)
税后利润 190,254 127,426

卡莫阿控股的少数股东权益(42,645)(27,044)
期内综合收益总计147,609100,382
公司应占合资企业利润 (49.5%) 73,066 49,690

截至2023年6月30日止三个月及2022年同期用于平衡合同应收款的实现铜价和临时铜价 (以市场售价计) 可总结如下﹕

 截至2023年6月30日
止三个月
截至2022年6月30日
止三个月
 $'000$'000

期内实现 - 期初未定价
远期开盘价 (美元/磅) (1)4.054.69
实现铜价 (美元/磅) (1)3.794.34
已销售铜 (吨)37,09250,608
平衡后的合同应收款 (千美元)(21,356)(39,227)

期内实现 - 当期新售铜
临时铜价 (美元/磅) (1)4.00
实现铜价 (美元/磅) (1)3.80
已销售铜 (吨)30,792
平衡后的合同应收款 (千美元)(13,006)

期末未定价 - 期初未定价
远期开盘价 (美元/磅) (1)4.69
远期收市价 (美元/磅) (1)3.80
已销售铜 (吨)39,797
平衡后的合同应收款 (千美元)(78,391)

期末未定价 - 当期新售铜
远期开盘价 (美元/磅) (1)3.774.26
远期收市价 (美元/磅) (1)3.813.79
已销售铜 (吨)69,93585,794
平衡后的合同应收款 (千美元)6,820(87,630)

平衡后的合同应收款总计 (千美元) (27,542) (205,248)

(1) 按加权平均值计

2023年第二季度,卡莫阿控股合资企业的融资成本为9,100万美元 (2022年第二季度﹕6,700万美元) ,其中7,200万美元与股东贷款有关,每位股东均需按照其股权比例向卡莫阿控股出资 (2022年第二季度﹕5,800万美元),直至项目产生足够的经营现金流。其它的融资成本中,1,400万美元与卡莫阿-卡库拉包销协议下的短期贷款有关 (2022年第二季度﹕700万美元)、300万美元与设备融资有关 (2022年第二季度﹕200万美元),以及200万美元与银行透支有关 (2022年第二季度﹕无)。

2023年第二季度的勘查及项目评价开支为400万美元,2022年同期为1,300万美元。2023年第二季度的勘查及项目评价开支用于西部前沿探矿权的勘查活动,2022年第二季度还包括用于基普什项目的开支,但由于项目重启开工因此在2023年第二季度将其开支予以资本化。

2023年第二季度的财务收入为6,200万美元,与2022年同期 (3,900万美元) 相比增加了2,300万美元。其中包括向卡莫阿控股合资企业提供贷款 (为过去运营出资) 的利息,2023年第二季度的利息收入5,000万美元,2022年同期所得的利息收入为3,500万美元。利息收入随着LIBOR息率上升和累计贷款余额增加。公司的贷款利息按12个月期美元LIBOR加7%的利率计算。截至2023年6月30日止三个月,12个月期美元LIBOR平均利率为5.53%,2022年同期则为2.81%。2023年7月1日起,利息将按SOFR参考利率计算。

公司在2023年第二季度嵌入式衍生金融负债的公允价值录得2,700万美元的损失,2022年第二季度嵌入式衍生金融负债的公允价值则录得1.84亿美元的收益,详见艾芬豪矿业截至2023年6月30日止三个月及六个月的《管理层讨论与分析》的可转债部分。

2022年第二季度,公司确认了基普什项目的递延所得税资产,从而产生了1.14亿美元的递延所得税回收 (收入)。鉴于基普什股东已就开发方案达成协议,并根据基普什2022可行性研究批准了开发预算,公司认为基普什项目很可能获得应税利润,可以计入未使用的税收损失和未使用的税收抵免。

截至2023年6月30日止六个月 (对比 2022年6月30日) 的回顾

截至2023年6月30日止六个月,公司录得1.7亿美元的利润及1.5亿美元的综合收益,2022年同期录得3.73亿美元利润及3.84亿美元综合收益。截至2022年6月30日止六个月所录得的利润,主要是嵌入式衍生金融负债的公允价值录得1.17亿美元的收益 (2023年同期嵌入式衍生金融负债的公允价值则录得5,800万美元的损失) 以及上文所述确认了基普什项目1.14亿美元的递延所得税资产所致。

截至2023年6月30日止六个月,公司录得来自合资企业的总收入2.53亿美元 (2022年﹕2亿美元),总结如下:

 截至2023年6月30日
止六个月
截至2022年6月30日
止六个月
 $'000$'000

公司应占合资企业利润155,725136,799
合资企业贷款利息97,42963,163
公司来自合资企业的收入 253,154 199,962

截至2023年6月30日止六个月,公司应占卡莫阿控股合资企业的利润为1.56亿美元,2022年同期的利润为1.37亿美元,总结如下:

 截至2023年6月30日
止六个月
截至2022年6月30日
止六个月
 $'000$'000

应收款项的收入1,389,4531,166,834
平衡后的合同应收款2,052(153,106)
收入 1,391,505 1,013,728
销售成本(517,223)(340,482)
毛利 874,282 673,246

管理和行政开支(58,440)(39,732)
矿产摊销(5,601)
经营利润 810,241 633,514

融资成本(179,374)(121,471)
外汇(亏损)收益(34,218)4,536
财务收入和其它10,1884,280
税前利润 606,837 520,859

当期税款(195,593)(9,941)
递延税款(9,339)(162,218)
税后利润 401,905 348,700

卡莫阿控股的少数股东权益(87,308)(72,339)
期内综合收益总计314,597276,361
公司应占合资企业利润 (49.5%) 155,725 136,799

截至2023年6月30日止六个月及2022年同期用于平衡合同应收款的实现铜价和临时铜价 (以市场售价计) 可总结如下﹕

 截至2023年6月30日
止六个月
截至2022年6月30日
止六个月
 $'000$'000

期内实现 - 期初未定价
远期开盘价 (美元/磅) (1)3.904.55
实现铜价 (美元/磅) (1)3.954.43
已销售铜 (吨)88,271103,673
平衡后的合同应收款 (千美元)11,269(28,171)

期内实现 - 当期新售铜
临时铜价 (美元/磅) (1)4.05-
实现铜价 (美元/磅) (1)3.94-
已销售铜 (吨)86,913-
平衡后的合同应收款 (千美元)(21,556)-

期末未定价 - 期初未定价
远期开盘价 (美元/磅) (1)3.794.55
远期收市价 (美元/磅) (1)4.054.23
已销售铜 (吨)6,62576,716
平衡后的合同应收款 (千美元)3,748(55,278)

期末未定价 - 当期新售铜
远期开盘价 (美元/磅) (1)3.844.36
远期收市价 (美元/磅) (1)3.884.13
已销售铜 (吨)100,241137,713
平衡后的合同应收款 (千美元)8,591(69,657)

平衡后的合同应收款总计 (千美元) 2,052 (153,106)

(1) 按加权平均值计

截至2023年6月30日止六个月,卡莫阿控股合资企业的融资成本为1.79亿美元 (2022年﹕1.21亿美元) ,其中1.45亿美元与股东贷款有关,每位股东均需按照其股权比例向卡莫阿控股出资 (2022年﹕1.07亿美元),直至项目产生足够的经营现金流。其它的融资成本中,2,700万美元与卡莫阿-卡库拉包销协议下的短期贷款有关 (2022年﹕1,200万美元)、500万美元与设备融资有关 (2022年﹕300万美元),以及200万美元与银行透支有关 (2022年﹕无)。

截至2023年6月30日止六个月,勘查及项目评价开支为800万美元,较2022年同期 (2,600万美元) 减少1,800万美元。 2023年的勘查及项目评价开支用于西部前沿探矿权的勘查活动,2022年还包括用于基普什项目的开支,但由于项目重启开工因此在2023年将其开支予以资本化。

截至2023年6月30日止六个月,财务收入为1.2亿美元,2022年同期为7,000万美元。其中包括向卡莫阿控股合资企业提供贷款 (为运营出资) 的利息,截至2023年6月30日止六个月的利息收入9,700万美元,2022年同期所得的利息收入为6,300万美元。2023年,合资企业利用其现金流支持项目运营和扩产,公司于年内没有向合资企业提供额外贷款。利息收入随着LIBOR息率上升和累计贷款余额增加。截至2023年6月30日止六个月,12个月期美元LIBOR平均利率为5.46%,2022年同期则为2.02%。

正如艾芬豪矿业截至2023年6月30日止三个月及六个月的《管理层讨论与分析》的可转债部分所述,截至2023年6月30日止六个月,公司的嵌入式衍生金融负债的公允价值录得5,800万美元的损失 (2022年﹕1.17亿美元收益)。

截至2023年6月30日止六个月的综合收益,包括由于南非兰特从2022年12月31日至2023年6月30日期间贬值10%而导致外汇损失2,000万美元,2022年同期因为换算海外业务而产生外汇收益1,000万美元。

截至2023年6月30日的财务状况 (对比截至2022年12月31日)

截至2023年6月30日,公司的总资产为42.37亿美元,相比截至2022年12月31日的39.69亿美元上升2.68亿美元。总资产的增长主要是向卡莫阿控股合资企业的投资增加了2.53亿美元及随着普拉特瑞夫和基普什项目继续开发,物业、厂房和设备增加了1.8亿美元,以及递延所得税资产增加了1,300万美元所致。

公司向卡莫阿控股合资企业的投资,从截至2022年12月31日的20.47亿美元增加2.53亿美元到截至2023年6月30日的23亿美元。公司对卡莫阿控股合资企业的投资明细如下﹕

 2023年6月30日 2022年12月31日
 $'000$'000
公司应占合资企业净资产666,165510,439
向合资企业预付贷款1,634,0301,536,601
投资合资企业合计 2,300,195 2,047,040

公司应占卡莫阿控股合资企业净资产的份额可分解如下﹕

  2023年6月30日 2022年12月31日
  100%49.5%100%49.5%
  $'000$'000$'000$'000

资产
不动产、厂房和设备 3,340,1321,653,3652,733,1761,352,922
矿产 784,286388,222789,888390,995
间接应收税款 335,736166,189279,385138,296
现金及现金等价物 333,204164,936365,633180,988
消耗品 314,843155,847257,434127,430
其它应收款 297,050147,040212,221105,049
长期应收贷款 263,096130,233252,523124,999
非流动库存 231,960114,820246,424121,980
应收账款 106,03152,48563,19631,282
流动库存 78,14138,68027,01113,370
使用权资产 46,55423,04411,5495,717
预付费用 14,2537,0559,2164,562
非流动存款 1,8729272,2721,125
递延所得税资产 626310710351

负债
股东贷款 (3,300,152)(1,633,575)(3,103,381)(1,536,174)
贸易及其他应付款项 (345,098)(170,824)(309,710)(153,306)
递延所得税负债 (283,180)(140,174)(273,841)(135,551)
应付所得税 (137,368)(67,997)(14,600)(7,227)
设备融资 (113,490)(56,178)(102,890)(50,931)
复兴拨备 (84,413)(41,784)(45,231)(22,389)
其他拨备 (58,833)(29,122)(26,675)(13,204)
短期融资贷款 (53,520)(26,492)(38,866)(19,239)
租赁负债 (47,624)(23,574)(13,243)(6,555)

非控股利益 (378,319)(187,268)(291,012)(144,051)

合资企业净资产  1,345,787 666,165 1,031,189 510,439

卡莫阿-卡库拉项目于2021年7月启动商业化生产之前,卡莫阿控股合资企业主要使用股东贷款,用于建设支出、不动产、厂房和设备来推进卡莫阿-卡库拉项目的发展。于2022年及2023年,合资企业利用其现金流支持项目运营和扩产,公司于期内没有向合资企业提供额外贷款。合资企业的财务状况稳健。截至2023年6月30日,合资企业持有现金和现金等价物3.33亿美元。

预计卡莫阿-卡库拉 I 期和 II 期运营将产生大量的现金流,以当前铜价计算,将足以支撑 III 期的资本性开支。合资企业正安排短期融资贷款,避免万一铜价大跌时导致资金短缺。卡莫阿-卡库拉在刚果(金) 的当地银行已安排1.9亿美元的透支额。

卡莫阿控股合资企业的现金流情况摘要如下:

 截至6月30日止三个月 截至6月30日止六个月
 2023202220232022
 $'000$'000$'000$'000

经营活动产生的净现金405,417249,877805,712634,362
营运资金项目变化(83,794)116,320(210,668)(43,646)
投资活动支出的净现金(370,232)(143,751)(623,388)(250,767)
融资活动产生 (支出) 的净现金(6,142)(895)(3,744)1,133
汇率造成的现金变化(1,669)(5,097)(341)(6,664)
净现金收入 (支出) (56,420) 216,454 (32,429) 334,418
现金和现金等价物 — 年初389,624139,995365,63322,031
现金和现金等价物 — 期末 333,204 356,449 333,204 356,449

卡莫阿控股合资企业的不动产、厂房和设备从2022年12月31日增长至2023年6月30日,达到6.07亿美元,可进一步分解如下:

 截至6月30日止六个月
 20232022
 $'000$'000
卡莫阿控股合资企业
扩建资本518,049267,756
维持性资本105,70725,709
初期资本9,009
 623,756302,474

折旧资本化18,1975,340
总资本性开支641,953307,814

借贷成本资本化51,54421,554
为卡莫阿控股增购其它不动产、厂房和设备总计693,497329,368

减﹕折旧、处置和外汇兑换(86,541)(54,296)

卡莫阿控股的不动产、厂房和设备净增长 606,956 275,072

截至2023年6月30日,艾芬豪拥有3.93亿美元的现金和现金等价物,相比截至2022年12月31日的5.97亿美元减少2.04亿美元。公司动用了1.98亿美元用于项目开发以及不动产、厂房及设备的购置,以及2,800万美元用于运营活动。

不动产、厂房和设备的净增长为1.8亿美元,共计2.06亿美元花费在项目开发及其它不动产、厂房及设备的购置。其中,1.06亿美元及7,000万美元分别用于普拉特瑞夫项目和基普什项目的开发成本及其它不动产、厂房及设备的购置 (详见第48页)。2023年第二季度,艾芬豪以2,800万美元购置一架公务机。

截至2023年6月30日止六个月及2022年同期,普拉特瑞夫项目及基普什项目的不动产、厂房和设备,包括已经资本化的开发成本,增长的主要细目详见下表:

 截至6月30日止六个月
 20232022
 $'000$'000
普拉特瑞夫项目
I 期建设55,91217,959
II 期建设25,7854,722
工资和福利6,4786,706
行政和其它开支3,2883,053
折旧3,152739
研究和工程外包2,1812,079
现场成本1,9841,034
社会和环境883556
总开发成本99,66336,848

增购其它不动产、厂房和设备6,2332,093
为普拉特瑞夫增购其它不动产、厂房和设备总计105,89638,941

 截至6月30日止六个月
 20232022
 $'000$'000
基普什项目
矿山建设成本39,159
行政费6,6193,519
工资和福利7,8325,725
其它开支5,1862,107
折旧 – 开发4,170
研究和工程外包3,5691,698
电力3,5331,544
增购其它不动产、厂房和设备4271,459
折旧 – 勘查和项目评价3,759
项目总开支70,49519,811

入账方法如下﹕
增购其它不动产、厂房和设备38,2651,459
开发成本资本化为不动产、厂房和设备32,230
经营活动亏损中的勘查和项目评价开支18,352
项目总开支70,49519,811

普拉特瑞夫项目及基普什项目2023年的各项支出对于项目迈向商业化生产而言是必需的,因此也资本化为不动产、厂房和设备。

2023年6月30日,公司与I-Pulse有限公司(以下简称“I-Pulse”) 达成转换协议,将高能勘探公司 (以下简称“HPX”) 未偿还予公司的可换股贷款余额转换为在I-Pulse的股权投资。2019年4月25日,公司向 HPX 提供5,000万美元的可转股贷款。截至2023年6月30日,贷款余额 (包括本金 5,000 万美元和应计利息 2,700 万美元) 共计 7,700万美元。根据转换协议,艾芬豪将HPX可转股贷款项下的所有责任转移至I-Pulse,以获得 I-Pulse 向艾芬豪发行的普通股。HPX是I-Pulse的子公司。公司在I-Pulse的股权投资,约占I-Pulse已发行普通股的5%。

截至2023年6月30日,公司的总负债为12.3亿美元,相比截至2022年12月31日的11.28亿美元增加了1.02亿美元,主要由于嵌入式衍生金融负债的公允价值录得5,800万美元的损失及下文所述基普什项目的4,000万美元贷款融资所致。

2023年5月22日,公司负责运营基普什项目的子公司基普什锌业有限公司 (以下简称“基普什”) 与刚果(金) Rawbank 银行签订贷款协议。Rawbank 根据协议条款向基普什提供8,000万美元贷款,分两期提取,每期4,000万美元,为基普什项目营运所需提供资金。基普什于2023年6月27日提取第一期款项。贷款的年利率为8%,另加每季度0.5%佣金。贷款连累计利息和佣金须于2024年5月31日偿还。根据贷款协议,艾芬豪已为基普什应付Rawbank的所有款项提供担保。

流动资金来源

截至 2023年6月30日,公司拥有3.93亿美元的现金和现金等价物。截至该日,公司的综合运营资金约3.49亿美元,而截至 2022年12月31日则为5.95亿美元。

2023年及2024年计划资本性开支明细如下:

资本性开支 2023年上半年
实际数值
2023年
指导目标
2024年
指导目标
 (百万美元)(百万美元)(百万美元)
卡莫阿-卡库拉
III 期扩建4071,400 – 1,8001,100 – 700
II 期及后续扩建资本111120
维持性资本10618080
 624 1,700 – 2,100 1,180 – 780

普拉特瑞夫
I 期初期资本77190 – 240200 – 150
II 期资本266060
 103 250 – 300 260 – 210
基普什
初期资本66 200 – 250 180 – 130

所有资本性开支的数值均以100%项目权益统计。

数值范围反映了卡莫阿-卡库拉 III 期扩建的时间点、普拉特瑞夫 II 期的资本和基普什项目的现金流在2023年至2024年两个历年期间存在的不确定性。普拉特瑞夫和基普什项目2024年资本性开支的指导目标未计入2024年首产后所需的维持性资本。

正如2023年1月30日公布的卡莫阿-卡库拉2023年综合开发方案所述,III 期扩建的剩余资本性开支约30亿美元,用于矿山、选厂、冶炼厂、基础设施和场外水电基础设施的投资。预计 I 期和 II 期运营将在2023年和2024年产生大量的现金流,以当前铜价计算,将足以支撑上述资本性开支。截至2023年6月底,合资企业持有现金和现金等价物3.33亿美元。

普拉特瑞夫 I 期矿山建设正在进行,将按计划于2024年第三季度投产。普拉特瑞夫 II 期的资本性开支主要用于2号竖井后续凿井工程和井塔建造。3号竖井的建设和装备,目前正在审查中,这有可能为 II 期生产计划提前提供契机。

基普什矿山的建设工程也在进行中,选厂将于2024年第三季度完工。剩余的资本性开支为3.8亿美元,至今已落实约1.63亿美元。2023年4月27日,艾芬豪与合资企业伙伴杰卡明及Glencore就基普什锌精矿100%产量的包销协议以及2.5亿美元的融资安排达成协议。包销和融资协议与基普什锌业的合资协议修订版预计将于未来数月同时落实,但尚需完成具有约束力的最终股东协议的签署。

2023年5月22日,基普什与刚果(金) Rawbank 银行签订贷款协议。Rawbank 根据协议条款向基普什提供8,000万美元贷款,分两期提取,每期4,000万美元,为基普什项目营运所需提供资金。基普什于2023年6月27日提取第一期款项。贷款的年利率为8%,另加每季度0.5%佣金。贷款连累计利息和佣金须于2024年5月31日偿还。根据贷款协议,艾芬豪已为基普什应付Rawbank的所有款项提供担保。

2023年将继续在刚果(金)的西部前沿勘查项目及其它靶区內进行勘查活动,初步预算为3,100万美元。

2021年3月17日,公司已完成私募发行总额为5.75亿美元、息票率2.50%、2026年到期的高级可转债。可转债为公司的高级无抵押债务,息票率2.50%,每半年付息一次。除非提前回购、赎回或转换,债券将于2026年4月15日到期。在2025年10月15日前一个工作日结束前,仅在某些情况下和特定时间,债券可根据持有人的选择进行兑换,此后,可随时兑换,直至到期日前第二个计划交易日结束。转换债券时,公司可选择以现金、普通股或其组合方式结算。截至2023年6月30日,主负债的账面值为4.8亿美元,嵌入式衍生负债的公允价值为2.79亿美元。

公司在其英国伦敦办公室有一笔价值320万英镑 (410万美元) 的抵押债券未偿付,需于2025年8月28日全额偿还,此抵押债券以物业资产担保,按1个月期英镑SONIA加1.9 %的利率每月支付利息。利息仅在到期日支付。

2013年,艾芬豪获ITC Platinum Development Limited提供应付贷款。截至2023年6月30日,该公司的账面值及合约金额为3,700万美元。艾芬豪必须在普拉特瑞夫项目出现剩余现金流后,即时偿还该项贷款。根据贷款协议,剩余现金流定义为普拉特瑞夫项目产生的总收入,扣除所有相关运营成本 (包括所有采矿建设和运营成本)。逾期债款需按3个月期美元LIBOR加2%的利率每月支付利息。利息不进行复利计息。2023 年 6 月 30 日起,利息将按3个月期美元SOFR加2.26%计算。

公司向监管机构提交的工作计划开支带有隐含承诺,以保持其勘查和采矿权许可证合法存续的良好信誉。下表列出了公司的长期合约责任﹕

截至2023年6月30日
的合同义务
偿还付款限期

            总计
        1 年內 1-3 年 4-5 年 5年后
$’000$’000$’000$’000$’000
可转债577,9932,993575,000
债务81,42940,0274,07237,330
租赁承诺1,689348770571
合同义务总计 661,111 43,368 579,842 571 37,330

如上所述,上表列出的债务代表应向花旗银行支付的抵押债券,以及应付ITC Platinum Development Limited和Rawbank的贷款。

公司需按其持有的股权比例向卡莫阿控股合资企业供资。

非公认会计准则财务指标

卡莫阿-卡库拉的 C1 现金成本和每磅 C1 现金成本

C1现金成本及每磅C1现金成本为非公认会计准则的财务指标。这些披露使投资者更清楚了解卡莫阿-卡库拉项目的表现,与其他铜生产商按照类似指标公布的业绩作比较。

C1现金成本的计算基准与伍德曼肯兹成本指南制定的行业标准定义一致,但并非IFRS认可的计量。在计算C1现金成本时,成本的计量基准与财务报表中所述的公司应占卡莫阿控股合资企业的收益份额相同。管理层以C1现金成本评估经营业绩,其中包括所有直接采矿、选矿以及管理和行政成本。冶炼费和销售至最终港口的运费被列作销售收入的一部分,将计入C1现金成本,以得出交付最终结算金属产品的粗略成本。权益金、产品税和非经常性费用并非直接生产成本,因此不会计入C1现金成本及每磅C1现金成本。

卡莫阿-卡库拉平衡后的销售成本与 C1 现金成本:

 截至6月30日止三个月 截至6月30日止六个月
 2023202220232022
 $'000$'000$'000$'000

销售成本 277,646 217,112 517,223 340,482

物流、粗炼和精炼费用123,887113,671235,330162,512
管理和行政开支27,79423,96458,44039,732
权益金和产品税(59,994)(55,651)(113,806)(84,227)
折旧 (47,722)(32,457)(86,210)(47,693)
电费回扣(4,779)(9,272)
产成品库存变动(774)545(1,462)548
集团其它实体的管理和行政开支(4,321)(2,074)(4,645)(2,302)

C1现金成本 311,737 265,110 595,598 409,052

每磅应付铜的销售成本 (美元/磅)1.241.151.251.12
生产每磅应付铜的C1现金成本 (美元/磅)1.411.421.411.34
精矿产铜量 (吨)100,41384,476190,974138,271

上述数字均以卡莫阿-卡库拉合资企业100%权益统计。

EBITDA 、经调整EBITDA EBITDA 利润率

EBITDA和经调整EBITDA为非公认会计准则的财务指标。艾芬豪认为卡莫阿-卡库拉的EBITDA是衡量项目是否有能力产生流动性的重要指标,通过产生运营现金流为其营运所需提供资金、偿还债务、为资本性开支供资,以及向股东派发现金股利。投资者和分析师也经常使用 EBITDA和经调整EBITDA进行估值。卡莫阿-卡库拉的EBITDA以及公司的EBITDA和经调整EBITDA旨在向投资者和分析师提供额外信息,但并非由IFRS标准定义的,故不应被独立评估或取代按照IFRS制订的表现指标。EBITDA和经调整EBITDA撇除融资活动的现金成本和税项的影响以及运营资金余额变动的影响,因此并不代表IFRS所定义的营业利润或经营产生的现金流。公司计算 EBITDA和经调整EBITDA 的方法可能与其他公司有所不同。

EBITDA利润率是衡量卡莫阿-卡库拉整体经济性的指标,反映了其盈利能力,计算方法是将息税折旧及摊销前利润除以收入。EBITDA利润率旨在向投资者和分析师提供额外信息,但并非由IFRS标准定义的,故不应被独立评估或取代按照IFRS制订的表现指标。

卡莫阿-卡库拉的税后利润与EBITDA的对账如下﹕

 截至6月30日止三个月 截至6月30日止六个月
 2023202220232022
 $'000$'000$'000$'000

税后利润190,254 127,426401,905 348,700

融资成本90,701 66,828179,374 121,471
当期及递延税款88,842 62,115204,932 172,159
折旧50,727 32,45791,811 47,693
未实现的外汇损失 (1)41,355 (836)46,244 (6,011)
财务收入(5,251) (2,513)(10,327) (4,319)

EBITDA456,628 285,477913,939 679,693

上述数字均以卡莫阿-卡库拉合资企业100%权益统计。

  1. 未实现的外汇损失并未计入当期及前期的EBITDA,由于公司认为计入未实现的外汇损益并不能充分反映卡莫阿-卡库拉的整体经济性和盈利能力。

艾芬豪的税后利润与EBITDA及经调整EBITDA的对账如下﹕

   截至6月30日止三个月 截至6月30日止六个月
 2023202220232022
   $'000$'000

税后利润87,183 351,520169,663 373,060

财务收入(61,956) (38,596)(119,782) (70,101)
当期及递延税款回收(1,769) (114,183)(2,650) (112,976)
融资成本5,539 10,01316,004 17,404
未实现的外汇损失 (1)1,934 2,3843,225 752
折旧609 2,2761,085 4,538
EBITDA31,540 213,41467,545 212,677

应占合资企业的税后净利润(73,066) (49,690)(155,725) (136,799)
公司应占卡莫阿-卡库拉合资企业的
EBITDA份额 (2)
180,489 114,309361,285 268,934
衍生负债的公允价值亏损 (收益)26,618 (183,600)57,518 (117,200)
非现金股份支付6,589 6,45713,127 12,710

经调整EBITDA172,170 100,890343,750 240,322
  1. 未实现的外汇损失并未计入当期及前期的EBITDA,由于公司认为计入未实现的外汇损益并不能充分反映公司的整体经济性和盈利能力。
  2. 公司应占卡莫阿-卡库拉合资企业的EBITDA份额是按照公司持有卡莫阿铜业 (39.6%)、艾芬豪矿业刚果(金)能源公司 (49.5%)、卡莫阿控股 (49.5%) 及Kamoa Services ( Pty) Ltd (49.5%) 的实际股权计算。

本新闻稿应当与艾芬豪矿业《2022年未经审计财务报表》和《管理层讨论与分析》报告一起阅读。有关报告可在www.ivanhoemines.comwww.sedarplus.ca获取。

技术信息披露

本新闻稿中关于卡莫阿-卡库拉铜矿项目(矿堆估算除外) 、普拉特瑞夫项目及基普什项目的科学或技术性披露已经由史蒂夫·阿莫斯 (Steve Amos) 审查和批准,他凭借其教育、经验和专业协会会籍被认为是NI 43-101 标准下的合资格人。由于阿莫斯先生是艾芬豪矿业的项目执行副总裁,因此他并不符合NI 43-101 对独立人士的界定。阿莫斯先生已核实本新闻稿所披露的技术数据。

本新闻稿中关于卡莫阿-卡库拉矿堆的科学或技术性披露已经由乔治·吉尔克里斯特 (George Gilchrist) 审查和批准,他凭借其教育、经验和专业协会会籍被认为是NI 43-101 条款下的合资格人。由于吉尔克里斯特先生是芬豪矿业资源部副总裁,因此他并不符合NI 43-101 对独立人士的界定。吉尔克里斯特先生已核实本新闻稿所披露关于卡莫阿-卡库拉矿堆的技术数据。

本新闻稿中关于西部前沿项目的科学或技术性披露已经由斯蒂芬·托尔 (Stephen Torr) 审查和批准,他凭借其教育、经验和专业协会会籍被认为是NI 43-101 条款下的合资格人。由于托尔先生是芬豪矿业地球科学副总裁,因此他并不符合NI 43-101 对独立人士的界定。托尔先生已核实本新闻稿所披露关于西部前沿项目的技术数据。

艾芬豪已经为卡莫阿-卡库拉项目、普拉特瑞夫项目和基普什项目分别编制了一份符合NI 43-101 标准的独立技术报告,这些报告可在艾芬豪网站以及SEDAR 网站上的艾芬豪页面获得,网址为www.sedarplus.ca

  • 2023年3月6日发布的卡莫阿-卡库拉2023综合开发方案技术报告,由OreWin Pty Ltd.、中国瑞林工程技术有限公司、DRA Global、Epoch Resources、Golder Associates Africa、Metso Outotec Oyj、Paterson and Cooke、SRK Consulting Ltd.以及The MSA Group编制。
  • 2022年2月14日发布的基普什2022可行性研究,由OreWin Pty Ltd.、MSA Group (Pty) Ltd.、SRK Consulting (South Africa) (Pty) Ltd. 和METC Engineering编制。
  • 2022年2月28日发布的普拉特瑞夫2022可行性研究,由OreWin Pty Ltd.、Mine Technical Services、SRK Consulting Inc. 、DRA Projects (Pty) Ltd 以及 Golder Associates Africa编制。

这些技术报告包括本新闻稿中引用的普拉特瑞夫项目、基普什项目和卡莫阿-卡库拉铜矿项目的矿产资源估算的生效日期、假设、参数和方法等信息,以及本新闻稿中关于普拉特瑞夫项目、基普什项目和卡莫阿-卡库拉铜矿项目的科学和技术性披露的数据验证、勘查程序和其他事项的信息。

联系方式

请即关注罗伯特·弗里兰德 (@robert_ivanhoe) 和艾芬豪矿业 (@IvanhoeMines_)的Twitter帐号。

投资者
温哥华﹕马修·基维尔 (Matthew Keevil),电话﹕+1.604.558.1034
伦敦﹕托米·霍顿 (Tommy Horton) ,电话﹕+44 7866 913 207

媒体
坦尼娅·托德 (Tanya Todd) ,电话﹕+1.604.331.9834

网址﹕www.ivanhoemines.com

前瞻性陈述

本新闻稿载有的某些陈述可能构成适用证券法所订议的"前瞻性陈述"或"前瞻性信息"。这些陈述及信息涉及已知和未知的风险、不确定性和其他因素,可能导致本公司的实际业绩、表现或成就、其项目或行业的业绩,与前瞻性陈述或信息所表达或暗示的任何未来业绩、表现或成就产生重大差异。这些陈述可通过文中使用"可能"、"将会"、"会"、"将要"、"打算"、"预期"、"相信"、"计划"、"预计"、"估计"、 "安排" 、"预测"、"预言"及其他类似用语,或者声明"可能"、"会"、"将会"、"可能会"或"将要"采取、发生或实现某些行动、事件或结果进行识别。这些陈述仅反映本公司于本新闻稿发布当日对于未来事件、表现和业绩的当前预期。

该等陈述包括但不限于下列事项的时间点和结果﹕(i) 关于卡莫阿-卡库拉预计 I 期和 II 期运营产生的现金流,以当前铜价计算,将足以支撑 III 期扩建所需的资本性开支的陈述;(ii) 关于卡莫阿-卡库拉提高铜回收率的初步试验取得可喜进展,从尾矿回收铜金属可提高回收率至90%以上,且试验分析结果显示,卡莫阿-卡库拉可以进一步提高产量、收入和现金流的陈述;(iii) 关于卡莫阿铜业一直与刚果(金)国有电力公司SNEL紧密合作,就刚果(金)南部电网出现的稳定性问题进行研究,找出供电问题的症结并协助制定长期解决方案,且卡莫阿铜业已制定一系列的升级改造计划以改善供电稳定性的陈述;(iv) 关于卡莫阿铜业的工程师正计划在矿山增加备用供电系统,确保卡莫阿-卡库拉项目未来的供电稳定性,同时正讨论引入赞比亚外部输电的陈述;(v) 关于卡莫阿-卡库拉矿山在未来12至18个月内将分阶段实施电力增容计划的陈述;(vi) 关于今年晚些时候将增加额外30兆瓦的备用电力,即使在电力中断的情况下,也能够满足卡莫阿-卡库拉项目 I 期和 II 期的总电力需求,预计于2024年第二季度投入运作的陈述;(vii) 关于已订购增容130兆瓦的备用电力系统,预计于2024年完成装机,以配合建设中的 III 期选厂和冶炼厂投产的陈述;(viii) 关于正讨论引入赞比亚外部输电,增加高达100兆瓦电力,预计于2023年第三季度完成首阶段工作的陈述;(ix) 关于III 期投产后,卡莫阿-卡库拉的综合设计产能将提高至1,420万吨/年的陈述;(x) 关于预计在前10年的年产铜将提升至约62万吨/年,将使卡莫阿铜业于2027年成为全球第三以及非洲最大铜矿山的陈述;(xi) 关于卡莫阿1区将于2023年底开始采矿,其后卡莫阿2区将于2025年开展,将采用与卡库拉矿山同样的机械化进路充填采矿法的陈述;(xii) 关于卡莫阿-卡库拉冶炼厂将采用芬兰美卓奥图泰公司的技术,按照国际金融公司制订的排放标准建造的陈述;(xiii) 关于预计冶炼厂于2023年12月将达到最高工作人数3,000名的陈述;(xiv) 关于卡莫阿-卡库拉冶炼厂生产的99.7%阳极铜预计将成为全球单位铜碳排放最低的产品之一的陈述;(xv) 关于冶炼厂的精矿处理能力达1,200万吨/年,将处理I 期和 II期来自卡库拉和III期及后续IV期来自卡莫阿选厂的精矿的陈述;(xvi) 关于卡莫阿-卡库拉 2023 综合开发方案显示,冶炼厂将处理卡莫阿-卡库拉约80%精矿的陈述;(xvii) 关于卡莫阿-卡库拉根据与卢阿拉巴铜冶炼厂签订的为期十年的协议,继续将部分精矿送往距离卡莫阿-卡库拉铜矿约50公里、靠近科卢韦齐镇的卢阿拉巴铜冶炼厂进行处理加工,预计每年处理约15万吨铜精矿的陈述;(xviii) 关于卡莫阿-卡库拉 III 期矿山及选厂扩建计划,以及位于矿山范围内、预计将成为非洲最大的50万吨/年一步炼铜冶炼厂的建设正如期推进,预计于2024年底完工,且施工期间从地表矿堆向选厂供矿以满足产量最大化的陈述;(xix) 关于卡莫阿-卡库拉冶炼厂每年将生产65万至80万吨浓硫酸副产品的陈述;(xx) 关于冶炼厂位于矿山范围内,为卡莫阿-卡库拉铜矿项目带来巨大的经济效益,显着降低物流成本,有助于降低粗炼费和当地税项,并可从副产品硫酸的销售中获得利益的陈述;(xxi) 关于 III 期投产后,由于含铜超过99%阳极粗铜出口的单位物流成本明显低于铜精矿,有助于将整体货运量减少一半以上,且卡莫阿-卡库拉 2023预可研显示,冶炼厂投产前5年 (从2025年起计) 将平均 C1 现金成本降低至约1.15美元/磅的陈述;(xxii) 关于英加二期水电站5号涡轮机组的升级改造,完成后将为国家电网增容178兆瓦清洁水电,可以满足 III 期选厂及一步炼铜冶炼厂的电力需求,并为日后扩建提供备用电能的陈述;(xxiii) 关于卡莫阿-卡库拉2023年的指导目标为精矿产铜39万至43万吨,C1现金本为1.40至1.50美元/磅的陈述;(xxiv) 关于公司正全力建设施工,推进普拉特瑞夫 I 期于2024年第三季度投产的陈述;(xxv) 关于待8月底破碎机和供矿机在950米中段完成装机后,预计今年剩余时间内的井下水平开拓速度将继续加快至约300米/月,且从2024年1月起,预计开拓速度将提升至约500米/月的陈述;(xxvi) 关于直径10米的2号竖井正在施工中,将具有800万吨/年的提升能力,将用于后续建设阶段,并将成为全球最大型的提升竖井之一的陈述;(xxvii) 关于吊桶和凿井卷扬机的土建工程即将完成,卷扬机将于2023年12月运抵现场的陈述;(xxviii) 关于普拉特瑞夫的5兆瓦光伏电厂预计于今年晚些时候投产,光伏发电将用于矿山开发和运营活动,且其后将引入其它可再生能源的陈述;(xxix) 关于施工中的3号竖井,原计划用作通风井及第二逃生井,现正计划配备提升设备,可从井下移除矿石和废石,有利于降低 I 期矿山建设和产量爬坡的风险,并可在 2 号竖井于2027年投产前加快 II 期井下开采作业产量爬坡的陈述;(xxx) 关于3号竖井正进行扩孔工程至直径5.1米,计划于2023年第四季度完工的陈述;(xxxi) 关于预计普拉特瑞夫 I 期生产的用水需求最高约300万公升/天,II 期扩建完工后将提高至900万公升/天的陈述;(xxxii) 关于Masodi废水处理厂施工进展顺利,将于2023年第三季度完工的陈述;(xxxiii) 关于预计基普什将会生产锌品位约55%的精矿,有害元素含量极低的陈述;(xxxiv) 关于包销商将以FCA方式购买基普什矿山的精矿,买方将负责由交货点至最终目的地的货运,有关费用由基普什进行报销的陈述;(xxxv) 关于基普什选厂将按计划于2024年第三季度投产的陈述;(xxxvi) 关于基普什选厂设施包括重介质分选以及一座选矿和浮选设施,预计在投产前5年将生产精矿含锌27万吨以上的陈述;(xxxvii) 关于基普什选厂设计回收率为96%,精矿锌品位55%的陈述;(xxxviii) 关于预计于2024年1月开采超高品位的大锌矿体的陈述;(xxxix) 关于基普什超过一半的主要采矿设备和辅助设备都已运抵现场,预计剩余的设备将于第三季度后期交付的陈述;(xl) 关于基普什项目正为新的地下矿工提供培训,目标是要在第三季度末全面部署4队采矿班组的陈述;(xli) 关于2023年至今的平均地下开拓速度约250米/月,其余的地下开拓设备和第4队采矿班组进场后,预计到年底将超过450米/月的陈述;(xlii) 关于本年度剩余时间基普什的地下开拓工程将逐步以矿石为主,锌品位20-25%,选厂投产前,矿石将被运送到地表矿石堆场的陈述;(xliii) 关于在基普什建设刚果(金)-赞比亚商业口岸,不仅可为基普什矿山带来优势,同时也为卡莫阿-卡库拉项目提供了出口精矿产品的额外通道,还将为基普什和卢本巴希的当地社区创造社会经济效益的陈述;(xliv) 关于基普什大锌矿体将采用横向分段的空场回采法进行一次和二次开采,使用混凝土进行回填以最大化开采超高品位矿石的陈述;(xlv) 关于基普什的深孔采场总高度为60米 (包括上层30米及下层30米),以15米高的底柱定位分隔,将从下至上进行开采,先开采下层采场,然后开采上层,使用深孔采矿法进行一次和二次开采的陈述;(xlvi) 关于预计上加丹加省即将签署建造11公里绕道的合同,承包商的工作团队将于下月进驻营地,且口岸基础设施的合同将于2023年底签署的陈述;(xlvii) 关于参与基普什项目建设的员工和承包商,预计2023年第四季度将达到最高人数2,000名,在矿山作业实现产量爬坡达到稳态产能后,预计现场的员工人数(包括采矿和服务承包商) 将达约1,200名的陈述;(xlviii) 关于在Makoko西区完成了4个钻孔,计划沿区段进行后续钻探,以提高该范围的三维地质解释质量的陈述;(xlix) 关于莫科菲德勘查项目由于设备故障导致延误,重力测量将于 2023 年第三季度进行,并计划于2023年第四季度开展金刚石深孔钻探,以测试磁力测量和重力测量结果圈定靶区的陈述;(l) 关于III 期扩建的剩余资本性开支约30亿美元,将会用于矿山、选厂、冶炼厂、基础设施和场外水电基础设施投资的陈述;(li) 关于艾芬豪与杰卡明及Glencore签署的包销和融资协议及相关细节 (包括艾芬豪矿业所占基普什项目的股权将减少至62%),与基普什的合资协议修订版预计将在未来数月同时落实,但尚需完成具有约束力的最终股东协议签署的陈述;(lii) 关于预计卡莫阿-卡库拉I 期和II 期运营将在2023年和2024年产生大量的现金流,以当前铜价计算,将足以支撑约21亿美元的资本性开支,且合资企业正安排短期融资贷款,避免万一铜价大跌时导致资金短缺的陈述;(liii) 关于公司2023年及2024年的资本性开支指导目标及计划资本性开支的陈述;(liv) 关于2023年的初步勘查预算为3,100万美元,包括西部前沿的勘查预算1,900万美元的陈述;(lv) 关于公司计划与 I-Pulse 的子公司 I-ROX 合作,携手研发脉冲功率技术在采矿领域应用的陈述;(lvi) 关于公司将于2023年第三季度发布西部前沿Makoko和Kiala高品位铜矿勘查区的首份矿产资源估算报告的陈述;以及 (lvii) 关于计划于2023年第三季度初使用第二台空气钻机在西部前沿开展空气钻的陈述。

此外,卡库拉铜矿可行性研究、卡莫阿-卡库拉2023综合开发方案、普拉特瑞夫2022 可行性研究以及基普什2022可行性研究的所有结果均构成了前瞻性陈述或信息,并包括内部收益率的未来估算、净现值,未来产量、现金成本估算、建议开采计划和方法、估计矿山服务年限、现金流预测、金属回收率、资本和运营成本估算,以及项目分期开发的规模和时间点。

另外,对于与卡莫阿-卡库拉铜矿、普拉特瑞夫及基普什项目、西部前沿勘查项目及莫科菲德勘查项目开发及勘查有关的特定前瞻性信息,公司是基于某些不确定因素而作出假设和分析。不确定因素包括:(i) 基础设施的充足性;(ii) 地质特征;(iii) 矿化的选冶特征;(iv) 发展充足选矿产能的能力;(v) 铜、镍、锌、铂金、钯、铑和黄金的价格;(vi) 完成开发及勘查所需的设备和设施的可用性;(vii) 消耗品和采矿及选矿设备的费用;(viii) 不可预见的技术和工程问题;(ix) 事故或破坏或恐怖主义行为;(x) 货币波动; (xi) 法例修订;(xii) 合资企业伙伴对协议条款的遵守情况;(xiii) 熟练劳工的人手和生产率;(xiv) 各政府机构对矿业的监管;(xv) 筹集足够资金以发展该等项目的能力;(xvi) 项目范围或设计更变;(xvii) 回收率、开采率和品位;(xviii) 政治因素;(xix) 矿山进水情况及对于开采作业的潜在影响;以及 (xx) 电源的稳定性和供应。

本新闻稿还载有矿产资源和矿产储量估算的参考信息。矿产资源估算未能确定,并涉及对许多有关因素的主观判断。矿产储量的估算提供了更多的确定性,但仍然涉及类似的主观判断。矿产资源不是矿产储量,不具有论证的经济潜力。任何该等估算的准确性是可用数据的数量和质量函数,并根据工程和地质诠释的假设和判断而作出 (包括公司项目的未来产量估算、预期开采的矿石量和品位,以及估计将实现的回收率),可能被证明是不可靠,在一定程度上取决于钻探结果和统计推论的分析,而最终可能证明是不准确的。矿产资源或矿产储量估算可能需要根据下列因素作出重新估算﹕(i) 铜、镍、锌、铂族元素、黄金或其他矿产价格的波动;(ii) 钻探结果;(iii) 选冶试验和其他研究的结果;(iv) 建议采矿作业,包括贫化;(v) 在矿山计划的任何估算及/或变更日期之后作出的矿山计划评估;(vi) 未能取得所需准许、批准和许可证的可能性;以及(vii) 法律或法规的修订。

前瞻性陈述及信息涉及重大风险和不确定性,故不应被视为对未来表现或业绩的保证,并且不能准确地指示能否达到该等业绩。许多因素可能导致实际业绩与前瞻性陈述或信息所讨论的业绩有重大差异,包括但不限于公司截至2023年6月30日止三个月及六个月的《管理层讨论与分析》和当前年度信息表中 “风险因素” 部分以及本新闻稿其他部分所指的因素,以及有关部门实施的法律、法规或规章或其不可预见的变化;与公司签订合约的各方没有根据协议履行合约;社会或劳资纠纷;商品价格的变动;以及勘查计划或研究未能达到预期结果或未能产生足以证明和支持继续勘查、研究、开发或运营的结果。

虽然本新闻稿载有的前瞻性陈述是基于公司管理层认为合理的假设而作出,但公司不能向投资者保证实际业绩会与前瞻性陈述的预期一致。这些前瞻性陈述仅是截至本新闻稿发布当日作出,而且受本警示声明明确限制。根据相应的证券法,公司并无义务更新或修改任何前瞻性陈述以反映本新闻稿发布当日后所发生的事件或情况。

基于公司截至2023年6月30日止三个月及六个月的《管理层讨论与分析》和当前年度信息表中 “风险因素” 所指的因素,公司的实际业绩可能与这些前瞻性陈述所预计的业绩产生重大差异。

Download in PDF Format

Subscribe to our Email List
