FORT LAUDERDALE, FLORIDA – Ivanhoe Mines (TSX: IVN; OTCQX: IVPAF) Co-Chair Robert Friedland announced today at the 31st BMO Global Metals & Mining Conference that the company’s South African subsidiary, Ivanplats, and its partners, welcome the outstanding positive findings of anindependent Platreef 2022 Feasibility Study for the tier-one Platreef palladium, rhodium, nickel, platinum, copper and gold project in South Africa.
The 2022 Feasibility Study provides the blueprint for the ongoing development of Platreef and builds on the excellent results of the preliminary economic assessment (PEA) for a phased-development scenario to expedite production, announced in November 2020, alongside the 2020 Feasibility Study. The Platreef 2022 Feasibility Study is based on a steady state production rate of 5.2 million tonnes per annum (Mtpa), as well as an accelerated ramp up to steady state through the earlier development of Shaft 2. The 2022 Feasibility Study is based on the detailed design and engineering scenario first presented in the 2020 PEA, confirming the viability of a new phased development pathway to fast-track Platreef into production by Q3 2024.
The Platreef 2022 Feasibility Study first phase of production includes an initial 700,000 tonnes per annum (700 ktpa) underground mine and 770-ktpa-capacity concentrator, targeting high-grade mining areas close to the project’s recently completed Shaft 1 (Figure 1).
Platreef’s Phase 2, 5.2-Mtpa steady state production rate would rank it as the world’s fifth largest primary platinum-group metals (PGM) mine on a palladium equivalent basis, with annual forecast production of more than 590,000 ounces of palladium, platinum, rhodium and gold, plus more than 40 million pounds of nickel and copper (Figure 8).
The Platreef 2022 Feasibility Study reflects the initial two phases of development for the Platreef Mine. Previous studies have demonstrated the resource base for future expansions up to 12 Mtpa, which would position Platreef among the very largest PGM producing mines in the world (Figure 8).
Watch a new video showcasing Platreef: https://vimeo.com/682603861/dce81b5e3a
Construction activities at the Platreef Project site, including Shaft 1 on the left, and the hitch-to-collar advancement for Shaft 2 on the right
Platreef poised to complete journey from tier-one discovery to one of the world's largest and lowest-cost PGM producers
The Platreef Project, which includes an underground deposit of thick, high-grade PGE-nickel-copper-gold mineralization discovered by Ivanhoe’s geologists, is in the northern limb of the Bushveld Complex approximately 11 kilometres from Mokopane, and 280 kilometres northeast of Johannesburg.
PGE-nickel-copper-gold mineralization in the northern limb is primarily hosted within the Platreef, a mineralized sequence which is traced more than 30 kilometres along strike. The Platreef Project is situated in the southern sector of the Platreef on two contiguous properties, Turfspruit and Macalacaskop, which comprise, in aggregate, approximately 7,842 hectares. The northernmost property, Turfspruit, is contiguous with and along strike from Anglo Platinum Limited’s Mogalakwena group of properties and mining operations.
Ivanplats acquired a prospecting permit for Macalacaskop and Turfspruit in February 1998. In 1999, Ivanhoe began a series of drilling campaigns, totalling more than 726,000 metres, to advance Platreef from a greenfield exploration project focused on shallow mineralized zones through to focusing on deeper underground targets. At the height of the drilling campaign, 30 diamond drill rigs were producing more than 10,000 metres of core a week.
Since 2007, Ivanplats has focused its Platreef exploration and development activities on defining and advancing the thick, high-grade, down-dip extension of its original discovery at Platreef, now known as the Flatreef Deposit. In 2012, the Merensky Reef analogue was recognized.
The Flatreef Deposit lies entirely on the Turfspruit and Macalacaskop properties that form part of Ivanhoe's mining right. The thickness of the mineralized reef (T1 & T2 mineralized zones) intersected in Shaft 1 is 29 metres, with average grab sample grade of 6.35 grams per tonne (g/t) platinum, palladium and rhodium plus gold (3PE+Au), ranging up to 9.6 g/t 3PE+Au, as well as significant quantities of nickel and copper. This thickness is exceptional when compared to the typical, approximately one-metre-thick reefs being mined elsewhere on South Africa's Bushveld Complex.
A Japanese consortium, led by Itochu and ITC Platinum, acquired a 10% interest in the Platreef Project in two tranches; the first 2% interest was acquired in September 2010 for US$10 million and the second 8% interest was acquired in June 2011 for US$280 million.
The thick, high-grade, flat-lying Flatreef deposit was discovered in 2010. Ivanplats conducted an exploration program with 30 drill rigs totalling over 260,000 metres in 2011. Platreef has excellent exploration upside for further expansion and discovery.
In June 2020, Ivanplats completed the sinking of Platreef's initial shaft, Shaft 1, to its final depth of 996 metres below surface. Shaft 1 is located approximately 450 metres away from a high-grade area of the Flatreef orebody, which will provide initial mining areas for Phase 1 production in 2024.
The thick Flatreef orebody also is flat-lying, which is ideal for safe, bulk-scale, mechanized mining and processes optimized for maximum ore extraction. Flatreef is characterized by its high-grade mineralization and a palladium-to-platinum ratio of approximately 1:1, which is considerably higher than other PGMs discoveries on the Northern Limb of the Bushveld.
Through phased development, Platreef is projected to become one of the world’s largest and lowest-cost producers of palladium, platinum, rhodium, nickel, copper and gold. The 2022 Feasibility Study considers Phase 1 and Phase 2 development, including only one third of Platreef’s Indicated Resources above an US$80/tonne Net Smelter Return (NSR) cut-off.
2022 Feasibility Study re-affirms outstanding economics of phased development at Platreef with an accelerated ramp up to 5.2 Mtpa
Mr. Friedland commented: “The Platreef discovery remains the world's greatest precious metals deposit under development, with a peerless endowment of palladium, rhodium, platinum, and gold; as well as highly significant quantities of strategic 'electric' metals such as nickel and copper. These outstanding economic results define our commitment to advance Platreef to first production, alongside our local communities and Japanese partners. We are counting down to less than 30 months from now. This achievement will only mark the first milestone, as we plan to expand this world-scale operation into one of the largest and lowest-cost, integrated PGM producers on the planet … all while generating outstanding returns on capital for a major, disruptive mine.
“PGMs have an integral role to play in the global transition to clean technologies, specifically the adoption of hydrogen energy systems; as well as the international push for lower emissions, which is led by developed economies … but let us not forget that emerging markets are catching up quickly … Platreef will be a responsible, industry leading, long-life supplier of palladium, rhodium, nickel, platinum, copper and gold … as well as a leading economic driver for South Africa. Ivanhoe Mines remains committed to 're-inventing mining' and will continue to leverage the most sustainable technologies available … as evidenced by our commitment to zero-emission, battery-powered equipment, and the adoption of the safest possible tailings method utilizing dry-stack technology, which has the added benefit of minimizing water consumption.
“Palladium and rhodium have reached all-time highs in recent years, currently trading at approximately $2,480 an ounce and $18,750 an ounce respectively, as progressively stricter air-quality rules increase demand for the metals used in vehicle pollution-control devices. Meanwhile, copper and nickel will continue to realize historic and sustained rallies due to underinvestment in new mine supply and massive growing demand tied to electric vehicles and global clean-energy initiatives.”
Platreef’s Indicated Mineral Resources contain an estimated 18.9 million ounces of palladium, 18.7 million ounces of platinum, 3.1 million ounces of gold, and 1.2 million ounces of rhodium (a combined 41.9 million ounces PGMs plus gold), plus 2.4 billion pounds of nickel and 1.2 billion pounds of copper, at a 2.0 g/t 3PE+Au cut-off.
Platreef’s Inferred Mineral Resources contain an additional 23.8 million ounces of palladium, 23.2 million ounces of platinum, 4.3 million ounces of gold, and 1.6 million ounces of rhodium (a combined 52.8 million ounces PGMs plus gold), plus 3.4 billion pounds of nickel and 1.78 billion pounds of copper, also at a 2.0 g/t 3PE+Au cut-off.
Mr. Friedland added: “The thick and flat-lying nature of the high-grade mineralization of the Flatreef deposit allows for the use of state-of-the-art, automated, electric mining machinery, including cutting-edge battery driven underground vehicles.
"For Ivanhoe Mines, achieving first production at Platreef will mark the next milestone in the journey to become a new-age, major diversified mining company ..... we intend to build on the achievements of the Kamoa-Kakula Copper Joint Venture in the Democratic Republic of Congo, and leverage the countless lessons we have learned during phased development at our tier-one copper asset … and let us not forget, Platreef still has vast potential to significantly expand the already enormous resource base … as well as a plethora of new nickel-sulphide exploration opportunities, many of which are near surface.”
Phase 1 construction underway, with first production expected in Q3 2024
Detailed engineering studies are underway on the initial 770-ktpa mine and concentrator, in parallel with the changeover of Shaft 1 into a production shaft, with expected completion in March 2022. First delivery of the initial battery-electric underground fleet is expected imminently, and the first blast on the 950-metre level is anticipated in April 2022. The initial underground development focus from Shaft 1 will be the on the first ventilation raise and ore passes connecting the 750-metre level to the 950-metre level.
Earthworks for the first concentrator are planned to begin in Q2 2022, followed by civil works and the ordering of long-lead-time items in H2 2022. First ore feed to the concentrator is planned for Q3 2024.
Phase 1 average annual production is estimated at 113,000 ounces (oz.) of platinum, palladium, rhodium and gold (3PE+Au), plus 5 million pounds of nickel and 3 million pounds of copper.

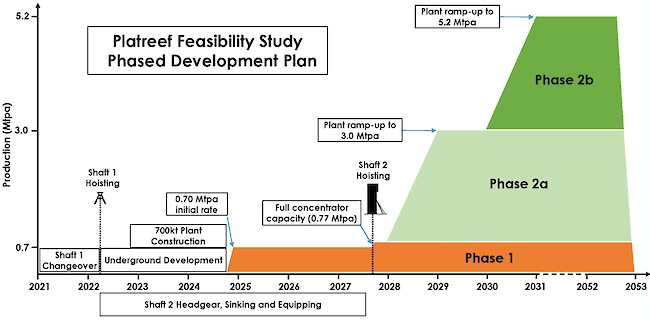

Figure 1: Production and timeline schematic of Platreef 2022 Feasibility Study.
William Mamashela (left) and William Mello, with local contractor Somuthwa Construction, assisting with construction of the Platreef Mine.
Shaft 2 commissioning accelerated to 2027, expediting Phase 2 expansion
While the 700-ktpa initial mine is operating using Shaft 1, the sinking of the project’s second, larger shaft (Shaft 2), that drives the Phase 2 expansion to 5.2 Mtpa, will progress at the same time. The 2022 Feasibility Study envisions Shaft 2 equipped for hoisting in 2027, an accelerated schedule by approximately 18 months compared to the 2020 PEA, coming online just over three years from first production of Phase 1.
Once Shaft 2 is complete, two 2.2-Mtpa concentrator modules will be commissioned, and the initial concentrator will be ramped up to its full capacity of 770-ktpa; increasing the steady-state production to 5.2 Mtpa (Figure 1).
The Phase 2 expansion would result in Platreef becoming the world’s fifth largest primary platinum-group metals (PGM) mine on a palladium equivalent basis, with annual forecast production of more than 590,000 ounces of palladium, rhodium, platinum, and gold, plus more than 40 million pounds of nickel and copper (Figure 6).
Construction at Shaft 2, which now is expected to be commissioned by 2027.
Platreef’s immense mineral endowment supports future expansions
The 2022 Feasibility Study considers Platreef’s Phase 1 and Phase 2 development, including only one third of the Indicated Resources above an US$80/tonne Net Smelter Return (NSR) cut-off. If the remainder of the Indicated Resources were to be converted to reserves, it would provide an opportunity to massively expand production.
As development of the project progresses, additional drilling from underground will be undertaken with the goal of increasing the confidence of the current mineral resources, as well as to expand the resource base. Additional studies will follow up on the previous work that envisaged further phased expansions based on updated reserves.

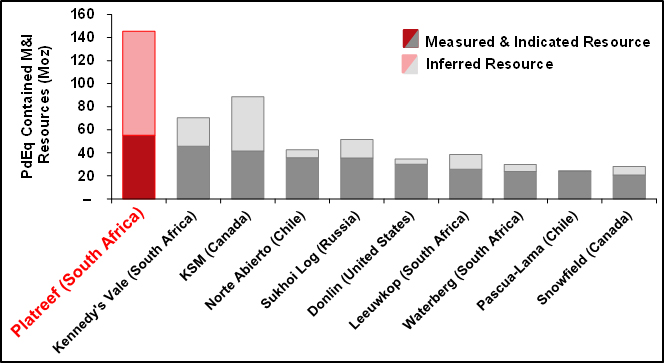

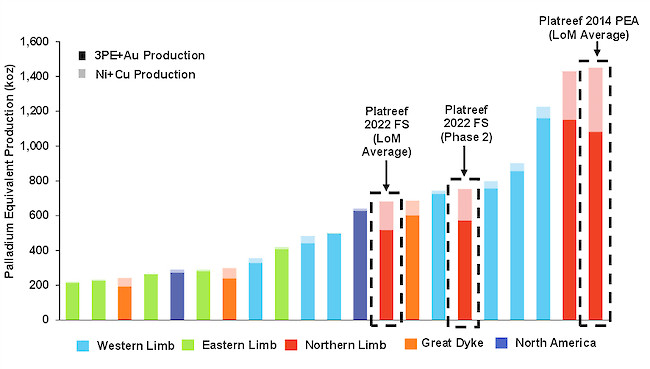

Figure 2: World’s largest precious metal deposits under development ranked by contained metal in Measured & Indicated Resources.
Source: Company filings, S&P Global Market Intelligence. Notes: Chart ranks the largest undeveloped primary palladium, platinum, gold, silver and rhodium projects from the S&P Global Market Intelligence database based on measured and indicated palladium equivalent resource. Palladium equivalent calculation includes palladium, platinum, gold, silver and rhodium ounces and has been calculated using spot price metal price assumptions (February 23, 2022) of US$1,095/oz platinum, US$2,480/oz palladium, US$18,750/oz rhodium, US$1,909/oz gold and US$24.55/oz silver. Measured and Indicated resources for Platreef correspond to palladium, platinum, gold and rhodium ounces at a 1 g/t cut-off grade.
Tshifhiwa Netshirando, Platreef’s Production Manager, is focused on equipping Shaft 1 for first production within just over two years.

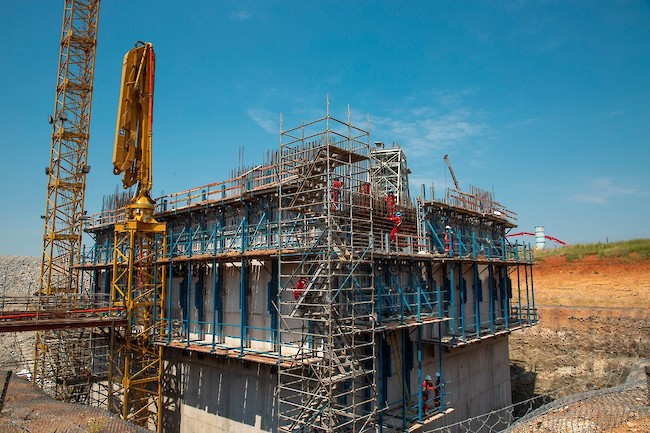

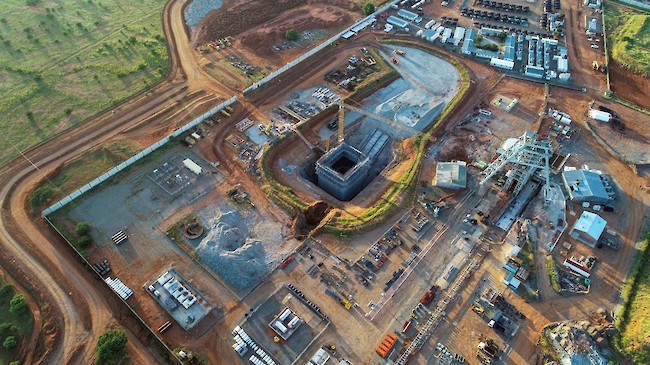

Aerial view from February 2022 of current construction at the Platreef site, including Shaft 1 (right) and progress at Shaft 2 (left).
Platreef will positively transform mining and community development in Limpopo Province
Ivanhoe Mines’ President, Marna Cloete, commented: “Ivanhoe Mines is excited to become a disruptive, cornerstone participant in the future of South Africa's platinum-group-metals mining industry. We have established a strong strategic foothold on the giant polymetallic Northern Limb of the renowned Bushveld Complex. We look forward to sharing the benefits of this truly unique orebody with our partners and local communities, as well as all the people of South Africa … Platreef represents an important, long-life economic driver for the nation, and we have only just begun to tap into the potential of this amazing discovery.
"We are pleased to be building the cutting-edge transformation in future underground platinum-group-metals mining operations in South Africa. We are charting a new path in the empowerment of the local people in Limpopo Province and in the training of women in the mining industry. We are focused on creating a vibrant local economy that’s not just going to be mining, as we are enabling entrepreneurs to create and expand a plethora of new businesses.
Dr. Patricia Makhesha, Ivanhoe’s Executive Vice President, Sustainability and Special Projects, added: “The agreement with the Mogalakwena Local Municipality to recycle wastewater is an important milestone in Platreef’s development. Recycling locally treated water is a cost-effective and sustainable approach to securing water for the Platreef Project.”
Ivanhoe Mines indirectly owns 64% of the Platreef Project through its subsidiary, Ivanplats, and is directing all mine development work. The South African beneficiaries of the approved broad-based, black economic empowerment structure have a 26% stake in the Platreef Project. The remaining 10% is owned by a Japanese consortium of ITOCHU Corporation; Japan Oil, Gas and Metals National Corporation; ITC Platinum Development Ltd., an ITOCHU affiliate; and Japan Gas Corporation.
The Platreef 2022 Feasibility Study was independently prepared by OreWin Pty Ltd. of Adelaide, Australia; Mine Technical Services of Reno, USA; SRK Consulting Inc. of Johannesburg, South Africa; DRA Global of Johannesburg, South Africa; and Golder Associates Africa of Midrand, South Africa.
A National Instrument 43-101 technical report will be filed on SEDAR at www.sedar.com and on the Ivanhoe Mines website at www.ivanhoemines.com within 45 days of the issuance of this news release.
Platreef’s thick mineralization, which will be mined with highly-productive mechanized methods, combined with higher nickel and copper grades, contribute to lower cash costs compared to other primary platinum-group-metal producers (Figures 7).Among global primary platinum-group-metals producers, Platreef’s estimated net total cash cost of US$514 per 3PE+Au ounce, net of copper and nickel by-product credits and including sustaining capital costs, ranks at the bottom of the cash-cost curve (Figure 7).

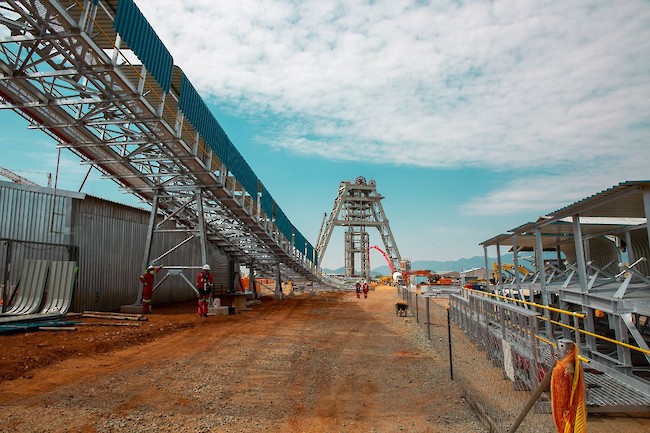

Construction of the Shaft 1 waste-rock conveyor system is progressing in advance of the start of underground mining operations.
Thapelo Kadi, Senior Manager for Safety Legal and Compliance, fosters a safety culture that strives toward Platreef’s vision of zero harm.

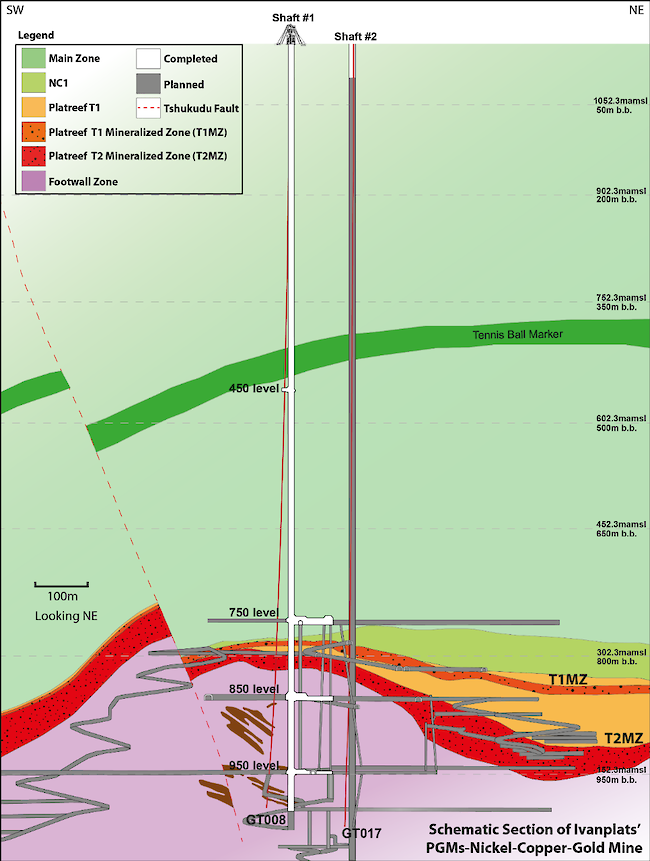

Figure 3: Schematic section of the Platreef Mine, showing Flatreef’s thick, high-grade T1 and T2 mineralized zones (dark orange and red), underground development work completed to date in shafts 1 and 2 (white) and planned development work (grey).
Members of Ivanplat’s underground mining team advancing the world-scale Platreef Mine toward first production in 2024.
Alfred Masimine, Bell Operator (left), and Malesela Magongoa, Sinker, underground at the 950-level station discussing the installation of the loading box at shaft bottom.

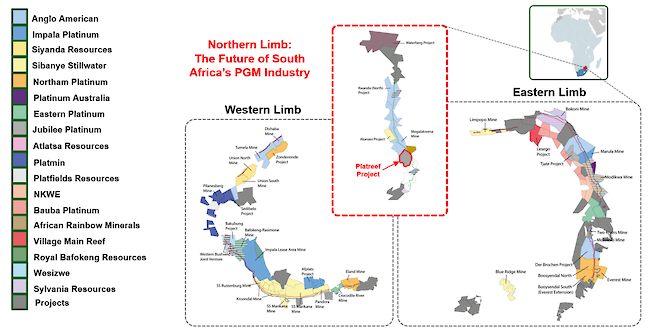

Figure 4: Map of South Africa’s Bushveld Igneous Complex.
Source: SFA (Oxford).

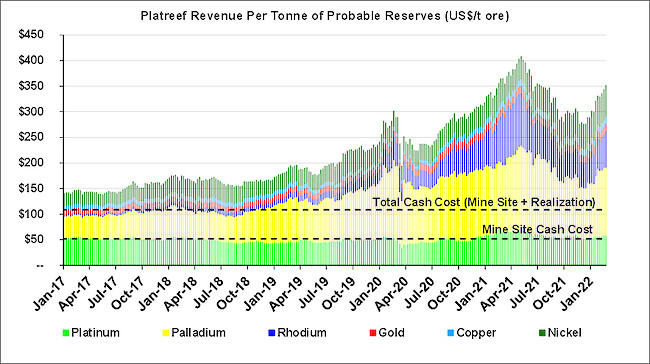

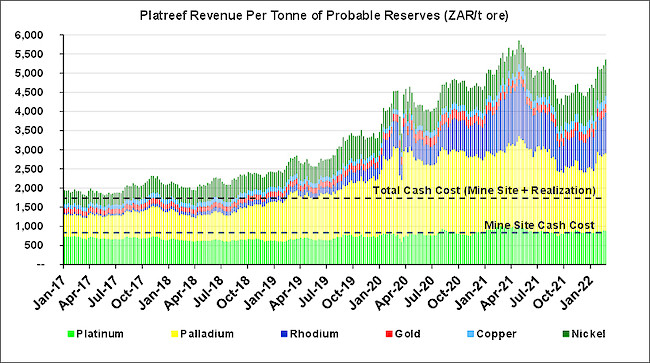

Figure 5: Revenue per tonne of ore at the Platreef Project since 2017 (shown in US dollars).
Figure 6: Revenue per tonne of ore at the Platreef Project has risen significantly since 2017 (shown in South African rand).
Source for figures 5 and 6: Bloomberg. Based on historical weekly commodity prices at the end of each week.
Notes for figures 5 and 6:
- Based on Platreef Mineral Reserves with an effective date of January 26, 2022.
- Probable Mineral Reserve of 124.7 million tonnes at a grade of 1.95 grams per tonne (g/t) platinum, 2.01 g/t palladium, 0.30 g/t gold, 0.14 g/t rhodium, 0.34% nickel and 0.17% copper.
- A declining Net Smelter Return (NSR) cut-off of $155 per tonne (t) to $80/t was used for the Mineral Reserve estimates.
- The NSR cut-off is an elevated cut-off above the marginal economic cut-off.
- Metal prices used in the Mineral Reserve estimate: US$1,600 per ounce (oz.) platinum, US$815/oz. palladium, US$1,300/oz. gold, US$1,500/oz. rhodium, US$8.90 per pound (lb) nickel and US$3.00/lb copper.
- Tonnage and grade estimates include dilution and mining recovery allowances.
- Applies life-of-mine average recoveries of 87.4% for platinum, 86.9% for palladium, 78.6% for gold, 80.5% for rhodium, 87.9% for copper and 71.9% for nickel.
- Total cash cost includes mine site costs, plus realization costs such as treatment and refining charges, royalties and transportation.

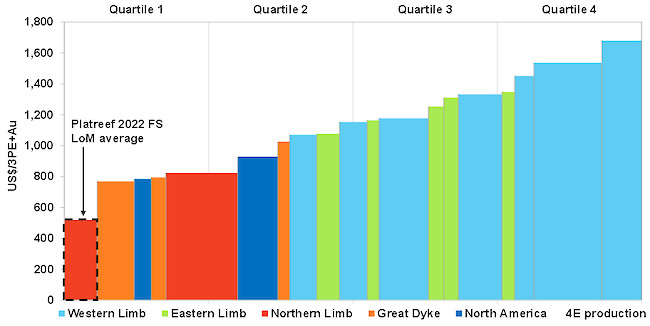

Figure 7: Global primary producers’ net total cash cost + sustaining capital (2021E), US$/3PE+Au oz.
Source: SFA (Oxford), Ivanplats. Notes: Cost and production data for the Platreef project is based on the Platreef Feasibility Study parameters, applying payabilities and smelting and refining charges as agreed with purchase of concentrate partners for Platreef concentrate (this is not representative of SFA’s standard methodology). SFA’s peer group cost and production data follows a methodology to provide a level playing field for smelting and refining costs on a pro-rata basis from the producer processing entity. Net total cash costs have been calculated using Ivanplats' long term price assumptions of 16:1 ZAR:USD, US$1,100/oz platinum, US$1,450/oz palladium, US$5,000/oz rhodium, US$1,600/oz gold, US$8.00/lb nickel and US$3.50/lb copper.
Figure 8: Ranking of selected global primary PGM producers, based on 2021E palladium equivalent production
Source: SFA (Oxford), Ivanplats. Notes: Chart excludes by-product PGM producers. Nornickel (by-product PGM producer) is the largest producer on a palladium equivalent basis. Cost and production data for the Platreef project is based on the Platreef 2022 FEASIBILITY STUDY and 2014 PEA parameters. Production data for the peer group is provided by SFA (Oxford). Equivalent palladium production has been calculated using Ivanplats' long term price assumptions of 16:1 ZAR:USD, US$1,100/oz platinum, US$1,450/oz palladium, US$5,000/oz rhodium, US$1,600/oz gold, US$8.00/lb nickel and US$3.50/lb copper.
2022 FEASIBILITY STUDY HIGHLIGHTS
Phased development plan targets first production from Phase 1 in Q3 2024, and accelerated Phase 2 expansion to realize potential of Platreef orebody
- The Platreef 2022 Feasibility Study evaluates the phased development of Platreef, with an initial 700-ktpa underground mine and a 770-ktpa capacity concentrator, targeting high-grade mining areas close to Shaft 1, with an initial capital cost of US$488 million.
- First concentrate production for Phase 1 is planned for Q3 2024, with the Phase 2 expansion based on the commissioning of Shaft 2 in 2027, followed by the commissioning of two 2.2-Mtpa concentrators in 2028 and 2029. This would increase the steady-state production to 5.2 Mtpa by using Shaft 2 as the primary production shaft.
- Expansion capital cost for Phase 2 is estimated at US$1.5 billion, which may be partially funded by cash flows from Phase 1 and a project financing package.
- Ivanplats’ dedicated engineering teams and leading consultants are evaluating optimizations to the sinking methodology for Shaft 2 to further accelerate the availability of the shaft for hoisting, which may accelerate the overall development timeline.
- Phase 1 average annual production of 113,000 ounces (oz.) of platinum, palladium, rhodium and gold (3PE+Au), plus 5 million pounds of nickel and 3 million pounds of copper.
- Phase 2 average annual production of591,000 oz. of 3PE+Au, plus 26 million pounds of nickel and 16 million pounds of copper, which would rank Platreef as the fifth largest primary PGM producer on a palladium equivalent basis (Figure 8)
- Life-of-mine cash cost of US$514 per ounce of 3PE+Au, net of by-products, and including sustaining capital costs would rank Platreef as the lowest cost primary PGM producer (Figure 7)
- After-tax net present value at an 8% discount rate (NPV8%) of US$1.7 billion and an internal rate of return (IRR) of 18.5%, based on long-term consensus prices.
- At spot prices as at February 23, 2022, the after-tax NPV8% increases to US$4.1 billion and the IRR increases to 29.3%.
- Shaft 1 equipping and changeover to hoisting is nearing completion, expected by end of March 2022, together with the arrival of initial battery electric underground mining fleet.
- In parallel with the changeover of Shaft 1 for permanent hoisting, detailed engineering and certain optimization initiatives are underway on the mine design, 770-ktpa concentrator and associated infrastructure design, which also will include the dry stack tailings storage facility. In addition, amendments to the water use licence, waste licence and environmental impact assessment required for the phased development plan have been lodged.
- Following the completion of the changeover of Shaft 1, off-shaft development will start in April 2022 with the initial aim of enabling construction of the first ventilation raise.
- With the focus shifting to execution, appointment and onboarding of earthworks contractors is the next short-term milestone for surface work, while detailed design across the project ramps up.

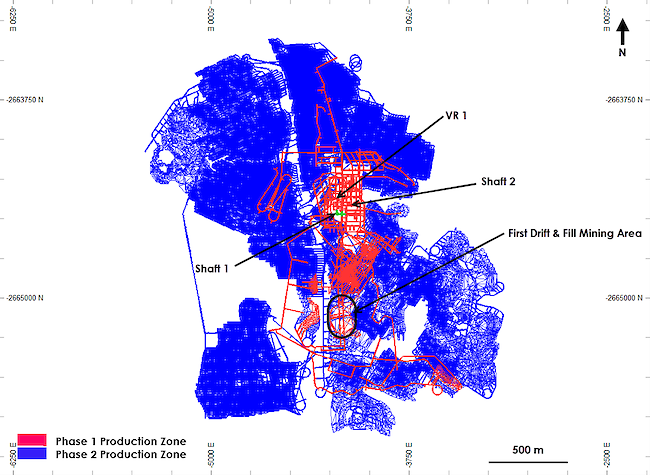

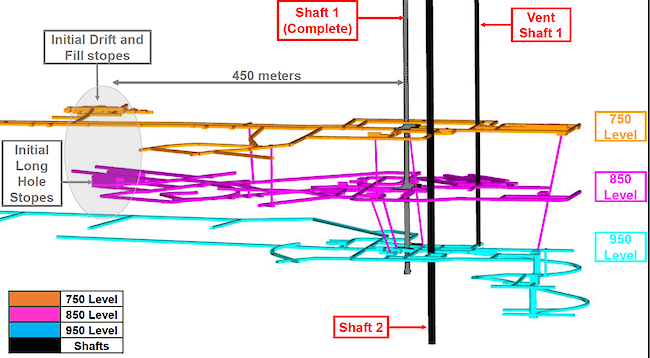

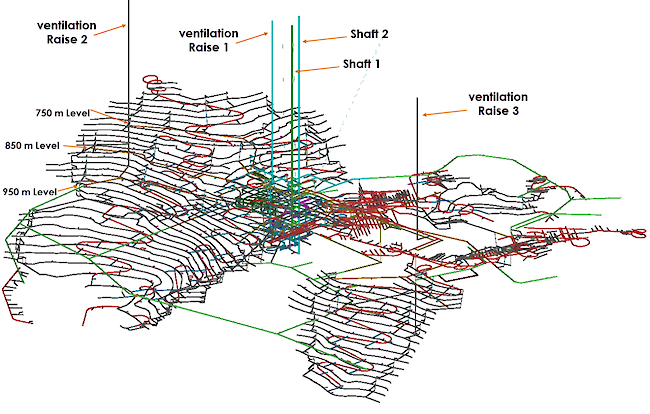

Figure 9: Plan of the Platreef 2022 Feasibility Study mine design, highlighting areas that are mined during Phase 1 (700-ktpa) and Phase 2 (5.2 Mtpa).
Figure by OreWin, 2022.
KEY INITIAL RESULTS FROM THE PLATREEF 2022 FEASIBILITY STUDY
Table 1: Summary of key results of the Platreef 2022 Feasibility Study.

Item | Units | Total / Average Life of Mine |
---|---|---|
Mined and processed |
|
|
Material Milled | Million tonnes | 125 |
Platinum | g/t | 1.94 |
Palladium | g/t | 1.99 |
Gold | g/t | 0.30 |
Rhodium | g/t | 0.13 |
3PE+Au | g/t | 4.37 |
Copper | % | 0.16 |
Nickel | % | 0.34 |
Peak Production (Year 8) |
|
|
3PE+Au | koz | 697 |
Nickel | kt | 13 |
Copper | kt | 8 |
Key financial results |
| |
Life of mine | Years | 28.3 |
Initial capital | US$ million | 488 |
Expansion capital | US$ million | 1,480 |
Peak capital | US$ million | 1,364 |
Mine-site cash cost | US$ per ounce 3PE+Au | 429 |
Total cash cost after credits | US$ per ounce 3PE+Au | 452 |
All-in cash cost after credits | US$ per ounce 3PE+Au | 514 |
Mine-site operating costs | US$ per tonne milled | 52 |
After-tax NPV8% | US$ million | 1,690 |
After-tax IRR | % | 18.5 |
Project payback period | years | 7.9 |
Notes:
- 3PE+Au = platinum, palladium, rhodium and gold.
- Long-term metal price assumptions for economic analysis are as follows: US$1,100/oz. platinum, US$1,450/oz. palladium, US$1,600/oz. gold, US$5,000/oz. rhodium, US$8.00/lb nickel and US$3.50/lb copper.
- All-in cash costs include sustaining capital costs.
Khazamola Baloyi, Government Relations Manager, at the Platreef site office.
Sample of the high-grade palladium-platinum-rhodium-nickel-copper-gold ore.

Table 2: Platreef 2022 Feasibility Study financial results at base case and spot prices.
Discount Rate | Base Case Prices (1) | Spot Prices (2) | |
---|---|---|---|
Net present value (NPV) | Undiscounted | 8,543 | 17,130 |
(US$ million, after tax) | 5.0% | 3,098 | 6,815 |
8.0% | 1,690 | 4,116 | |
| 10.0% | 1,104 | 2,979 |
| 12.0% | 692 | 2,169 |
Internal rate of return (IRR) |
| 18.5% | 29.3% |
Project payback period | (Years) | 7.9 | 6.4 |
Exchange rate | (ZAR: USD) | 16:1 |
- Base case metal price assumptions are as follows: US$1,100/oz. platinum, US$1,450/oz. palladium, US$1,600/oz. gold, US$5,000/oz. rhodium, US$8.00/lb nickel and US$3.50/lb copper.
- Spot metal prices as at February 23, 2022 are as follows: US$1,095/oz. platinum, US$2,480/oz. palladium, US$1,909/oz. gold, US$18,750 /oz. rhodium, US$11.31/lb nickel and US$4.48/lb copper.
Table 3: Platreef 2022 Feasibility Study average mine production and processing statistics.

Item | Units | Phase 1 Average (1) | Phase 2 Average (2) | LOM Average |
---|---|---|---|---|
Production | Mtpa | 0.7 | 4.9 | 4.4 |
Platinum | g/t | 2.53 | 1.93 | 1.94 |
Palladium | g/t | 2.54 | 1.98 | 1.99 |
Gold | g/t | 0.38 | 0.30 | 0.30 |
Rhodium | g/t | 0.17 | 0.13 | 0.13 |
3PE+Au(2) | g/t | 5.63 | 4.34 | 4.37 |
Copper | % | 0.19 | 0.16 | 0.16 |
Nickel | % | 0.40 | 0.34 | 0.34 |
Recoveries |
|
|
|
|
Platinum | % | 90.4 | 87.2 | 87.2 |
Palladium | % | 90.2 | 86.7 | 86.8 |
Gold | % | 80.4 | 78.5 | 78.5 |
Rhodium | % | 84.4 | 80.2 | 80.3 |
3PE+Au(2) | % | 89.4 | 86.0 | 86.2 |
Copper | % | 90.0 | 87.6 | 87.7 |
Nickel | % | 77.5 | 71.4 | 71.6 |
Concentrate produced | kt/a (dry) | 34.9 | 216.2 | 195.7 |
Platinum | g/t | 38.1 | 38.2 | 38.2 |
Palladium | g/t | 38.1 | 39.0 | 39.0 |
Gold | g/t | 5.1 | 5.3 | 5.3 |
Rhodium | g/t | 2.4 | 2.4 | 2.4 |
3PE + Au (3) | g/t | 83.8 | 85.0 | 85.0 |
Copper | % | 2.8 | 3.3 | 3.3 |
Nickel | % | 5.1 | 5.4 | 5.4 |
Recovered metal |
|
|
|
|
Platinum | koz/a | 51 | 266 | 240 |
Palladium | koz/a | 51 | 271 | 245 |
Gold | koz/a | 7 | 37 | 33 |
Rhodium | koz/a | 3 | 17 | 15 |
3PE + Au(2) | koz/a | 113 | 591 | 535 |
Copper | Mlb/a | 3 | 16 | 14 |
Nickel | Mlb/a | 5 | 26 | 23 |
- Phase 1 production over 3.3 years from 2024 to 2027 at 0.7 Mtpa.
- Phase 2 production over 25.0 years from 2028 to 2052 at 5.2 Mtpa.
- 3PE+Au is the sum of the grades for and production of platinum, palladium, rhodium and gold.

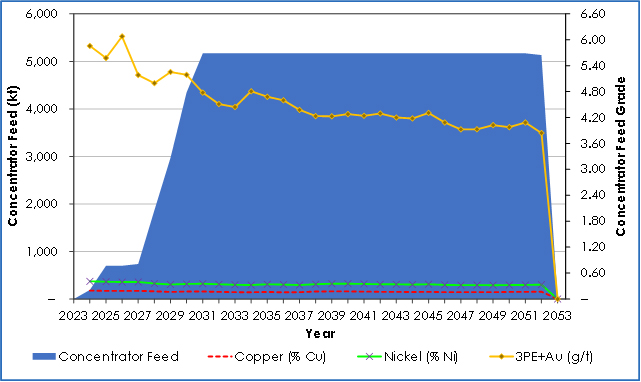

Figure 10: Platreef 2022 Feasibility Study concentrator production (tonnes milled and grades for the life-of-mine).
Figure by OreWin, 2022.

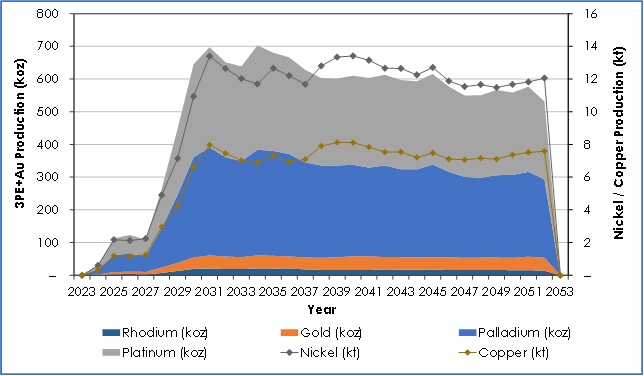

Figure 11: Platreef 2022 Feasibility Study estimated 3PE+Au recovered metal and nickel/copper recovered metal for the life-of-mine.
Figure by OreWin, 2022.

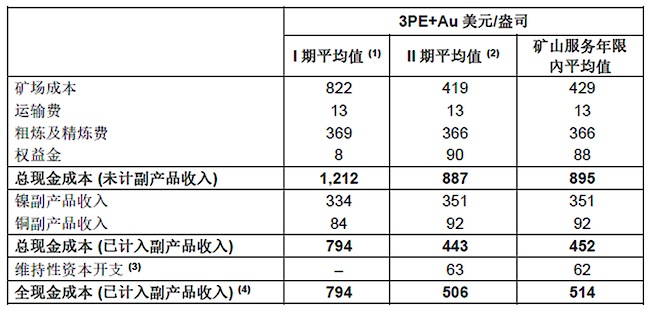

Table 4: Platreef 2022 Feasibility Study unit operating costs and cash costs after credits.
US$ per ounce of 3PE+Au | |||
---|---|---|---|
Phase 1 Average (1) | Phase 2 Average (2) | LOM Average | |
Mine site | 822 | 419 | 429 |
Transport | 13 | 13 | 13 |
Treatment & Refining | 369 | 366 | 366 |
Royalties | 8 | 90 | 88 |
Total cash costs before credits | 1,212 | 887 | 895 |
Nickel credits | 334 | 351 | 351 |
Copper credits | 84 | 92 | 92 |
Total cash costs after credits | 794 | 443 | 452 |
Sustaining capital costs (3) | – | 63 | 62 |
All-in cash costs after credits (4) | 794 | 506 | 514 |
- Phase 1 production over 3.3 years from 2024 to 2027 at 0.7 Mtpa.
- Phase 2 production over 25.0 years from 2028 to 2052 at 5.2 Mtpa.
- Phase 1 operating costs include allowance for sustaining capital costs.
- All-in cash costs include sustaining capital costs.

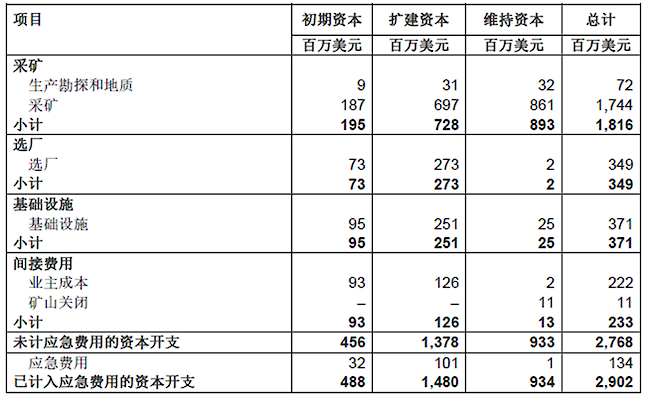

Table 5: Platreef 2022 Feasibility Study capital investment summary.
Description | Initial Capital | Expansion Capital | Sustaining Capital | Total |
---|---|---|---|---|
| US$M | US$M | US$M | US$M |
MINING |
|
|
|
|
Exploration and geology | 9 | 31 | 32 | 72 |
Mining | 187 | 697 | 861 | 1,744 |
Subtotal | 195 | 728 | 893 | 1,816 |
CONCENTRATOR |
|
|
|
|
Concentrator | 73 | 273 | 2 | 349 |
Subtotal | 73 | 273 | 2 | 349 |
INFRASTRUCTURE |
|
|
|
|
Infrastructure | 95 | 251 | 25 | 371 |
Subtotal | 95 | 251 | 25 | 371 |
INDIRECTS |
|
|
|
|
Owners Cost | 93 | 126 | 2 | 222 |
Closure | – | – | 11 | 11 |
Subtotal | 93 | 126 | 13 | 233 |
CAPITAL EXPENDITURE BEFORE CONTINGENCY | 456 | 1,378 | 933 | 2,768 |
Contingency | 32 | 101 | 1 | 134 |
CAPITAL EXPENDITURE AFTER CONTINGENCY | 488 | 1,480 | 934 | 2,902 |
Note: Initial capital reflects the capital costs from January 1, 2022, to achieve initial production of 0.7 Mtpa, followed by expansion capital to reflect the capital costs to achieve full production of 5.2 Mtpa. Expansion capital includes US$50 million spent during the Phase 1 pre-production period to continue construction on Shaft 2.

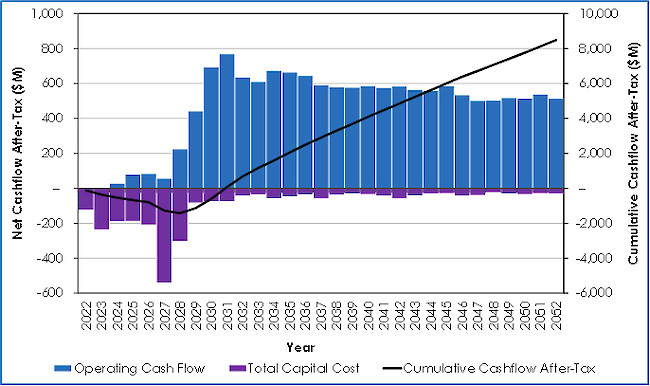

Figure 12: Platreef Mine 2022 Feasibility Study projected operating surplus, total capital costs and cumulative net cash flow after tax, at base case assumptions.
Figure by OreWin, 2022.
Platreef Mineral Resources
The mineral resources used in the Feasibility Study were those amenable to underground selective mining.

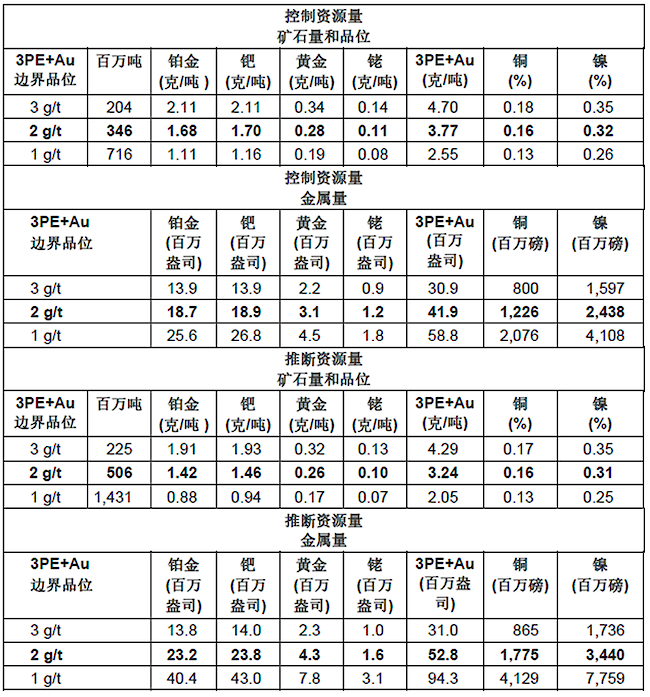

Table 6: Mineral Resources amenable to underground selective mining methods (base case is highlighted).
Indicated Mineral Resources | ||||||||
---|---|---|---|---|---|---|---|---|
Cut-off | Mt | Pt | Pd | Au | Rh | 3PE+Au | Cu | Ni |
3 g/t | 204 | 2.11 | 2.11 | 0.34 | 0.14 | 4.70 | 0.18 | 0.35 |
2 g/t | 346 | 1.68 | 1.70 | 0.28 | 0.11 | 3.77 | 0.16 | 0.32 |
1 g/t | 716 | 1.11 | 1.16 | 0.19 | 0.08 | 2.55 | 0.13 | 0.26 |
Indicated Mineral Resources | ||||||||
Cut-off | Pt | Pd | Au | Rh | 3PE+Au | Cu | Ni | |
3 g/t | 13.9 | 13.9 | 2.2 | 0.9 | 30.9 | 800 | 1,597 | |
2 g/t | 18.7 | 18.9 | 3.1 | 1.2 | 41.9 | 1,226 | 2,438 | |
1 g/t | 25.6 | 26.8 | 4.5 | 1.8 | 58.8 | 2,076 | 4,108 | |
Inferred Mineral Resources | ||||||||
Cut-off | Mt | Pt | Pd | Au | Rh | 3PE+Au | Cu | Ni |
3 g/t | 225 | 1.91 | 1.93 | 0.32 | 0.13 | 4.29 | 0.17 | 0.35 |
2 g/t | 506 | 1.42 | 1.46 | 0.26 | 0.10 | 3.24 | 0.16 | 0.31 |
1 g/t | 1,431 | 0.88 | 0.94 | 0.17 | 0.07 | 2.05 | 0.13 | 0.25 |
Inferred Mineral Resources | ||||||||
Cut-off | Pt | Pd | Au | Rh | 3PE+Au | Cu | Ni | |
3 g/t | 13.8 | 14.0 | 2.3 | 1.0 | 31.0 | 865 | 1,736 | |
2 g/t | 23.2 | 23.8 | 4.3 | 1.6 | 52.8 | 1,775 | 3,440 | |
1 g/t | 40.4 | 43.0 | 7.8 | 3.1 | 94.3 | 4,129 | 7,759 |
- Mineral Resources were estimated and finalized April 22, 2016. On 28 January 2022, updated criteria for assessing reasonable prospects of eventual extraction were reviewed to ensure the estimate remained current. The updated effective date is 28 January 2022. The Qualified Person for the estimate is Mr. Timothy Kuhl, RM SME.
- Mineral Resources are reported inclusive of Mineral Reserves. Mineral Resources that are not Mineral Reserves do not have demonstrated economic viability.
- The 2 g/t 3PE+Au cut-off is considered the base-case estimate and is highlighted. The rows are not additive.
- Mineral Resources are reported on a 100% basis. Mineral Resources are stated from approximately -200 m to 650 m elevation (from 500 m to 1,350 m depth). Indicated Mineral Resources are drilled on approximately 100 x 100 m spacing; Inferred Mineral Resources are drilled on 400 x 400 m (locally to 400 x 200 m and 200 x 200 m) spacing.
- Reasonable prospects for eventual economic extraction were determined using the following assumptions. Assumed commodity prices are US$1,600/oz. platinum, US$815/oz. palladium, US$1,300/oz. gold, US$1,500/oz. rhodium, US$3.00/lb copper, and US$8.90/lb nickel. It has been assumed that payable metals would be 82% from smelter/refinery and that mining costs (average US$34.27/t) and process, general and administrative costs, and concentrate transport costs (average US$15.83/t of mill feed for a four-Mtpa operation) would be covered. The processing recoveries vary with block grade but typically would be 80%-90% for platinum, palladium and rhodium; 70-90% for gold; 60-90% for copper; and 65-75% for nickel.
- 3PE+Au = platinum, palladium, rhodium and gold.
- Totals may not sum due to rounding.
Platreef 2020 Feasibility Study Mineral Reserve
The mineral resources used as the basis of the Feasibility Study were those amenable to underground selective mining.

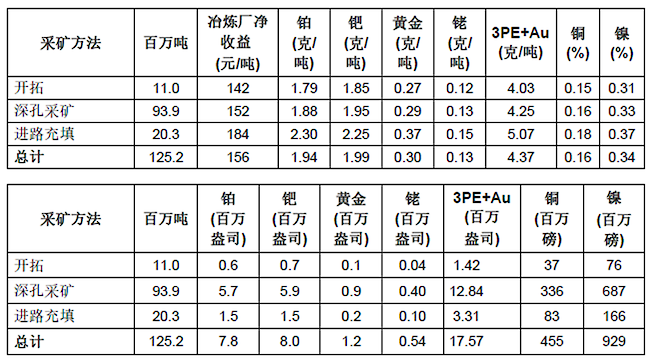

Table 7: Probable Mineral Reserves – tonnage and grades as at January 26, 2022.
Method | Mt | NSR | Pt | Pd | Au | Rh | 3PE+Au | Cu | Ni |
---|---|---|---|---|---|---|---|---|---|
Ore development | 11.0 | 142 | 1.79 | 1.85 | 0.27 | 0.12 | 4.03 | 0.15 | 0.31 |
Long-hole | 93.9 | 152 | 1.88 | 1.95 | 0.29 | 0.13 | 4.25 | 0.16 | 0.33 |
Drift-and-fill | 20.3 | 184 | 2.30 | 2.25 | 0.37 | 0.15 | 5.07 | 0.18 | 0.37 |
Total | 125.2 | 156 | 1.94 | 1.99 | 0.30 | 0.13 | 4.37 | 0.16 | 0.34 |
Method | Mt | Pt | Pd | Au | Rh | 3PE+Au | Cu | Ni |
---|---|---|---|---|---|---|---|---|
Ore development | 11.0 | 0.6 | 0.7 | 0.1 | 0.04 | 1.42 | 37 | 76 |
Long-hole | 93.9 | 5.7 | 5.9 | 0.9 | 0.40 | 12.84 | 336 | 687 |
Drift-and-fill | 20.3 | 1.5 | 1.5 | 0.2 | 0.10 | 3.31 | 83 | 166 |
Total | 125.2 | 7.8 | 8.0 | 1.2 | 0.54 | 17.57 | 455 | 929 |
- Mineral Reserves have an effective date of January 26, 2022. The Qualified Person for the estimate is Curtis Smith (OreWin), MAusIMM (CP).
- A declining NSR cut-off of US$155/t to US$80/t was used for the Mineral Reserve estimates.
- The NSR cut-off is an elevated cut-off above the marginal economic cut-off.
- Metal prices used in the Mineral Reserve estimate are as follows: US$1,600/oz. platinum, US$815/oz. palladium, US$1,300/oz. gold, US$1,500/oz. rhodium, US$8.90/lb nickel and US$3.00/lb copper.
- Metal-price assumptions used for the Feasibility Study economic analysis are as follows: US$1,100/oz. platinum, US$1,450/oz. palladium, US$1,600/oz. gold, US$5,000/oz. rhodium, US$8.00/lb nickel and US$3.50/lb copper.
- Tonnage and grade estimates include dilution and mining recovery allowances.
- Total may not add due to rounding.
- 3PE+Au = platinum, palladium, rhodium and gold.
Platreef to be mined primarily using highly productive mechanized methods
Mining zones in the current Platreef mine plan occur at depths ranging from approximately 700 metres to 1,200 metres below surface. Mining will be performed using highly productive mechanized methods, including long-hole stoping and drift-and-fill. Each method will utilize cemented backfill for maximum ore extraction.
Figure 13 shows the proposed shaft and ventilation raise locations, and the main access levels in an elevated view (looking north-east). Mining access ramps will connect the haulage levels with the mining sublevels and other infrastructure. The mining sublevels will be developed from the ramps at regular vertical intervals in the production areas. Drilling and extraction levels for stopes will be driven from the sublevels.
Figure 13: Platreef underground mine access layout.
Figure by OreWin, 2022.
Following the completion of the changeover of Shaft 1, off-shaft development would start in April 2022 with the initial aim of enabling construction of the critical ventilation shaft 1 (Figure 14). This ventilation shaft not only enables future development of underground infrastructure but is planned to be the secondary means of egress from the mine until Shaft 2 is complete. Once Phase 1 ore production commences in Q3 2024, mining will focus on the higher-grade area approximately 450 metres from Shaft 1 (Figure 14), requiring less underground infrastructure to access.
Figure 14: Underground mine layout of initial development.
Figure by Ivanhoe, 2022.
During Phase 2, primary access to the mine will be by way of a 1,104-metre-deep, 10-metre-diameter production shaft (Shaft 2). Secondary access to the mine will be via the 996-metre-deep, 7.25-metre-diameter ventilation shaft (Shaft 1). During mine production, both shafts also will serve as ventilation intakes. During Phase 2, ore will be hauled from the stopes to a series of internal ore passes and fed to the bottom of Shaft 2, where it will be crushed and hoisted to surface.
Conventional metallurgical flowsheet for Phase 1 and 2
Metallurgical testwork has focused on maximizing recovery of platinum-group elements (PGE) and base metals (mainly nickel) while producing an acceptably high-grade concentrate suitable for further processing and/or sale to a third party. The three main geo-metallurgical units and composites tested produced smelter-grade final concentrates averaging 85 g/t PGE+Au, at acceptable PGE recoveries. Testwork also has shown that the material is amenable to treatment by conventional flotation without the need for mainstream or concentrate re-grinding. Extensive bench-scale testwork comprising of open-circuit and locked-cycled flotation testing, comminution testing, mineralogical characterization, tailings dewatering, and rheological characterization was performed at Mintek of South Africa, an internationally accredited metallurgical testing facility and laboratory.
Comminution and flotation testwork have indicated that the optimum grind for beneficiation is 80% passing 75 micrometres. Platreef ore is classified as being “hard” to “very hard”, and thus not suitable for semi-autogenous grinding; a multi-stage crushing and ball-milling circuit has been selected as the preferred size reduction method.
Improved flotation performance has been achieved using high-chrome grinding media, as opposed to carbon steel media. The inclusion of a split-cleaner flotation circuit configuration, in which the fast-floating fraction is treated in a cleaner circuit separate from the medium- and slow-floating fractions, resulted in improved PGE, copper and nickel recoveries and concentrate grades.
A phased development approach was adopted for the flow-sheet design in the 2022 Feasibility Study. Phase 1 comprises a stand-alone concentrator with a design capacity of 770 ktpa. Phase 2 comprises an additional two 2.2-Mtpa modules, which will be constructed sequentially to meet the mine ramp-up schedule.
Both Phase 1 and Phase 2 flowsheets incorporate a three-stage crushing circuit, feeding crushed material to the milling and flotation modules. Flotation is followed by concentrate thickening, concentrate filtration, tailings handling and tailings disposal facility. It is expected that plant performance over life-of-mine will achieve 3PGE+Au recovery of 86% at a concentrate grade averaging 85 g/t 3PGE+Au.
Members of the Orion Mine Finance and Nomad Royalty teams, with members of Platreef’s mine development team,on the top platform of the Shaft 1 headgear.
Kgalalelo Tladi, Chief Safety Officer, conducting a safety inspection of the Shaft 1 underground equipping stage.
Sustainable, dry stacking tailings storage methodology
The tailings storage facility (TSF) design in the 2022 Feasibility Study is based on the dry stack methodology. Previously, a hybrid paddock deposition methodology was considered; however, Ivanplats opted to change the TSF deposition methodology from conventional upstream design to dry stacking, which has numerous benefits.
Dry stacking facilities are deemed to be inherently safer, as there is no hydraulic deposition; hence, in the unlikely event of a catastrophic failure, the risk of flooding the surrounding areas with tailings will be minimal. Stacked tailing storage facilities also are more water efficient in that most of the water in the tailings is captured in the dewatering plant, pumped directly back to the concentrator and re-used within the process.
During the 2022 Feasibility Study mine life, approximately 53 million tonnes of tailings will be stored in the dry stack TSF, with the remainder of the tailings (approximately 60% overall) to be used as backfill in the underground mine, further reducing the project footprint.
The TSF design also caters for a potential future expansion to 8-Mtpa production capacity, to be explored in future studies.
It is envisaged to use the approved rock-dump footprint within the immediate Platreef mine and concentrator areas as a dry stacking tailings facility during Phase 1. Golder Associates currently is performing the design work to apply for the relevant licences and/or amendments to the existing authorizations.
Ivanplats signs new agreement to provide local, treated water for Platreef’s Phase 1 and 2 operations; supply of electricity also secured
The water requirement for the Phase 1 operation is projected to peak at approximately three million litres per day, which will then increase to nine million litres per day once the Phase 2 expansion is complete. On January 17, 2022, Ivanhoe announced the signing of new agreements for the rights to receive local, treated water to supply the bulk water needed for the phased development plan at Platreef. These agreements replace those originally signed in 2018.
Under the terms of a new offtake agreement, the Mogalakwena Local Municipality (MLM) has agreed to supply at least three million litres per day of treated effluent, up to a maximum of 10 million litres per day for 32 years, from the date of first production, sourced from the town of Mokopane’s Masodi Waste Water Treatment Works, currently under construction.
Ivanplats also has signed a sponsorship agreement where Ivanplats has undertaken the commitment to complete the partially constructed Masodi Waste Water Treatment Works, which was halted in 2018. Ivanplats anticipates spending approximately ZAR 215 million (US$14 million) to complete the works, whereby Ivanplats’ financial contribution will take the form of a sponsorship in favour of the municipality. Ivanplats will purchase the treated water at a reduced rate of ZAR 5 per thousand litres. Arrangements are underway to re-commence the construction works in Q3 2022, which are scheduled to take approximately 18 months.
On February 24, 2017, the 5 million-volt-ampere (MVA) electrical power line connecting the Platreef site to the Eskom public electricity utility was energized and now is supplying electricity to Platreef for shaft equipping and construction activities.
Ivanplats has reached an agreement with Eskom for the supply of a total of 100 MVA of power, which represents Platreef’s electrical power requirement for the full Phase 2 mine, concentrator and associated infrastructure. As part of the 2022 Feasibility Study, Ivanhoe negotiated the load build-up with Eskom to cater for Phase 1’s construction requirement of up to 8 MVA, Phase 1’s production requirement of 25 MVA and later ramping up to 100 MVA for Phase 2.
Ivanplats opted for a self-build, with the construction contract awarded. The construction of the 2 X 27km Overhead lines for the 100MVA power supply commenced in November 2021. The contractors site establishment is completed, with bush clearing, and soil nomination tests under way, for the structure foundations.
Ivanplats arranges offtake for Platreef’s Phase 1 production; evaluating options for Phase 2
Ivanplats recently signed documents relating to offtake for 100% of Phase 1's PGM concentrate production of approximately 40,000 tonnes per year, based on standard commercial terms for PGM mines in South Africa. The ability to place Phase 1 PGM concentrate reflects its high quality, which contains six payable metals including palladium, rhodium, platinum, nickel, copper and gold.
The offtake arrangements are with Northam Platinum Limited and Heron Metals Pty Ltd., a joint venture in which Trafigura Pte. Ltd. ("Trafigura"), a Singaporean registered company, has a majority shareholding. Northam Platinum is an independent, fully empowered, integrated PGM producer, with primary operations in South Africa including the wholly owned Zondereinde Mine and metallurgical complex, and Booysendal Mine. The Trafigura Group is one of the world's leading independent commodity trading and logistics houses.
The terms of the proposed offtake with Heron Metals / Trafigura are based on a non-binding indicative term sheet and are subject to negotiation and execution of definitive documentation for a concentrate sales agreement.
Ivanplats is evaluating alternatives for the processing of concentrate production during Phase 2, from 2028 onwards. This includes placing concentrates with smelters in South Africa or elsewhere, where additional capacity is expected to become available by the time steady-state production is achieved. Ivanplats is also considering standalone downstream processing options, including both conventional smelting and refining, and hydrometallurgical processes.
Shaft 1 changeover nearing completion with Shaft 2 early works underway
The construction of the 996-metre-level station at the bottom of Shaft 1 was completed in July 2020. Shaft 1 initially will be used to access the orebody and is approximately 450 metres away from a high-grade area of Flatreef that is planned for mining in Phase 1. The three development stations that will provide initial, underground access to the high-grade orebody also have been completed on the 750-, 850-, and 950-metre levels.
Shaft equipping commenced in May 2021 and remains on track to be completed in March 2022. Following the completion of the changeover work in the shaft, underground stations, and establishment of the ore and waste passes, lateral underground mine development will commence toward high-grade ore zones.
Lateral mine development on the 950-metre level toward the Flatreef orebody is expected to begin in Q2 2022. The initial development will use battery electric M2C drill rigs and 14-tonne load haul dumpers being manufactured by Epiroc, a leading mining equipment manufacturer, at its facilities in Örebro, Sweden. The partnership with Epiroc for emissions-free mining equipment is an important first step toward reducing the carbon footprint of the mine, with learnings to be applied across Ivanhoe Mines’ operations. The battery electric mining fleet is expected to arrive on site in March 2022.
The contract for the initial mine development has been adjudicated and is in the final stages of negotiation. Newly designed rock chutes on surface will connect the conveyors feeding the concentrator plant and the waste rock area; from there the waste rock will be crushed and used as cemented backfill underground for maximum ore extraction, as well as for protection berms to contain storm water and reduce noise emissions.
Pilot drilling of the first main ventilation shaft will commence in Q2 2022, after which it will be reamed to its final diameter of 5.1 metres, providing the main return airway for the Phase 1 development. On completion, this ventilation shaft also will serve as a second egress from the mine.
Early-works surface construction for Shaft 2, including the excavation of a surface box-cut to a depth of approximately 29 metres below surface and construction of the concrete hitch for the 103-metre-tall concrete headframe, have been completed. The Shaft 2 headframe construction, from the hitch to the collar level, is progressing well with the third and fourth headgear lifts well advanced. Ten civil lifts are to be constructed in total, including a ventilation plenum and personnel access tunnel, with targeted completion in May 2022.
Phillip Ramphisa, Platreef’s Environmental Manager, Business Sustainability, analyzing project water samples. Ivanhoe Mines is committed to responsible water use at all its projects in support of the United Nations’ Sustainable Development Goals.
Development of human resources and job skills
Current and future human resource development at the Platreef Project is one of the largest contributors to the sustainable development of the project. Ivanplats has a commitment and dedication to being a Mine of the Future and an employer of choice, underpinned by excellence, and overseen by strategic and valuable recruitment, human resource development and workplace safety programs, among others. The Platreef Project’s first five-year Social and Labour Plan (SLP) contributed R67 million (US$4 million) for the development of job skills among local residents.
Implementation of the second SLP currently is underway, through which Ivanplats plans to build on the foundation laid in the first SLP and continue with its training and development suite, which includes 15 new mentors, internal skills training for 78 staff members, a legends program to prepare retiring employees with new/other skills, community adult education training for host community members, core technical skills training for at least 100 community members, portable skills, and more.
Local economic development projects will contribute to community water source development with the Mogalakwena Municipality boreholes program, educational program in partnership with Department of Education, and significant funding for sanitation infrastructure at the municipality. The refurbishment and equipping of a health clinic in Tshamahansi Village, which will be conducted in partnership with other parties, will enable better access to health services for local residents.
Ivanplats proudly launched its first cadetship program, providing opportunities to 50 local youths every year. The program seeks to enhance gender diversity, with 54% of the students being female; and offers these cadets, who are scheduled to graduate in March, a national certificate in health and safety, as well as mining competencies, such as utility vehicle operations.
Chuene Matlala, Platreef’s Senior Project Officer, responsible for the implementation of local economic development initiatives as part of the project’s Social Labour Plan.
Hendrietta Sarila, Project Geologist and Environmental Management Coordinator and Chairperson of the Women in Mining Committee, at the Platreef Project, a member of Deloitte's Women in Mining Class of 2021.
Ivanplats draws down initial US$75-million tranche of US$300 million streaming facilities; financing focus now on securing US$120 million in senior debt
Ivanplats recently concluded stream-financing agreements for a US$200 million gold-streaming facility and a US$100 million palladium- and platinum-streaming facility, which will fund a large portion of the Phase 1 capital costs, with initial production scheduled in 2024. The stream facilities are to be drawn in two tranches, with the first tranche of US$75 million drawn in December 2021, and the second tranche of US$225 million to be drawn upon satisfaction of certain conditions precedent.
The conclusion of the stream-financing agreements allows Ivanplats to focus efforts on finalizing the senior debt facility for up to US$120 million. Both the gold stream facility and palladium and platinum stream facility will be subordinated to any senior secured financing.
The senior debt facility is anticipated to be used only after the stream facilities are fully drawn. Ivanplats remains flexible to raise additional capital at a later date.
Future expansion options
The 2022 Feasibility Study considers Platreef’s Phase 1 and Phase 2 development, including only one third of the Indicated Resources above an US$80/t NSR cut-off. If the remainder of the Indicated Resources were to be converted to Mineral Reserves, it would provide an opportunity to significantly expand production.
The full indicated and inferred resource base at Platreef may support additional expansions and larger production capacity. As development and stoping continues, an infill drilling program from underground is recommended to increase confidence and potentially expand the resource base, which would underpin future studies on further mine expansions.
Qualified persons
The 2022 Feasibility Study and Technical Report has been prepared by:
- OreWin of Adelaide, Australia – Overall report preparation and economic analysis, Mineral Reserve estimation and mine plan.
- Mine Technical Services of Nevada, USA– Mineral Resource estimation.
- SRK Consulting of Johannesburg, South Africa – Mine geotechnical recommendations.
- DRA Global of Johannesburg, South Africa – Process and infrastructure.
- Golder Associates Africa of Midrand, South Africa – Water and tailings management.
The independent qualified persons responsible for preparing the Platreef 2022 Feasibility Study, on which the technical report will be based, are Bernard Peters (OreWin); Curtis Smith (OreWin); Timothy Kuhl (Mine Technical Services); William Joughin (SRK); Val Coetzee (DRA Global); and Riaan Thysse (Golder Associates). Each qualified person has reviewed and approved the information in this news release relevant to the portion of the Platreef 2022 Feasibility Study for which they are responsible.
Other scientific and technical information in this news release has been reviewed and approved by Stephen Torr, P.Geo., Ivanhoe Mines’ Vice President, Project Geology and Evaluation, a Qualified Person under the terms of NI 43-101. Mr. Torr is not considered independent under NI 43-101 as he is the Vice President, Project Geology and Evaluation of Ivanhoe Mines. Mr. Torr has verified the technical data disclosed in this news release.
Sample preparation, analyzes, and security
During Ivanhoe’s work programs, sample preparation and analyses were performed by accredited independent laboratories. Sample preparation is accomplished by Set Point laboratories in Mokopane. Sample analyses have been accomplished by Set Point Laboratories in Johannesburg, Lakefield Laboratory (now part of the SGS Group) in Johannesburg, Ultra Trace Laboratory in Perth, Genalysis Laboratories in Perth and Johannesburg, SGS Metallurgical Services in South Africa, Acme in Vancouver, and ALS Chemex in Vancouver. Bureau Veritas Minerals Pty Ltd assumed control of Ultra Trace during June 2007 and is responsible for assay results after that date.
Sample preparation and analytical procedures for samples that support Mineral Resource estimation have followed similar protocols since 2001. The preparation and analytical procedures are in line with industry-standard methods for platinum, palladium, gold, copper and nickel deposits. Drill programmes included insertion of blank, duplicate, standard reference material (SRM), and certified reference material (CRM) samples. The quality assurance and quality control (QA/QC) program results do not indicate any problems with the analytical protocols that would preclude use of the data in Mineral Resource estimation.
Sample security has been demonstrated by the fact that the samples were always attended or locked in the on-site core facility in Mokopane.
Information on sample preparation, analyses and security will be contained in the Technical Report to be filed on SEDAR at www.sedar.com within 45 days of this news release, and which will be made available on the Ivanhoe Mines website at www.ivanhoemines.com.
About Ivanhoe Mines
Ivanhoe Mines is a Canadian mining company focused on advancing its three principal projects in Southern Africa: the development of major new, mechanized, underground mines at the Kamoa-Kakula copper discoveries in the Democratic Republic of Congo and at the Platreef palladium-rhodium-platinum-nickel-copper-gold discovery in South Africa; and the extensive redevelopment and upgrading of the historic Kipushi zinc-copper-germanium-silver mine, also in the Democratic Republic of Congo.
Kamoa-Kakula began producing copper concentrates in May 2021 and, through phased expansions, is positioned to become one of the world's largest copper producers. Kamoa-Kakula is being powered by clean, renewable hydro-generated electricity and is projected to be among the world’s lowest greenhouse gas emitters per unit of metal produced. Ivanhoe Mines has pledged to achieve net-zero operational greenhouse gas emissions (Scope 1 and 2) at the Kamoa-Kakula Copper Mine. Ivanhoe also is exploring for new copper discoveries on its Western Foreland exploration licences in the Democratic Republic of Congo, near the Kamoa-Kakula Project.
Information contacts
Investors: Bill Trenaman +1.604.331.9834 / Media: Matthew Keevil +1.604.558.1034
Cautionary statement on forward-looking information
Certain statements in this news release constitute “forward-looking statements” or “forward-looking information” within the meaning of applicable securities laws. Such statements involve known and unknown risks, uncertainties and other factors, which may cause actual results, performance or achievements of the company, the Platreef Project, or industry results, to be materially different from any future results, performance or achievements expressed or implied by such forward-looking statements or information. Such statements can be identified by the use of words such as “may”, “would”, “could”, “will”, “intend”, “expect”, “believe”, “plan”, “anticipate”, “estimate”, “scheduled”, “forecast”, “predict” and other similar terminology, or state that certain actions, events or results “may”, “could”, “would”, “might” or “will” be taken, occur or be achieved. These statements reflect the company’s current expectations regarding future events, performance and results, and speak only as of the date of this news release.
The forward-looking statements and forward-looking information in this news release include without limitation, statements that (i) the Phase 1 mine is advancing towards first production in Q3 2024; (ii) Shaft 2 commissioning is accelerated to 2027; (iii) Phase 2 annual forecast production is more than 590,000 ounces of palladium, platinum, rhodium and gold, plus more than 40 million pounds of nickel and copper; (iv) Platreef is to have a cash cost of US$514 per ounce 3PE + AU; (v) changeover of Shaft 1 to a production shaft is expected to be completed in March 2022; (vi) earthworks for the first concentrator is planned to begin in Q2 2022; (vii) civil works and ordering of long lead items is planned for H2 2022; (viii) rock hoisting is to commence in Q2 2022; (ix) two 2.2 Mtpa concentrator modules will be commissioned in 2028 and 2029 once Shaft 2 is complete; (x) steady state production in Phase 2 is 5.2 Mtpa; (xi) the re-commencement of construction of the Masodi Waste Water Treatment is expected to begin in Q3 2022, and construction is expected to take approximately 18 months; (xii) lateral mine development is expected to begin on the 950-metre level in Q2 2022; (xiii) the battery electric mining fleet is expected to arrive at Platreef in March 2022; and (xiv) the senior debt facility of US$120 million is anticipated to be used only after the stream facilities are fully drawn; (xv) Platreef is projected to become one of the world’s largest and lowest-cost producers of palladium, platinum, rhodium, nickel, copper and gold.
In addition, all of the results of the Platreef 2022 Feasibility Study constitute forward-looking statements and forward-looking information. The forward-looking statements include metal price assumptions, cash flow forecasts, projected capital and operating costs, metal recoveries, mine life and production rates, and the financial results of the Platreef 2022 Feasibility Study. These include estimates of internal rates of return after-tax of 18.5% at long term consensus metal prices and 29.3% at spot metal prices with payback periods of 7.9 years and 6.6 years respectively; net present values at an 8% discount rate of US$1.7 billion at long term consensus metal prices and US$4.1 billion at spot metal prices; future production forecasts and projects, including average annual production of 590koz 3PE+Au; estimates of net total cash cost, net of copper and nickel by-product credits and including sustaining capital costs of US$514/oz; mine life estimates, including a 28.3 year mine life; initial capital costs of US$448 million and US$1.5 billion for expansion capital costs; Phase 1 average annual production of 113,000 ounces of 3PE + Au; cash flow forecasts; estimates of 3PE+Au recoveries of 86%. Readers are cautioned that actual results may vary from those presented.
All such forward-looking information and statements are based on certain assumptions and analyses made by Ivanhoe Mines’ management in light of their experience and perception of historical trends, current conditions and expected future developments, as well as other factors management believe are appropriate in the circumstances. These statements, however, are subject to a variety of risks and uncertainties and other factors that could cause actual events or results to differ materially from those projected in the forward-looking information or statements including, but not limited to, unexpected changes in laws, rules or regulations, or their enforcement by applicable authorities; the failure of parties to contracts to perform as agreed; social or labour unrest; changes in commodity prices; unexpected failure or inadequacy of infrastructure, industrial accidents or machinery failure (including of shaft sinking equipment), or delays in the development of infrastructure, and the failure of exploration programs or other studies to deliver anticipated results or results that would justify and support continued studies, development or operations. Other important factors that could cause actual results to differ from these forward-looking statements also include those described under the heading “Risk Factors” in the company’s most recently filed MD&A as well as in the most recent Annual Information Form filed by Ivanhoe Mines. Readers are cautioned not to place undue reliance on forward-looking information or statements. Certain of the factors and assumptions used to develop the forward-looking information and statements, and certain of the risks that could cause the actual results to differ materially are presented in technical reports available on SEDAR at www.sedar.com and on the Ivanhoe Mines website at www.ivanhoemines.com.
This news release also contains references to estimates of Mineral Resources and Mineral Reserves. The estimation of Mineral Resources and Mineral Reserves is inherently uncertain and involves subjective judgments about many relevant factors. Mineral Resources that are not Mineral Reserves do not have demonstrated economic viability. The accuracy of any such estimates is a function of the quantity and quality of available data, and of the assumptions made and judgments used in engineering and geological interpretation, which may prove to be unreliable and depend, to a certain extent, upon the analysis of drilling results and statistical inferences that may ultimately prove to be inaccurate. Mineral Resource or Mineral Reserve estimates may have to be re-estimated based on, among other things: (i) fluctuations in platinum, palladium, gold, rhodium, copper, nickel or other mineral prices; (ii) results of drilling; (iii) results of metallurgical testing and other studies; (iv) changes to proposed mining operations, including dilution; (v) the evaluation of mine plans subsequent to the date of any estimates; and (vi) the possible failure to receive required permits, approvals and licences.
Although the forward-looking statements contained in this news release are based upon what management of the company believes are reasonable assumptions, the company cannot assure investors that actual results will be consistent with these forward-looking statements. These forward-looking statements are made as of the date of this news release and are expressly qualified in their entirety by this cautionary statement. Subject to applicable securities laws, the company does not assume any obligation to update or revise the forward-looking statements contained herein to reflect events or circumstances occurring after the date of this news release.
南非波特希特斯 – 艾芬豪矿业 (TSX: IVN; OTCQX: IVPAF) 联席董事长罗伯特·弗里兰德 (Robert Friedland) 与孙玉峰 (Miles Sun) 今天欣然宣布,旗下南非普拉特瑞夫钯-铂-铑-镍-铜-金矿顶级项目的2022年独立可行性研究 (以下简称“2022可行性研究”) 取得相当理想的积极结果。
今天公布的2022可行性研究,是以2020年11月发布的初步经济评价 (以下简称“初步经济评价”) 以及2020年可行性研究的出色结果为基础。2022可行性研究基于520万吨/年的稳态产能,以及2号竖井加速爬坡达产的方案而编制。2022可行性研究以2020初步经济评价所提出的详细设计和工程方案为基础,充分论证新分期开发方案的可行性以加快推进普拉特瑞夫项目于2024年第三季度投产。
普拉特瑞夫2022可行性研究中,I 期包括初期70万吨/年的地下采矿和77万吨/年产能的选厂,近期完工的1号竖井附近的高品位采区将作为首采区 (图1)。
普拉特瑞夫 II 期达到520万吨/年的稳态产能后,将使普拉特瑞夫成为全球第5大主要铂族金属矿山 (按钯金属当量排名),预计年产超过59万盎司的钯、铂金、铑和黄金以及18,100吨 (4,000万磅) 以上的镍和铜金属。
2022可行性研究反映了普拉特瑞夫矿山的早期两阶段开发。过往的研究显示,后续扩产可达到1,200万吨/年的潜力,这将使普拉特瑞夫成为全球规模最大的铂族金属生产矿山之一。
观看普拉特瑞夫全新视频:https://vimeo.com/682365843/71bb8d040d
普拉特瑞夫项目的施工现场,包括下图左边的1号竖井以及下图右边的2号竖井井架 (从地基至井口) 的建设工程
普拉特瑞夫将成为全球规模最大、成本最低的铂族金属矿山之一
艾芬豪地质师在普拉特瑞夫发现的厚大矿体,含有高品位的铂族金属、镍、铜和金矿化。项目位于林波波省的布什维尔德岩浆杂岩带北部,距离波特希特斯约11公里,距离约翰内斯堡东北约280公里。
在布什维尔德北翼,铂族金属-镍-铜-金矿化主要赋存在普拉特瑞夫层位,是一套走向延伸30多公里的矿化序列。普拉特瑞夫项目位于普拉特瑞夫层位的南部,由Turfspruit及Macalacaskop两个相连的矿权组成,总面积约7,842公顷。最北部的Turfspruit 矿权,邻近且位于英美铂金 (Anglo Platinum) Mogalakwena 矿山的走向延伸上。
Rustenberg Platinum 于1970年代在普拉特瑞夫项目开展了区域性勘查工作。该公司是当时Johannesburg Consolidated Investments (以下简称“JCI”) 的全资子公司,其后于1995年从JCI分拆后加入Amplats (现为英美铂业)。JCI与英美铂业延续英美铂业前身在1960年代进行的前期工作,沿普拉特瑞夫的Turfspruit和Macalacaskop矿权开展稀疏的钻探工作。
1998年2月,Ivanplats获得Macalacaskop和Turfspruit矿权的探矿许可证。1999年,艾芬豪开展了一系列的钻探活动,总进尺726,000米,从最初专注于寻找近地表的矿化带转为重点勘查较深部的钯区。在勘查高峰期,项目投入30台金刚石钻机,每周完成10,000米以上的岩芯钻探。
自2007年以来,Ivanplats重点推进普拉特瑞夫的勘查和开发活动,以圈定和扩大早期发现的Flatreef矿床的高品位厚大矿体的深部延伸。2012年发现了类似于Merensky Reef的矿化层位。
整个Flatreef矿床位于Turfspruit和Macalacaskop矿权范围内。1号竖井施工揭露的矿化层位 (T1 和 T2 矿化带) 厚度约29米,捡块样铂、钯、铑和金 (以下简称“3PE+Au”) 平均品位6.35克/吨,最高达9.6克/吨 (3PE+Au),且含有大量的镍和铜。与南非布什维尔德其它矿床大约1米厚的矿化层位相比,29米厚度绝对是极其罕见的。
由伊藤忠商事株式会社和ITC Platinum牵头的日本财团通过2轮投资持有Ivanplats 10%的股权 — 首轮于2010年9月以1,000万美元收购2%股权,以及第二轮于2011年6月以2.8亿美元收购8%股权。
2010年首次发现了厚大、高品位、平缓的Flatreef矿床。2011年,Ivanplats投入30台钻机开展勘查,总进尺260,000米以上。普拉特瑞夫具有巨大的勘查潜力
2020年6月,Ivanplats完成普拉特瑞夫1号竖井的凿井工程,井深996米。1号竖井距离Flatreef高品位矿体约450米,将作为2024年 I 期投产时的首采区。
Flatreef矿休厚大、平缓,适合进行安全的大规模机械化作业,最大化开采和处理矿石。Flatreef以其高品位为特征,铂钯比约1:1,远远超过布什维尔德北部发现的其它铂族金属矿。
通过分期开发,预计普拉特瑞夫将成为全球规模最大、成本最低的钯-铂-铑-镍-铜-金矿山之一。2022可行性研究认为,普拉特瑞夫 I 期和 II 期开发以80美元/吨的冶炼厂净收益 (NSR) 边界,仅使用了1/3的控制资源量。
2022可行性研究再次证明,普拉特瑞夫加速爬坡至520万吨/年的分期开发方案的可观经济性
弗里兰德先生说﹕“普拉特瑞夫矿床的重大发现,使其至今仍是全球规模最大的待开发贵金属矿床,蕴藏无与伦比的钯、铑、铂金和黄金,以及大量战略性清洁电能源金属,如镍和铜。可行性研究强劲的经济测算结果,巩固了我们的美好愿景,与当地社区和日本合作伙伴携手在未来30个月推进普拉特瑞夫投产。然而,这只是项目的首个里程碑,我们正计划扩建这个世界级项目,使它成为全球规模最大、成本最低的铂族金属矿山之一,同时为这座非凡的大型矿山带来可观的资本回报。”
“铂族金属在全球迈向清洁能源转型方面发挥着关键的作用,特别是氢能源系统应用,以及由发达经济体引领的、新兴市场正快速响应的国际减排行动。普拉特瑞夫将成为行业领先、负责任的钯、铂金、铑、黄金、镍和铜金属的长期供应商,以及南非、当地的利益相关方和社区的重要和可持续经济发展驱动。艾芬豪矿业已作出承诺,致力实现零排放,并采用电池动力设备和尾矿干堆,继续利用最可持续和最负责任的先进技术 “重塑采矿业未来”。”
“钯和铑金属的价格连年创下新高,目前的交易价格分别约为每盎司2,480美元和18,750美元,原因是日趋严格的空气质量管理使得汽车污染控制装置的金属需求增长。同时,由于供应端投资不足和电动汽车及全球清洁能源需求增长,铜和镍也处在价格攀升的历史高位。”
以3PE+Au等于2.0克/吨的边界品位估算,普拉特瑞夫控制资源量含1,890万盎司钯金属量、1,870万盎司的铂金属量、310万盎司的黄金金属量、120万盎司的铑金属量,也即合计4190万盎司的铂族金属+黄金金属量,以及24亿磅的镍金属量和12亿磅的铜金属量。
以3PE+Au等于2.0克/吨的边界品位估算,推断资源量还含有2,380万盎司钯金属量、2,320万盎司的铂金属量、430万盎司的黄金金属量、160万盎司的铑金属量,也即合计5,280万盎司的铂族金属+黄金金属量,以及34亿磅的镍金属量和17.8亿磅的铜金属量。
弗里兰德先生补充说﹕ “Flatreef矿床厚大、平缓的高品位矿化特征,适合采用先进的机械化自动采矿技术以及尖端的地下电动采矿设备,使我们可以高效和安全的方式将矿石开采至地表,以生产对于现代、清洁技术至关重要的各种金属。”
“对艾芬豪矿业来说,普拉特瑞夫的投产将标志着我们跻身全球多元化的大型矿业公司的重要一步。我们希望在卡莫阿-卡库拉顶级铜矿项目强劲发展的势头下,利用在分期开发过程中获得的宝贵经验,继续推进普拉特瑞夫的后续扩建。请大家不要忘记,普拉特瑞夫仍具有巨大的资源增长潜力,以及广阔的勘查前景,而且许多是近地表的。”
I 期建设工程进展顺利,预计于2024年第三季度投产
初期77万吨/年选厂的详细工程研究正在进行中,并同步开展1号竖井向生产井的转换,预计于2022年3月完工。首批地下电动采矿设备也将于此时交付,预计950米中段的首次爆破将于2022年4月进行。1号竖井的早期地下开拓工程包括首个通风井以及连接750米中段至950米中段的放矿设施。
项目计划于2022年第二季度开展第一座选厂的土方工程,并于2022年下半年开展土木工程和长周期设备采购。将于2024年第三季度向选厂供应首批矿石。
预计 I 期平均年产11.3万盎司的铂金、钯、铑和黄金、2,200吨 (500万磅) 镍和1,400吨 (300万磅) 铜。
当地承包商Somuthwa工程公司的William Mamashela (左) 和William Mello在普拉特瑞夫矿山施工
加快推进 II 期扩建,2号竖井提前至2027年投产
初期70万吨/年矿山利用1号竖井进行生产,并同步开展更大规格的2号竖井凿井工程,以推进 II 期扩建至520万吨/年的产能。按照普拉特瑞夫2022可行性研究的方案,2号竖井将于2027年完成装配并投入提升工作,相比2020初步经济评估计划的时间点提前约18个月,与 I 期投产只相隔三年多。
一旦2号竖井完工,两座220万吨/年的选厂将正式投产,而初始选厂将提升产能至77万吨/年,项目总稳态产能扩大至520万吨/年 (图1)。
II 期扩建投产后,将使普拉特瑞夫成为全球第五大铂族金属矿山 (按钯金属当量排名),预计年产超过59万盎司的钯、铂金、铑和黄金以及18,100吨 (4,000万磅) 以上的镍和铜。
普拉特瑞夫蕴藏着巨大的矿产资源,有利未来的扩建计划
普拉特瑞夫2022可行性研究包括普拉特瑞夫的 I 期和 II 期开发,仅使用了约1/3的控制资源量 (冶炼厂净收益边界为80美元/吨)。如果剩余的控制资源量在未来进行储量转换,将有机会大幅提高产量。
随着项目开发进程,后续井下钻探将旨在提高资源量的可靠程度,同时扩大资源规模。预计将开展进一步研究以跟进先前的工作,基于资源量更新情况,来规划后续的分期扩建方案。.
图2﹕普拉特瑞夫2020 FS的选矿厂产量 (矿山服务年限内的矿石处理量和品位)
信息来源﹕公司文件、标准普尔全球市场情报。根据标准普尔全球市场情报数据库中最大规模的未被开发钯、铂金、黄金、银和铑金属项目进行排名 (以探明和控制的钯当量资源为标准)。钯当量计算包括钯、铂金、黄金、银和铑盎司,并根据以下现货金属价格 (2022年2月23日) 假设计算﹕铂金1,095美元/盎司、钯2,480美元/盎司、铑18,750美元/盎司、黄金1,909美元/盎司和银24.55美元/盎司。普拉特瑞夫的探明和控制资源量,以1克/吨边界品位估算钯、铂、黄金和铑金属量.
普拉特瑞夫生产经理Tshifhiwa Netshirando正全力推进1号竖井的装配工作。1号竖井将于短短两年内投产
普拉特瑞夫施工现场鸟瞰图 (2022年2月),图右为1号竖井,图左为2号竖井的施工进度
项目已采购零排放电池动力设备用于地下开拓工程
艾芬豪总裁玛娜·克洛特 (Marna Cloete) 表示:“艾芬豪矿业十分荣幸成为南非铂族金属矿业未来发展的中流砥柱,并且在布什维尔德杂岩体北部建立战略性生产基地。我们期待与利益相关方、当地社区以及南非人民分享这独特矿体创造的利益。普拉特瑞夫项目是南非经济发展的长期驱动,而我们相信这顶级资源拥有着巨大的潜力;其开发建设才刚刚开始,更美好的未来就在前方。”
“我们很高兴代表利益相关方、股东和金属的最终用户,引领南非铂族金属地下采矿行业积极变革。艾芬豪致力于使用电池动力设备,并继续安全第一、负责任的开发,通过项目的分期开发战略,使普拉特瑞夫的一流潜力得到充分释放。”
艾芬豪可持续与特殊项目执行副总裁帕翠莎·马凯莎 (Patricia Makhesha) 博士说﹕“普拉特瑞夫项目最近与Mogalakwena当地政府签署新的包销协议使用中水,这是项目发展的一项重要里程碑。污水处理再利用将为普拉特瑞夫项目提供具有成本效益和长期稳定的水资源供应。我们正努力将普拉特瑞夫打造成为南非下一个伟大的铂族金属矿山,并承诺以环保、资源节约的方式运营。”
“我们相信,在南非规划其未来经济、绿色能源转型以及推动全球清洁技术供应链增长的材料方面,像普拉特瑞夫这样的世界级项目将是不可或缺的。我们很高兴能够为利益相关方创造可持续的、长期的变革机会,其中包括就业、采购和建设方面的机遇。”
艾芬豪矿业通过其子公司Ivanplats间接持有普拉特瑞夫项目64%的权益。《全面提高黑人经济实力法案》的南非受益人持有26%的权益,其余10%权益由伊藤忠商事株式会社、日本石油天然气和金属国家公司和日本天然气公司组成的日本财团持有。
普拉特瑞夫2022 可行性研究由澳大利亚阿德莱德的OreWin Pty Ltd.、美国里诺的Mine Technical Services、南非约翰内斯堡的SRK Consulting Inc.、南非约翰内斯堡的DRA Global以及南非米德兰的Golder Associates Africa独立编撰。
NI 43-101技术报告将于本新闻稿发布后45天内上传至SEDAR网址 (www.sedar.com) 以及艾芬豪矿业网站 (www.ivanhoemines.com)。
普拉特瑞夫的矿体厚大,将使用高效的机械化方法进行开采,加上其镍和铜品位较高,相比其他主要铂族金属矿山的现金成本更低 (图3、4和5)。在全球主要的铂族金属矿山中,估计普拉特瑞夫的总净现金成本为每盎司3PE+Au 514美元 (扣除铜和镍副产品收入,并计入维持性资本开支),是现金成本最低的矿山之一。
1号竖井废石输送系统正在施工建设,为地下采矿做好准备.
安全法律合规部高级经理Thapelo Kadi致力推行安全文化,为普拉特瑞夫项目打造零伤害的工作环境
Ivanplat地下采矿团队全力推进普拉特瑞夫世界级矿山于2024年实现投产
信号操作员Alfred Masimine (左) 和凿井工Malesela Magongoa 在井下950米中段就竖井底部安装装载箱进行讨论
图3﹕普拉特瑞夫矿山示意剖面图,显示Flatreef的T1和T2厚大的高品位矿化带 (深橙色和红色) 、1号竖井和2号竖井已完工的开拓工程 (白色) 和规划的掘进工程 (灰色)
图4﹕南非布什维尔德岩浆杂岩体分布图
信息来源﹕英国牛津SFA公司
图5﹕Platreef项目2017年以来的吨矿收入 (美元)
图6﹕Platreef项目2017年以来的吨矿收入显著增长 (南非兰特)
图5和图6资料来源:Bloomberg,以历史上每周收盘商品价格为准进行每周统计
1. 基于2022年1月26日的矿产储量。
2. 可信储量矿石量124.7百万吨,平均品位铂1.95克/吨、钯2.01克/吨、金0.30克/吨、铑0.14克/吨, 镍0.34%和铜0.17%。
3. 采用155美元/吨至80美元/吨的冶炼厂净收益边界来开展矿产储量估算。
4. 提高后的NSR边界高于边际经济的边界。
5. 矿产储量估算中使用的金属价格为:铂1,600美元/盎司、钯815美元/盎司, 黄金1,300美元/盎司, 铑1,500美元/盎司、镍8.90美元/磅、铜3.00美元/磅。
6. 矿石吨位和品位估算考虑了贫化和采矿损失的因素。
7. 矿山服务年限内的平均回收率为:铂87.4%、钯86.9%、黄金78.6%、铑80.5%、铜87.9%和镍71.9%。
8. 总现金成本包括矿山现场成本、加工和冶炼费等实现成本、权益金和运输成本。
图7﹕全球主要生产商的总现金成本净值及维持性资本开支 (2021年估算),美元/每盎司3PE+Au
信息来源﹕英国牛津SFA公司
图8﹕全球部分主要铂族金属生产商2021年底钯当量产量排名
信息来源﹕英国牛津SFA公司、Ivanplats。注:图表并不包括铂族金属副产品生产商。Nornickel (铂族金属副产品生产商)是最大型的生产商,以钯当量产量计算。普拉特瑞夫项目的成本及生产数据以普拉特瑞夫2022 可行性研究及2014初步经济评估的参数为基础。同业的生产数据由SFA公司提供。钯当量产量以Ivanplats的长期价格假设计算,假设南非兰特兑美元16:1、铂1,100美元/盎司、钯1,450美元/盎司、铑5,000美元/盎司、黄金1,600美元/盎司、镍8.00美元/磅,以及铜3.5美元/磅
2022可行性研究要点
分期开发方案目标在2024年第三季度启动 I 期投产,并加快 II 期扩建以释放普拉特瑞夫矿体的潜力
- 普拉特瑞夫2022可行性研究对于普拉特瑞夫的分期开发方案进行了评估,初期70万吨/年的地下采矿能力及77万吨/年的选矿能力,以1号竖井附近的高品位矿带为目标采区,初期资本开支为4.88亿美元。
- I 期计划于2024年第三季度实现首批精矿的生产,II 期扩建计划于2号竖井在2027年投产后展开,其后建造两座220万吨/年的选厂,计划分别于2028年及2029年投产。2号竖井将用作首采井,以提升稳态产能至520万吨/年。
- II 期扩建资本开支估计为15亿美元,将由 I 期的现金流和项目融资方案提供部分资金。
- Ivanplats勤勉尽责的工程团队及高级顾问团队正在评估优化2号竖井的凿井方法,以求大幅提前2号竖井的提升作业,加快整体开发进程。
- I 期平均年产11.3万盎司的铂金、钯、铑和黄金以及2,200吨 (500万磅) 镍和1,400吨 (300万磅) 铜。
- II 期平均年产59.1万盎司的3PE+Au金属以及11,800吨 (2,600万磅) 镍和7,300吨 (1,600万磅) 铜;这将使普拉特瑞夫成为世界第五大主要铂族金属矿山 (以钯金属当量排名)。
- 矿山服务年限内的现金成本为每盎司3PE+Au 514美元 (扣除副产品,并已计入维持性资本开支)。这将使普拉特瑞夫成为全球成本最低的主要铂族金属矿山。
- 以长期共识价格计算,税后净现值为17亿美元 (折现率8%),内部收益率为18.5%。以2022年2月23日的现货价格计算,净现值将会提升至41亿美元,内部收益率增加至29.3%。
- 1号竖井装配后用于岩石提升的转换工作已接近完成,预计于2022年3月底竣工,首批地下电动采矿设备也将于此时运抵现场。
- 1号竖井将转换成为永久提升竖井,而矿山设计、77万吨/年选厂和相关基础设施设计的详细工程设计和部分优化方案将会同步进行,其中还包括干堆尾矿库。此外,项目已提交分期开发方案所需的用水许可证、废弃物许可证和环境影响评价的修订稿。
- 1号竖井转换完成后,将于2022年4月开展竖井以外的工程,最初目标是要建设首个通风井。
- 地表工程下一个短期里程碑重点是土方工程承包商的选择、进场和施工,且同时加快推进项目各方面的详细工程设计。
图9﹕普拉特瑞夫2022可行性研究的矿山设计图,重点显示了普拉特瑞夫2022可行性研究的 I 期 (70万吨/年) 和 II 期 (520 万吨/年) 方案的采区
图表由OreWin编制 (2022年)
普拉特瑞夫2022可行性研究的主要结果
表1﹕普拉特瑞夫2022 可行性研究分期开发方案的主要结果概要
注﹕
1. 3PE+Au是指铂金、钯、铑和黄金。
2. 经济分析中长期金属价格假设为﹕铂1,100美元/盎司、钯1,450美元/盎司、黄金1,600美元/盎司、铑5,000美元/盎司、镍8.00美元/磅及铜3.50美元/磅。
3. 全现金成本已包括维持性资本开支.
政府关系经理Khazamola Baloyi在普拉特瑞夫矿山现场的办事处
高品位钯-铂-铑-镍-铜-金矿石的样品
表2﹕普拉特瑞夫2022 可行性研究的财务测算结果 (基础方案及现货价格计算)
- 基础方案的金属价格假设如下﹕铂1,100美元/盎司、钯1,450美元/盎司、黄金1,600美元/盎司、铑5,000美元/盎司、镍8.00美元/磅及铜3.50美元/磅。
- 现货金属价格 (2022年2月23日) 如下﹕铂1,095美元/盎司、钯2,480美元/盎司、黄金1,909美元/盎司、铑18,750美元/盎司、镍11.31美元/磅及铜4.48美元/磅。
表3﹕普拉特瑞夫2022可行性研究的平均采矿和选矿处理量统计
- I 期从2024年至2027年,3.3年期间以70万吨/年规模生产的产量。
- II 期从2028年至2052年,25.0年期间以520万吨/年规模生产的产量。
- 3PE+Au是铂金、钯、铑和黄金的品位及产量总和。
图10﹕普拉特瑞夫2020 FS的选矿厂产量 (矿山服务年限内的矿石处理量和品位)
图表由OreWin编制 (2022年)
图11﹕普拉特瑞夫2022可行性研究估算矿山服务年限內的3PE+Au金属及镍/铜回收金属
图表由OreWin编制 (2022年).
表4﹕普拉特瑞夫2022可行性研究的单位运营成本及现金成本 (已扣除副产品收入)
1. I 期从2024年至2027年,3.3年期间以70万吨/年规模生产的产量。
2. II 期从2028年至2052年,25.0年期间以520万吨/年规模生产的产量。
3. I 期运营成本已包括维持性资本开支。
4. 全现金成本已包括维持性资本开支。
表5﹕普拉特瑞夫2022 可行性研究的资本投资概要
注:初期资本反映了实现70万吨/年的初期生产所需的资本性开支 (2022年1月1日起计),其后的扩建资本反映了实现520万吨/年总产能的资本性开支。扩建资本已计入在 I 期预生产阶段花费的5,000万美元,用于继续建设2号竖井。
图12﹕普拉特瑞夫2022可行性研究的预测营业盈余、总资本性开支及税后累计净现金流 (基础方案)
图表由OreWin编制 (2022年)
普拉特瑞夫的矿产资源量
可研报告所用的矿产资源量适用于地下选择性开采
表6﹕矿产资源量适用于井下选择性开采 (粗体显示基础方案)
1. 矿产资源量估算于2016年4月22日完成。2022年1月28日,更新参数对最终经济开采的合理预期进行了评估,以确保估算仍然有效。更新版的基准日为2022年1月28日。估算报告的合资格人Timothy Kuhl 先生是采矿、冶金与勘探学会 (SME) 的会员。
2. 报告的矿产资源量中包含矿产储量。矿产资源量不是矿产储量,不具有论证的经济潜力。
3. 2克/吨3PE+Au的边界品位作为估算的基础方案,并以粗体显示;不同边界品位估算结果不可累加。
4. 矿产资源量以100%项目权益报告。矿产资源估算范围为-200米至650米水平 (深度500米至1,350米) 。控制资源量钻孔间距约100 × 100米,推断资源量钻孔间距为400 × 400米(局部400 × 200米以及200 × 200米)。
5. 最终经济开采的合理预期根据以下假设确定。金属价格为﹕铂1,600美元/盎司、钯815美元/盎司、黄金1,300元/盎司、铑1,500元/盎司、铜3.00元/磅及镍8.90元/磅。假设冶炼厂/精炼厂的金属计价系数为82%,并且已包括采矿成本 (平均34.27美元/吨) 和选矿成本、管理和行政成本及精矿运输成本 (年处理矿石400万吨规模下入选成本15.83美元/吨)。选矿回收率视乎矿块品位而变化,但一般为80%-90% (铂、钯和铑)、70-90% (黄金)、60-90% (铜)以及65-75% (镍) 。
6. 3PE+Au是指铂、钯、铑和黄金。
7. 总计可能会因四舍五入而有微小差异。
普拉特瑞夫2020可行性研究的矿产储量
可行性研究所用的矿产资源基础适用于部分的地下开采作业
表7﹕可信储量 — 截至2022年1月26日的矿石量和品位
1. 矿产储量估算的基准日为2022年1月26日。估算报告的合资格人为Curtis Smith (OreWin) (澳大拉西亚矿业和冶金学会的特许专业人士)。
2. 矿产储量估算中使用的冶炼厂净收益 (NSR) 边界为155美元/吨至80美元/吨。
3. 提高后的NSR边界高于边际经济的边界。
4. 矿产储量估算中使用的金属价格为﹕铂1,600美元/盎司、钯815美元/盎司、黄金1,300 美元/盎司、铑1,500美元/盎司、镍8.90美元/磅以及铜3.00美元/磅。
5. 可行性研究经济分析中金属价格假设为﹕铂1,100美元/盎司、钯1,450美元/盎司、黄金1,600美元/盎司、铑5,000美元/盎司、镍8.00 美元/磅以及铜3.50美元/磅。
6. 矿石量和品位估算已考虑贫化和回采率。
7. 总计可能会因四舍五入而有微小差异。
8. 3PE+Au是指铂金、钯、铑和黄金。
普拉特瑞夫主要采用高效的机械化开采方式
普拉特瑞夫采矿计划中的采区位于地表以下约700米至1,200米的深度。拟采用高效的机械化方式开采,包括深孔采矿法 (long-hole stoping) 及进路充填采矿法 (drift-and-fill)。两种方法都会采用混凝土回填以最大化开采矿石。
图13显示了设计的竖井和通风井位置,以及主要进场通道中段的垂直投影图 (朝东北面)。采区进场斜坡道将拉运中段、采区分段和其它基础设施连接起来。采区分段将在生产区域从斜坡道以固定的垂直间隔向外开拓。钻进和采场开采中段将从分段掘进.
图13﹕普拉特瑞夫井下矿山设计图
图表由Orewin编制 (2022年)
1号竖井转换完成后,将于2022年4月开展竖井以外的工程,初步目标是要建设关键的1号通风井 (图14)。通风井不仅可以保障其它地下基础设施的建设,还可以用作第二进场通道,直至2号竖井完工。2024年第三季度开展I期矿石生产后,采矿作业将会集中在距离1号竖井约450米高品位区域(图14),进场所需的地下基础设施相对较少。
图14﹕早期开发阶段地下矿山设计图
图表由艾芬豪编制 (2022年).
II 期生产期间,2号竖井 (1,104米深、直径10米的生产井) 将会用作主要进场通道。1号竖井 (996米深、直径7.25米的通风井) 将会用作第二进场通道。矿山生产期间,1号和2号竖井还可以同时作为进风井。II 期生产期间,矿石将会从采场拉运至多个放矿点输送到2号竖井的底部,破碎后提升至地表
I 期和 II 期的常规选冶流程设计
选冶试验的重点是最大化回收铂族金属及以镍为主的基本金属,并生产合格的高品位精矿用于进一步选冶和/或对外销售。三种主要地质选冶单元和组合样已完成试验,并生产出平均85克/吨PGE+Au冶炼级的最终精矿,铂族金属的回收率在可接受的水平。试验显示Platreef的矿石适合传统浮选工艺,而不需要主流程或精矿再磨。实验室连续扩大试验,包括开路和闭路浮选试验、磨矿试验、矿物特征、尾矿脱水及流变特征的研究,由位于南非的国际认可的Mintek选冶实验室开展。
磨矿和浮选试验显示,选矿的最佳细度为80%通过75微米。普拉特瑞夫的矿石分为“硬”至“非常硬”,不适合半自磨工艺,所以优选多段破碎和球磨流程。
与碳钢介质不同,高铬研磨介质成功提高了浮选性能。将采用分离-精选流程,其中快速浮选环节采用精选而与中速和慢速浮选环节分开,从而提高铂族金属、铜及镍的回收率和精矿品位。
2022可行性研究的流程设计分阶段进行。I 期包括设计产能77万吨/年的独立选厂。II 期包括其后建设的另外两座220万吨/年的并行模块,以实现矿山产能爬坡计划。
I 期和 II 期流程设计包括三段破碎流程,破碎后的矿石输送到磨矿-浮选模块。浮选后通过精矿浓密、精矿过滤、直至尾矿处理和排放。预计矿山服务年限內选厂3PGE+Au的回收率为86%,平均精矿品位为85克/吨3PGE+Au。.
猎户座矿业金融与Nomad Royalty团队和普拉特瑞夫开发团队在1号井架平台
首席安全官Kgalalelo Tladi在1号竖井的地下装配工作平台进行安全检查
可持续的尾矿干堆存储方法
2022可行性研究的尾矿存储设施 (以下简称“TSF”) 采用干堆尾矿库,之前曾经考虑采用混合式围坝沉积方法,但Ivanplats最终决定将尾矿库从传统的上游筑坝改为更具优势的干堆方案。
由于不存在水压影响,干堆尾矿库固有的安全性更高。因此,即便在罕见的灾难性事故中,尾矿淹没周围地区的风险非常低。干堆尾矿库更加节约水资源,因为尾矿中绝大多数水份在脱水厂已被收集,并直接泵回选厂循环利用。
2022可行性研究的矿山服务年限内,5,300万吨尾矿将储存在干堆尾矿库内,其余的尾矿 (占整体约 60%) 将运送到井下用于回填,进一步减少项目对环境所造成的影响。
干堆尾矿库的设计还应考虑产能扩大至800万吨/年后的生产状况,将会在未来的研究中深入分析。
可行性研究计划在毗邻普拉特瑞夫矿山和选厂的范围内,使用已批准的废石场,用作I期的干堆尾矿库。目前,Golder Associates正在进行设计工作,以申请相关的许可证及/或现有许可的变更.
Ivanplats签署新协议,为普拉特瑞夫 I 期及 II 期提供中水
预计 I 期生产的用水需求最高约300万公升/天,II 期扩建完工后将提高至900万公升/天。2022年1月17日,艾芬豪公布已签署新协议,将获得当地经处理后的中水,以供应普拉特瑞夫分期开发所需的生产用水。这份协议取代了最初于2018年签署的协议。
根据新包销协议的条款,Mogalakwena当地政府 (以下简称“MLM”) 同意,自项目投产后的32年间由波特希特斯的 Masodi 废水处理厂每天供应不少于300万公升且不多于1,000万公升经处理的中水。Masodi 废水处理厂的施工正在进行中。
同时,Ivanplats已签署资助协议,承诺将会完成Masodi废水处理厂2018年中断后的未完成工程。Ivanplats将向市政府提供经济援助,预计投入约2.15亿南非兰特 (约1,400万美元) 以完成Masodi处理厂的建设。Ivanplats将以5南非兰特每1,000公升的较低价格购买中水。计划2022年第三季度重新启动建设工程,为期约18个月。
2017年2月24日,连接普拉特瑞夫矿山与南非公共电力公司Eskom的5 MVA线路已经接通,正向普拉特瑞夫供电,以开展竖井装配和其它建设工程。
Ivanplats与Eskom达成供电协议,提供总计100 MVA电力,即普拉特瑞夫 II 期矿山、选厂和相关基础的电力需求。在普拉特瑞夫2022可行性研究方案下,艾芬豪正与Eskom商讨扩大电力供给,以满足I期建设所需8 MVA、I期生产所需25 MVA,以及其后II期扩建所需100 MVA的电力需求。
Ivanplats选择自建形式,已经完成工程发包。2 X 27公里的供电线路已于2021年11月开始建设,将会提供100 MVA的电力。承包商工地的建设已经完成,现正清理灌木和土壤测试,为建设地基做好准备.
Ivanplats为普拉特瑞夫 I 期产量安排包销协议
Ivanplats根据南非铂族金属矿山的标准商业条款,签署了普拉特瑞夫项目I期100%产量 (约4万吨/年精矿) 包销协议的相关文书。显示了对I期铂族金属精矿高质量的信任,精矿含钯、铑、铂金、镍、铜和黄金六种计价金属。
Ivanplats分别与Northam Platinum Limited和Heron Metals Pty Ltd.签署包销协议,Heron Metals Pty Ltd.是Trafigura Pte. Ltd. (以下简称"托克")的合资企业,Trafigura Pte. Ltd. 注册在新加坡,持有Heron Metals多数股权。Northam Platinum 位于南非瀑布城,是一家独立的综合铂族金属生产商,主要在南非从事业务,包括其全资拥有的Zondereinde矿山和冶炼项目以及Booysendal矿山。托克是领先的国际独立商品贸易和物流公司。
与Heron Metals / 托克的包销协议的条款基于一份非约束性意向书,尚取决于后续谈判和精矿销售协议的最终法律文书签署。
Ivanplats正在评估 II 期 (从2028年起) 精矿的处理的替代方案,包括将精矿运送到南非或其它地方的冶炼厂,预计稳产产能将有所提高。同时,Ivanplats正研究独立的下游加工方案,包括传统的冶炼和精炼以及湿法冶金工艺.
1号竖井的转换工作即将完成,目前正进行2号竖井的前期工作
1号竖井底部的996米中段工作站已于2020年7月顺利竣工。1号竖井早期将用作进场通道,距离 I 期规划开采的Flatreef高品位采区约450米。位于750米、850米和950米中段的三个工作站均已完工,将为早期进入高品位矿区提供便利条件。
竖井于2021年5月开始进行装配,按计划将于2022年3月竣工。在竖井和地下工作站完成转换、矿石和废石放矿设施完成后,将会启动井下水平巷道开拓,向高品位矿区推进。
预计2022年第二季度开始在950米中段进行水平巷道开拓,向Flatreef矿体掘进。初期的开拓工程将会使用Epiroc公司制造的电动M2C钻机及载重14吨的铲运机进行。Epiroc公司是一家领先的采矿设备制造商,其工厂位于瑞典厄勒布鲁。
Ivanplats与Epiroc公司在零排放采矿设备方面的合作,是迈向减碳足迹的重要一步,其成功经验将广泛应用于艾芬豪旗下的其它矿山。电池动力采矿设备预计在2022年3月运抵现场。
初期矿山开发工程的合同已完成评标,正在开展最终阶段的谈判。新设计的地表溜槽将会连接输送系统,将岩石运输至选厂和废石场,废石将被破碎加工成混凝土回填采空区以最大化开采矿石,并用作护堤储存雨水及降低噪音排放。
第一个主要通风井将于2022年第二季度开始施工导孔,最终将扩大至5.1米的孔径,为 I 期开发提供主要的回风道。完工后,通风井将用作矿山的第二进场通道。
2号竖井的前期地表工程已经展开,其中地表以下约29米深的开口以及建造103米高的混凝土井架的地基已经完工。2号竖井井架 (从地基至井口) 的建设工程进度理想,第三和第四部井架升降机的施工进展顺利。计划建设共十部升降机,包括通风和工作人员通道,并计划于2022年5月完工.
普拉特瑞夫的可持续业务发展环保经理Phillip Ramphisa对项目的水样进行分析。艾芬豪矿业承诺在其所有项目负责任地使用水资源,以支持联合国的可持续发展目标
人力资源和职业技能发展
普拉特瑞夫目前和未来的人力资源发展,是项目可持续发展中最重要的一部分。Ivanplats致力于成为“未来的矿山”和员工首选的雇主,以其卓越表现为基础,实施战略性和有价值的招聘方案、人力资源发展和工作场所安全计划等。普拉特瑞夫项目第一个五年社会和劳动计划 (以下简称“SLP”) 已为当地居民在工作技能培训方面提供6,700万兰特 (400万美元) 的资助。
项目正实施第二个SLP计划,Ivanplats计划以第一个SLP为基础,继续专注于培训和开发计划,其中包括﹕增加15名新培训师、向78名员工提供内部技术培训、延续向即将退休的员工提供新技能培训、为项目社区成员提供成人教育,以及向最少100名社区成员提供核心技术培训以及通用技能等。
当地经济发展项目将有助于开发社区水源,包括实行Mogalakwena市水井计划、与教育部合作设立教育计划,以及大额资助建设市政卫生基础设施。项目将与各方合作进行Tshamahansi村一家诊所的翻新工程及设备添置,为当地居民提供更优质的医疗服务。
Ivanplats非常荣幸启动首个学员计划,每年为50名当地青年提供学习机会。学员计划旨在加强性别多样化,其中54%的学员都是女性。首届学员将于今年3月毕业,并将获取职业安全以及采矿技能 (例如操作工程车) 的国家认可证书.
普拉特瑞夫的高级项目主任Chuene Matlala负责推行社会和劳动计划下的当地经济发展方案
地质师兼环保协调员Hendrietta Sarila是女性矿业委员会的主席,以及德勤2021矿业女性课程的学员
Ivanplats从3亿美元的金属流融资提取第一期7,500万美元款项;目前正集中完成1.2亿美元的高级债务融资
Ivanplats最近签订了2亿美元的黄金金属流及1亿美元的钯-铂金属流融资协议,交易将为I期大部分的资本开支提供资金,项目将于2024年实现投产。金属流融资分两期提取,第一期7,500万美元已于2021年12月提取,第二期的2.25亿美元将在满足若干先决条件后才可提取。
达成金属流协议使Ivanplats团队可以集中推进高达1.2亿美元的高级债务融资。黄金金属流融资及钯-铂金属流融资都将顺从于高级债务融资的安排。
预计高级债务融资仅在金属流融资全额提取后才能使用。Ivanplats仍可在其后筹集额外资金。
后续扩建方案
普拉特瑞夫2022可行性研究涵盖了普拉特瑞夫的I期和II期开发方案,仅使用了约1/3的控制资源量 (冶炼厂净收益边界为80美元/吨)。如果剩余的控制资源量在未来进行储量转换,将有机会大幅提高产量。
普拉特瑞夫控制资源量和推断资源量,可支持项目继续扩建和产能提升。随着施工和采矿作业继续推进,建议开展井下加密钻探,以提高资源量的可靠程度,同时扩大资源规模,这将为矿山未来的扩建研究工作奠定基础。
合资格人
以下公司负责编撰2022年可研报告和技术报告﹕
- 澳大利亚阿德莱德的OreWin — 整体报告编撰和经济分析、矿产储量估算和采矿计划
- 美国内华达州的Mine Technical Services — 矿产资源估算
- 南非约翰内斯堡的SRK Consulting — 矿山土力学的建议
- 南非约翰内斯堡的DRA Global — 选矿和基础设施
- 南非米德兰的Golder Associates Africa — 水利和尾矿管理
负责编撰普拉特瑞夫2022 可行性研究的独立合资格人包括﹕ Bernard Peters (OreWin)、Curtis Smith (OreWin)、Timothy Kuhl (Mine Technical Services) 、William Joughin (SRK) 、Val Coetzee (DRA Global)以及Riaan Thysse (Golder Associates)。每位合资格人已经按他们负责编撰普拉特瑞夫2022 FS的部分,审阅和批核本新闻稿的相应内容。
本新闻稿载有的其他科学和技术信息,已经由艾芬豪矿业项目地质及评估副总裁斯蒂芬·托尔 (Stephen Torr) 审阅和批核。托尔先生是符合NI 43-101 条款下的合资格人。由于托尔先生是艾芬豪矿业项目地质及评估副总裁,因此他并不符合NI 43-101 对独立人士的界定。托尔先生已核实本新闻稿所披露的技术数据。
样品制备、分析和安全
在艾芬豪的工作计划中,样品制备和分析由独立认证的实验室进行。样品制备由波特希特斯的Set Point Laboratories 完成。样品分析则由约翰内斯堡的Set Point Laboratories、约翰内斯堡的Lakefield Laboratory (目前是SGS集团成员)、珀斯的Ultra Trace Laboratory、珀斯及约翰内斯堡的Genalysis Laboratories、南非的SGS Metallurgical Services、温哥华的Acme,以及温哥华的ALS Chemex负责。Bureau Veritas Minerals Pty Ltd从2007年6月起掌控Ultra Trace,并从该日起负责分析结果。
用作支持矿产资源估算的样品制备和分析程序,从2001年起一直遵循相似的规程。制备和分析程序符合铂金、钯、黄金、铜和镍矿床的行业标准方法。钻孔计划包括加入空白分析、重复标准的参考物质,以及认证的参考物质样品。质量保证和控制程序的结果并不显示分析规程存在任何问题,将会影响在矿产资源估算中使用数据。
样品经常由员工看管或锁在波特希特斯的现场核心设施,足以证明样品的安全性。
关于样品制备、分析和安全的信息将载于技术报告内。有关技术报告将于本新闻稿发布后45天内上载于SEDAR网址 (www.sedar.com) 以及艾芬豪矿业网站 (www.ivanhoemines.com)。
关于艾芬豪矿业
艾芬豪矿业是一家加拿大的矿业公司,正在推进旗下位于南部非洲的三大合资项目:位于刚果民主共和国的卡莫阿-卡库拉铜矿和位于南非的普拉特瑞夫钯-铑-铂-镍-铜-金矿的大型机械化地下矿山开发工程;以及同样位于刚果民主共和国、久富盛名的基普什 (Kipushi) 锌-铜-锗-银矿的大型重建和改善工程。
卡莫阿-卡库拉铜矿项目于2021年5月实现铜精矿生产,未来将分阶段进行扩建,预计将会成为全球最大规模的铜生产商之一。卡莫阿-卡库拉使用清洁、可再生的水电,并将成为世界上每单位金属温室气体排放量最低的矿山之一。艾芬豪矿业已作出承诺,卡莫阿-卡库拉铜矿将致力实现净零运营温室气体排放 (范围一和二)。同时,艾芬豪正在刚果民主共和国境内、毗邻卡莫阿-卡库拉项目的西部前沿 (Western Foreland) 探矿权内寻找新的铜矿资源。
联系方式
投资者﹕比尔·特伦曼 (Bill Trenaman),电话﹕+1.604.331.9834 / 媒体﹕马修·基维尔 (Matthew Keevil),电话﹕ +1.604.558.1034
前瞻性信息的警戒性声明
本新闻稿载有的某些陈述可能构成适用证券法所订议的“前瞻性陈述”或“前瞻性信息”。这些陈述及信息涉及已知和未知的风险、不明朗因素和其他因素,可能导致本公司的实际业绩、表现或成就、普拉特瑞夫项目或行业的业绩,与前瞻性陈述或信息所表达或暗示的任何未来业绩、表现或成就产生重大差异。这些陈述可通过文中使用“可能”、“将会”、“会”、“将要”、“打算”、“预期”、“相信”、“计划”、“预计”、“估计”、 “安排” 、“预测”、“预言”及其他类似用语,或者声明“可能”、“会”、“将会”、“可能会”或“将要”采取、发生或实现某些行动、事件或结果进行识别。这些陈述仅反映本公司于本新闻稿发布当日对于未来事件、表现和业绩的当前预期。
本新闻稿载有的前瞻性陈述或前瞻性信息包括但不限于以下的陈述﹕(i) I期矿山将于2024年第三季度实现首产;(ii) 2号竖井将提前于2027年投产;(iii) 估计II期年产超过59万盎司的钯、铂金、铑和黄金以及4,000万磅以上的镍和铜金属;(iv) 普拉特瑞夫的现金成本为每盎司3PE + AU 514美元;(v) 1号竖井转换为生产井的工程将于2022年3月完工;(vi) 计划于2022年第二季度开展第一座选厂的土方工程;(vii) 计划于2022年下半年进行土木工程及订购长周期设备;(viii) 2022年第二季度开展岩石提升;(ix) 一旦2号竖井完工,两座220万吨/年的选厂模块将于2028年及2029年投产;(x) II期的稳态产能为520吨/年;(xi) Masodi废水处理厂重新启动建设工程为期约18个月;(xii) 预计2022年第二季度开始在950米中段进行水平巷道开拓;(xiii) 电池电力采矿设备预计在2022年3月运抵普拉特瑞夫现场;以及 (xiv) 完成高达1.2亿美元的高级债务融资。
另外,普拉特瑞夫2022 可行性研究的所有结果均构成前瞻性陈述及前瞻性信息。前瞻性陈述包括金属价格假设、现金流预测、资本和运营成本估算、金属回收率、矿山服务年限和开采率,以及普拉特瑞夫2022 可行性研究的财务业绩。这些包括税后内部收益率18.5% (以长期共识金属价格计算) 和29.3% (以现货金属价格计算) 以及项目回报期分别为7.9年和6.6年的估算;净现值 (折现率8%) 17亿美元 (以长期共识金属价格计算) 和41亿美元(以现货金属价格计算)的估算;未来产量的预测及项目(包括预测平均年产量为59.0万吨3PE+Au);估计总现金成本净值(扣除铜及镍副产品收入,并已计入维持资本开支) 为514美元/盎司;估计矿山服务年限 (包括矿山服务年限为28.3年);初步资本开支4.48亿美元及扩建资本开支15亿美元;I期平均年产量为11.3万盎司 3PE+Au的估算;现金流量预测;估计3PE+Au回收率86%。读者请注意实际业绩与本新闻稿所述的可能会有所差异。
所有该等前瞻性信息和陈述乃基于艾芬豪矿业管理层就他们的经验和对于过往趋势、目前条件和预期未来发展的看法,以及管理层在此情况下认为恰当的其他因素而作出的某些假设和分析。然而,这些陈述涉及不同风险和不明朗因素以及其他因素,可能导致实际事件或业绩与前瞻性信息或陈述所预测的有重大差异,包括但不限于有关部门实施的法例、法规或规章或其无法预计的修订、合约各方未能根据协议履行合约、社会或劳资纠纷、商品价格的变动、基础设施出现无法预计的故障或设施不足、工业事故或机械故障(包括竖井凿井设备)、或延迟开发基础设施;以及勘探计划或其他研究未能达到预期结果或用作证明和支持继续研究、开发或运营的结果。可能导致实际业绩与前瞻性陈述有差异的其他重要因素包括本公司最近提交的管理层讨论与分析报告内以及公司最近提交的周年信息报告内“风险因素”部分所指的因素。读者请注意不应过度依赖前瞻性信息或陈述。用作编撰前瞻性信息和陈述的某些因素和假设,以及可能导致实际业绩产生重大差异的某些风险均载于SEDAR (www.sedar.com) 及艾芬豪矿业网站(www.ivanhoemines.com) 内的技术报告。
本新闻稿还载有矿产资源和矿产储量估算的参考信息。矿产资源和矿产储量估算未能确定,并涉及对许多有关因素的主观判断。矿产资源不是矿产储量,不具有論証的经济潜力。任何该等估算的准确性是可用数据的数量和质量函数,并根据工程和地质诠释的假设和判断而作出,可能被证明是不可靠,在一定程度上取决于钻探结果和统计推论的分析,而最终可能证明是不准确的。矿产资源或矿产储量估算可能需要根据下列因素作出重新估算﹕(i) 铂金、钯、黄金、铑、铜、镍或其他矿产价格的波动;(ii) 钻探结果;(iii) 选冶试验和其他研究的结果;(iv) 建议采矿作业,包括贫化;(v) 在任何估算日期后作出的采矿计划评估;以及(vi) 未能取得所需准许、批准和许可证的可能性。
虽然本新闻稿载有的前瞻性陈述是基于公司管理层认为合理的假设而作出,但公司不能向投资者保证实际业绩会与前瞻性陈述的预期一致。这些前瞻性陈述仅是截至本新闻稿发布当日作出,而且受本警示声明明确限制。根据相应的证券法,公司并无义务更新或修改任何前瞻性陈述以反映本新闻稿发布当日后所发生的事件或情况。
