TORONTO, CANADA ‒ Ivanhoe Mines (TSX: IVN; OTCQX: IVPAF) today announced its financial results for the three months ended March 31, 2021. Ivanhoe Mines is a Canadian mining company advancing its three mining projects in Southern Africa: the Kamoa-Kakula copper mining complex in theDemocratic Republic of Congo (DRC); the Platreef palladium-rhodium-platinum-nickel-copper-gold discovery in South Africa; and the extensive upgrading of the historic Kipushi zinc-copper-lead-germanium mine, also in the DRC. Ivanhoe also is exploring for new copper discoveries on its Western Foreland exploration licences in the DRC, near the Kamoa-Kakula Project. All figures are in U.S. dollars unless otherwise stated.

HIGHLIGHTS

  • Development of the Kakula Mine, the first of multiple, planned mining areas at Ivanhoe Mines’ Kamoa-Kakula joint-venture copper project, has advanced ahead of schedule and first copper concentrate production is expected within a few weeks. Lower-grade ore will be fed into the plant during the final commissioning phase, to ensure plant performance and copper recovery are satisfactory before increasing the head grade.
  • Kamoa-Kakula’s Phase 2 construction is progressing slightly ahead of plan and is scheduled to start up in Q3 2022, which will see a doubling of mill throughput to 7.6 million tonnes per annum (Mtpa). Phases 1 and 2 combined are forecast to produce approximately 400,000 tonnes of copper per year. Based on independent benchmarking, the project’s phased expansion scenario to 19 Mtpa would position Kamoa-Kakula as the world’s second-largest copper mining complex, with peak annual copper production of more than 800,000 tonnes.
  • Kamoa-Kakula’s initial production guidance, on a 100%-project basis, is between 80,000 and 95,000 tonnes of copper in concentrate for the remainder of 2021.
  • At the end of April 2021, Kamoa-Kakula’s pre-production ore stockpiles held three million tonnes grading 4.74% copper, containing more than 140,000 tonnes of copper.
  • Given the current copper price environment, Ivanhoe, together with its partner Zijin, is exploring the acceleration of the Kamoa-Kakula Phase 3 concentrator expansion from 7.6 Mtpa to 11.4 Mtpa, which may be fed from expanded mining operations at Kansoko or a new mining area at Kamoa North (including the Bonanza Zone). Kamoa Copper also is refining its longer-term downstream processing strategy, including the potential construction of a smelter or hydrometallurgical processing facility.
  • In March 2021, Ivanhoe Mines completed a US$575 million, 2.50% convertible senior notes offering. The funding positions Ivanhoe and joint-venture partners to fast-track additional hydropower upgrades to provide sufficient clean and renewable electricity for Kamoa-Kakula expansions to 19 million tonnes of ore per annum and beyond, including a smelter. Funding also allows for expansion and acceleration of the Western Foreland exploration program, in pursuit of the next world-scale copper discovery.
  • In April 2021, Ivanhoe announced that Ivanhoe Mines Energy DRC signed an agreement with the DRC’s state-owned power company SNEL to upgrade a major turbine at the Inga II hydropower facility. The upgraded turbine is expected to produce 162 megawatts of clean, renewable hydropower, providing the Kamoa-Kakula Copper Mine with sufficient, sustainable electricity for future expansions, including a copper smelter.
  • In May 2021, Ivanhoe pledged to achieve net-zero operational greenhouse gas emissions (Scope 1 and 2) at the industry-leading Kamoa-Kakula Copper Mine. Since the mine already is powered by clean, renewable hydro-generated electricity, the focus of the company’s net-zero commitment will be on electrifying the project’s mining fleet with new, state-of-the-art equipment powered by electric batteries or hydrogen fuel cells, when commercially available.
  • In February, Ivanhoe began its 2021 exploration program on its Western Foreland licences that cover a combined area of approximately 2,550 square kilometres in close proximity to Kamoa-Kakula. The 2021 exploration budget has been increased to $21 million to include additional drilling and surveys. The budget may be further expanded based on program results.
  • To support Ivanhoe’s growth plans, future capital needs and widen shareholder support, the company is considering the viability of seeking one or more listings on international stock exchanges. Any such listing(s) would be subject to market conditions and meeting listing requirements.
  • In February 2021, Ivanhoe announced that its South African subsidiary, Ivanplats, is arranging project-level financing of up to $420 million to advance development of the world-scale Platreef palladium, rhodium, platinum, nickel, copper and gold project in South Africa.
  • Ivanplats has signed a non-binding term sheet with Orion Mine Finance, a leading international provider of production-linked stream financing to base and precious metals mining companies, for a $300-million gold, palladium and platinum streaming facility. Ivanplats also has appointed two prominent, international commercial banks – Societe Generale and Nedbank – as mandated lead arrangers for a senior project debt facility of up to $120 million.
  • Ivanplats’ proposed financings follow the November 30, 2020 issuance of the outstanding findings of an independent Platreef Integrated Development Plan 2020 (Platreef IDP20), which consists of an updated feasibility study (Platreef 2020 FS) and a preliminary economic assessment (Platreef 2020 PEA). The initial capital cost for the phased development plan under the Platreef 2020 PEA, starting at a mining rate of 700,000 tonnes per annum (700 ktpa), is estimated at $390 million.
  • Detailed engineering is underway on Platreef’s 700-ktpa initial mine design, 770-ktpa concentrator and associated infrastructure for the phased development plan, which is scheduled to be incorporated into an updated feasibility study before the end of 2021. The Shaft 1 changeover is progressing well in preparation for permanent hoisting by early 2022.
  • At the Kipushi Mine redevelopment project in the DRC, the Kipushi Project’s draft feasibility study, and development and financing plan are being reviewed by Ivanhoe Mines together with its joint-venture partner Gécamines.
  • Ivanhoe has made excellent progress in upgrading Kipushi’s underground infrastructure to allow for mining to quickly begin at the ultra-high-grade Big Zinc orebody. Resumption of production at the mine now requires the construction of a surface processing plant and other related surface production facilities. Discussions are continuing with Gécamines to advance a new era of production at Kipushi andit is anticipated that these discussions will be concluded with the finalization of the feasibility study and the agreement on the development and financing plan by mid-2021.
  • At the end of Q1 2021, Kamoa-Kakula had reached 628,000 work hours free of a lost-time injury, Kipushi had reached 3.14 million work hours free of a lost-time injury, and Platreef had reached 202,000 work hours free of a lost-time injury.

Principal projects and review of activities

1. Kamoa-Kakula Project
39.6%-owned by Ivanhoe Mines
Democratic Republic of Congo

The Kamoa-Kakula Project, a joint venture between Ivanhoe Mines and Zijin Mining, has been independently ranked as the world’s fourth-largest copper deposit by international mining consultant Wood Mackenzie. The project is approximately 25 kilometres west of the town of Kolwezi and about 270 kilometres west of Lubumbashi.

Ivanhoe sold a 49.5% share interest in Kamoa Holding Limited (Kamoa Holding) to Zijin Mining in December 2015 for an aggregate consideration of $412 million. In addition, Ivanhoe sold a 1% share interest in Kamoa Holding to privately-owned Crystal River for $8.32 million – which Crystal River will pay through a non-interest-bearing, 10-year promissory note. Since the conclusion of the Zijin transaction in December 2015, each shareholder has been required to fund expenditures at the Kamoa-Kakula Project in an amount equivalent to its proportionate shareholding interest in Kamoa Holding.

A 5%, non-dilutable interest in the Kamoa-Kakula Project was transferred to the DRC government on September 11, 2012, for no consideration, pursuant to the 2002 DRC mining code. Following the signing of an agreement with the DRC government in November 2016, in which an additional 15% interest in the Kamoa-Kakula Project was transferred to the DRC government, Ivanhoe and Zijin Mining now each hold an indirect 39.6% interest in the Kamoa-Kakula Project, Crystal River holds an indirect 0.8% interest and the DRC government holds a direct 20% interest. Kamoa Holding holds an 80% interest in the project.

The Kakula concentrator plant and some of approximately 7,000 employees and contractors who helped construct the mine ahead of schedule and within budget.

Phase 1 concentrator plant now energized with permanent hydroelectricity.

Health and safety at Kamoa-Kakula

At the end of March 2021, the Kamoa-Kakula Project reached 627,876 work hours free of a lost-time injury. Nine lost-time injuries occurred in Q1 2021. The project continues to strive toward its workplace objective of zero harm to all employees and contractors.

Kamoa-Kakula has successfully focused on prevention, preparation and mitigation in managing the risks associated with COVID-19. Large-scale testing, combined with focused preventative measures, ensured that positive cases were quickly identified, isolated and treated, with cross contamination kept to a minimum. Maintaining this high standard of risk management remains a daily focus, to prevent future cases.

The Kamoa COVID-19 hospital continues to treat patients when required, as construction progresses for the expansion and upgrade of the primary healthcare wing of the hospital. Kamoa-Kakula’s highly experienced doctors and nurses apply the latest medical treatments, supported by a world-leading emergency response and paramedic team.

As the pandemic evolves, the medical team at Kamoa-Kakula continues to review and update its risk mitigation protocols, while ensuring that new medical advances are investigated and applied to protect the health and safety of the workforce and community members.

The new primary healthcare wing of the Kamoa hospital under construction.

Initial 3.8-Mtpa Kakula concentrator plant nearing completion, with first copper concentrate production within weeks

Overall progress of Kamoa-Kakula’s first phase, 3.8-Mtpa mining and milling operation (covering mine infrastructure, concentrator plant and surface infrastructure) now is approximately 94% complete (as of end of April), compared to 90% at the end of March.

Overall construction of the project’s first phase, 3.8-Mtpa concentrator plant and associated facilities is advancing rapidly and is approximately 98% complete (as of end of April), up from 92% complete at the end of March. The concentrator plant is essentially mechanically complete, with first copper concentrate production scheduled for later this month or early June. Lower-grade ore will be fed into the plant during the final commissioning phase, to ensure plant performance and copper recovery are satisfactory before increasing the head grade.

Structural steel erection, platework installation and piping and valve installation for the first concentrator plant are effectively complete, as is electrical, controls and instrumentation installation.

The main mine 220-kilovolt (kV) Kamoa Consumer Substation (KCS) has been energized on grid power, as has the 33kV KCS substation. In addition, the main plant 33kV substation and all the plant medium-voltage and low-voltage substations have been energized, and the concentrator plant is fully energized.

Construction complete (C1) sign off is nearing completion with approximately 75% of the certificates signed off and handed over from construction to commissioning. C2 (pre commissioning) commissioning is well underway with some areas (crushing and screening, milling) more than 90% complete. Early C3 activities (checking for leaks, certain instrument calibration, control-loop checks) have started with water being circulated through certain areas in the plant.

Electrical installation at the backfill plant is ongoing and the backfill plant is scheduled to be completed in July 2021, well before paste backfill is required for mining operations.

The backfill plant will be used to mix tailings from the processing plant with cement to produce paste backfill. The backfill will be pumped back into the mine and used to help support mined-out areas. Approximately one-half of the mine’s tailings will be sent back underground, significantly reducing the surface tailings storage. Construction of the tailings storage facility is progressing well and is scheduled to be completed on time to receive tailings from the processing plant.

Construction and commissioning of the surface bulk reclaim tip, bypass conveyor system and run-of-mine stockpile feed conveyor now is complete. The bulk reclaim tip system will be used to feed ore from Kakula’s surface stockpiles to the processing circuit, as well as ore from the Kansoko Mine when second phase operations begin.

The Phase 1 concentrator plant, now mechanically complete.

Copper production guidance for 2021

The Kamoa-Kakula concentrator plant is essentially mechanically complete and first copper concentrate production is scheduled for later this month or early June 2021. Assuming first production starts at that time, Ivanhoe’s guidance for contained copper in concentrate expected to be produced by the Kamoa-Kakula Project for the balance of 2021 assumes a ramp-up from first production in line with published technical disclosures, and is as follows:

Kamoa-Kakula Project                                                                              2021 Guidance
Contained Copper in Concentrate                                                            80,000 to 95,000 tonnes

All figures in the above table are on a 100%-project basis. Metal reported in concentrate is prior to refining losses or deductions associated with smelter terms. Cost guidance is expected to be provided once the Kamoa-Kakula Project’s Phase 1 plant has reached steady state production. Guidance involves estimates of known and unknown risks, uncertainties and other factors which may cause the actual results to be materially different.

Kamoa-Kakula’s Phase 1 backfill plant with concentrator plant in the background.

Construction of Phase 2 of the Kamoa-Kakula project is well underway and Phase 3 expansion is being explored

Construction of the second 3.8-Mtpa concentrator plant is progressing well toward a Q3 2022 start-up, with the current focus on earthworks and civil works. Both earthworks and civil works are tracking slightly ahead of schedule. With orders for all the long-lead items of equipment for the Phase 2 concentrator placed in September 2020, procurement activities have focused on the remainder of the plant equipment. Structural steel fabrication is underway with the first batch complete and due to arrive on site in June 2021.

Given the current copper price environment, Ivanhoe and its partner Zijin are exploring the acceleration of the Kamoa-Kakula Phase 3 concentrator expansion from 7.6 Mtpa to 11.4 Mtpa, which may be fed from expanded mining operations at Kansoko, or new mining areas at Kamoa North (including the Bonanza Zone) and Kakula West.

Foundations for the Phase 2 ball mills and flotation cells advancing rapidly.

Underground development more than 13 kilometres ahead of plan at the end of Q1 2021

Kamoa-Kakula also set a monthly mine development record in March, with advancement of more than 3,100 metres, bringing total underground development to approximately 38.6 kilometres – approximately 13.5 kilometres ahead of schedule. A total of 8.8 kilometres of underground development was completed in Q1 2021. Good progress continued in early Q2 2021 and further increased the underground development to more than 42 kilometres at the end of April 2021, which is 15 kilometres ahead of schedule.

Drift-and-fill stoping operations are progressing well at the Kakula Mine, with approximately 70% of the ore production coming from stoping operations and the remainder coming from mine development activities. Drift-and-fill stoping is a highly-productive mining method of extracting underground ore, where a single tunnel, known as a stope, is extracted leaving an open void that is subsequently backfilled to allow for the extraction of the neighbouring stope in sequence. The backfill plant, which will mix tailings from the processing plant with cement to produce paste backfill, will begin pumping backfill to the underground operations in July 2021.

Large-scale, mechanized mining operations are progressing well at the Kakula and Kansoko mines.April represented the third consecutive month of mining in excess of the 3.8-Mtpa milling rate, reducing start-up risk as the stockpile is not expected to be drawn down significantly until the Phase 2 processing plant comes on stream in Q3 2022.



Pre-production ore stockpiles now hold approximately 3.0 million tonnes grading 4.74% copper, containing more than 140,000 tonnes of copper

At the end of December 2020, Kamoa-Kakula’s pre-production surface stockpiles contained approximately 1.52 million tonnes of high-grade and medium-grade ore at an estimated blended grade of 4.03% copper, containing more than 61,000 tonnes of copper. The project’s combined medium-grade and high-grade ore mined was approximately 300,000 tonnes at an average grade of 5.45% copper in January 2021, approximately 339,000 tonnes at an average grade of 5.50% copper in February 2021, and approximately 400,000 tonnes at an average grade of 5.36% copper in March 2021. This brings the project’s total pre-production high- and medium-grade ore surface stockpiles to approximately 2.56 million tonnes at an estimated grade of 4.60% copper as of the end of March 2021.

A further 409,000 tonnes were mined in April and comprised 357,000 tonnes grading 5.70% copper from the Kakula Mine, including 121,000 tonnes grading 8.40% copper from the mine’s high-grade centre, and 51,000 tonnes grading 5.85% copper from the Kansoko Mine.

The project’s pre-production surface stockpiles now contain more than 3.0 million tonnes of high-grade and medium-grade ore at an estimated blended average of 4.74% copper. Kamoa-Kakula now has reached the 3.0-million-tonne target of mined high-grade and medium-grade ore, several months ahead of the timeline estimated in the 2020 pre-feasibility study.

Kakula’s main pre-production stockpile and concentrator plant. This stockpile, one of three at Kamoa-Kakula, currently contains approximately 1.64 million tonnes grading 4.93% copper.

Kamoa-Kakula close to finalizing agreements for the sale of its copper concentrates during Phase 1 operations

Kakula is expected to produce an extremely high-grade, clean copper concentrate (containing over 55% copper) that will be highly coveted by smelters around the world. Metallurgical test work indicates that the Kakula concentrates contain extremely low arsenic levels by world standards – approximately 0.01%.

Offtake agreements for copper concentrates produced during Phase 1 operations are nearing final, and include arrangements to utilize local smelter capacity to produce blister copper ingots, and also to export concentrates directly.

Upon receipt of final documentation and board approvals from Kamoa-Kakula’s joint-venture partners, as well as from Kamoa Copper SA, Ivanhoe plans to issue a news release providing details of the marketing arrangements.

Draw down of equipment financing facility successfully commenced

On December 1, 2020, Ivanhoe announced the Kamoa-Kakula Project had secured an equipment financing facility of up to EUR 176 million (approximately $211 million), together with a $9 million down-payment facility to be used to purchase underground mobile mining equipment and services from leading Swedish manufacturers Sandvik AB and Epiroc AB, and Finnish manufacturer Normet Oy.

The facility has an availability period of three years and amortizes over five years from utilization and is tied to underground mining equipment at the Kamoa-Kakula Project. The Swedish Export Credit Agency (EKN) has provided both political and commercial cover to the lenders and receives a one-off premium per tranche’s first utilization.

After the completion of all conditions precedent, the Kamoa-Kakula Project completed the draw-down of $9 million of the down-payment facility and an equivalent of $56 million of the equipment financing in December 2020. In Q1 2021, further draw-downs of the equipment financing equivalent of $7.2 million were completed. Further draw-downs under the equipment finance facilities remain subject to conditions precedent customary for facilities of this nature. The company expects the conditions precedent to be met prior to each utilization.

The equipment finance is secured only by the equipment that is being financed. The down-payment facility is unsecured. No guarantee is required from any of the sponsors or parent companies with Kamoa Holding Limited issuing a non-binding Letter of Support, confirming its support for the project.

In addition, Gold Mountains (H.K.) International Mining Company, a subsidiary of Zijin Mining Group, has provided Kamoa Holding Limited with a limited recourse line of credit of $200 million secured by the project’s pre-production ore stockpiles to fund the Phase 2 concentrator expansion. Kamoa Holding has not yet drawn on this line of credit.

Kamoa-Kakula connected to the national power grid, providing clean, renewable 220-kV hydropower

The mine is receiving hydroelectric power for the Kamoa 120-kilovolt (kV) overhead line via the 18-megawatt mobile substation, which is connected to the national grid. Energizing of the permanent 35-kilometre, 220-kV power line connecting the new Western Dispatch substation in Kolwezi to Kamoa-Kakula, and thereby supplying the project with reliable and clean hydro-generated electricity from the national grid, was achieved in December 2020. This was a major milestone in securing permanent grid power for the project.

The main mine 220-kilovolt (kV) Kamoa Consumer Substation (KCS) has been energized on grid power, as has the 33kV KCS substation. The main plant 33kV substation and all the plant medium-voltage and low-voltage substations also have been energized, and the plant now is electrically live.

Towers along the new 35-kilometre, 220-kV power line connecting the new Western Dispatch substation in Kolwezi to Kamoa-Kakula, supplying the project with reliable and clean hydro-generated electricity from the national grid.

Agreement reached to upgrade major turbine at the Inga II hydropower facility

On April 26, 2021, Ivanhoe announced that Ivanhoe Mines Energy DRC signed an agreement with the DRC’s state-owned power company SNEL to upgrade a major turbine at the Inga II hydropower facility. The upgraded turbine is expected to produce 162 megawatts (MW) of clean, renewable hydropower, providing the Kamoa-Kakula Copper Mine with sufficient, sustainable electricity for future expansions, including its own copper smelter.

Aerial view of the Inga I (rear) and Inga II (front) hydropower plants on the Congo River. The penstock funneling water to turbine 5 at Inga II is circled in red.

The map below shows the Inga andMwadingusha hydropower complexes, theInga high-voltage power line, the Kamoa-Kakula Project, the new 220-kV power line connecting Kamoa-Kakula to the national grid at Kolwezi, and the Benguela railway connecting the DRC to the Angolan port of Lobito.

Ongoing upgrading work enables Mwadingusha hydropower station to supply clean, sustainable electricity

The upgrading work at the Mwadingusha hydropower plant is nearing completion with the synchronization of the first turbine achieved in December 2020. Three of the six new turbines at the Mwadingusha hydropower plant now have been synchronized to the national electrical grid, with each generating unit producing approximately 13 MW of power. Electricity from all of Mwadingusha’s six turbines, with an upgraded output of 78 MW, is expected to be integrated into the national power grid in Q2 2021.

The work is being conducted by engineering firm Stucky of Lausanne, Switzerland, under the direction of Ivanhoe Mines and Zijin Mining, in conjunction with the DRC’s state-owned power company, La Société Nationale d’Electricité (SNEL).

Aerial view of the 78-MW Mwadingusha hydropower plant, the reservoir and the community of Mwadingusha.

Engineering, procurement and construction of other surface infrastructure rapidly progressing

Beijing-based CITIC Construction Co., Ltd. is building Kakula’s first phase, backfill paste plant. The backfill plant will be used to mix tailings from the concentrator plant with cement to produce paste backfill. The backfill will be pumped back into the mine and used to help support mined-out areas. Approximately one-half of the mine’s tailings will be sent back underground, significantly reducing the surface tailings storage. Construction of the backfill plant is progressing in parallel with the concentrator plant and is expected to be commissioned in July 2021.

Construction of the tailings storage facility is progressing well and is scheduled to be completed well ahead of the required date.

Construction of the surface bulk reclaim tip, bypass conveyor system and run-of-mine stockpile feed conveyor also is progressing well, with first commissioning and tie into the main decline conveyor planned for early 2021. The bulk reclaim tip system will be used to feed ore from Kakula’s surface stockpiles to the processing circuit, as well as ore from the Kansoko Mine when second phase operations begin.

Kamoa-Kakula aiming to become the first net-zero carbon emitter among the top-tier copper mines by electrifying its mining fleet with state-of-the-art equipment powered by electric batteries or hydrogen fuel cells

On May 5, 2021, Ivanhoe Mines announced its pledge to achieve net-zero operational greenhouse gas emissions (Scope 1 and 2) at the industry-leading Kamoa-Kakula Copper Mine in the Democratic Republic of Congo.

In support of the Paris Agreement on climate change, and in the spirit of the commitments at the recent virtual global climate conference by the Chinese and American governments to sharply cut emissions, Ivanhoe Mines has committed to working with its joint-venture partners and leading underground mining equipment manufacturers to ensure that Kamoa-Kakula becomes the first net-zero operational carbon emitter among the world’s top-tier copper producers.

Since the Kamoa-Kakula mine and concentrator plant already are powered by clean, renewable hydro-generated electricity, the focus of the company’s net-zero commitment will be on electrifying the project’s mining fleet with new, state-of-the-art equipment powered by electric batteries or hydrogen fuel cells.

Kamoa-Kakula is working closely with its mining equipment suppliers to decrease the use of fossil fuels in its mining fleet, and evaluate the viability, safety and performance of new electric, hydrogen and hybrid technologies. The mine plans to introduce them into its mining fleet as soon as they become commercially available.

Enriching communities through sustainable development

The Sustainable Livelihoods Program was founded in 2010 to strengthen food security and farming capacity in the host communities near Kamoa-Kakula by establishing an agricultural training garden and support for farmers at the community level. Today, approximately 467 community farmers are benefiting from the Sustainable Livelihoods Program, producing high-quality food for their families and selling the surplus for additional income.

The Sustainable Livelihoods Program, which commenced with maize and vegetable production, now includes fruit, aquaculture, poultry and honey. The construction of 100 new fish ponds currently is underway, to contribute toward local entrepreneurship and enhanced regional food security. The Musokantanda Agronomist Secondary School, constructed and equipped during 2020, now serves as a research facility and offers educational programs to 118 students, as well as training programs to local farmers. Plans also are underway for a collaboration between the agronomy school and the University of Kolwezi, which will provide further practical training for students.

Additional non-farming-related activities continued and included education programs, a community brick-making program, a sewing program, and the supply of fresh water to a number of local communities using solar-powered boreholes. To ensure that the sewing team is geared to commence operations and that their production of Kamoa-Kakula personal protective equipment (PPE) and other garments meets quality standards, 28 members of the project are undergoing professional training for six months.

The new Muvunda Primary School, catering to 206 students, has been opened and construction and equipping of the Kaponda Primary School is underway. Eight out of a planned 29 boreholes were drilled in communities using local contractors, providing 4,244 community members with easy access to clean water.

Construction of resettlement houses for the relocation program continued with 13 more households relocated to the Kaponda host site, bringing the total to 74 homes relocated and 10 households remaining. Land replacement was completed for 108 project-affected people in the Kamoa North area. The remaining families are scheduled for relocation upon completion of the construction of their new homes. The entire Kakula Mine area, including the tailings dam area, will be secured once these relocation phases are complete.

L-R: Local community members Dennis Kabadi, Ines Lumbwe, Simon Ilonga, and Hernestine Hlumbwe at the Kamoa-Kakula sewing centre. The sewing project, nicknamed Salamah (‘security and peace’ in Swahili), was initiated by Kamoa-Kakula’s Local Economic Development team in 2013 and has since seen significant growth and development.



2. Platreef Project
64%-owned by Ivanhoe Mines
South Africa

The Platreef Project is owned by Ivanplats (Pty) Ltd (Ivanplats), which is 64%-owned by Ivanhoe Mines. A 26% interest is held by Ivanplats’ historically-disadvantaged, broad-based, black economic empowerment (B-BBEE) partners, which include 20 local host communities with approximately 150,000 people, project employees and local entrepreneurs. Ivanplats reached Level 4 contributor status in its most recent verification assessment on the B-BBEE scorecard. A Japanese consortium of ITOCHU Corporation, Japan Oil, Gas and Metals National Corporation, and Japan Gas Corporation, owns a 10% interest in Ivanplats, which it acquired in two tranches for a total investment of $290 million.

The Platreef Project hosts an underground deposit of thick, platinum-group metals, nickel, copper and gold mineralization on the Northern Limb of the Bushveld Igneous Complex in Limpopo Province – approximately 280 kilometres northeast of Johannesburg and eight kilometres from the town of Mokopane.

On the Northern Limb, platinum-group metals mineralization is primarily hosted within the Platreef, a mineralized sequence that is traced more than 30 kilometres along strike. Ivanhoe’s Platreef Project, within the Platreef’s southern sector, is comprised of two contiguous properties: Turfspruit and Macalacaskop. Turfspruit, the northernmost property, is contiguous with, and along strike from, Anglo Platinum’s Mogalakwena group of mining operations and properties.

Since 2007, Ivanhoe has focused its exploration and development activities on defining and advancing the down-dip extension of its original discovery at Platreef, now known as the Flatreef Deposit, which is amenable to highly-mechanized, underground mining methods. The Flatreef area lies entirely on the Turfspruit and Macalacaskop properties that form part of the company’s mining right.

Health and safety at Platreef

At the end of March 2021, the Platreef Project reached a total of 202,283 lost-time, injury-free hours worked in accordance with South Africa’s Mine Health and Safety Act, and Occupational Health and Safety Act. It has been more than six months since the last lost-time injury occurred at the Platreef Project.

Intermediate Life Support nurse Anna Lebea (left) giving a vaccine to Bernard Maruma, a graduate Electrical Engineer at the Platreef Project.

Arrangement of project-level financing of up to $420 million to advance development of Platreef

In February 2021, Ivanplats signed a non-binding term sheet with Orion Mine Finance, a leading international provider of production-linked stream financing to base and precious metals mining companies, for a $300 million gold, palladium and platinum streaming facility. The stream financing remains subject to completion of legal due diligence and structuring, as well as negotiation and execution of definitive documentation. The streaming facility is planned to be drawn down in four separate tranches, as needed, in parallel with the engineering studies to upgrade the Platreef 2020 PEA to a feasibility study and the changeover of Platreef’s Shaft 1 to a production shaft.

Ivanplats also appointed two prominent, international commercial banks – Societe Generale and Nedbank – as mandated lead arrangers for a senior project debt facility of up to $120 million. The senior project debt facility is scheduled to be utilized only after the streaming facility is fully drawn down. Definitive terms and conditions of the debt facility are subject to the completion of the feasibility study for Platreef’s phased development plan, completion of due diligence and structuring, as well as negotiation and execution of definitive documentation. Terms and conditions of the debt facility will be made available when finalized.

Shaft 1 changeover to a production shaft progressing well

The construction of the 996-metre-level station at the bottom of Shaft 1 was completed in July 2020. The completed Shaft 1 is located approximately 350 metres away from a high-grade area of the Flatreef orebody that is planned for bulk-scale, mechanized mining. The three development stations that will provide initial, underground access to the high-grade orebody have also been completed on the 750-, 850-, and 950-metre levels.

The changeover construction at Shaft 1, initially delayed following an accident on September 14, 2020, is progressing to plan and is on schedule for commencement of rock hoisting early in 2022. All equipment for the shaft changeover has been procured and is on site. The detailed engineering designs for the shaft changeover have been completed, reviewed and approved. The changeover work within the shaft will be conducted by Platreef’s experienced owners’ team.

The winder that was used to successfully sink Shaft 1 will be converted and re-equipped to function as the permanent rock, personnel and material winder for the life of mine. The shaft will be equipped with two 12.5-tonne skips (with hoisting capacity of 825,000 tonnes per year) and an interchangeable personnel and materials cage to accommodate the movement of personnel and materials up and down the shaft during the initial phase of mining.

The shaft will be equipped using rope guides for the main rock, personnel and materials conveyances. The stage and winder ropes used during the sinking phase have been removed, and the equipping stage, new permanent guide-ropes and new permanent hoisting ropes have been delivered to site. Further to this, an auxiliary winder will be installed mainly to function as a man winder during the main rock hoisting cycle.

The construction of the winder foundations is underway and will be completed in time for the auxiliary winder installation and commissioning. The headgear, both winders, equipping stage, conveyances and control systems will comply with the highest industry safety standards, with proven and tested safety and redundancy systems in place.

Newly-designed rock chutes will connect the conveyors feeding the concentrator plant and the waste rock area, from where the rock will be converted to cemented backfill and used for protection berms to contain storm water and reduce noise emissions.

The new ropes and the newly-designed and constructed equipping stage have successfully been installed. The equipping in the shaft is expected to commence in May 2021 for completion by end of March 2022. Following the completion of the changeover work in the underground stations, and establishment of the ore and waste passes, lateral underground mine development will commence toward high-grade ore zones.

Early-works surface construction for Shaft 2 began in 2017. It includes the excavation of a surface box-cut to a depth of approximately 29 metres below surface and construction of the concrete hitch for the 103-metre-tall concrete headgear (headframe) that will house the shaft’s permanent hoisting facilities and support the shaft collar. Platreef’s initial budget for 2021 of $59 million, which included $10 million for commencement of headframe construction for Shaft 2, has been increased to $76 million with additional budget allocated toward detailed engineering designs, an alternative downstream processing option study and execution readiness. The Shaft 2 headframe construction, from the hitch to the collar level, recently commenced and is scheduled for completion in April 2022.

Sinah Tjale, Safety Officer, inspecting safety harnesses at the Platreef Mine. Ivanhoe is proud of the growing team of talented South African and Congolese women at all levels of the company.



Underground mining to incorporate highly productive, mechanized methods

Mining zones in the current Platreef mine plan occur at depths ranging from approximately 700 metres to 1,200 metres below surface. Initial access to the mine will be via the 996-metre-deep, 7.25-metre-diameter ventilation shaft (Shaft 1) that recently has been sunk to its final depth. Once expanded mine production is achieved, primary access to the mine will be by way of a 1,104-metre-deep, 10-metre-diameter production shaft (Shaft 2). During mine production, both shafts also will serve as ventilation intakes. Three additional ventilation exhaust raises (Ventilation Raise 1, 2, and 3) are planned to achieve steady-state production.

Mining will be performed using highly-productive mechanized methods, including long-hole stoping and drift-and-fill. Each method will utilize cemented backfill for maximum ore extraction. The production plans in both the PEA’s initial five-year drift-and-fill mining operation hoisting from Shaft 1 and the expansion when Shaft 2 is available, are focused on maximizing higher-grade areas, which was achieved through optimization based on stope locations, stope grades, mining method, and zone productivities. The orebody was targeted to recover approximately 125 million tonnes at the highest net smelter return.

The ore will be hauled from the stopes to a series of internal ore passes and fed to the bottom of the shafts, where it will be crushed and hoisted to surface.

Platreef employees working on the conversion and re-equipping of the permanent rock, personnel and material winder of the mine’s Shaft 1.

Development of human resources and job skills

Consultation regarding the Platreef Project’s second Social and Labour Plan (SLP) is in the final stages. In this second SLP, Ivanplats plans to build on the foundation laid in the first SLP and continue with its training and development suite, which includes 15 new mentors, internal skills training for 78 staff members, a legends program to prepare retiring employees with new/other skills, community adult education training for host community members, core technical skills training for at least 100 community members, portable skills training, and more. The Platreef Project continued supporting several educational programs and the provision of free Wi-Fi in host communities.

Local economic development projects will contribute to community water source development through the Mogalakwena Municipality boreholes program. Other projects, which will be undertaken in partnership with other parties, include the refurbishment and equipping of a clinic in Tshamahansi Village.

The enterprise and supplier development commitments comprise of expanding the existing kiosk and laundry facilities even further and adding expanded change house facilities to be managed by a community partner in the future. A five-year integrated business accelerator and funding project will assist community members to obtain help with development and supplier readiness.

Students at the Somavhuga High School in Tshamahansi Village, near the Platreef Project. Ivanhoe continues to invest in young people through educational support and enrichment such as scholarships, bursaries, internships and learnerships, as well as through the upkeep of Wi-Fi hotspots in support of e-learning.



3. Kipushi Project
68%-owned by Ivanhoe Mines
Democratic Republic of Congo

The Kipushi copper-zinc-germanium-silver-lead mine in the DRC is adjacent to the town of Kipushi and approximately 30 kilometres southwest of Lubumbashi. It is located on the Central African Copperbelt, approximately 250 kilometres southeast of the Kamoa-Kakula Project and less than one kilometre from the Zambian border. Ivanhoe acquired its 68% interest in the Kipushi Project in November 2011; the balance of 32% is held by the state-owned mining company, Gécamines.

Health and safety at Kipushi

At the end of March 2021, the Kipushi Project reached a total of 3,144,006 work hours free of lost-time injuries. It has been more than two years since the last lost-time injury occurred at the Kipushi Project.

Since temporarily suspending mine development operations due to the COVID-19 pandemic, the project maintained a reduced workforce to safely and cost-effectively maintain infrastructure and pumping systems and to execute planned projects.

The Kipushi Project operates a potable-water station for the daily supply of water to the municipality of Kipushi. This support includes power supply, disinfectant chemicals, routine maintenance, security, and emergency repair of leaks to the primary reticulation. Plans are underway for the establishment of additional solar-powered boreholes at a local school and in nearby communal areas.

The Kipushi Project supported educational initiatives in 2020 through continued renovations at the Mungoti School. The sewing training centre project established by the Kipushi Project continued producing cloth face masks – donating approximately 2,000 masks a month to host communities.

The Sustainable Livelihoods Program, which commenced in 2020 with a poultry farming initiative established for the benefit of a consortium of local women, progressed well with 300 chickens having been brought to market.

Kipushi’s definitive feasibility study in final stages of completion

The Kipushi Project’s pre-feasibility study (PFS), announced by Ivanhoe Mines on December 13, 2017, anticipated annual production of an average of 381,000 tonnes of zinc concentrate over an 11-year, initial mine life at a total cash cost of approximately $0.48 per pound (lb) of zinc.

Highlights of the PFS, based on a long-term zinc price of $1.10/lb, include:

  • After-tax net present value (NPV) at an 8% real discount rate of $683 million.
  • After-tax real internal rate of return (IRR) of 35.3%.
  • After-tax project payback period of 2.2 years.
  • Pre-production capital costs, including contingency, of $337 million.
  • Existing surface and underground infrastructure allow for significantly lower capital costs than comparable greenfield development projects.
  • Life-of-mine average planned zinc concentrate production of 381,000 dry tonnes per annum, with a concentrate grade of 59% zinc, is expected to rank Kipushi, once in production, among the world’s largest zinc mines.

All figures are on a 100%-project basis unless otherwise stated. Estimated life-of-mine average cash cost of $0.48/lb of zinc is expected to rank Kipushi, once in production, in the bottom quartile of the cash-cost curve for zinc producers internationally.

The draft feasibility study, together with the development and financing plan for Kipushi, are being reviewed by Ivanhoe Mines together with its partner Gécamines. It is anticipated that these discussions will be concluded with the finalization of the feasibility study and the agreement on the development and financing plan by mid-2021.

Project development and infrastructure

Although development and rehabilitation activities in Q1 2021, as well as for the year ending December 31, 2020, were limited, significant progress has been made in recent years to modernize the Kipushi Mine’s underground infrastructure as part of preparations for the mine to resume commercial production, including upgrading a series of vertical mine shafts to various depths, with associated headframes, as well as underground mine excavations and infrastructure. A series of crosscuts and ventilation infrastructure still is in working condition and have been cleared of old materials and equipment to facilitate modern, mechanized mining. The underground infrastructure also includes a series of high-capacity pumps to manage the mine’s water levels, which now are easily maintained at the bottom of the mine.

Shaft 5 is eight metres in diameter and 1,240 metres deep and has been upgraded and re-commissioned. The main personnel and material winder has been upgraded and modernized to meet international industry standards and safety criteria. The Shaft 5 rock-hoisting winder also is fully operational with new rock skips, new head- and tail-ropes, and attachments installed. The two newly-manufactured rock conveyances (skips) and the supporting frames (bridles) have been installed in the shaft to facilitate the hoisting of rock from the main ore and waste storage silos feeding rock on the 1,200-metre level.

Cyril Muke checking the variable speed drives for the large-capacity Grifo water pumps that are keeping Kipushi’s underground operations dry.

The main haulage way on the 1,150-metre level, between the Big Zinc access decline and Shaft 5 rock load-out facilities, has been resurfaced with concrete so the mine now can use modern, trackless, mobile machinery. A new truck-tipping bin, which feeds into the large-capacity rock crusher located directly below, has been installed on this level. The old winder at P2 Shaft has been removed and construction of the new foundation, along with assembly and installation of the new modern winder, has been completed and fully commissioned after passing safety inspection and testing procedures.

Alain Mutomo, Garcao Ilunga and Christophe Ngandu (L-R) surveying underground at Kipushi in preparation for resumption of mining activities.


Young Kipushi residents on their way to collect water from the solar-powered water wells installed by the Kipushi Project.


4. Western Foreland Exploration Project
100%-owned and 90%-owned by Ivanhoe Mines
Democratic Republic of Congo

Ivanhoe’s DRC exploration group is targeting Kamoa-Kakula-style copper mineralization through a regional exploration and drilling program on its Western Foreland exploration licences, located to the north, south and west of the Kamoa-Kakula Project. Ivanhoe’s Western Foreland Exploration Project consists of 17 licences that cover a combined area of approximately 2,550 square kilometres.

Exploration models that successfully led to the discoveries of Kakula, Kakula West, and the Kamoa North Bonanza Zone on the Kamoa-Kakula joint-venture mining licence, are being applied to the Western Foreland extensive land package by the same team of exploration geologists responsible for the previous discoveries.

Exploration activities at the Western Foreland area continued during Q1 2021 with the field season restarting in mid-February. The target of the 2021 field season is to start drill testing some of the new permits and generate more targets. Initial drill programs in Q1 2021 were planned close to current access routes and to follow up on Makoko West extension discoveries made in 2020. The drill core from the program is being processed for analysis and detailed rock physical property test work also is being done to further geological understanding, as well as the ability of the data to be used for future larger-scale geophysical test work and analysis.

In Q1 2021, a total of eleven new diamond drill holes were completed at the Makoko West area. The drilling aimed to further delineate the continuation of prospective lower Nguba stratigraphy westwards toward the new exploration permits from initial drilling in 2020. Diamond drilling was completed on northwest-southeast fences every 1,000 metres, with typically two to three holes drilled on each fence and spaced approximately 400 metres apart. Holes drilled generally were around 150 to 450 metres deep, with some shallower holes. A total of 2,725 metres were drilled during the quarter. Exploration continued on the Western Foreland exploration licences with strict procedures in place to protect employees and drilling contractors from COVID-19.

On February 10, 2021, Ivanhoe Mines announced that assay results from drilling completed in early 2020 confirm the extension of the Kamoa North high-grade copper structure for at least 800 metres in the Kiala Discovery area.

The high-grade copper zone at the Kiala Discovery was originally discovered on the Kamoa-Kakula mining licence and delineated through a series of step-out fences of holes drilled on 100-metre spacings in a northerly direction onto Ivanhoe’s 100%-owned exploration licences.

The structure controlling the zone of high-grade copper remains open to the north, and Ivanhoe now has secured 35 kilometres of highly prospective, 100%-owned exploration ground along trend and to the north of the Kiala Discovery.

Selected drill holes at the Kiala Discovery include:

  • DKIA_DD007 intersected 7.21 metres (true width) of 7.98% copper, at a 1% and 2% copper cut-off, from 345.44 metres down hole.
  • DKIA_DD011 intersected 3.82 metres (true width) of 5.35% copper, at a 1% and 2% copper cut-off, from 348.00 metres down hole.
  • DKIA_DD014 intersected 5.30 metres (true width) of 12.42% copper, at a 1% and 2% copper cut-off, from 366.70 metres down hole.
  • DKIA_DD016 intersected 3.59 metres (true width) of 9.71% copper, at a 1% and 2% copper cut-off, from 351.40 metres down hole.

On February 10, 2021, Ivanhoe Mines also announced that drilling at the Makoko Sud Discovery intercepted significant, shallow copper mineralization (including up to 6.01 metres grading 3.38% copper) over a 7.5-kilometre strike length in a south-westerly direction along strike from the initial Makoko Sud Discovery area.

Significant new drill intercepts from Makoko West include:

  • DMKK_DD117, a 3.6-kilometre step-out hole from previous Makoko Sud drilling, intersected 6.01 metres (true width) of 3.38% copper, at a 2% copper cut-off from 259.72 metres down hole and 9.75 metres (true width) of 2.63% copper at a 1% copper cut-off.
  • DMKK_DD118, a 1.6-kilometre step-out hole from previous Makoko Sud drilling, intersected 4.19 metres (true width) of 3.01% copper, at a 2% copper cut-off from 209.50 metres down hole and 5.15 metres (true width) of 2.78% copper at a 1% copper cut-off.
  • DMKK_DD123, a 7.5-kilometre step-out hole from previous Makoko Sud drilling, intersected 3.33 metres (true width) of 1.44% copper, at a 2% copper cut-off from 570 metres down hole and 17.77 metres (true width) of 1.39% copper at a 1% copper cut-off.

The recent Makoko West drilling is extremely significant for the exploration potential of the new exploration permits as it demonstrates that the target stratigraphy extends westward and that the copper mineralizing system on the western edge of the basin is laterally extensive. Future drilling in the Makoko West area will target specific structural locations that are conducive to developing higher copper grades.

A high-resolution magnetic and radiometric survey started during Q4 2020 with 61% of the data acquisition completed. This program has been put on hold while ground-water level drops as this could affect the survey quality. The program will be completed during Q2 2021.

Construction of a 16-kilometre road to gain access to new exploration target areas on the new western permits continued during Q1 2021, running from the Makoko exploration area out to the west and now is nearly complete. In addition, a new bridge over the Lubudi River currently is being constructed, with a new 60-kilometre access spine road planned for the other side of the new bridge to access the new permits to the southwest targeted for exploration during 2021.

The initial 2021 budget was $16 million and now has been increased to $21 million to include additional drilling, surveys and field-work vehicles. The budget may be further expanded based on program results. The increased 2021 exploration program now includes 60,000 metres of combined aircore and diamond drilling, airborne, electromagnetic and ground-based geophysics, soil sampling, road construction and additional field-work vehicles. Much of this year’s exploration will focus on the more than 1,700 square kilometres of new, 100%-owned permits that were acquired in 2019 and received environmental certification in 2020.

SELECTED QUARTERLY FINANCIAL INFORMATION

The following table summarizes selected financial information for the prior eight quarters. Ivanhoe had no operating revenue in any financial reporting period and did not declare or pay any dividend or distribution in any financial reporting period.

DISCUSSION OF RESULTS OF OPERATIONS

Accounting for the convertible notes closed in March 2021

The company closed a private placement offering of $575.0 million of 2.50% convertible senior notes maturing in 2026 on March 17, 2021. Upon conversion, the convertible notes may be settled, at the company’s election, in cash, common shares or a combination thereof. Due to this election right, the convertible notes have an embedded derivative liability that is measured at fair value with changes in value being recorded in profit or loss, as well as the host loan that is accounted for at amortized cost.

The convertible senior notes are senior unsecured obligations of the company which will accrue interest payable semi-annually in arrears at a rate of 2.50% per annum and will mature on April 15, 2026, unless earlier repurchased, redeemed or converted. The initial conversion rate of the notes is 134.5682 Class A common shares of the company per $1,000 principal amount of notes, or an initial conversion price of approximately $7.43 (equivalent to approximately C$9.31) per common share.

Holders of the notes may convert the notes, at their option, in integral multiples of $1,000 principal amount, or in excess thereof, at any time until the close of business on the business day immediately preceding October 15, 2025, but only under the following circumstances:

  • during any calendar quarter commencing after the calendar quarter ending on June 30, 2021 (and only during such calendar quarter), if the last reported sale price of the Company’s Class A common shares for at least 20 trading days (whether or not consecutive) during a period of 30 consecutive trading days ending on, and including, the last trading day of the immediately preceding calendar quarter is greater than or equal to 130% of the conversion price on each applicable trading day; or
  • during the five consecutive business day period after any ten consecutive trading day period (the “measurement period”) in which the trading price per $1,000 principal amount of notes for each trading day of the measurement period was less than 98% of the product of the last reported sale price of the Company’s Class A common shares and the conversion rate on each such trading day; or
  • if the Company calls any or all of the notes for redemption in certain circumstances or upon the occurrence of certain corporate events.

On or after October 15, 2025 until the close of business on the second scheduled trading day immediately preceding the maturity date, holders may convert all or any portion of their notes, in multiples of $1,000 principal amount, at the option of the holder regardless of the foregoing conditions.

The convertible notes will not be redeemable at the company’s option prior to April 22, 2024, except upon the occurrence of certain tax law changes. On or after April 22, 2024 and on or prior to the 41st scheduled trading day immediately preceding the maturity date, the notes will be redeemable at the company’s option if the last reported sale price of the company’s common shares has been at least 130% of the conversion price then in effect for at least 20 trading days (whether or not consecutive) during any 30 consecutive trading day period (including the last trading day of such period) ending on, and including, the trading day immediately preceding the date on which the company provides notice of redemption at a redemption price equal to 100% of the principal amount of the convertible notes to be redeemed, plus accrued and unpaid interest to, but excluding, the redemption date.

Due to the fact that upon conversion, the notes may be settled, at the company’s election, in cash, common shares or a combination thereof, the conversion feature is a derivative financial liability. The effect of this is that the host liability will be accounted for at amortized cost, with an embedded derivative liability being measured at fair value with changes in value being recorded in profit or loss.

The effective interest rate of the host liability was deemed to be 9.39%. The carrying value of the host liability was $415.7 million as at March 31, 2021.

The derivative liability had a fair value of $150.5 million on closure of the convertible notes offering, which decreased to $124.9 million as at March 31, 2021, resulting in a gain on fair valuation of financial liability of $25.6 million for Q1 2021.

The following key inputs and assumptions were used in determining the fair value of the embedded derivative liability on March 17, 2021 at initial recognition:

  • Share price of C$7.00.
  • A credit spread of 630 basis points.
  • Volatility of 42%.
  • Borrowing cost of 50 basis points.

The key inputs and assumptions used at March 31, 2021 was:

  • Share price of C$6.47.
  • A credit spread of 610 basis points.
  • Volatility of 42%.
  • Borrowing cost of 50 basis points.

Transaction costs on the convertible notes offering relating to the derivative liability amounted to $3.7 million and was expensed and included in the profit for the period.

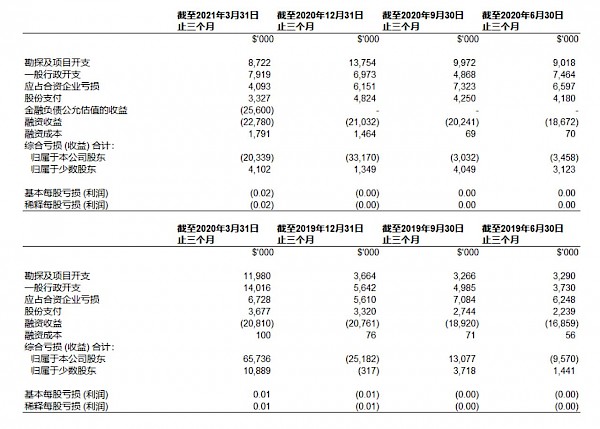

Review of the three months ended March 31, 2021 vs. March 31, 2020

The company recorded a total comprehensive profit of $16.2 million for Q1 2021 compared to a loss of $76.6 million for the same period in 2020. The comprehensive loss for Q1 2020 included an exchange loss on translation of foreign operations of $62.5 million, resulting from the weakening of the South African Rand by 28% from December 31, 2019, to March 31, 2020, compared to an exchange loss on translation of foreign operations recognized in Q1 2021 of $4.2 million.

As explained above, the company recognized a gain on fair valuation of the embedded derivative financial liability of $25.6 million for Q1 2021 and transaction costs on the convertible notes offering relating to the derivative liability was expensed and amounted to $3.7 million.

Finance income for Q1 2021 amounted to $22.8 million, and was $2.0 million more than for the same period in 2020 ($20.8 million). Included in finance income is the interest earned on loans to the Kamoa Holding joint venture to fund operations that amounted to $21.2 million for Q1 2021, and $16.3 million for the same period in 2020, and increased as the accumulated loan balance increased. Interest received on cash and cash equivalents decreased due to US interest rate cuts by the Federal Reserve.

Exploration and project expenditure amounted to $8.7 million in Q1 2021 and $12.0 million for the same period in 2020. Exploration and project expenditure related to exploration at Ivanhoe’s Western Foreland exploration licences and amounts spent at the Kipushi Project which was on reduced activities and incurred limited cost of a capital nature in the periods. The main classes of expenditure at the Kipushi Project in Q1 2021 and Q1 2020 are set out in the following table:

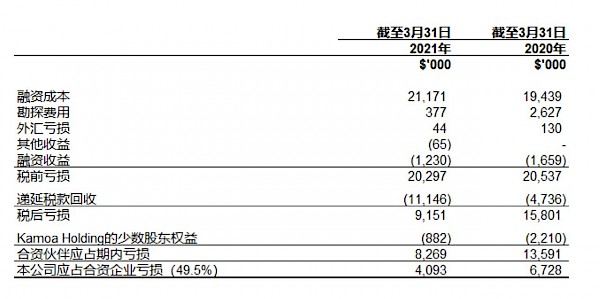

The company’s share of losses from the Kamoa Holding joint venture decreased from $6.7 million in Q1 2020 to $4.1 million in Q1 2021. The following table summarizes the company’s share of losses of the joint venture for the three months ended March 31, 2021, and for the same period in 2020:

The finance costs in the Kamoa Holding joint venture relates to shareholder loans where each shareholder is required to fund Kamoa Holding in an amount equivalent to its proportionate shareholding interest. The company is advancing Crystal River’s portion on its behalf in return for an increase in the promissory note due to Ivanhoe.

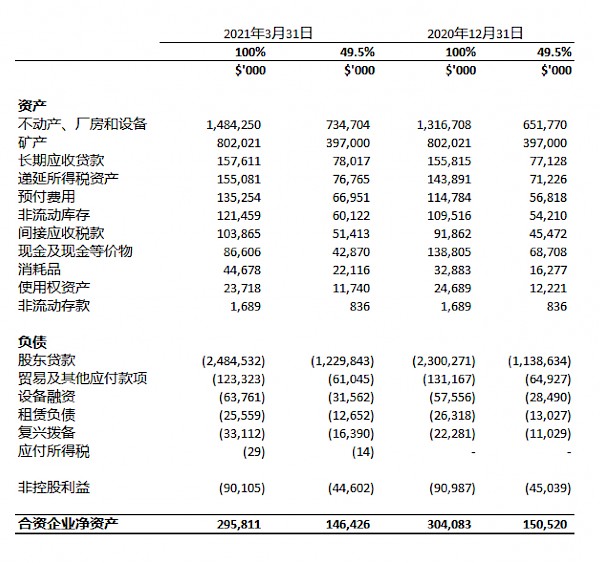

Financial positionas atMarch31, 2021 vs. December31, 2020

The company’s total assets increased by $559.0 million, from $2,417.1 million as at December 31, 2020, to $2,976.1 million as at March 31, 2021. The main reason for the increase in total assets was the receipt of the net proceeds from the convertible senior notes that closed on March 17, 2021. The net proceeds from the sale of the convertible notes, after deducting the expenses of the offering that related to the host liability of $10.3 million, was $564.7 million.

Cash and cash equivalents increased by $469.1 million, from $262.8 million as at December 31, 2020, to $731.9 million as at March 31, 2021 due to the receipt of the convertible note proceeds. The company utilized $20.2 million of its cash resources in its operations and advanced loans of $70.0 million to the Kamoa Holding joint venture during the three months ended March 31, 2021.

The company’s total liabilities increased by $537.2 million to $617.8 million as at March 31, 2021, from $80.6 million as at December 31, 2020, with the increase also due to the private placement offering of $575.0 million of 2.50% convertible senior notes described above.

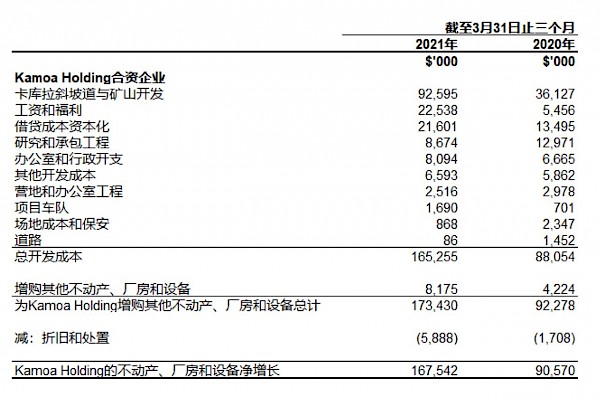

The net increase of property, plant and equipment amounted to $0.5 million, with additions of $6.8 million to project development and other property, plant and equipment. Of this total, $6.7 million pertained to development costs and other acquisitions of property, plant and equipment at the Platreef Project.

The main components of the additions to property, plant and equipment – including capitalized development costs – at the Platreef Project for the three months ended March 31, 2021, and for the same period in 2020, are set out in the following table:

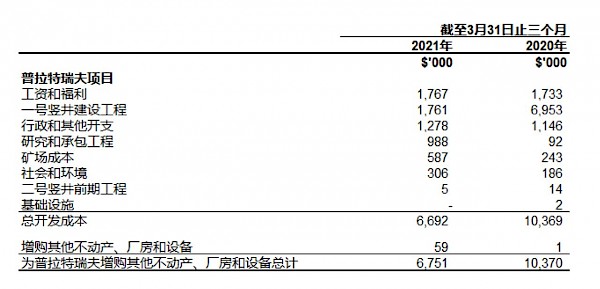

Costs incurred at the Platreef Project are deemed necessary to bring the project to commercial production and are therefore capitalized as property, plant and equipment.

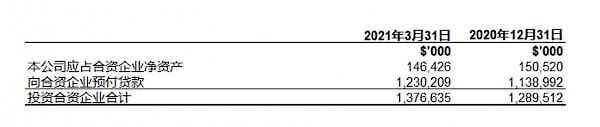

The company’s investment in the Kamoa Holding joint venture increased by $87.1 million from $1,289.5 million as at December 31, 2020, to $1,376.6 million as at March 31, 2021, with each of the current shareholders funding the operations equivalent to their proportionate shareholding interest. The company’s portion of the Kamoa Holding joint venture cash calls amounted to $70.0 million during the three months ended March 31, 2021, while the company’s share of losses from the joint venture amounted to $4.1 million.

The company’s investment in the Kamoa Holding joint venture can be broken down as follows:

The Kamoa Holding joint venture principally uses loans advanced to it by its shareholders to advance the Kamoa-Kakula Project through investing in development costs and other property, plant and equipment, as well as continuing with exploration. This can be evidenced by the movement in the company’s share of net assets in the Kamoa Holding joint venture which can be broken down as follows:

The Kamoa Holding joint venture completed the draw-down of EUR 45 million (approximately $56 million) of the equipment financing and $9 million of the down-payment facilities in late December 2020 and EUR 5.9 million (approximately $7.2 million) of the equipment financing in Q1 2021. The equipment finance is secured only by the equipment that is being financed and has an effective interest rate of 8.96%. The down-payment facility is unsecured and has an effective interest rate of 11.58%.

The Kamoa Holding joint venture’s net increase in property, plant and equipment from December 31, 2020, to March 31, 2021, amounted to $167.5 million and can be further broken down as follows:

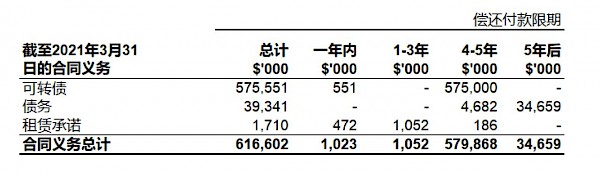

LIQUIDITY AND CAPITAL RESOURCES

The company had $731.9 million in cash and cash equivalents as at March 31, 2021. At this date, the company had consolidated working capital of approximately $781.8 million, compared to $308.0 million at December 31, 2020.

Since December 8, 2015, each shareholder in Kamoa Holding has been required to fund Kamoa Holding in an amount equivalent to its proportionate shareholding interest. The company is advancing Crystal River’s portion on its behalf in return for an increase in the promissory note due to Ivanhoe.

The Platreef Project’s current expenditure is being funded solely by Ivanhoe, through an interest bearing loan to Ivanplats, as the Japanese consortium has elected not to contribute to current expenditures.

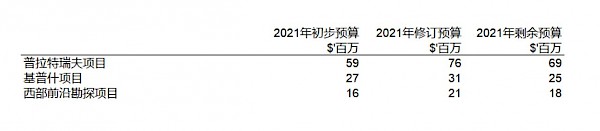

The company’s main objectives for the remainder of 2021 at the Platreef Project is the detailed engineering and updated feasibility study for the phased development plan, progression of the Shaft 1 changeover and the construction of the Shaft 2 headframe to the collar. At Kipushi, cost-saving measures will continue until the finalization of the feasibility study and the development and financing plan is agreed. Mine development at the Kamoa-Kakula Project continues with first production expected later this month or early June 2021 and the Phase 2 concentrator expansion is being fast tracked.

Ivanhoe’s board of directors allocated increased 2021 budgets to each of the Platreef, Kipushi and Western Foreland's exploration projects. The budget increases and amounts remaining for the remainder of 2021 are set out in the following table:

The company’s proportionate funding of the Kamoa-Kakula Project is expected to be $158million for the remainder of 2021, with the assumption that additional equipment purchases would be funded through the equipment financing facilities and that the limited recourse line of credit from Zijin is not drawn.

On 17 March 2021, the company closed a private placement offering of $575 million of 2.50% convertible senior notes maturing in 2026. The convertible senior notes are senior unsecured obligations of the company which will accrue interest payable semi-annually in arrears at a rate of 2.50% per annum and will mature on April 15, 2026, unless earlier repurchased, redeemed or converted.

The notes will be convertible at the option of holders, prior to the close of business on the business day immediately preceding October 15, 2025, only under certain circumstances and during certain periods, and thereafter, at any time until the close of business on the second scheduled trading day immediately preceding the maturity date. Upon conversion, the notes may be settled, at the company’s election, in cash, common shares or a combination thereof.

The carrying value of the host liability was $415.7 million and the fair value of the embedded derivative liability was $124.9 million as at March 31, 2021.The company has a mortgage bond outstanding on its offices in London, United Kingdom, of £3.2 million ($4.4 million). The bond is fully repayable on August 28, 2025, secured by the property and incurs interest at a rate of GBP 1 month LIBOR plus 1.9% payable monthly in arrears. Only interest will be payable until maturity.

In 2013, the company became party to a loan payable to ITC Platinum Development Limited, which had a carrying value of $32.4 million as at March 31, 2021, and a contractual amount due of $34.7 million. The loan is repayable once the Platreef Project has residual cashflow, which is defined in the loan agreement as gross revenue generated by the Platreef Project, less all operating costs attributable thereto, including all mining development and operating costs. The loan attracts interest of USD 3 month LIBOR plus 2% calculated monthly in arrears. Interest is not compounded. The difference of $2.3 million between the contractual amount due and the carrying value of the loan is the benefit derived from the low-interest loan.

The company has an implied commitment in terms of spending on work programs submitted to regulatory bodies to maintain the good standing of exploration and exploitation permits at its mineral properties. The following table sets forth the company’s long-term obligations:

Debt in the above table represents the mortgage bond owing to Citibank and loan payable to ITC Platinum Development Limited, as described above.

The company is required to fund its Kamoa Holding joint venture in an amount equivalent to its proportionate shareholding interest.

This news release should be read in conjunction with Ivanhoe Mines’ Q1 2021 Financial Statements and Management’s Discussion and Analysis report available at www.ivanhoemines.com and at www.sedar.com.

Qualified Persons and NI 43-101 Technical Reports

Disclosures of a scientific or technical nature regarding the revised capital expenditure and development scenarios at the Kamoa-Kakula Project in this news release have been reviewed and approved by Steve Amos, who is considered, by virtue of his education, experience and professional association, a Qualified Person under the terms of NI 43-101. Mr. Amos is not considered independent under NI 43-101 as he is the Head of the Kamoa Project. Mr. Amos has verified the technical data disclosed in this news release.

Other disclosures of a scientific or technical nature regarding the Kakula and Kansoko stockpiles in this news release have been reviewed and approved by George Gilchrist, who is considered, by virtue of his education, experience and professional association, a Qualified Person under the terms of NI 43-101. Mr. Gilchrist is not considered independent under NI 43-101 as he is the Vice President, Resources of Ivanhoe Mines. Mr. Gilchrist has verified the other technical data disclosed in this news release.

Other disclosures of a scientific or technical nature in this news release have been reviewed and approved by Stephen Torr, who is considered, by virtue of his education, experience and professional association, a Qualified Person under the terms of NI 43-101. Mr. Torr is not considered independent under NI 43-101 as he is the Vice President, Project Geology and Evaluation. Mr. Torr has verified the other technical data disclosed in this news release.

Ivanhoe has prepared a current, independent, NI 43-101-compliant technical report for each of the Platreef Project, the Kipushi Project and the Kamoa-Kakula Project, which are available under the company’s SEDAR profile at www.sedar.com:

  • The Kamoa-Kakula Integrated Development Plan 2020 dated October 13, 2020, prepared by OreWin Pty Ltd., China Nerin Engineering Co., Ltd., DRA Global, Epoch Resources, Golder Associates Africa, KGHM Cuprum R&D Centre Ltd., Outotec Oyj, Paterson and Cooke, Stantec Consulting International LLC, SRK Consulting Inc., and Wood plc., covering the company’s Kamoa-Kakula Project;
  • The Platreef Integrated Development Plan 2020 dated December 6, 2020, prepared by OreWin Pty Ltd., Wood plc (formerly Amec Foster Wheeler), SRK Consulting Inc., Stantec Consulting International LLC, DRA Global, and Golder Associates Africa, covering the company’s Platreef Project; and
  • The Kipushi 2019 Mineral Resource Update dated March 28, 2019, prepared by OreWin Pty Ltd., MSA Group (Pty) Ltd., SRK Consulting (South Africa) (Pty) Ltd, and MDM (Technical) Africa Pty Ltd. (a division of Wood PLC), covering the company’s Kipushi Project.

These technical reports include relevant information regarding the effective dates and the assumptions, parameters and methods of the mineral resource estimates on the Platreef Project, the Kipushi Project and the Kamoa-Kakula Project cited in this news release, as well as information regarding data verification, exploration procedures and other matters relevant to the scientific and technical disclosure contained in this news release in respect of the Platreef Project, Kipushi Project and Kamoa-Kakula Project.

Information contacts

Investors
Bill Trenaman +1.604.331.9834

Media
Matthew Keevil +1.604.558.1034

Website www.ivanhoemines.com

Forward-looking statements

Certain statements in this news release constitute “forward-looking statements” or “forward-looking information” within the meaning of applicable securities laws. Such statements and information involve known and unknown risks, uncertainties and other factors that may cause the actual results, performance or achievements of the company, its projects, or industry results, to be materially different from any future results, performance or achievements expressed or implied by such forward-looking statements or information. Such statements can be identified by the use of words such as “may”, “would”, “could”, “will”, “intend”, “expect”, “believe”, “plan”, “anticipate”, “estimate”, “scheduled”, “forecast”, “predict” and other similar terminology, or state that certain actions, events or results “may”, “could”, “would”, “might” or “will” be taken, occur or be achieved. These statements reflect the company’s current expectations regarding future events, performance and results and speak only as of the date of the company’s MD&A for the three months ended March 31, 2021.

Such statements include without limitation, the timing and results of: (i) statements regarding the capital costs remaining until initial production for the Kamoa-Kakula joint venture estimated at $172 million as of March 31, 2021; (ii) statements regarding progress and schedule of the Kamoa-Kakula Project’s first concentrator plant, including that it remains on track to be mechanically complete in Q2 2021, with first copper concentrate production scheduled for May or early June 2021; (iii) statements regarding construction of the second 3.8-Mtpa concentrator plant is progressing well toward a Q3 2022 start-up; (iv) statements regarding Ivanhoe and its partner Zijin exploring the acceleration of the Kamoa-Kakula Phase 3 concentrator expansion from 7.6 Mtpa to 11.4 Mtpa, which may be fed from expanded mining operations at Kansoko, or new mining areas at Kamoa North (including the Bonanza Zone) and Kakula West; (v) statements regarding the stockpile not being expected to be drawn down significantly until the Phase 2 processing plant comes on stream in Q3 2022; (vi) statements regarding construction of the Kamoa-Kakula backfill plant scheduled to be completed in July 2021, well before paste backfill is required for mining operations, including that approximately one half of the mine’s tailings will be sent back underground; (vii) statements regarding the expected progress on other construction at the Kamoa-Kakula Project, including that the tailings storage facility is scheduled to be completed on time to receive tailings from the processing plant; (viii) statements that Kakula is expected to produce an extremely high-grade and clean copper concentrate (containing over 55% copper) that will be highly coveted by copper smelters around the world; (ix) statements regarding offtake agreements for copper concentrates produced during Phase 1 operations are nearing final, and include arrangements to utilize local smelter capacity to produce blister copper ingots, and also to export concentrates directly; (x) statements regarding the Kamoa-Kakula Project being among the world's lowest greenhouse gas emitters per unit of copper produced; (xi) statements regarding refurbishment of six turbines at the Mwadingusha hydro-electric power plant and that electricity from all of Mwadingusha’s six turbines are expected to be integrated into the national power grid in Q2 2021; (xii) statements regarding the agreement reached to upgrade a major turbine at the Inga II hydropower facility including that the upgraded turbine is expected to produce 162 MW of clean, renewable hydropower, providing the Kamoa-Kakula Copper Mine with sufficient, sustainable electricity for future expansions, including its own copper smelter; (xiii) statements regarding Kamoa-Kakula aiming to become the first net-zero carbon emitter among the top-tier copper mines by electrifying its mining fleet with state-of-the-art equipment powered by electric batteries or hydrogen fuel cells; (xiv) statements regarding the Platreef Project’s streaming facility, including that it is planned to be drawn down in four separate tranches; (xv) statements regarding the Platreef Project’s Shaft 1 changeover including that it is expected to commence in May 2021 and be completed by end of March 2022; (xvi) statements that the construction of the Shaft 2 headframe from the hitch to the collar level is scheduled for completion in April 2022; (xvii) statements regarding the planned mining methods at Platreef will use highly productive, mechanized methods, including long-hole stoping and drift-and-fill mining, and that each method will utilize cemented backfill for maximum ore extraction; (xviii) statements that the draft feasibility study and development and financing plan for Kipushi are being reviewed by Ivanhoe Mines together with its partner Gécamines and that it is anticipated that these discussions will be concluded with the finalization of the feasibility study and the agreement on the development and financing plan by mid-2021; (xix) statements regarding future drilling in the Makoko West area including that it will target specific structural locations that are conducive to developing higher copper grades; (xx) statements regarding Ivanhoe’s guidance of contained copper in concentrate expected to be produced by the Kamoa-Kakula Project; (xxi) statements regarding production guidance of between 80,00 and 95,000 tonnes of contained copper in concentrate for the balance of 2021 from the Kamoa-Kakula Project; (xxii) statements regarding the company’s proportionate funding of the Kamoa-Kakula Project is expected to be $158 million for the remainder of 2021; and (xxiii) statements regarding the main objectives for the remainder of 2021 and the remaining 2021 budget.

As well, all of the results of the feasibility study for the Kakula copper mine, the Kakula-Kansoko 2020 pre-feasibility study and the updated and expanded Kamoa-Kakula Project preliminary economic assessment, the feasibility study of the Platreef Project, the Platreef 2020 preliminary economic assessment and the pre-feasibility study of the Kipushi Project, constitute forward-looking statements or information, and include future estimates of internal rates of return, net present value, future production, estimates of cash cost, proposed mining plans and methods, mine life estimates, cash flow forecasts, metal recoveries, estimates of capital and operating costs and the size and timing of phased development of the projects. Furthermore, with respect to this specific forward-looking information concerning the development of the Kamoa-Kakula, Platreef and Kipushi projects, the company has based its assumptions and analysis on certain factors that are inherently uncertain. Uncertainties include: (i) the adequacy of infrastructure; (ii) geological characteristics; (iii) metallurgical characteristics of the mineralization; (iv) the ability to develop adequate processing capacity; (v) the price of copper, nickel, zinc, platinum, palladium, rhodium and gold; (vi) the availability of equipment and facilities necessary to complete development; (vii) the cost of consumables and mining and processing equipment; (viii) unforeseen technological and engineering problems; (ix) accidents or acts of sabotage or terrorism; (x) currency fluctuations; (xi) changes in regulations; (xii) the compliance by joint venture partners with terms of agreements; (xiii) the availability and productivity of skilled labour; (xiv) the regulation of the mining industry by various governmental agencies; (xv) the ability to raise sufficient capital to develop such projects; (xvi) changes in project scope or design, and (xvii) political factors.

This news release also contains references to estimates of Mineral Resources and Mineral Reserves. The estimation of Mineral Resources is inherently uncertain and involves subjective judgments about many relevant factors. Estimates of Mineral Reserves provide more certainty but still involve similar subjective judgments. Mineral Resources that are not Mineral Reserves do not have demonstrated economic viability. The accuracy of any such estimates is a function of the quantity and quality of available data, and of the assumptions made and judgments used in engineering and geological interpretation (including estimated future production from the company’s projects, the anticipated tonnages and grades that will be mined and the estimated level of recovery that will be realized), which may prove to be unreliable and depend, to a certain extent, upon the analysis of drilling results and statistical inferences that ultimately may prove to be inaccurate. Mineral Resource or Mineral Reserve estimates may have to be re-estimated based on: (i) fluctuations in copper, nickel, zinc, platinum group elements (PGE), gold or other mineral prices; (ii) results of drilling; (iii) metallurgical testing and other studies; (iv) proposed mining operations, including dilution; (v) the evaluation of mine plans subsequent to the date of any estimates and/or changes in mine plans; (vi) the possible failure to receive required permits, approvals and licences; and (vii) changes in law or regulation.

Forward-looking statements and information involve significant risks and uncertainties, should not be read as guarantees of future performance or results and will not necessarily be accurate indicators of whether or not such results will be achieved. A number of factors could cause actual results to differ materially from the results discussed in the forward-looking statements or information, including, but not limited to, the factors discussed below and under “Risk Factors”, and elsewhere in the company’s MD&A for the three months ended March 31, 2021, as well as unexpected changes in laws, rules or regulations, or their enforcement by applicable authorities; the failure of parties to contracts with the company to perform as agreed; social or labour unrest; changes in commodity prices; and the failure of exploration programs or studies to deliver anticipated results or results that would justify and support continued exploration, studies, development or operations.

Although the forward-looking statements contained in this news release are based upon what management of the company believes are reasonable assumptions, the company cannot assure investors that actual results will be consistent with these forward-looking statements. These forward-looking statements are made as of the date of this news release and are expressly qualified in their entirety by this cautionary statement. Subject to applicable securities laws, the company does not assume any obligation to update or revise the forward-looking statements contained herein to reflect events or circumstances occurring after the date of this news release.

The company’s actual results could differ materially from those anticipated in these forward-looking statements as a result of the factors set forth in the “Risk Factors” section and elsewhere in the company’s MD&A for the three months ended March 31, 2021.

加拿大多伦多艾芬豪矿业 (TSX: IVN; OTCQX: IVPAF) 今天公布其截至 2021 3 31 止三个月的财务业绩。艾芬豪矿业是一家加拿大的矿业公司,目前正推进旗下位于南部非洲的三大矿产项目﹕位于刚果民主共和国(以下简称"刚果()") 的卡莫阿-卡库拉(Kamoa-Kakula) 铜矿和位于南非的普拉特瑞夫(Platreef) -----金矿,以及同样位于刚果()、久负盛名的基普什(Kipushi) ---锗矿。同时,艾芬豪正在其刚果()境内、毗邻卡莫阿-卡库拉项目的西部前沿 (Western Foreland) 探矿权内寻找新的铜矿资源。除非另有说明,所有数字均以美元为单位。
重点﹕

  • 艾芬豪矿业卡莫阿-卡库拉铜矿合资项目设计了多个采区,首采区卡库拉(Kakula) 矿山的开发进度超计划推进,预计将于数周内启动首批铜精矿生产。最后阶段试车期间将使用较低品位的矿石,在确保选厂的产能和铜回收率达标后,再提高入选品位。
  • 卡莫阿-卡库拉II期的施工进展顺利,略微超越既定计划,预计于2022年第三季度实现投产,将提升产能至年处理矿石760万吨。I 期和 II 期投产后每年将累计生产高达40万吨铜。根据独立研究机构排名,一旦项目扩大产能至1,900万吨/年,卡莫阿-卡库拉将成为全球第二大铜矿山,最高年产量将超过80万吨铜。
  • 按卡莫阿-卡库拉的初步生产指导目标,并以项目100% 权益计算,项目在2021年剩余时间生产精矿的铜金属量为80,000吨至95,000吨。
  • 20214月底,卡莫阿-卡库拉的投产前矿石堆场已储备矿石300万吨,铜品位4.74%,含有超过14万吨的铜金属。
  • 鉴于当前的铜价走势,艾芬豪与其合资伙伴紫金正积极研究加快卡莫阿-卡库拉的III期扩建,将选厂产能从760万吨/年提升至1,140万吨/年,并将由卡索科(Kansoko) 矿山的扩建或卡莫阿(Kamoa) 北区(包括富矿带) 的新采区供给矿石。同时,卡莫阿铜业正在完善其下游产业的长期战略,包括探讨新建冶炼厂或湿法选冶设施的可能性。
  • 艾芬豪矿业于20213月已完成发行总额为5.75亿美元、票息率2.50%的高级可转债。这笔资金使艾芬豪及其合资伙伴可快速跟进其它水电设施的升级改造,以确保为卡莫阿-卡库拉铜矿扩大产能至1,900万吨/年的工程以及冶炼厂,提供充足的清洁和可再生的电力。这笔资金还将用于扩大和加快西部前沿探矿权的勘查计划,寻找下一个世界级的铜矿资源。
  • 20214月,艾芬豪宣布艾芬豪矿业刚果()能源公司与刚果()国有电力公司SNEL 签署英加二期水电站主要涡轮机组的升级改造协定。涡轮机组升级后将产生162兆瓦的清洁、可再生水电,为卡莫阿-卡库拉铜矿及冶炼厂提供长期的稳定电力以配合日后的扩建计划。
  • 20215月,艾芬豪承诺其领先行业的卡莫阿-卡库拉铜矿将致力实现净零运营温室气体排放 (范围一和二)。目前,矿山已获得清洁、可再生的水电能源供应,公司的净零承诺重点将会在通过采用新引入的电池或氢燃料电池驱动的先进设备,全力推进采矿作业电气化。
  • 艾芬豪于今年2月在毗邻卡莫阿-卡库拉的西部前沿探矿权內展开2021年勘查工作,覆盖面积约2,550平方公里。2021年的勘探预算现已增加至2,100万美元,包括钻孔工程和勘测工作,预算视勘查结果可另行追加。
  • 为配合其扩产计划、满足未来资金需求及吸引更多股东投资,艾芬豪正在考虑寻求在一个或多个国际证券交易所并行上市的可行性。任何此类上市均须视市场条件及上市规则而定。
  • 20212月,艾芬豪公布其南非子公司Ivanplats正在安排4.2亿元的项目级融资,以推进其位于南非的普拉特瑞夫世界级钯-----金矿项目。
  • Ivanplats 与猎户座矿业金融集团 (Orion Mine Finance) (以下简称"猎户座") 已就3亿元的黄金、钯及铂金属流融资签订非约束性协议。猎户座是世界领先的金融集团,为基础金属和贵金属矿企提供生产相关的金属流融资。此外,Ivanplats已委托两家国际知名的商业银行法国兴业银行和莱利银行担任受托牵头安排行,负责1.2亿元的项目级高级债务融资。
  • 20201130日,Ivanplats公布普拉特瑞夫项目的2020独立综合开发分案 (以下简称"普拉特瑞夫IDP20") 令人鼓舞的研究结果,随后开始筹措融资安排。普拉特瑞夫IDP20包括项目的可行性研究更新版 (以下简称"普拉特瑞夫2020 FS") 以及初步经济评估 (以下简称"普拉特瑞夫2020 PEA")。普拉特瑞夫2020 PEA分期开发方案预计的初期资本开支约3.9亿元,年处理矿石70万吨。
  • 普拉特瑞夫分期开发方案的70万吨/年的初始矿山设计、77万吨/年选厂和相关基础设施的详细工程设计正在进行中,并将于2021年底前纳入更新版可行性研究。1号竖井转换为生产井的进展顺利,将于2022年初开始进行长期矿石提升。
  • 艾芬豪矿业及其合资伙伴、刚果()国有矿业公司杰卡明(Gécamines)正在审阅刚果()基普什矿山重建项目的可行性研究草案以及开发和融资方案。项目现场目前由一支精干的队伍进行维护和抽水作业。
  • 艾芬豪在基普什矿山地下基础设施的升级方面取得了重大进展,这将使超高品位的大锌矿体能够快速开采。目前需要建设地表选厂和相关的生产设施,为矿山复产作好准备。艾芬豪正与杰卡明进行讨论以推动基普什矿山进入一个新的生产时期,预计双方将于2021年中可行性研究完成以及开发和融资方案达成协议后完成协商。
  • 截至2021年第一季度末,卡莫阿-卡库拉项目已连续628,000个工时没有发生失时工伤、基普什项目已连续314万个工时没有发生失时工伤,而普拉特瑞夫已连续202,000个工时没有发生失时工伤。

主要项目及活动回顾

1. 卡莫阿-卡库拉项目
艾芬豪矿业持有 39.6% 权益
位于刚果民主共和国

卡莫阿-卡库拉项目是艾芬豪矿业与紫金矿业的合资企业,被国际矿业咨询公司伍德曼肯兹 (Wood Mackenzie) 评为全球第 4 大铜矿床。该项目位于科卢韦齐 (Kolwezi) 镇以西约 25 公里处,在卢本巴希 (Lubumbashi) 以西约 270 公里处。
2015年12月,艾芬豪以总价 4.12 亿元向紫金矿业出售卡莫阿控股有限公司 (以下简称 "卡莫阿控股") 49.5% 的权益。另外,艾芬豪以 832 万元向私营公司晶河全球出售卡莫阿控股 1% 的权益,晶河全球将以十年期无息本票支付。2015年12月与紫金的交易完成后,每位股东必须按其股权比例承担对项目费用的出资。
根据 2002 年刚果(金)矿业法, 2012年9月11日无条件向刚果(金)政府出让卡莫阿-卡库拉5%的不可稀释股权。根据2016年11月与刚果(金)政府签订的协议,卡莫阿-卡库拉项目再向刚果(金)政府转让项目15%的权益,艾芬豪与紫金矿业目前各自间接持有卡莫阿-卡库拉项目39.6% 的权益,晶河全球间接持有0.8% 权益,而刚果(金)政府则直接持有20% 权益。卡莫阿控股直接持有项目 80% 权益。

卡库拉选厂前约7,000名公司及承包商员工的部分人员合影,他们共同努力在预算之内超计划完成矿山的建设工程。



第一序列选厂现已获得长期水电供应。

卡莫阿-卡库拉的职业健康与安全

截至 2021年3月底,卡莫阿-卡库拉项目录得合共 627,876个零失时工伤工时。2021年第一季度发生了9宗工伤事故。项目将继续致力为所有员工和承包商提供零伤害的工作环境。

卡莫阿-卡库拉矿山继续以防疫、防控及降低风险为重点,应对COVID-19疫情。项目进行大规模的检测,加上重点实施防疫措施,确保能够及早发现确诊个案并即时进行隔离和治疗,以降低交叉感染的风险。项目将继续保持高水平的日常风险管理,以防止将来出现确诊个案。

卡莫阿COVID-19医院的主医疗大楼目前正进行扩建及升级工程,在有需要时继续为患者提供治疗。卡莫阿-卡库拉经验丰富的医生和护士,在世界领先的紧急响应及医护团队的支援下,利用最新技术开展诊疗。

随着疫情的变化,卡莫阿-卡库拉的医疗队伍将继续审核和更新其疫情防控方案,并确保在应用新医疗技术之前进行审查,以保护员工和社区成员的安全和健康。

卡莫阿医院新建的主医疗翼楼正在施工中

卡库拉380万吨/年初始选厂的建设接近完成,将在数周内实现首批铜精矿生产

卡莫阿-卡库拉I期年处理矿石380万吨的采选作业 (包括矿山基础设施、选厂和地表基础设施) 整体进展顺利,目前已完成约94% (截至4月底),相比于3月底已完成至90%。

项目第一序列380万吨/年选矿设施的整体建设正在快速推进,目前已完成约98% (截至4月底),相比于3月底已完成至92%。选厂已基本竣工,并计划于本月下旬或6月初实现首批铜精矿生产。最后阶段试车期间将使用较低品位的矿石,在确保选厂的产能和铜回收率达标后,再提高入选品位。

第一序列选厂的钢结构和钣金安装、管道和阀门的安装,以及电器、控制和仪表的安装基本上已完成。

矿山的220千伏卡莫阿 (以下简称“KCS”)主变电站及33千伏KCS变电站已接入电网。选厂的33千伏主变电站以及所有中压和低压变电站已通电,选厂现已获得电力供应。

第一阶段 (C1) 证书签字将近完成,约75%已获签字并从建设移交至试车阶段。第二阶段试车 (预试车) 进展顺利,部分厂区 (破碎、过筛和选矿) 已完成超过90%。目前已率先展开第三阶段 试车,在部分厂区供水运行,检查有否泄漏并校准部分仪器及检查控制环。

回填厂的电气安装正在进行中。回填厂将于2021年7月、在采矿作业需要膏体充填之前完工。

回填厂将尾矿与水泥混合制造回填膏体。回填料将被泵至井下用于采空区回填。矿山约一半的尾矿将用于井下回填,大大减少地表的尾矿量。尾矿库的施工进度理想,按计划将会按时完工以接收来自选厂的尾矿。

大型地表卸料系统、皮带输送系统及原矿输送系统的施工和试车都已顺利完成。大型卸料系统将从卡库拉地表矿堆 (II期作业开始后也从卡索科矿山) 运送矿石供给选厂。

第一序列选厂基本上已竣工。



2021年铜生产指导目标

卡莫阿-卡库拉选厂基本上已竣工,并将于本月下旬或2021年6月初实现首批铜精矿生产。假设如期启动投产,按艾芬豪的生产指导目标,预计卡莫阿-卡库拉项目在2021年剩余时间生产精矿的铜金属量如下﹕

卡莫阿-卡库拉项目                                                                          2021年指导目标
精矿铜金属量                                                                                    80,000至95,000吨

上表中的所有数字均以 100% 项目为基础。报告的精矿金属量未考虑冶炼协议中的损失或扣减。在卡莫阿-卡库拉项目的第一序列选厂实现稳产后,预计将会提供成本的指导目标。

卡莫阿-卡库拉第一序列回填厂,背景为选厂。



卡莫阿-卡库拉项目的II期施工进展顺利;III期扩建的研究工作正在进行中

第二序列380万吨/年选厂的施工进展顺利,预计于2022年第3季度实现投产,目前正重点进行土方和土木工程,两项工程都略微超越既定目标。2020年9月已为第二序列选厂的所有长周期设备下订单,目前正集中采购选厂的其它设备。钢结构的制造正在进行中,首批已制造完成并将于2021年6月运抵现场。

鉴于当前的铜价走势,艾芬豪与其合资伙伴紫金正积极研究加快卡莫阿-卡库拉的III期扩建,将选厂产能从760万吨/年提升至1,140万吨/年,并将由卡索科矿山的扩建或卡莫阿北区 (包括富矿带) 的新采区供给矿石。

第二序列球磨机和浮选车间的地基建设正在快速推进。



地下开拓工程于2021年第一季度末已超过既定目标13公里以上

卡莫阿-卡库拉项目在3月份创下月度开拓记录,掘进超过3,100米,至今完成约38.6公里,超越计划约13.5公里。2021年第一季度的地下开拓工程共掘进8.8公里。2021年第二季度初继续取得理想的进度,截至2021年4月底已经完成超过42公里的地下开拓工程,超过既定目标约15公里。

卡库拉矿区的进路充填采矿作业进展顺利,开采的矿石70%来自回采作业,其余来自掘进。进路充填是一种高效的地下采矿方法,完成一条单一的巷道 (称为采场) 的采矿后,进行采空区回填,进而可以依次开采相邻的采场。回填厂将尾矿与水泥混合制造回填膏体,并将于2021年7月开始将回填料泵回井下作业。

卡库拉和卡索科矿山的大型机械化采矿进展顺利。4月份,月度采矿速率已连续三个月超越380万吨/年的选矿速率,降低堆矿量大幅减少的风险,并且仅在第二序列选厂于2022年第三季度投产时才会减少。


投产前地表矿堆已储备矿石300万吨,铜品位4.74%,含有超过14万吨的铜金属

截至2020年12月底,卡莫阿-卡库拉的投产前地表堆场已储备了约152万吨高品位和中品位矿石,平均铜品位约4.03%,含有超过61,000吨的铜金属。项目2021年1月份共采出约30万吨高品位和中品位矿石,平均铜品位5.45%; 2021年2月份采出约33.9万吨矿石,平均铜品位5.50%;2021年3月份采出约40万吨矿石,平均铜品位5.36%。截至2021年3月底,项目投产前的高品位和中品位地表堆场,累计储备了约256万吨矿石,平均铜品位约4.60%。

4月份采出额外40.9万吨矿石,包括在卡库拉矿山采出的35.7万吨矿石,铜品位5.70% (其中包含在矿床高品位中心采出的12.1万吨矿石,铜品位高达8.40%) ,以及在卡索科矿山采出的51,000吨矿石,铜品位5.85%。

目前,项目投产前地表堆场已储备超过300万吨高品位和中品位矿石,平均铜品位约4.74%。卡莫阿-卡库拉目前已采出300万吨高品位和中品位矿石,相比2020年预可行性研究预测的时间点提前数月达标。

卡库拉投产前地表主堆场和选厂。该堆场是卡莫阿-卡库拉三个堆场的其中之一,目前储备矿石约164万吨,铜品位4.93%

卡莫阿-卡库拉铜矿在I期运营期间的铜精矿销售协议即将达成

卡库拉预计将生产品位极高的清洁铜精矿 (铜品位超过55%),它将是世界各地冶炼厂梦寐以求的产品。冶金试验表明,按照世界标准,卡库拉精矿的砷含量极低,约为0.01%。

在I期生产的铜精矿承购协议即将达成,其中包括利用当地冶炼厂生产粗铜以及直接出口精矿的安排。

在收到最终文件以及卡莫阿-卡库拉合资企业伙伴和卡莫阿铜业的董事会批准后,艾芬豪将披露营销安排的细节。

成功开展设备融资款项的提取

2020 年12 月1 日,艾芬豪宣布卡莫阿-卡库拉项目获得高达1.76亿欧元(约2.11亿美元) 的设备融资以及900万美元首付款,资金将会用于向领先的瑞典制造商Sandvik AB 和Epiroc AB 以及芬兰制造商Normet Oy 订购地下采矿的移动设备和服务。

贷款有效期3年,自提款日起5年内完成偿付,并与卡莫阿-卡库拉项目的地下采矿设备关联。瑞典出口信用局 (以下简称"EKN") 为贷款人提供了政治和商业保险,并且每期贷款的首次使用将收取一次性保费。

2020年12月,设备融资的所有先决条件得到满足后,卡莫阿-卡库拉项目已从900万美元首付款贷款提取款项以及从设备融资提取5,600万美元的款项。 2021年第一季度,项目从设备融资再提取720万美元的款项。其后设备融资款项的提取,仍需满足一系列惯常的先决条件。在每次提取款项前,必须满足相关的先决条件。

设备融资仅以设备作为抵押,首付款贷款则无抵押。卡莫阿控股公司已发出一份无约束力的支持函,确定为项目提供支持,无需任何担保人或母公司作担保。

此外,紫金矿业集团的子公司金山(香港)国际矿业有限公司已向卡莫阿控股公司提供了2亿美元的有限追索权信贷额度,以项目投产前的堆矿作抵押,为选厂的II期扩建提供资金。卡莫阿控股尚未提取此信贷额度的款项。

卡莫阿-卡库拉现已接入国家电网,获得清洁、可再生的220千伏水电能源

矿山经由国家电网连接的18兆瓦移动变电站,向卡莫阿120千伏高架输电线提供水电供应。 2020年12月,连接卡莫阿-卡库拉的一条35公里长的220千伏输电线路,经科卢韦齐的西部调度 (Western Dispatch) 变电站并入国家电网,为项目提供可靠和清洁的水电能源。这是项目取得长期电网供电的一个重要里程碑。

矿山的220千伏KCS主变电站及33千伏KCS变电站已接入电网。选厂的33千伏主变电站以及所有中压和低压变电站已通电,选厂现已获得电力供应。

连接卡莫阿-卡库拉的一条新建的35公里长的220千伏输电线的电塔,经科卢韦齐的西部调度变电站并入国家电网,为项目提供可靠和清洁的水电能源。

英加二期水电站主涡轮机组的升级改造达成协议

2021年4月26日,艾芬豪宣布艾芬豪矿业刚果(金)能源公司与刚果(金)国有电力公司SNEL 签署英加二期水电站主涡轮机组的升级改造协定。涡轮机组升级后将生产162兆瓦的清洁、可再生水电,为卡莫阿-卡库拉铜矿及冶炼厂提供长期的稳定电力以配合日后的扩建计划。

位于刚果河上的英加一期 ()和英加二期 () 水电站的鸟瞰图。红圈位置为英加二期5号涡轮机的压力管道。


下图显示了英加和Mwadingusha水电项目、英加高压输电线路、卡莫阿-卡库拉项目、连接卡莫阿-卡库拉与科卢韦齐国家电网的220千伏新输电线路,以及连接刚果()和安哥拉洛比托港的本格拉(Benguela) 铁路的位置。



Mwadingusha 水电站正进行修缮工程,将提供清洁、可再生电能

Mwadingusha 水电站的改造工程即将完成,第一台涡轮机已于2020年12月并入国家电网。 Mwadingusha水电站的6台新涡轮机组其中3台现已并入国家电网,每台发电机组可产生约13兆瓦的电力。Mwadingusha水电站的6台涡轮机组翻新后,总共可提供78兆瓦的电力,预计于2021年第二季度并入国家电网。

改造工程由瑞士洛桑的Stucky工程公司在艾芬豪矿业及紫金矿业的指导下,与刚果(金)国有电力公司SNEL 合作施工。

78兆瓦Mwadingusha水电站、水库和Mwadingusha社区的鸟瞰图。

其他地表基础设施的工程、采购和施工正迅速推进

北京的中信建设有限公司正在兴建卡库拉第一序列的回填厂。回填厂将尾矿与水泥混合制造回填膏体。回填料将被泵至井下用于采空区回填。矿山约一半的尾矿将用于井下回填,大大减少地表的尾矿量。回填厂的施工进展顺利,建设工程与选厂大致同时完工,预计将于2021年7月实现投产。

尾矿库的建设进度理想,将于规划时间之前完工。

大型地表卸料系统、皮带输送系统及原矿输送系统的施工都进展顺利,计划于2021年初进行第一阶段试车,并配合主要斜坡道的输送系统。大型卸料系统将从卡库拉地表矿堆 (于II期作业开始后也从卡索科矿山) 运送矿石供给选厂。

卡莫阿-卡库拉旨在成为首个实现净零碳排放的顶级铜矿山,采用电池或氢燃料电池驱动的先进设备,全力推进电气化采矿作业

2021年5月5日,艾芬豪矿业宣布,公司已作出承诺,其位于刚果(金)、领先行业的卡莫阿-卡库拉铜矿将会致力实现净零运营温室气体排放(范围一和二) 。

为支持应对气候变化的《巴黎协定》以及本着中美两国政府最近在线上全球气候会议中承诺大幅减排的精神,艾芬豪矿业将致力与其合资伙伴及领先的地下采矿设备制造商紧密合作,确保卡莫阿-卡库拉将会成为首个实现净零运营碳排放的世界顶级铜矿生产商。

目前,卡莫阿-卡库拉矿山和选厂已获得清洁、可再生的水电能源供应,公司的净零承诺重点将通过引入电池或氢燃料电池驱动的先进设备,来全力推进项目的电气化采矿作业。

卡莫阿-卡库拉项目与其采矿设备供应商紧密合作,以减少采矿作业中的化石燃料使用,同时对于新的电、氢和混合技术的可行性、安全性和性能作出评估,在它们可供商业使用时尽快引入项目的采矿作业。

可持续发展促进社区繁荣

“可持续民生计划” 于2010年创立,旨在通过建立农业培训园以及在社区层面为居民提供支持,提升卡莫阿-卡库拉项目社区的食品安全和农作物生产。如今,约有 467位社区居民正受益于“可持续民生计划”,为家人生产优质食品并出售多余的食品以获得额外收入。

“可持续民生计划”从最初的玉米和蔬菜种植已发展到目前包括水果、水产养殖、家禽和养蜂。目前正在建设100个新鱼塘,鼓励当地创业以及提高该地区的粮食安全。Musokantanda农业中学于2020年建成并配备设施,目前用作研究设施,并为118名学生提供教育,以及为当地农民提供培训。同时,农业中学与科卢韦齐大学正在制定合作计划,为学生提供进一步的实践培训。

其他非农业相关活动按计划继续进行,包括教育计划、社区制砖厂计划、缝纫项目以及使用太阳能水井向部分当地社区供应淡水。缝纫项目的28名成员正在接受为期六个月的专业培训,以确保缝纫团队有足够的技术,为卡莫阿-卡库拉生产的个人防护设备 (PPE) 和工作服符合质量标准。

新建成的Muvunda小学已经开幕,可容纳206名学生。Kaponda小学正在进行建设和设施安装。民生计划聘用了当地的承包商在社区内钻探8个水井 (计划共29个水井),为4,244名社区成员提供清洁的水源。

搬迁计划的安置房建设继续施工,其中再有13个家庭已搬入Kaponda安置房,累计74个家庭已完成搬迁,剩余10个家庭。计划已向卡库拉北区108位受项目影响的居民完成土地置换。余下的家庭将于安置房建设完成后搬迁。全部搬迁计划实施完成后,将满足整个卡库拉矿区 (包括尾矿坝) 的建设需要。

从左至右﹕当地社区成员Dennis KabadiInes LumbweSimon IlongaHernestine Hlumbwe在卡莫阿-卡库拉缝纫中心。“Salamah” (斯瓦希里语中的“安全与和平”) 缝纫项目,由卡莫阿-卡库拉的当地经济发展团队于2013年创办,自始取得了长足的发展。

2.普拉特瑞夫项目
艾芬豪矿业持股64%
位于南非

普拉特瑞夫项目由 Ivanplats (Pty) Ltd. (以下简称 "Ivanplats") 持有,艾芬豪矿业持有Ivanplats公司64%的股权。由《全面提高黑人经济实力法案》(B-BBEE) 的南非受益人持有项目26%的股权,这些受益人包括 20 个当地社区,约150,000 位居民、项目雇员和当地企业主。Ivanplats 在最近 B-BBEE 评分核实评估中达到 4 级贡献者标准。另外,伊藤忠商事株式会社、日本石油天然气和金属国家公司和日本天然气公司组成的日本财团通过 2 轮投资 (共 2.9 亿美元) 持有 Ivanplats 10% 的股权。

普拉特瑞夫是一个地下开采项目,含有厚大的铂族金属、镍、铜和金矿化,位于林波波省的布什维尔德岩浆杂岩带北部,距离约翰内斯堡东北面约280公里,距离莫科帕内镇约8公里。

普拉特瑞夫矿化连续,走向延伸30多公里,铂族金属矿化主要赋存在该矿化带的北翼。艾芬豪的普拉特瑞夫项目位于普拉特瑞夫南部,由Turfspruit及Macalacaskop两个相连的矿权组成。最北部的 Turfspruit 矿权,邻近且位于英美铂金 (Anglo Platinum) Mogalakwena 矿山的走向延伸上。

自2007 年以来,艾芬豪重点实施勘探和开发活动,以圈定普拉特瑞夫矿体的深部延伸,目前已命名为 Flatreef 矿床,适合高度机械化的地下开采。整个Flatreef 矿区位于 Turfspruit 和 Macalacaskop 矿权范围内,属于公司采矿许可范围的一部分。

普拉特瑞夫的职业健康与安全

截至2021 年3月底,根据南非《矿山健康与安全法》(Mine Health and Safety Act) 及《职业健康与安全法》(Occupational Health and Safety Act),普拉特瑞夫项目录得合共202,283个零失时工伤工时,距离项目上次失时工伤事件已超过六个月。

中级护士Anna Lebea ()为普拉特瑞夫项目的电气工程师研究生Bernard Maruma注射疫苗。



开展4.2亿美元的项目融资,全力推进普拉特瑞夫项目

2021年2月,Ivanplats 与猎户座就3亿美元的黄金、钯及铂金属流融资签订非约束性协议。猎户座是世界领先的金融集团,为基础金属和贵金属矿企提供生产相关的金属流融资。金属流融资仍需完成法律尽职调查和交易架构,以及最终文件的谈判和签署。金属流融资计划按需要分四期提款,同时进行工程研究将普拉特瑞夫 2020年初步经济评估升级为可行性研究,并将普拉特瑞夫的1号竖井转换为生产井。

此外,Ivanplats已委托两家国际知名的商业银行 — 法国兴业银行和莱利银行担任受托牵头安排行,负责1.2亿美元的项目级高级债务融资。项目级的高级债务融资,仅在金属流融资全额提取后才能使用。债务融资的最终条款和条件,将取决于普拉特瑞夫分期开发方案的可行性研究完成、尽职调查和交易架构达成,以及最终文件的谈判和执行。债务融资的条款和条件,将在上述各项敲定后进行最终定夺。

1号竖井转换为生产井的进展顺利

1号竖井底部的996米中段工作站已于2020年7月顺利完工。1号竖井距离Flatreef高品位矿体约350米,计划开展大规模机械化开采。分别位于750 米、850 米和950米中段的三个工作站都已经完工,采掘班组可以通过初步地下通道前往高品位矿区。

1号竖井转换为生产井的工程,曾受到2020年9月14日发生的事故延迟,目前已继续进行,按计划将于2022年初开始矿石提升。竖井转换所需的设备已经完成订购并已送达现场;详细的工程设计已完成并获得审批。竖井的转换工作将由普拉特瑞夫的资深业主团队负责。

在1号竖井成功进行凿井工程的卷扬机将被改造装配,在矿山服务年限内进行矿石提升,以及用于运送工作人员和物料。竖井将配备两个12.5吨的箕斗 (提升能力达82.5万吨/年) 以及可转换的罐笼,以配合在首采阶段运送工作人员和物料进出竖井。

竖井将配备钢索导轨,进行主要岩石、工作人员和物料的运送。凿井阶段使用的平台钢索和卷扬机钢索已被拆除,而在装配阶段新的永久导轨钢索以及新的永久提升钢索已经运抵现场。此外,还将安装辅助卷扬机,在岩石提升阶段用于载人。

卷扬机地基的施工正在进行中,将会在辅助卷扬机进行安装和试车之前按时完工。竖井的井架、两座卷扬机、装备平台以及输送和控制系统,将符合行业的最高安全标准,并经过安全验证和测试,且设有备援系统。

新设计的溜槽将会连接输送系统,将岩石运输至选厂和废石场,废石将被加工为水泥回填物,并用作护堤储存雨水及降低噪音排放。

新的钢索和新设计建造的装备平台已安装完成。竖井将于2021年5月开始进行装配,并计划于2022年3月底完工。在地下工作站完成转换及矿石和废石通道建成后,地下水平开拓工程将会启动,向高品位矿区推进。

2号竖井的早期地表工程已于2017年展开,包括地表以下约 29 米深的地表箱形切割槽以及建造103 米高的混凝土井架的地基。该井架将设有竖井的永久提升设施并将用于支撑井口。普拉特瑞夫2021年的初步预算为5,900万美元,其中包括1,000万美元用于建设2号竖井的井架。预算现已增加至7,600万美元,将用于项目的详细工程设计以及下游选矿替代方案的研究和实施准备。 2号竖井井架 (从地基至井口) 的建设工程近期展开,并将于2022年4月完工。

安全主任Sinah Tjale正在普拉特瑞夫矿山检查安全带。艾芬豪对于公司上下越来越多的南非和刚果女性人才感到自豪。

地下采矿将会采用高效的机械化开采方法

普拉特瑞夫采矿计划中的采区位于地表以下约 700 米至 1,200 米的深度。1号竖井 (996米深、直径7.25米的通风竖井) 的凿井工程最近已完成,并达到其最终深度,将会用作初步进场的通道。一旦扩大矿山产量,2号竖井 (1,104米深、十米直径的生产井) 将会用作通往矿区的主要通道。矿山生产期间,1号和2号竖井同时作为通风井。规划的另外3个通风井 (1号、2号及3号通风井) 将助力实现稳态产量。

计划采用高效机械化的开采方法,包括深孔采矿法及进路充填法。两种方法都会采用水泥回填以最大化开采矿石。初步经济评估前5年在1号竖井以外开展进路充填采矿作业,以及在2号竖井可用时开展扩建。两个生产方案都会通过优化采矿位置、采矿品位、开采方法和矿段的生产力,最大化开采较高品位采区,目标是要在该矿体以最高净冶炼收益,回收约1.25亿吨的矿石。

矿石将会从矿场通过一系列的内部矿石运送点输送到1号和2号竖井的底部,然后进行破碎并提升至地表。

普拉特瑞夫的员工在1号竖井改造和装配永久性卷扬机,该卷扬机将用于矿石提升以及运送工作人员和物料。

人力资源和职业技能发展

普拉特瑞夫项目的第二个社会和劳动计划 (SLP) 的咨询工作已进入最后阶段。在第二个SLP中,Ivanplats计划以第一个SLP为基础,继续专注于培训和开发计划,其中包括﹕增加15名新培训师、向78名员工提供内部技术培训、延续向即将退休的员工提供新/其他技术的培训计划、为项目社区成员提供社区成人教育,以及向最少100名社区成员提供核心技术培训以及常用技能等。普拉特瑞夫项目继续支持多个教育计划,以及在运营社区提供免费无线上网。

当地经济发展项目包括﹕Mogalakwena市水井计划以提供社区水源。其他项目将与各方合作进行,包括翻新Tshamahansi村的一家诊所及添置设备。

企业和供应商的发展承诺包括进一步扩展现有的小卖店和洗衣设施,以及增设更衣室设施,未来移交由社区伙伴负责管理。为期5年的综合业务发展和资助项目计划,将会帮助社区成员作好业务发展和作为供应商的准备。

普拉特瑞夫项目附近的TshamahansiSomavhuga高中的学生们。艾芬豪继续资助年轻人,为他们提供教育和进修机会,如奖学金、助学金、实习和学员计划,并供应无线上网热点以支持线上学习。



3. 基普什项目
艾芬豪矿业持有68%股权
位于刚果民主共和国

位于刚果(金)的基普什铜-锌-锗-银-铅矿,邻近基普什镇,距离卢本巴希西南约30公里。基普什地处中非铜矿带,位于卡莫阿-卡库拉项目东南约 250 公里,距离赞比亚边境不足一公里。 2011年11月,艾芬豪收购了基普什项目 68% 的权益;其余 32% 权益由刚果(金)国有矿业公司杰卡明持有。

基普什的职业健康与安全

于2021年3月底,基普什项目累积了3,144,006个零失时工伤工时,距离基普什项目上次失时工伤事件已接近两年。

鉴于COVID-19疫情,基普什已暂停了矿山建设作业。项目现场有一支精干的队伍,安全有效地进行维护工作,并保持抽水作业和执行已规划的工作。

基普什项目设有饮用水供应站为基普什市供水。这涉及电力、化学消毒剂、日常维护、保安和紧急修复主要管网的泄漏。项目正计划在一家当地学校及附近社区建设额外的太阳能水井。

作为支持社区教育的举措之一,基普什项目于2020年继续进行Mungoti学校的翻新工程;项目成立的缝纫培训中心继续生产布口罩,每月向运营社区捐赠约2,000个口罩。

基普什项目于2020年实施"可持续发展民生计划",使当地的妇女团体受惠。计划从家禽养殖开始且进展顺利,已有300只鸡投入市场销售。

基普什项目的最终可行性研究接近完成

艾芬豪矿业于2017年12月13日公布的基普什项目预可行性研究估计,初步11年矿山全寿命期间,平均年产381,000吨锌精矿,现金成本0.48美元/磅。

预可行性研究的重点 (基于长期锌价 1.10 美元/) 包括﹕

  • 税后净现值为 6.83 亿美元,实际折现率为 8%。
  • 税后实际内部收益率为 35.3%。
  • 税后项目投资回收期为 2.2 年。
  • 包括预备费在内的投产前资本开支为 3.37 亿美元。
  • 与新建开发项目相比,利用现有的地表和地下基础设施,可显著降低资本开支。
  • 在矿山全寿命期间,平均年产锌精矿 38.1万吨,锌精矿品位 59%。投产后,预计基普什将会成为全世界规模最大的锌矿之一。

除非另有指明,否则所有数字均以 100% 项目为基础进行报告。在矿山全寿命期间,估计平均现金成本为 0.48美元/磅。投产后,预计基普什将会成为世界现金成本最低 (成本曲线位于四分位图底部) 的锌矿生产商之一。
艾芬豪矿业及其合作伙伴杰卡明正在审阅基普什的可行性研究草案以及开发和融资方案,预计双方将于2021年中,在完成可行性研究以及开发和融资方案达成协议后完成协商。

项目开发和基础设施

尽管2021年第一季度以及截至2020年12月31日止年度的开发和重建活动受到限制,基普什矿山近年来的地下基础设施现代化升级进展顺利,为重启商业性生产作好准备。这些工程包括在不同深度修建竖井和井架,以及地下矿山的掘进工程和基础设施。一系列的穿脉巷和通风基础设施仍然运作正常,并已清除陈旧物料和设备,以配合先进的机械化采矿作业。地下基础设施还包括一系列高效水泵,用于控制矿山水位,目前水位很容易保持在矿山底部。

5号竖井的直径为8米、深 1,240 米,现已进行升级和重新试车。主要的工作人员和物料进出场的卷扬机已被升级改造,以满足全球行业标准和安全标准。 5号竖井的岩石提升卷扬机目前已全面运行,并已安装新的箕斗、钢索以及相关配件。竖井已安装两个新制造的岩石运输工具(箕斗)和支撑框架(控制电缆),以方便从1,200 米中段的主矿石仓和废石仓提升岩石。

Cyril Muke正在检查大容量Grifo水泵的变速驱动器,确保基普什的地下作业保持干燥。

大锌矿体进场斜坡道与5号竖井出岩设施之间的 1,150 米中段主要运输道已经重做混凝土地平,矿山现在可以使用现代化的无轨移动设备进行采矿。新的卡车卸料仓 (用于将矿石送入正下方的破碎机) 已在这个中段安装。2号竖井的旧卷扬机已移除。现代化的新卷扬机地基建设、组装和安装都已经完成,并在通过安全检验和测试程序后全面运行。

(左至右) Alain MutomoGarcao IlungaChristophe Ngandu在基普什进行地下测量,为重启采矿作业作好准备。

年轻的基普什居民正前往基普什项目建设的太阳能机井运水。



4. 西部前沿勘探项目
艾芬豪矿业全资拥有及持有90%权益
位于刚果民主共和国

艾芬豪的刚果(金)勘探团队通过区域勘探和钻孔,在其位于卡莫阿-卡库拉项目以北、以南和以西的西部前沿探矿权内,重点勘探卡莫阿-卡库拉类型的铜矿化。艾芬豪的西部前沿勘查项目包括17个探矿证,总面积约2,550平方公里。

之前取得重大发现的原班地质人马,在西部前沿广阔的勘查区内,采用相同的勘查模型;该模型成功指导了卡莫阿-卡库拉合资项目采矿权内卡库拉、卡库拉西区和卡莫阿北区富矿带的发现。

2021年第一季度期间,西部前沿矿区的勘探活动继续进行,野外作业于2月中旬重启。2021年野外作业的目标是要在部分新许可区进行钻孔测试以选定更多靶区。2021年第一季度的初步钻孔工程计划靠近现有的进场路线进行,以及跟进2020年发现的Makoko西部延伸范围。钻孔岩芯正在加工或化验分析,同时进行了详细的岩石物理性质测试,以进一步了解地质特性,以及研究数据是否适用于日后进行大规模物探。

2021年第一季度,在 Makoko西部勘查区共完成了11个新的金刚石钻孔。目的是确定下Nguba群地层向西面延伸至新探矿权的可能性。沿西北-东南向1,000米间距布设钻孔勘探线,每条勘探线上施工2至3个钻孔,孔距约400米。钻孔深度一般约150至450米,部分钻孔较浅。本季度共完成了2,725米的钻探进尺。此外,西部前沿勘矿权继续进行勘探活动,并实施严格的COVID-19防疫程序以保护员工和钻探承包商。

2021 年 2 月 10 日,艾芬豪矿业公布2020年初完成的钻孔分析结果,确认卡莫阿北区的高品位铜矿化向Kiala 矿区内至少延伸了 800 米。

Kiala 矿区的高品位铜矿带最先在卡莫阿-卡库拉采矿权被发现,并通过一系列间距100米的探边孔圈定,向北延伸至艾芬豪全资拥有的探矿权范围内。

高品位铜矿带的控矿构造向北开放延伸。艾芬豪全资拥有极具勘查前景的、走向延伸至Kiala 矿区长达35公里的探矿权。

Kiala 探矿区的部分钻孔包括﹕

  • DKIA_DD007 自345.44米,见矿7.21米 (真厚度),铜品位7.98% (以 1%及2% 铜边界品位计算)。
  • DKIA_DD011 自348.00米,见矿3.82米 (真厚度),铜品位5.35% (以 1%及2% 铜边界品位计算)。
  • DKIA_DD014 自366.70米,见矿5.30米 (真厚度),铜品位12.42% (以 1%及2% 铜边界品位计算)。
  • DKIA_DD016 自351.40米,见矿3.59米 (真厚度),铜品位9.71% (以 1%及2% 铜边界品位计算)。

2021年2月10日,艾芬豪矿业同时宣布,钻探工作在Makoko勘查区发现重要的、赋存较浅的铜矿化 (包括6.01米,铜品位3.38%),从Makoko最初发现的矿化区向西南方向,走向上延伸超过7.5公里。

Makoko西部最新的钻探成果包括﹕

  • DMKK_DD117,距离Makoko之前钻探区3.6公里的探边孔,以2%铜边界品位计算,自259.72米见矿6.01米 (真厚度),铜品位3.38%。以1%铜边界品位计算,见矿9.75米 (真厚度),铜品位2.63%。
  • DMKK_DD118,距离Makoko之前钻探区1.6公里的探边孔,以2%铜边界品位计算,自209.50米见矿4.19米 (真厚度),铜品位3.01%。以1%铜边界品位计算,见矿5.15米 (真厚度),铜品位2.78%。
  • DMKK_DD123,距离Makoko之前钻探区7.5公里的探边孔,以2%铜边界品位计算,从井下钻孔570米深度开始,见矿3.33米 (真厚度),铜品位1.44%。以1%铜边界品位计算,则见矿17.77米 (真厚度),铜品位1.39%。

最近在Makoko西部开展的钻探工作,对于新探矿权的勘探潜力评价意义重大,显示目标地层向西面延伸,而且盆地西缘的铜矿化沿水平方向展布。Makoko西部勘查区未来的钻孔工作,将选择有利于形成高铜品位的特定构造位置为优先靶区。

2020年第四季度启动的高分辨率磁法测量已完成了61%的数据采集。由于地下水位下降或会影响测量的质量,因此计划暂时停止,并将于2021年第二季度完成。

2021年第一季度期间继续建造一条16公里长的道路,从Makoko勘查区向西面一直延伸至西部新许可区内的勘探靶区,工程已接近完成。此外,目前正在Lubudi River上修筑桥梁,并计划于2021年在新桥的另一侧建造一条60公里长的新进场干路,通往位于西南面新许可区的勘探靶区。

2021年的初步勘探预算为1,600万美元,现已增加至2,100万美元以包括额外的钻孔工程、测量和野外作业。预算视勘查结果可另行追加。2021年扩大的勘查计划包括共60,000米的空气钻和金刚石钻探、航空和大地地球物理测量、土壤采样、道路建设和额外的野外作业。今年大部分的勘查工作将会集中在公司全资拥有的1,700多平方公里的新探矿权范围内。艾芬豪2019年获得该探矿权, 2020年获得环评审批。

季度财务信息精选

下表总结了前八个季度的财务信息精选。艾芬豪在任何财务报告期间都没有任何经营收入,并且在任何财务报告期间都未声明或支付任何股息或股东红利。

经营业绩讨论
20213月已完成可转债的发行

2021年3月17日,公司已完成私募发行总额为5.75亿美元、息票率2.50%、2026年到期的高级可转债。转换债券时,公司可选择以现金、普通股或其组合方式结算。鉴于上述的选择权,可转债设有嵌入式的衍生负债,以公允价值计量且其变动计入当期损益,而主贷款则以摊余成本入账。

高级可转债为本公司的高级无抵押债务,息票率2.50%,每半年付息一次。除非提前回购、赎回或转换,债券将于2026年4月15日到期。债券的初步转换率为每份面值1,000美元的债券可转换为134.5682股公司A类普通股,或相当于每普通股约7.43美元 (约9.31加元) 的初步转换价。

在2025年10月15日前一个工作日结束前,仅在下述情况下,债券持有人可选择以面值1,000美元或以上的整数倍转换债券﹕

· 在截至2021年6月30日止季度之后的任何季度期间(以及仅在该季度期间),如果本公司在30个连续交易日(包括上一季度的最后一个交易日) 期间至少20个交易日 (不论是否连续) 的A类普通股收盘价格高于或相等于当时每个适用交易日转换价格的130%;或

· 在任何10个连续交易日后的5个工作日期间("测量周期"),测量周期内每个交易日的每份面值1,000 美元的债券交易价格低于本公司A类普通股的收盘价格与这些交易日的转换率乘积的98%;或

· 如果本公司在某些情况下或在若干事件发生时,要求赎回部分或全部债券

2025年10月15日或之后,直至到期日前第2个计划交易日结束前,债券持有人可选择以面值1,000美元的整数倍转换其全部或部分债券,而无须符合上述条件。

本公司不得在2024年4月22日之前赎回债券 (除非某些税法有所修订)。2024年4月22日或之后,以及在到期日前第41个交易日或之前,如果在本公司提供赎回通知前的任何30个连续交易日 (包括该期间的最后一个交易日) 期间至少20个交易日 (不论是否连续) 的普通股收盘价格高于或相等于当时转换价格的130%,则本公司可以赎回债券。债券的赎回价格为债券面值的100%,加上应计未付利息 (但不包括赎回日)。

由于在转换债券时,公司可选择以现金、普通股或其组合方式结算,因此可转债被视为一种衍生金融负债,导致主负债(host liability)以摊余成本入账。嵌入式衍生负债(derivative liability)以公允价值计量且其变动计入当期损益。

主负债的实际利率为9.39%。截至2021年3月31日,主负债的账面值为4.157亿美元。

公司完成可转债发行时,衍生负债的公允价值为1.505亿美元,截至2021年3月31日已下跌至1.249亿美元,2021年第一季度的金融负债公允价值变动2,560万美元。

2021年3月17日,初步确认根据以下的关键参数和假设厘定嵌入式衍生负债的公允价值﹕

· 股价为7.00加元
· 信贷息差为630个基点
· 波动率42%
· 借贷成本为50个基点

于2021年3月31日使用的关键数据和假设如下﹕

· 股价为6.47加元
· 信贷息差为610个基点
· 波动率42%
· 借贷成本为50个基点

与衍生负债相关的可转债发行交易成本为370万美元,已费用化且已计入当期利润表。

截至2021331日止三个月 (对比 2020331) 的回顾

公司于2021年第一季度录得1,620万美元的综合收益,2020年同期则录得7,660万美元的亏损。2020年一季度的综合亏损,主要是由于把国外经营收入进行折算时由于南非兰特从2019年12月31日至2020年3月31日下跌28%而导致外汇损失6,250万美元,而2021年第一季度由于国外经营收入折算而导致外汇损失420万美元。

如上所述,公司在2021年第一季度嵌入式衍生金融负债的公允价值变动2,560万美元;与衍生负债相关的可转债发行的交易成本为370万美元,并已费用化且已计入当期利润表。

2021年第一季度的财务收入达2,280万美元,与2020年同期 (2,080万美元) 相比高出200万美元。财务收入中包括向卡莫阿控股合资企业提供的贷款利息,2021年第一季度的利息收入2,120万美元,2020年同期所得的利息收入为1,630万美元,随着累计贷款余额增加。由于美联储减息,导致现金和现金等价物所得利息下跌。

2021年第一季度的勘探及项目开支为870万美元,2020年同期为1,200万美元。勘探及项目开支用于艾芬豪的西部前沿探矿权的勘探活动,还包括用于基普什项目的开支,但由于项目在期内减少作业而产生了有限的资本开支。下表列出了2021年第一季度和2020年第一季度基普什项目的主要开支类别﹕

公司为卡莫阿控股合资企业分担的亏损由2020年第一季度的670万美元减少至2021年第一季度的410万美元。下表列出截至2021年3月31日止三个月及2020年同期公司为卡莫阿控股分担的亏损汇总:

卡莫阿控股合资企业的融资成本与股东贷款有关,其中,每位股东均需向卡莫阿控股提供相当于其持股比例权益的资金。公司代表晶河全球继续出资,以换取以艾芬豪为受益人的期票增加。

截至 2021331日的财务状况对比截至 20201231日的财务状况

截至2021年3月31日,公司的总资产为29.761亿美元,相比截至2020年12月31日的24.171亿美元增长了5.59亿美元。总资产的增长主要由于2021年3月17日完成发行高级可转债所得的净收入所致。出售可转债所得的收入 (扣除与主负债相关的发行成本1,030万美元) 为5.647亿美元。

截至2021年3月31日,公司拥有7.319亿美元的现金和现金等价物,相比截至2020年12月31日的2.628亿美元上升4.691亿美元,主要由于可转债所得的收入所致。截至2021年3月31日止三个月,公司动用了2,020万美元现金资源用于运营,并向卡莫阿控股合资企业提供7,000万美元的贷款。

截至2021年3月31日,公司的总负债为6.178亿美元,相比截至2020年12月31日的8,060万美元增加了5.372亿美元,主要由于上述私募发行总额5.75亿美元、息票率2.50%的高级可转债所致。

不动产、厂房和设备的净增长为50万美元,共计680万美元花费在项目开发及其他不动产、厂房及设备的购买。其中,670万美元用于普拉特瑞夫项目的开发成本及其他不动产、厂房及设备的购买。

截至2021年3月31日止三个月及2020年同期的普拉特瑞夫项目不动产、厂房和设备,包括已经资本化的开发成本,增长的主要细目详见下表:

普拉特瑞夫项目产生的成本被视为对于项目迈向商业生产而言是必需的,因此也资本化为不动产、厂房和设备。

鉴于每位现有股东按其持有卡莫阿控股的股权比例向卡莫阿控股注资从而为运营提供资金支持,公司向卡莫阿控股合资企业的投资上升了8,710万美元,从截至2020年12月31日的12.895亿美元到截至2021年3月31日的13.766亿美元。公司在 2021年3月31日止三个月期间向卡莫阿控股合资企业的现金出资的份额达到7,000万美元,而公司分担的合资企业亏损达到410万美元。

公司对卡莫阿控股合资企业的投资明细如下﹕

卡莫阿控股合资企业主要使用由其股东向其预付的贷款,通过投资开发支出、不动产、厂房和设备以及持续实施勘探活动,来推进卡莫阿-卡库拉项目。这反映再公司享有的卡莫阿控股合资企业的净资产份额的变化上。该净资产份额可分解如下:

于2020年12月底,卡莫阿控股合资企业已从设备融资获得4,500万欧元 (约5,600万美元) 以及从首付款贷款中提取900万美元,并于2021年第一季度从设备融资获得590万欧元 (约720万美元)。设备融资仅以设备作为抵押,实际利率为8.96%。首付款贷款则无抵押,实际利率为11.58%。

卡莫阿控股合资企业的不动产、厂房和设备从 2020年12月31日净增长至 2021年3月31日,达到1.675亿美元,可进一步分解如下:

流动资金和资本资源

截至2021年3月31日,公司拥有7.319亿美元的现金和现金等价物。截至该日,公司的综合运营资金约为7.818亿美元,而截至 2020年12月31日则为 3.08亿美元。

自 2015年12月8日起,各股东必须按其股权比例向卡莫阿控股注资。公司代表晶河全球继续出资,以换取以艾芬豪为受益人的期票增加。

目前,普拉特瑞夫项目的开支由艾芬豪单方出资 (通过向 Ivanplats 提供计息贷款),因为日本财团已决定不为当前的开支出资。

在 2021 年剩余时间,公司对普拉特瑞夫项目的主要目标是完成分期开发方案的详细工程设计和更新可行性研究、继续转换1号竖井为生产井以及建设2号竖井的井口、井架。基普什项目将继续实施现金节流措施,直至可行性研究完成以及开发和融资方案达成协议。卡莫阿-卡库拉项目继续推进矿山的开发工作,预计于本月下旬或2021年6月初启动首批铜精矿生产,同时加快选厂的II期扩建。

艾芬豪董事会为普拉特瑞夫、基普什及西部前沿的勘探项目分别提高了2021年的预算。下表列出了预算增长以及2021年剩余时间的剩余金额:


假设额外设备的采购将由设备融资提供资金,且尚未提取紫金的有限追索权信贷款项的条件下,公司为卡莫阿-卡库拉项目2021 年剩余时间制订的预算为 1.58亿美元。

2021年3月17日,公司已完成私募发行总额为5.75亿美元、息票率2.50%、2026年到期的高级可转债。高级可转债为本公司的高级无抵押债务,息票率2.50%,每半年付息一次。除非提前回购、赎回或转换,债券将于2026年4月15日到期。

在2025年10月15日前一个工作日结束前,仅在某些情况下和特定时间,债券可根据持有人的选择进行兑换,此后,可随时兑换,直至到期日前第二个计划交易日结束。转换债券时,本公司可选择以现金、普通股或其组合方式结算。

截至2021年3月31日,主负债的账面值为4.157亿美元,嵌入式衍生负债的公允价值为1.249亿美元。艾芬豪在其英国伦敦办公室有一笔价值320万英镑 (440万美元) 的抵押债券未偿付,需于2025年8月28日全额偿还,此抵押债券以物业资产担保,按1个月期英镑LIBOR加1.9 %的利率每月支付利息。利息仅在到期日支付。

2013年,艾芬豪获ITC Platinum Development Limited提供合约金额3,470万美元的应付贷款。截至2021年3月31日,该公司的账面值为3,240万美元。艾芬豪必须在普拉特瑞夫项目出现剩余现金流后,即时偿还该项贷款。根据贷款协议,剩余现金流定义为普拉特瑞夫项目产生的总收入,扣除所有相关运营成本 (包括所有采矿建设和运营成本)。逾期债款需按3个月期美元LIBOR加2%的利率每月支付利息。利息不进行复利计息。应付合约金额与贷款账面值相差230万美元,主要由于低息贷款所致。

公司向监管机构提交的工作计划开支带有隐含承诺,以保持其矿权的勘探和采矿许可区良好的信誉。下表列出了公司的长期合约责任﹕



如上所述,上表列出的债务代表应向花旗银行支付的抵押债券以及应付ITC Platinum Development Limited的贷款。

公司需按其持有的股权比例向卡莫阿控股合资企业供资。

本新闻稿应当与艾芬豪矿业2021年第一季度的财务报表和《管理层讨论与分析》报告一起阅读。有关报告可在www.ivanhoemines.comwww.sedar.com获取。

合资格人及符合NI 43-101 标准的技术报告

本新闻稿中关于卡莫阿-卡库拉项目资本开支和开发方案修订版的科学或技术性披露已经由史蒂夫·阿莫斯 (Steve Amos) 审查和批准,他凭借其教育、经验和专业协会会籍被认为是NI 43-101 标准下的合资格人。由于阿莫斯先生是卡莫阿项目的负责人,因此他并不符合NI 43-101 对独立人士的界定。阿莫斯先生已核实本新闻稿所披露的技术数据。

本新闻稿中关于卡库拉和卡索科矿堆的其它科学或技术性披露已经由乔治·吉尔克里斯特 (George Gilchrist) 审查和批准,他凭借其教育、经验和专业协会会籍被认为是NI 43-101 条款下的合资格人。由于吉尔克里斯特先生是艾芬豪矿业资源部副总裁,因此他并不符合NI 43-101 对独立人士的界定。吉尔克里斯特先生已核实本新闻稿所披露的其它技术数据。

本新闻稿中的其它科学或技术性披露已经由斯蒂芬·托尔 (Stephen Torr) 审查和批准,他凭借其教育、经验和专业协会会籍被认为是NI 43-101 条款下的合资格人。由于托尔先生是项目地质和评估副总裁,因此他并不符合NI 43-101 对独立人士的界定。托尔先生已核实本新闻稿所披露的其它技术数据。

艾芬豪已经为普拉特瑞夫项目、基普什项目和卡莫阿-卡库拉项目分别编制了一份符合NI 43-101 标准的最新独立技术报告,这些报告可在SEDAR 网站上的艾芬豪页面获得,网址为www.sedar.com

  • 2020年10月13日发布的2020年卡莫阿-卡库拉综合开发方案,由OreWin Pty Ltd.、中国瑞林工程技术有限公司、DRA Global、Epoch Resources、Golder Associates Africa、KGHM Cuprum R&D Centre Ltd.、Outotec Oyj、Paterson and Cooke、Stantec Consulting International LLC、SRK Consulting Inc.以及Wood plc编制,涵盖公司的卡莫阿-卡库拉项目;
  • 2020年12月6日发布的2020 年普拉特瑞夫综合开发方案,由OreWin Pty Ltd.、Wood plc (前为Amec Foster Wheeler)、SRK Consulting Inc.、Stantec Consulting International LLC 、DRA Global以及Golder Associates Africa编制,涵盖公司的普拉特瑞夫项目;以及
  • 2019年3月28日发布的2019 年基普什矿产资源更新,由OreWin Pty Ltd.、MSA Group (Pty) Ltd.、SRK Consulting (South Africa) (Pty) Ltd. 和MDM (Technical) Africa Pty Ltd . (Wood PLC 的一个部门) 编制,涵盖了公司的基普什项目。

这些技术报告包括本新闻稿中引用的普拉特瑞夫项目、基普什项目和卡莫阿-卡库拉项目的矿产资源估算的生效日期、假设、参数和方法等信息,以及本新闻稿中关于普拉特瑞夫项目、基普什项目和卡莫阿-卡库拉项目的科学和技术性披露的数据验证、勘探程序和其他事项的信息。

联系方式
投资者:比尔·特伦曼 (Bill Trenaman),电话:+1.604.331.9834   /
媒体:马修·基维尔 (Matthew Keevil),电话:+1.604.558.1034
网址﹕www.ivanhoemines.com

前瞻性陈述

本新闻稿载有的某些陈述可能构成适用证券法所订议的"前瞻性陈述"或"前瞻性信息"。这些陈述及信息涉及已知和未知的风险、不明朗因素和其他因素,可能导致本公司的实际业绩、表现或成就、项目或行业的业绩,与前瞻性陈述或信息所表达或暗示的任何未来业绩、表现或成就产生重大差异。这些陈述可通过文中使用"可能"、"将会"、"会"、"将要"、"打算"、"预期"、"相信"、"计划"、"预计"、"估计"、 "安排" 、"预测"、"预言"及其他类似用语,或者声明"可能"、"会"、"将会"、"可能会"或"将要"采取、发生或实现某些行动、事件或结果进行识别。这些陈述仅反映本公司于本新闻稿发布当日对于未来事件、表现和业绩的当前预期。这些陈述仅反映本公司于截至 2021 年32 月 31 日止三个月的《管理层讨论与分析》发布当日对于未来事件、表现和业绩的当前预期。

该等陈述包括但不限于下列事项的时间点和结果﹕(i) 关于截至2021年3月31日,卡莫阿-卡库拉合资企业在首产前还有约1.72亿美元资本开支的陈述;(ii) 关于卡莫阿-卡库拉项目选厂的进度和时间点,包括选厂将按计划于2021年第二季度竣工,并计划于2021年5月或6月初实现首批铜精矿生产的陈述;(iii) 关于第二序列380万吨/年选厂的施工进展顺利,预计于2022年第三季度实现投产的陈述;(iv) 关于艾芬豪与其合资伙伴紫金正积极研究加快卡莫阿-卡库拉的III期扩建,将选厂产能从760万吨/年提升至1,140万吨/年,并将由卡索科矿山的扩建或卡莫阿北区(包括富矿带)的新采区供给矿石的陈述;(v) 关于堆矿量仅在第二序列选厂于2022年第三季度投产时才会大幅减少的陈述;(vi) 关于卡莫阿-卡库拉回填厂将于2021年7月、在采矿作业需要膏体充填之前完工,且矿山约一半的尾矿将用于井下回填的陈述;(vii) 关于卡莫阿-卡库拉项目其他建设的预期进度,包括尾矿库按计划将会按时完工以接收来自选厂的尾矿的陈述; (viii) 关于卡库拉预计将生产品位极高的清洁铜精矿(铜品位超过55%),它将是世界各地冶炼厂梦寐以求产品的陈述;(ix) 关于在I期生产的铜精矿承购协议即将达成,其中包括利用当地冶炼厂生产粗铜以及直接出口精矿安排的陈述;(x)关于卡莫阿-卡库拉项目将会成为全球单位铜温室气体排放最低矿山之一的陈述;(xi) 关于翻新后的Mwadingusha水电站,6台涡轮机组合共提供的电力,预计于2021年第二季度并入国家电网的陈述;(xii) 关于英加二期水电站主要涡轮机组的升级改造达成协议,涡轮机组升级后将产生162兆瓦的清洁、可再生水电,为卡莫阿-卡库拉铜矿及冶炼厂提供长期的稳定电力以配合日后扩建计划的陈述;(xiii) 关于卡莫阿-卡库拉旨在成为首个实现净零碳排放的顶级铜矿,采用电池或氢燃料电池驱动的先进设备,全力推进采矿作业电气化的陈述;(xiv) 关于普拉特瑞夫项目的金属流融资,包括计划分四期提款的陈述;(xv) 关于普拉特瑞夫项目1号竖井转换为生产井预计于2021年5月展开工程并于2022年3月完工的陈述;(xvi) 关于2号竖井井架(从地基至井口) 的建设工程将于2022年4月完工的陈述;(xvii ) 关于普拉特瑞夫计划采用高效机械化的开采方法,包括深孔采矿法及进路充填法,两种方法都会采用水泥回填以最大化开采矿石的陈述;(xviii) 关于艾芬豪矿业及其合资伙伴杰卡明正在审阅基普什的可行性研究草案以及开发和融资方案,预计双方将于2021年中,在完成可行性研究以及开发和融资方案达成协议后完成协商的陈述;(xix) 关于Makoko西部勘查区未来的钻孔工作,将选择有利于形成更高铜品位的特定构造位置为优先靶区的陈述;(xx) 关于按艾芬豪的指导目标,卡莫阿-卡库拉项目将生产的精矿铜金属量的陈述;(xxi) 关于按生产指导目标,卡莫阿-卡库拉项目在2021年剩余时间生产精矿的铜金属量为80,000吨至95,000吨的陈述;(xxii) 关于公司按比例为卡莫阿-卡库拉项目制定2021 年剩余时间的预算为1.58亿美元的陈述;以及(xxiii) 关于在2021 年剩余时间的主要目标和2021年剩余预算的陈述。

此外,卡库拉铜矿可行性研究、卡库拉-卡索科2020年预可行性研究、更新和扩展的卡莫阿-卡库拉项目初步经济评估、普拉特瑞夫项目的可行性研究,普拉特瑞夫2020年初步经济评估以及基普什项目的预可行性研究的所有结果均构成了前瞻性陈述或信息,并包括内部收益率的未来估算、净现值,未来产量、现金成本估算、建议开采计划和方法、估计矿山全寿命、现金流量预测、金属回收率、资本和运营成本估算,以及项目分期开发的规模和时间点。另外,对于与卡莫阿-卡库拉项目、普拉特瑞夫项目和基普什项目开发有关的特定前瞻性信息,公司是基于某些不确定因素而作出假设和分析。不确定因素包括:(i) 基础设施的充足性;(ii) 地质特征;(iii) 矿化的冶金特征;(iv) 发展充足选矿产能的能力;(v) 铜、镍、锌、铂金,钯、铑和黄金的价格;(vi) 完成开发所需的设备和设施的可用性;(vii) 消耗品和采矿及选矿设备的费用;(viii) 不可预见的技术和工程问题;(ix) 事故或破坏或恐怖主义行为;(x) 货币波动; (xi) 法例修订;(xii) 合资企业伙伴对协议条款的遵守情况;(xiii) 熟练劳工的人手和生产率;(xiv) 各政府机构对矿业的监管;(xv) 筹集足够资金以发展该等项目的能力;(xiv) 项目范围或设计更变;以及 (xv) 政治因素。

本新闻稿亦载有矿产资源和矿产储量估算的参考信息。矿产资源的估算具有内在的不确定性,并涉及对许多相关因素的主观判断。矿产储量的估算提供了更多的确定性,但仍然涉及类似的主观判断。矿产资源并非矿产储量,并不显示其具有经济潜力。任何该等估算的准确性是可用数据的数量和质量的函数,并根据工程和地质诠释的假设和判断 (包括估计公司项目的未来产量、预计开采所得的矿石量和品位,以及估计将会实现的回收率) 而作出,可能被证明是不可靠的,在一定程度上取决于钻孔结果和统计推论的分析,而最终可能证明是不准确的。矿产资源或矿产储量估算可能需要根据以下因素重新估算:(i) 铜、镍、锌、铂族元素 (PGE)、黄金或其他矿物价格的波动;(ii) 钻孔工程的结果;(iii) 冶金测试和其他研究;(iv) 建议开采作业,包括贫化;(v) 在矿山计划的任何估算及/或变更日期之后作出的矿山计划评估;(vi) 未能取得所需准许、批准和许可证的可能性;以及 (vii) 法律或法规的修订。

前瞻性陈述及信息涉及重大风险和不确定性,故不应被视为对未来表现或业绩的保证,并且不能准确地指示能否达到该等业绩。许多因素可能导致实际业绩与前瞻性陈述或信息所讨论的业绩有重大差异,包括但不限于“风险因素”以及本公司截至2021年3月31日止三个月的《管理层讨论与分析》其他部分所指的因素,以及有关部门实施的法律、法规或规章或其不可预见的变化;与公司签订合约的各方没有根据协议履行合约;社会或劳资纠纷;商品价格的变动;以及勘探计划或研究未能达到预期结果或未能产生足以证明和支持继续勘探、研究、开发或运营的结果。

虽然本新闻稿载有的前瞻性陈述是基于公司管理层认为合理的假设而作出,但公司不能向投资者保证实际业绩会与前瞻性陈述的预期一致。这些前瞻性陈述仅是截至本新闻稿发布当日作出,而且受本警戒性声明明确限制。根据相应的证券法,本公司并无义务更新或修改任何前瞻性陈述以反映本新闻稿发布当日后所发生的事件或情况。

基于公司截至2021年3月31日止三个月的《管理层讨论与分析》的“风险因素”和其他部分所指的因素,公司的实际业绩可能与这些前瞻性陈述所预计的业绩产生重大差异。

Download in PDF Format

Subscribe to our Email List
